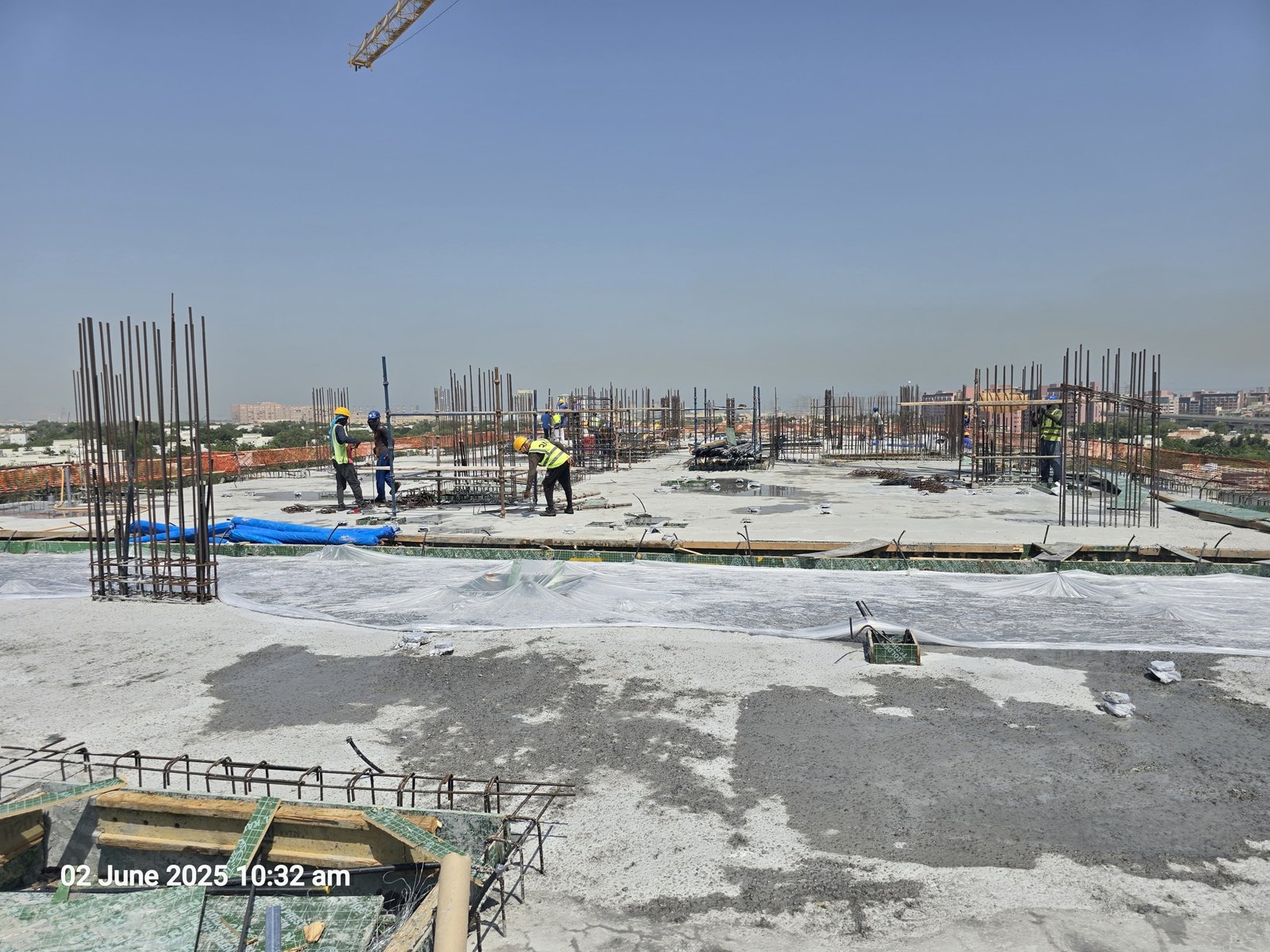

77.5%

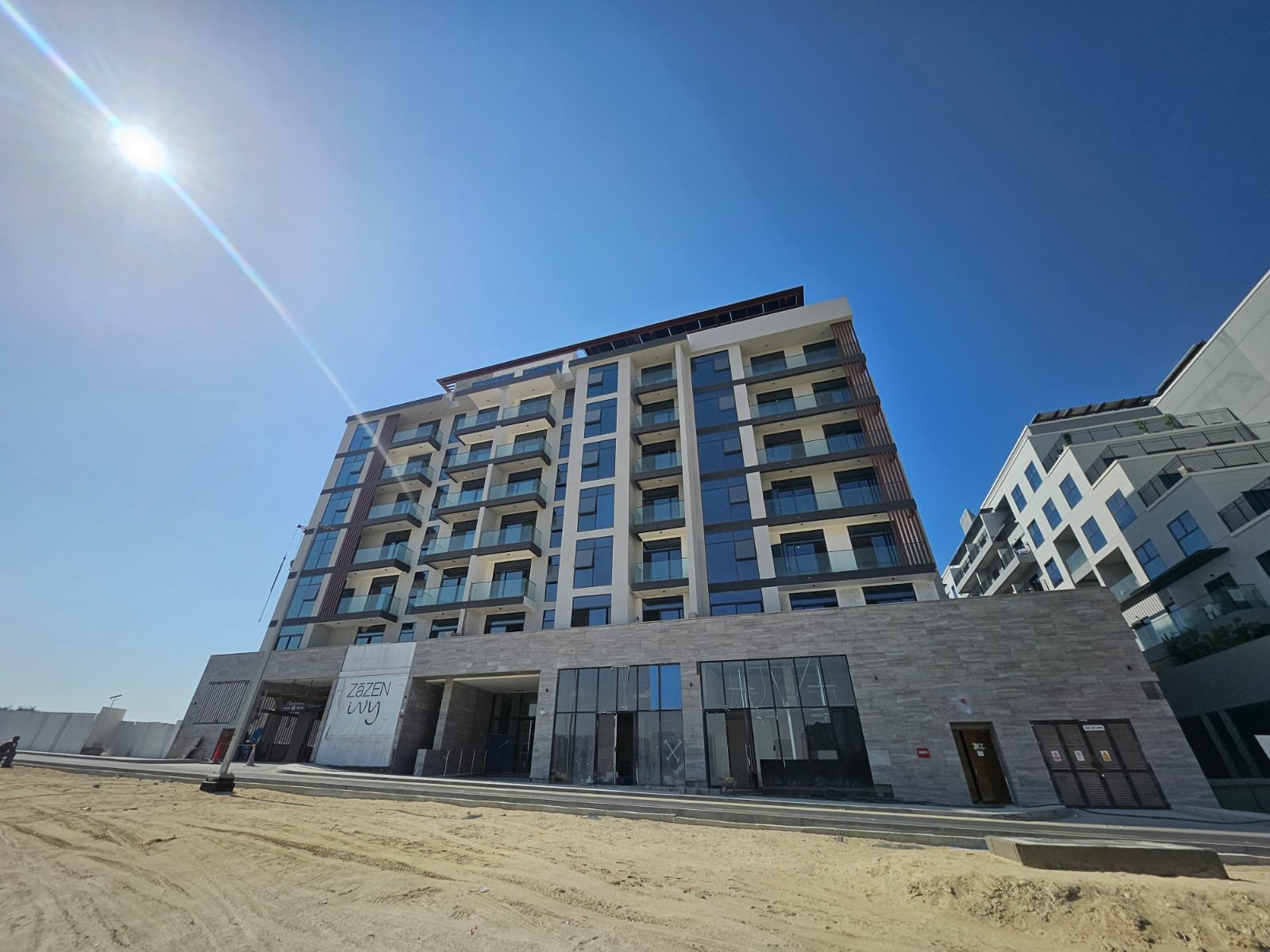

Complete
ZāZEN IVY
CONSTRUCTION UPDATES
Start Date
JUL 2024
Completion DateMar 2026
It is currently under construction and due for completion in March 2026. This project is registered under RERA project number 3109.
CONSTRUCTION UPDATES
Start Date
JUN 2024
Completion DateMAR 2027
ZāZEN IVY
It is currently under construction and due for completion in March 2026. This project is registered under RERA project number 3109.

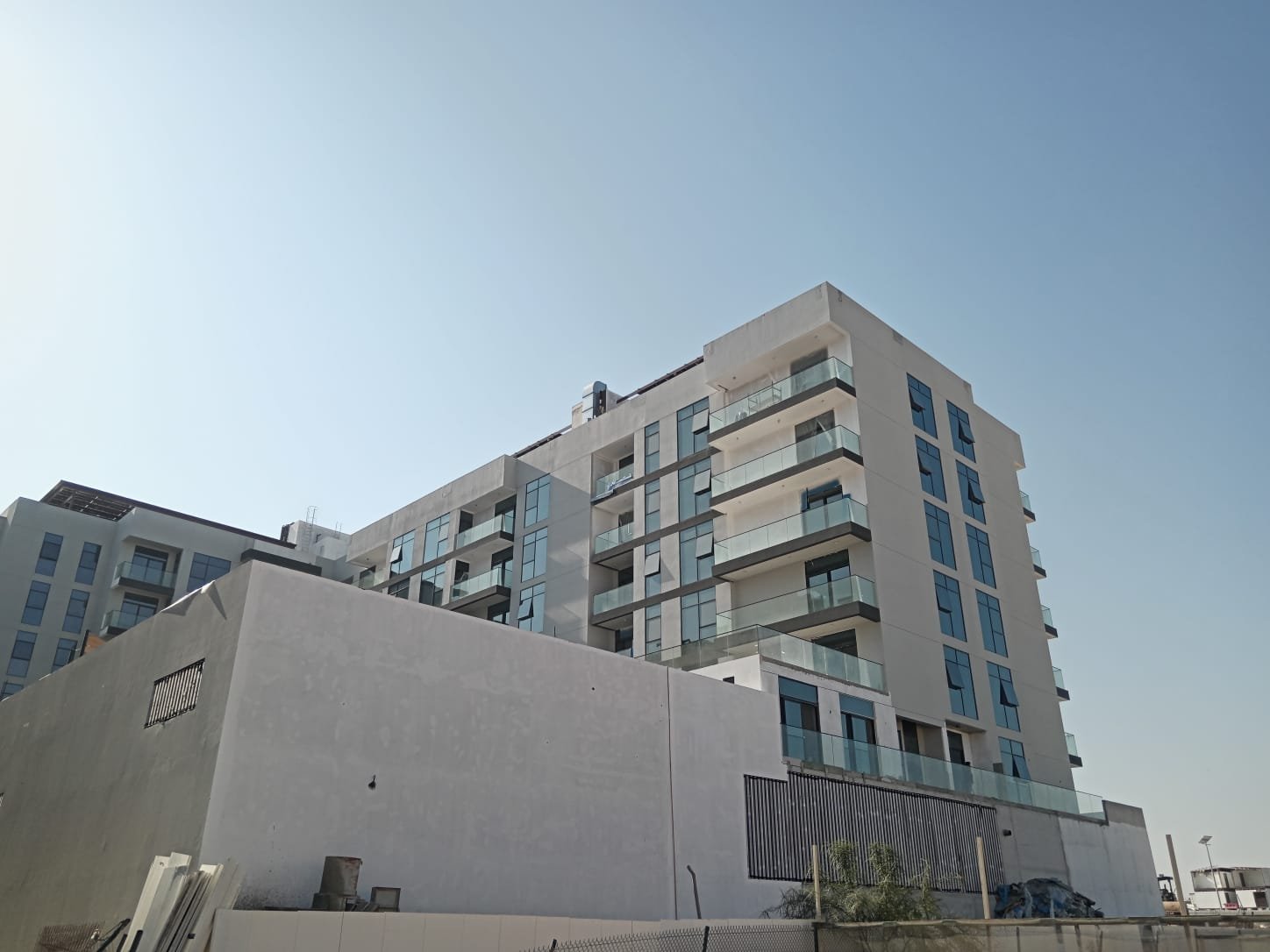

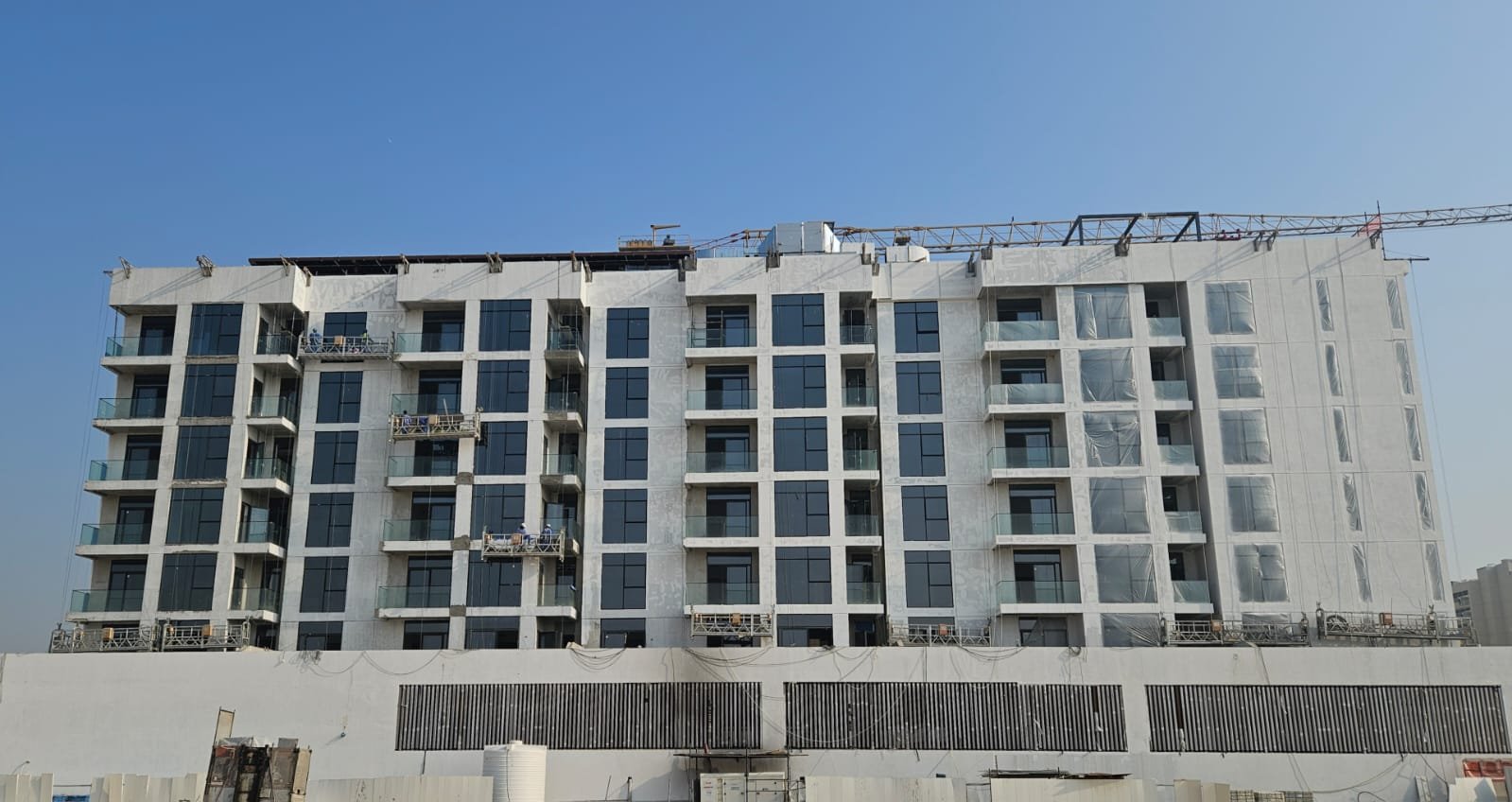

VIEW PROJECT

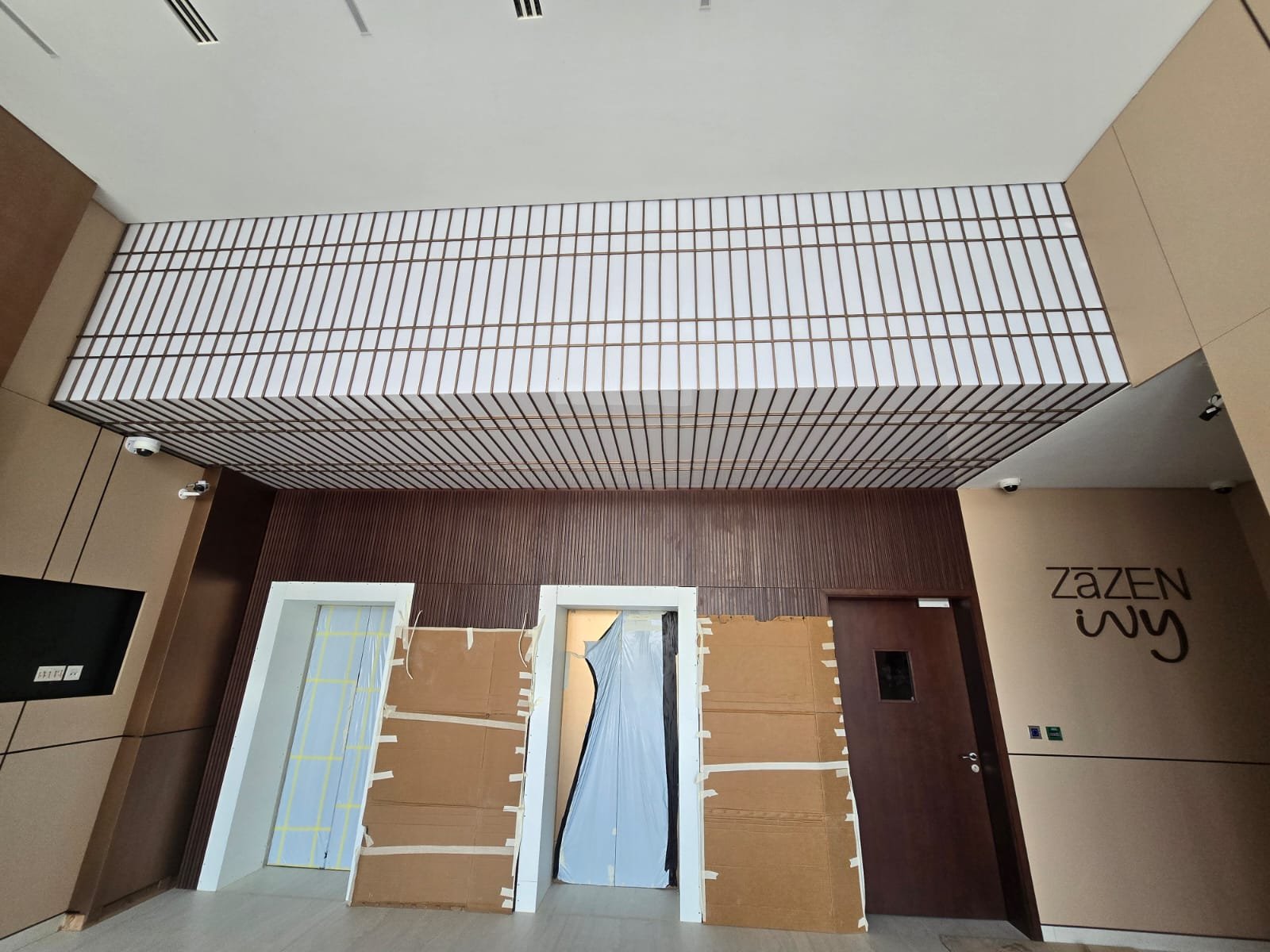

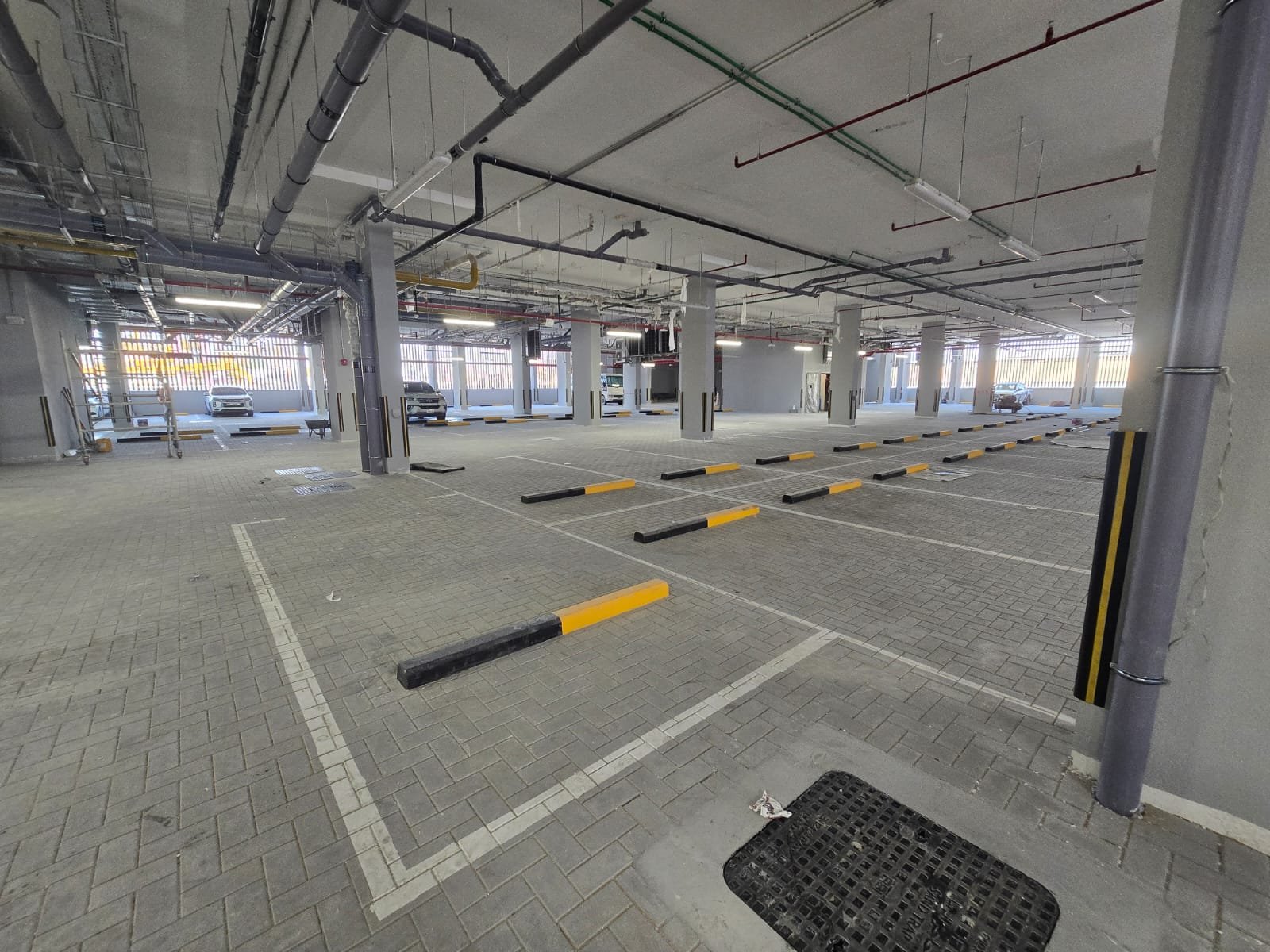

Delivered
TIMELINE
ZāZEN IVY – CONSTRUCTION UPDATE

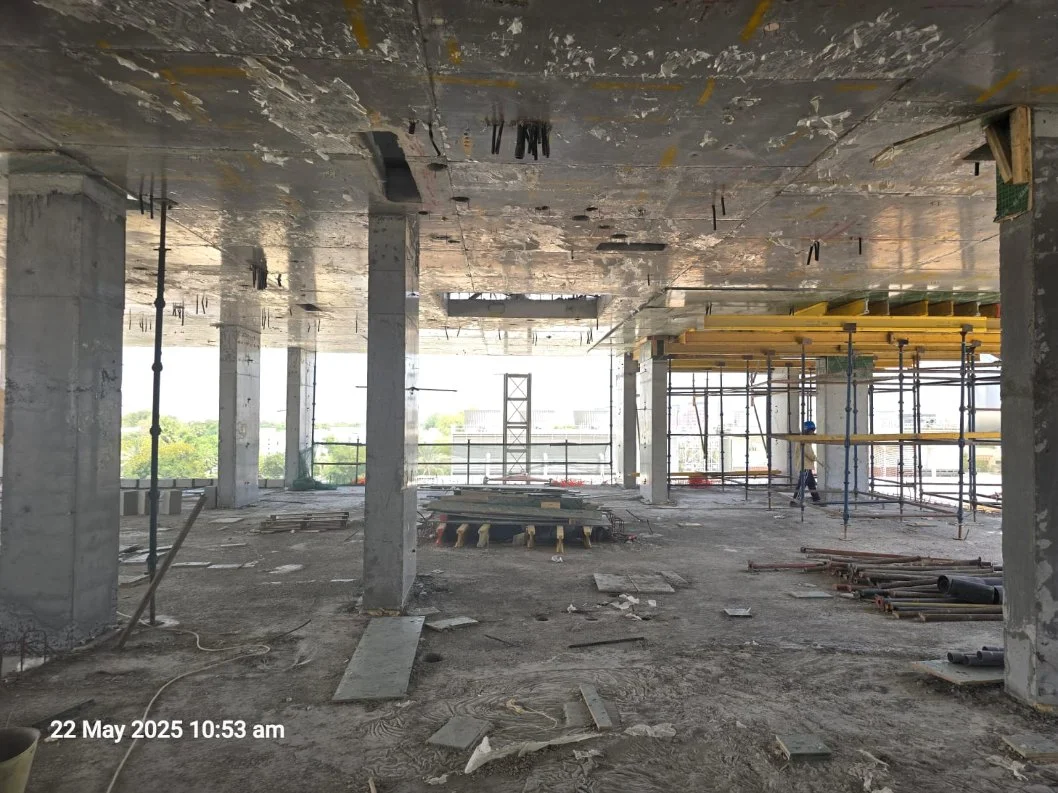

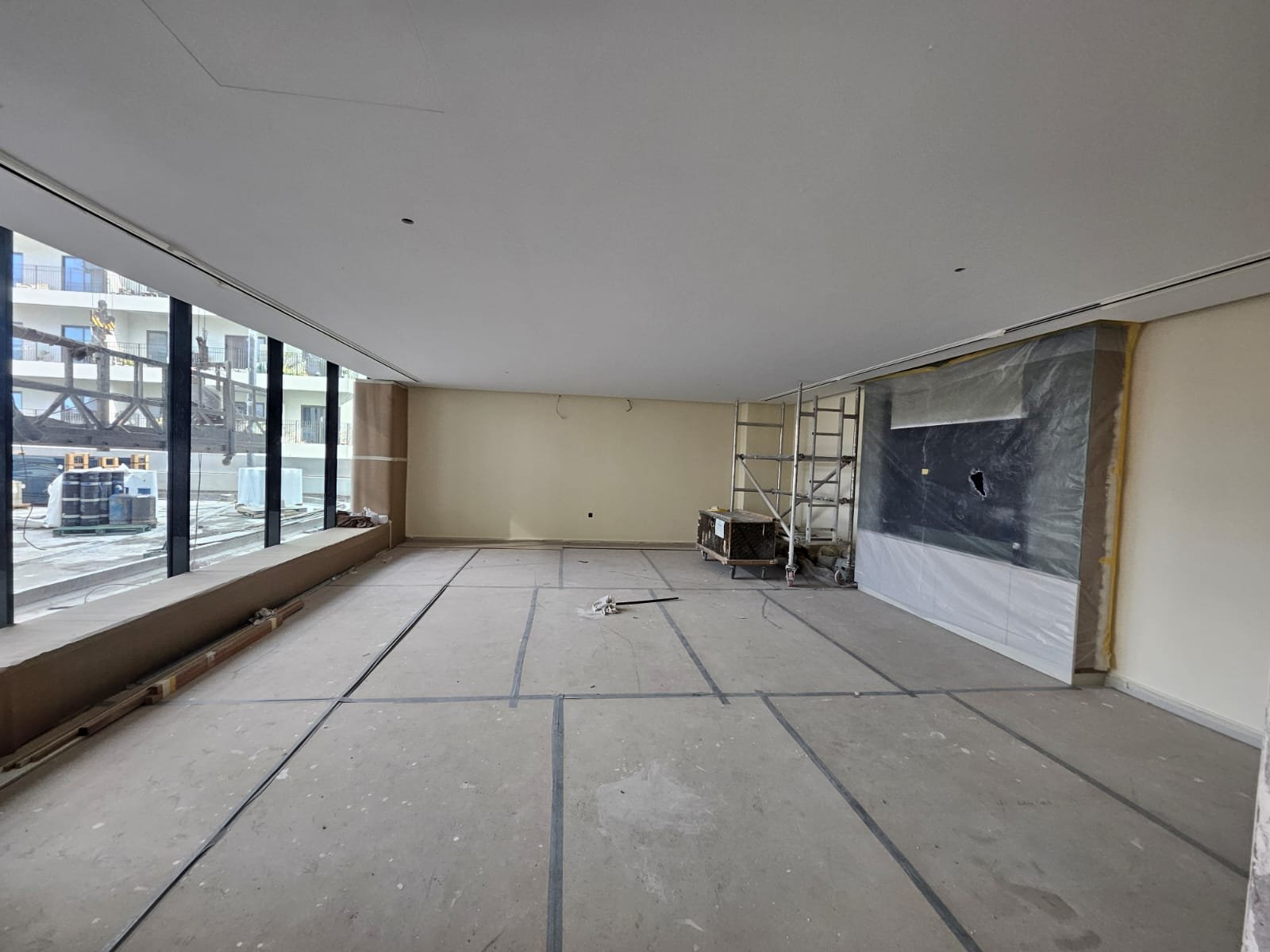

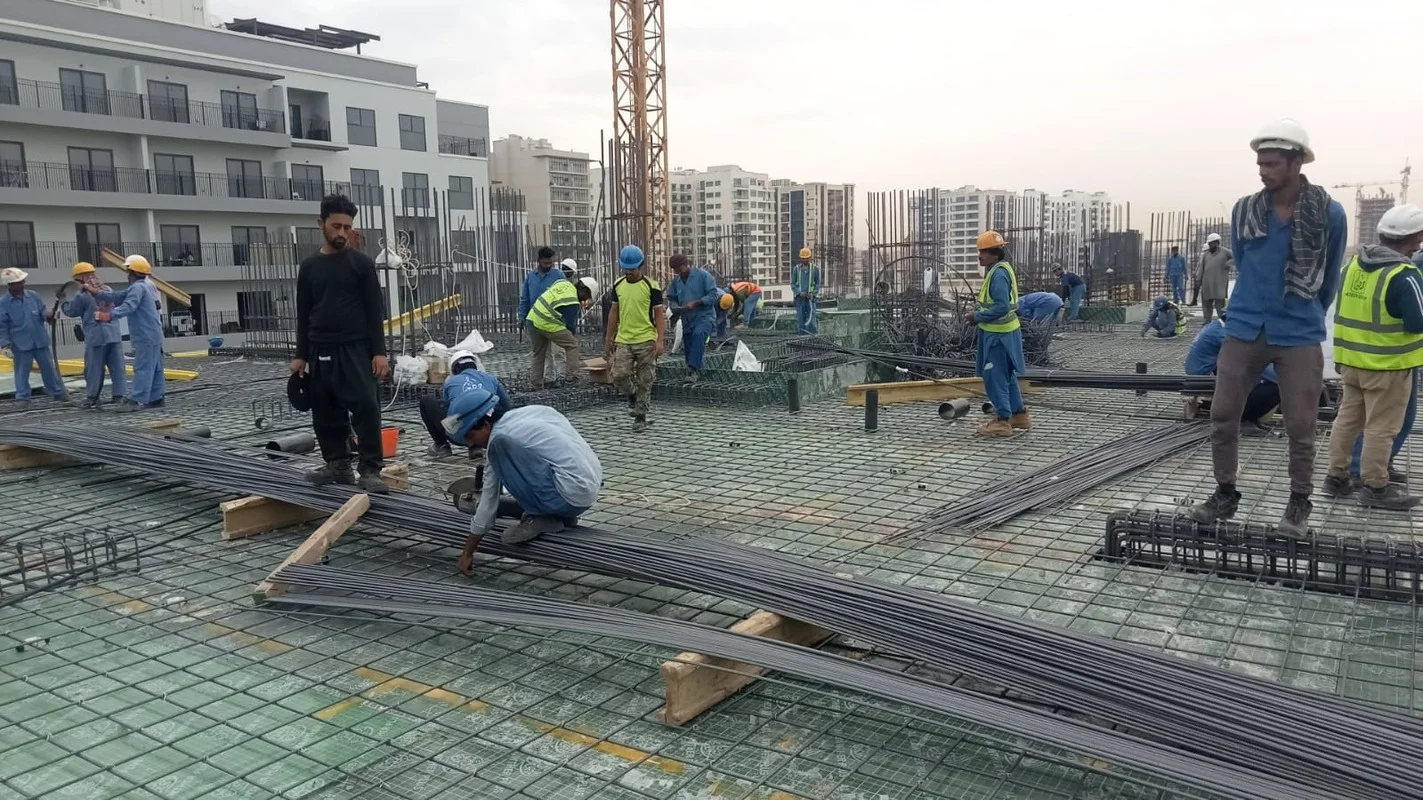

Progress
77.5%
Stage
Ground floor
Structure works · Finishing works:
- Ceiling painting works, 95% completed
- Wall plaster works, 95% completed
- Epoxy flooring for pump room, 100% completed
- GRP for water tank, 100% completed
- FIC manhole GRP work, 100% completed
- Floor tile, 90% completed
- Aluminum louver, 80% completed
- Aluminum frame and glazing works, 50% completed
- Stone cladding works, 20% completed
MEP works:
- H/L MEP works, 60% completed
- Fire pump installed, 100% completed
- Transfer pump installed, 100% completed
1st floor:
- Wall & floor tile works in apartment, 100% completed
- Floor tile works in corridor, 100% completed
- Aluminum works: framing, 100% completed
- Glassing, 100% completed
- Vanity counters, 95% completed
- Wardrobe fixed, 100% completed
- Kitchen cabinet installation works, 70% completed
- Internal wooden door fixing, 90% completed
- Gypsum board closure, 100% completed
- Painting wall, 95% completed
- Painting ceiling, 90% completed

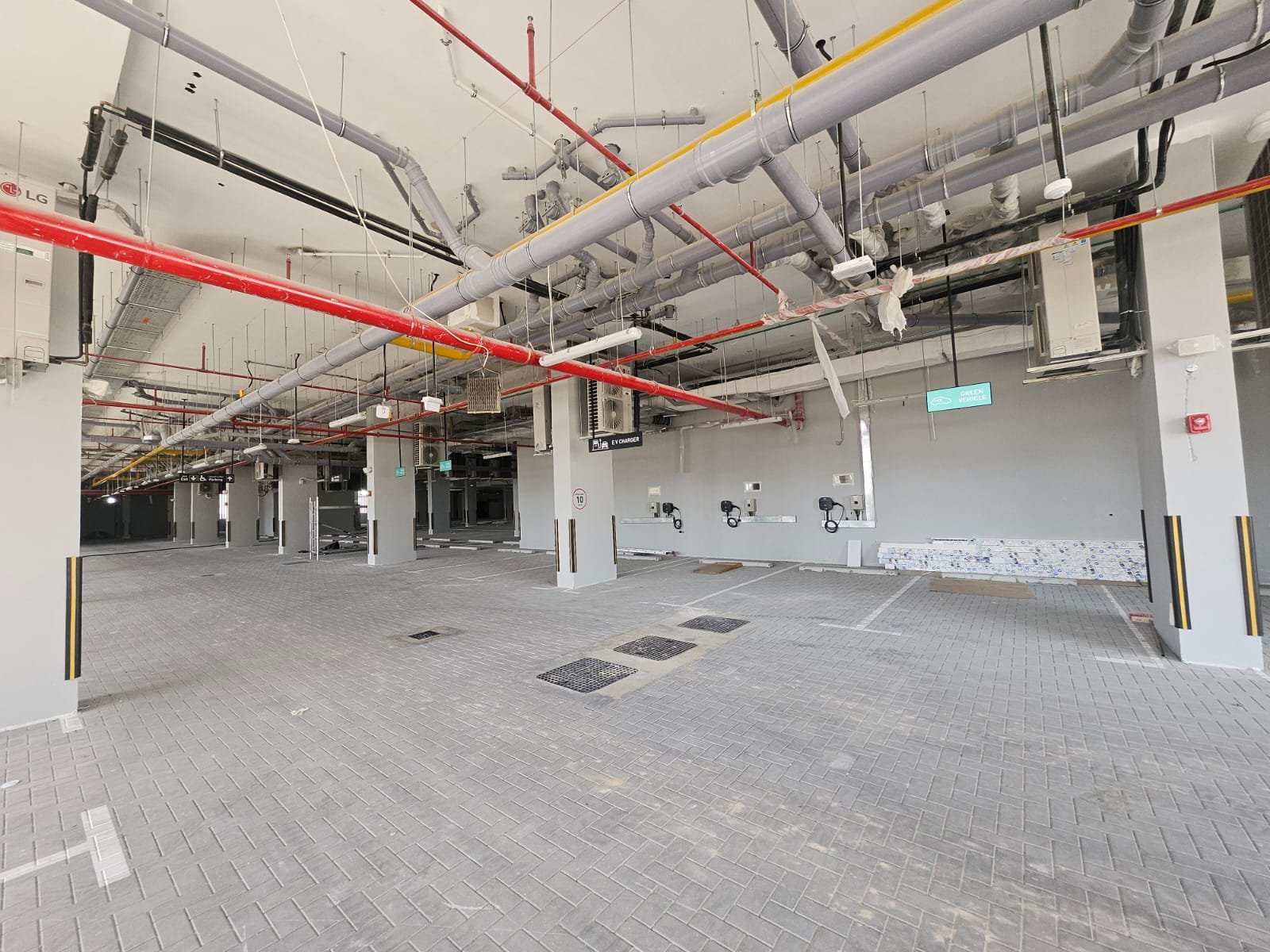

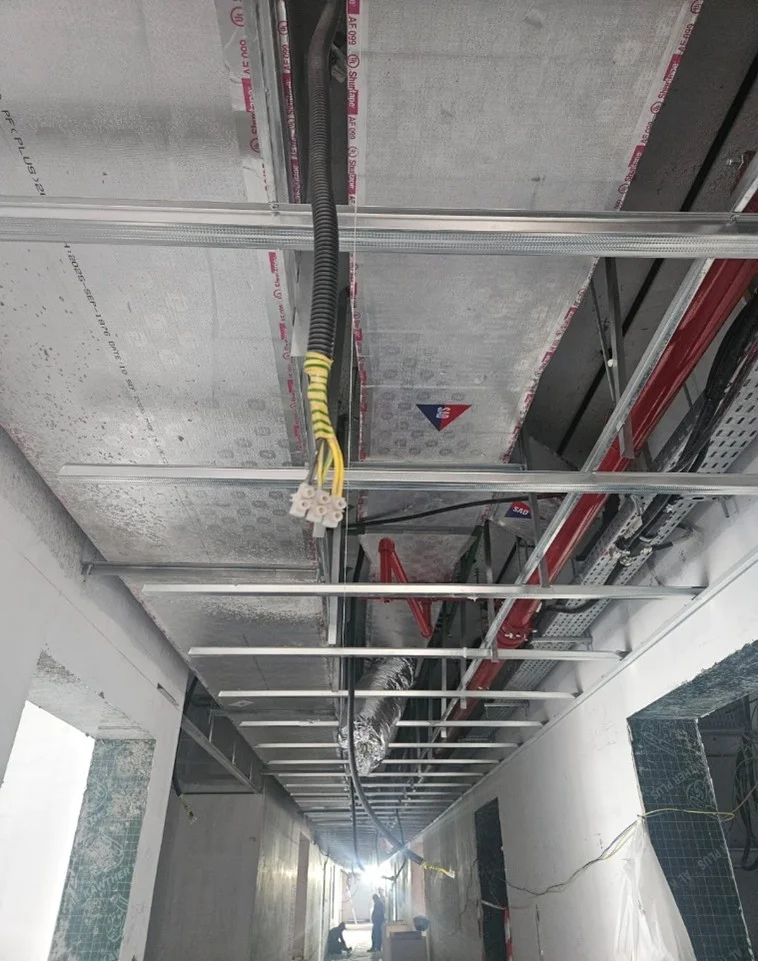

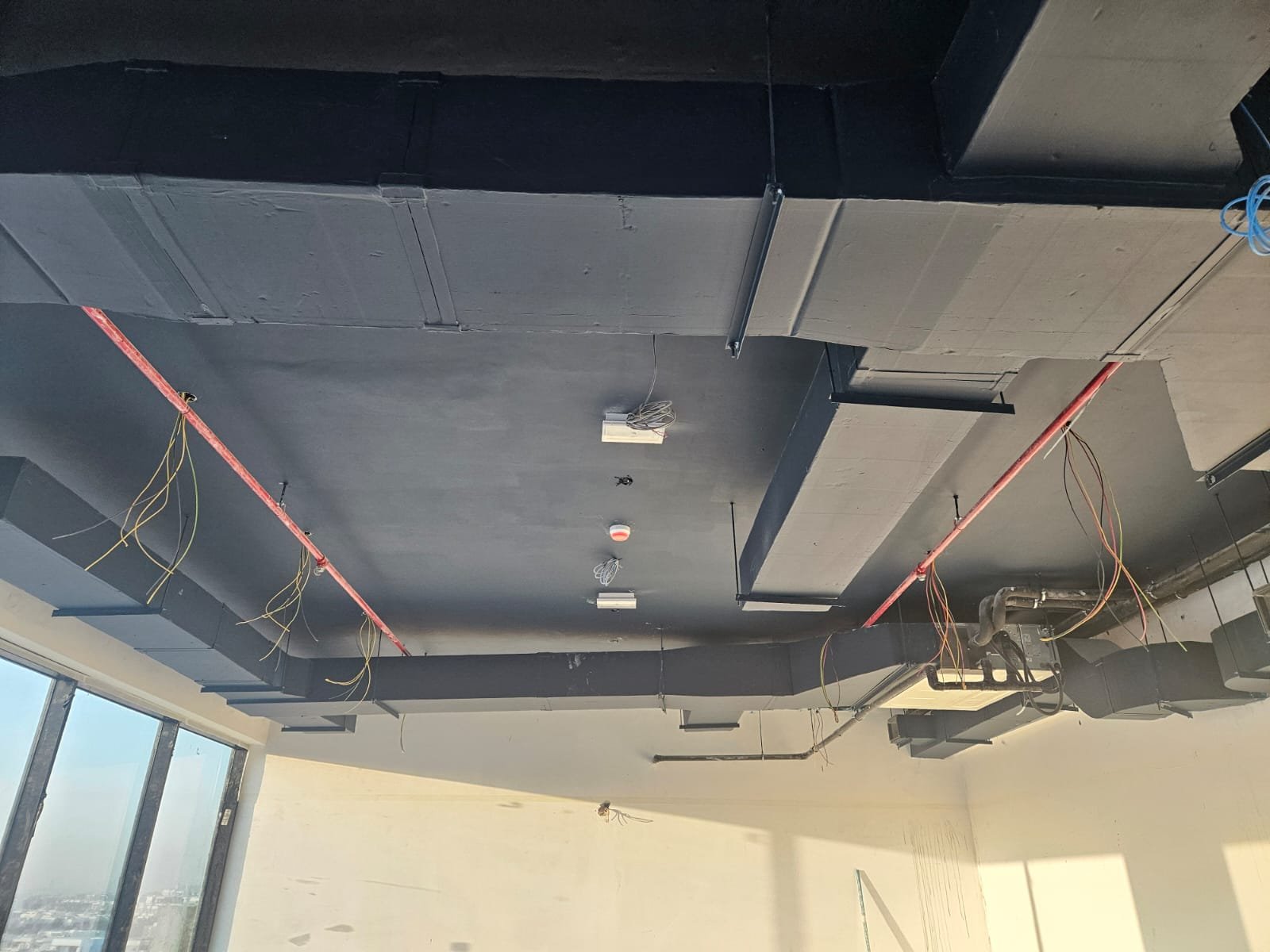

HL works
- 95% completed
2nd floor:
- Wall tile works, 100% completed
- Floor tile works, 100% completed
- Balcony tile, 40% completed
- Aluminum works: framing, 100% completed
- False ceiling: framing works, 100% completed
- Gypsum board closure, 100% completed
- Vanity counters, 100% completed
- Wardrobe fixed, 100% completed
- Kitchen cabinet works, 70% completed
- Internal wooden door fixing, 90% completed
- Painting wall, 95% completed
- Painting ceiling, 90% completed
MEP works:
- MEP H/L, 95% completed
3rd floor
Finishing works
- Waterproofing wet area, 100% completed
- Balcony waterproofing, 25% completed
- Floor tile works, 100% completed
- Wall tile works, 100% completed
- False ceiling closure, 100% completed
- Painting wall, 95% completed
- Painting ceiling, 95% completed
- Kitchen cabinets works, 35% completed
- Wardrobes, 45% completed
- Internal wooden doors, 90% completed
MEP works:
- MEP H/L, 95% completed
4th floor
Finishing works:
- Wall plaster works, 100% completed
- Waterproofing wet area, 100% completed
- Balcony waterproofing, 95% completed
- Floor tile works, 100% completed
- Wall tile works, 100% completed
- False ceiling framing work, 100% completed
- False ceiling board closure, 70% completed
- Painting wall, 90% completed
- Painting ceiling, 90% completed
- Service rooms wooden door works, 100% completed
MEP works:
- MEP H/L, 95% completed
- MEP 1st fix works, 100% completed

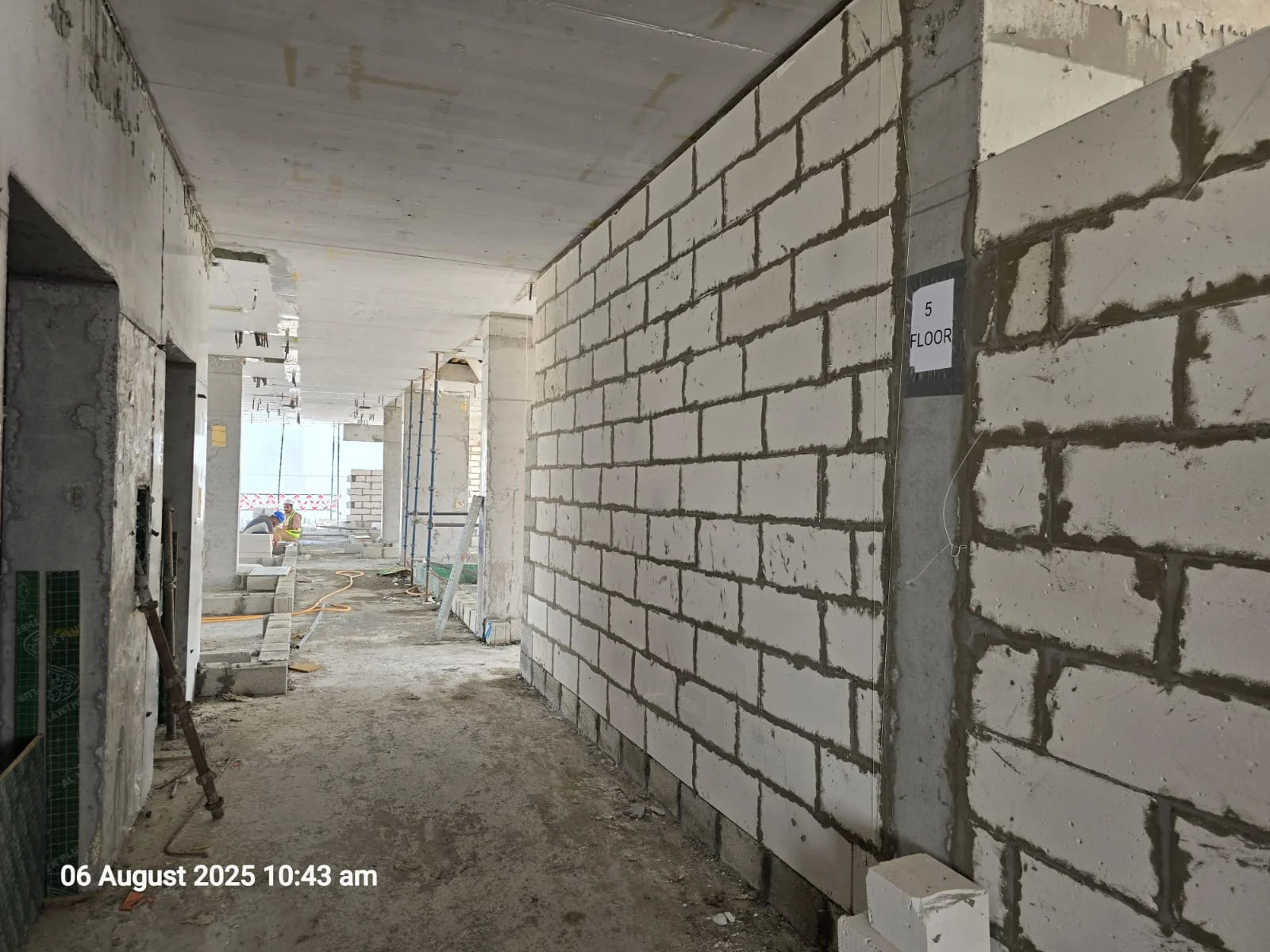

5th floor
Finishing works:
- Wall plastering, 100% completed
- Waterproofing wet area, 100% completed
- Balcony waterproofing, 95% completed
- Floor tiles, 100% completed
- Wall tiles, 100% completed
- Balcony tiles, 35% completed
- Wall painting, 80% completed
- Ceiling painting, 90% completed
- False ceiling framing works, 60% completed
MEP works:
- MEP H/L, 95% completed
- MEP 1st fix works, 100% completed
6th floor
Finishing works:
- Plastering works, 100% completed
- Wall painting works, 80% completed
- Ceiling painting, 80% completed
- Floor tiles, 100% completed
- Wall tiles, 80% completed
- False ceiling framing works, 45% completed
MEP works:
- MEP 1st fix works, 100% completed
- HL works, 60% completed
Roof floor
Structure works:
- Aluminum pergola foundation casted, 100% completed
Finishing works:
- Parapet plaster works, 100% completed
- Combo system work – foam, 100% completed

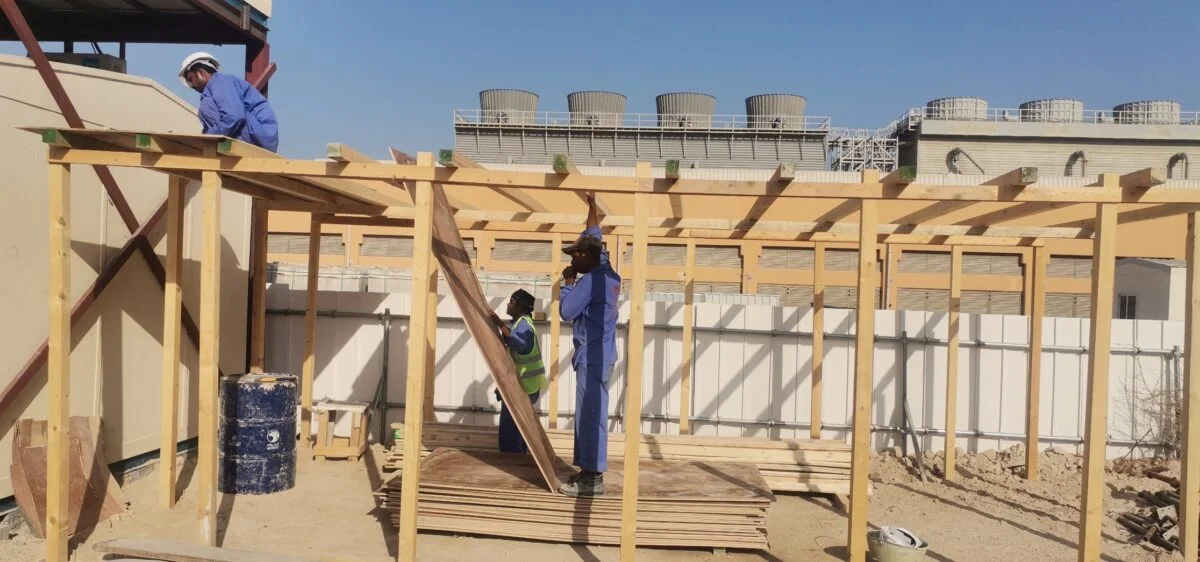

- Aluminum pergola installation, 100% completed

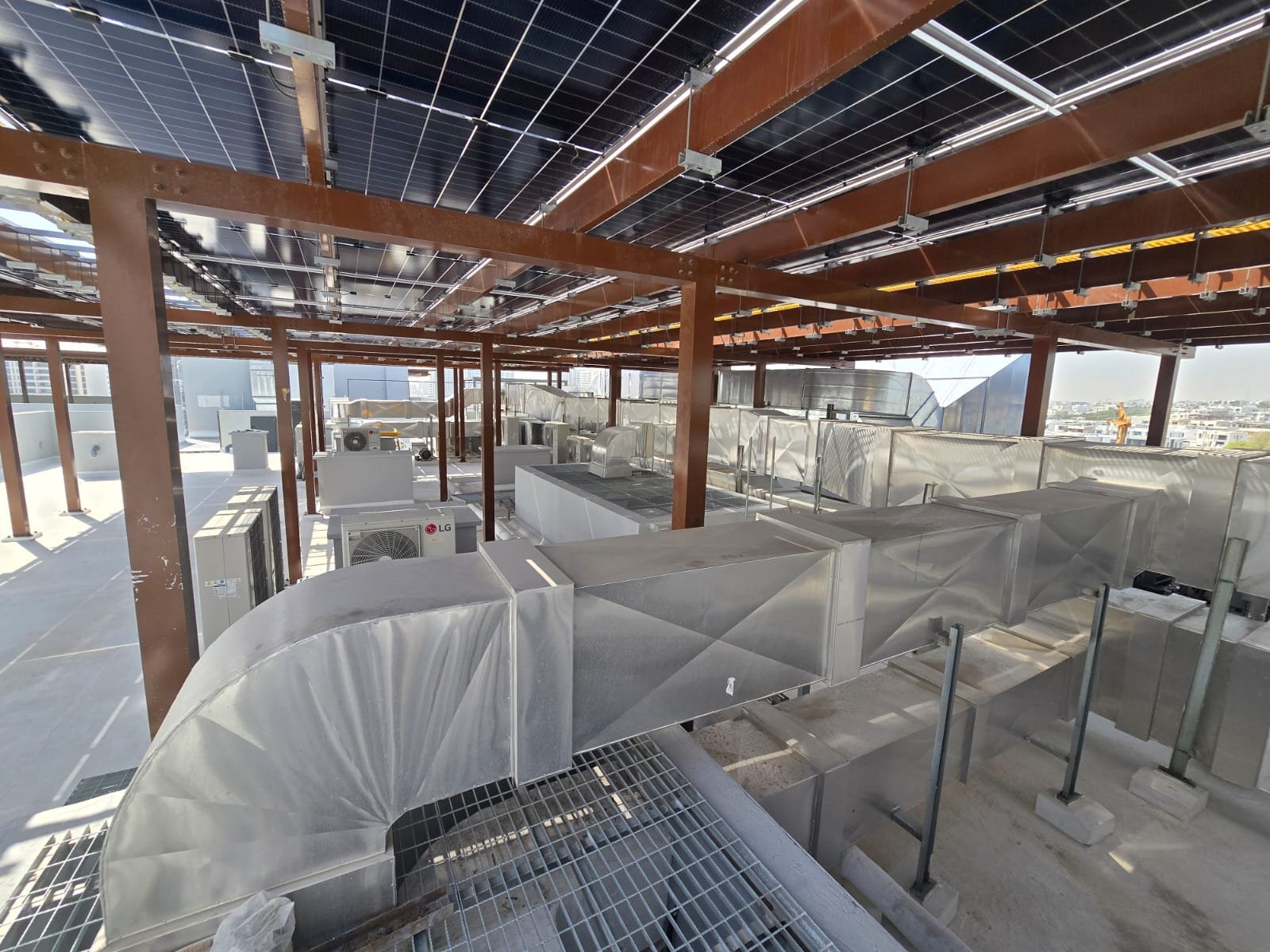

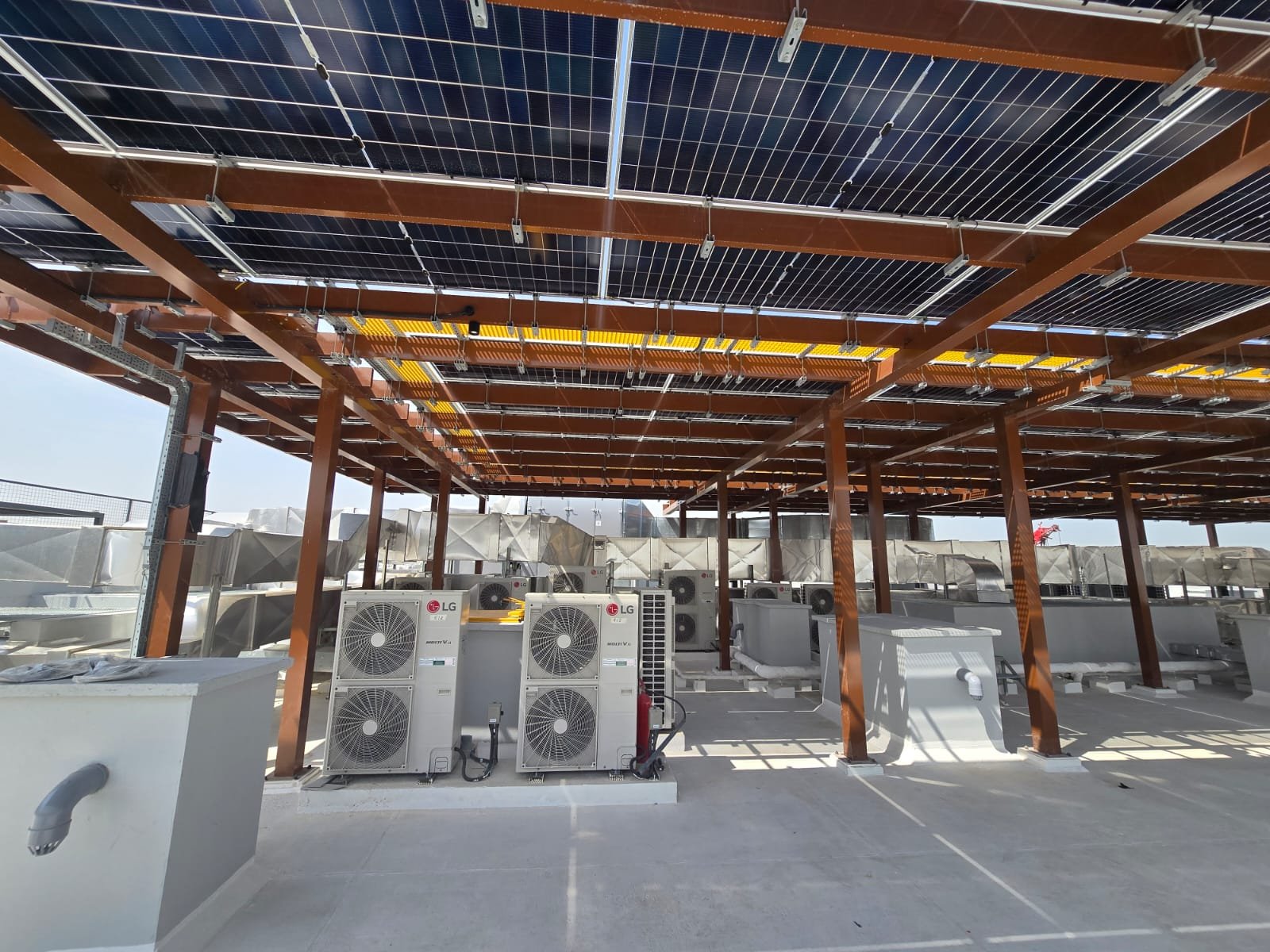

- Solar panel fixing, started
MEP works:
- MEP machine delivery and installation, 100% completed
External elevation finishing works
Elevation 1
- Plaster works, 100% completed
- Painting works, 100% completed
- Aluminum frame and glazing works, 100% completed
- Balcony handrail, 100% completed
- Façade installation, 100% completed
Right elevation
- Plaster works, 100% completed
- Painting works, 80% completed
- Aluminum frame and glazing works, 100% completed
- Balcony works, 100% completed
Back elevation
- Plaster works, 80% completed
- Painting works, 80% completed
- Aluminum and glazing works, 80% completed
Left elevation
- Plaster works, 100% completed
- Painting works, 60% completed
- Aluminum and glazing works, 100% completed
- Balcony handrail works, 40% completed
Internal finishing works
Lift works:
- Lift unit one installation, 100% completed

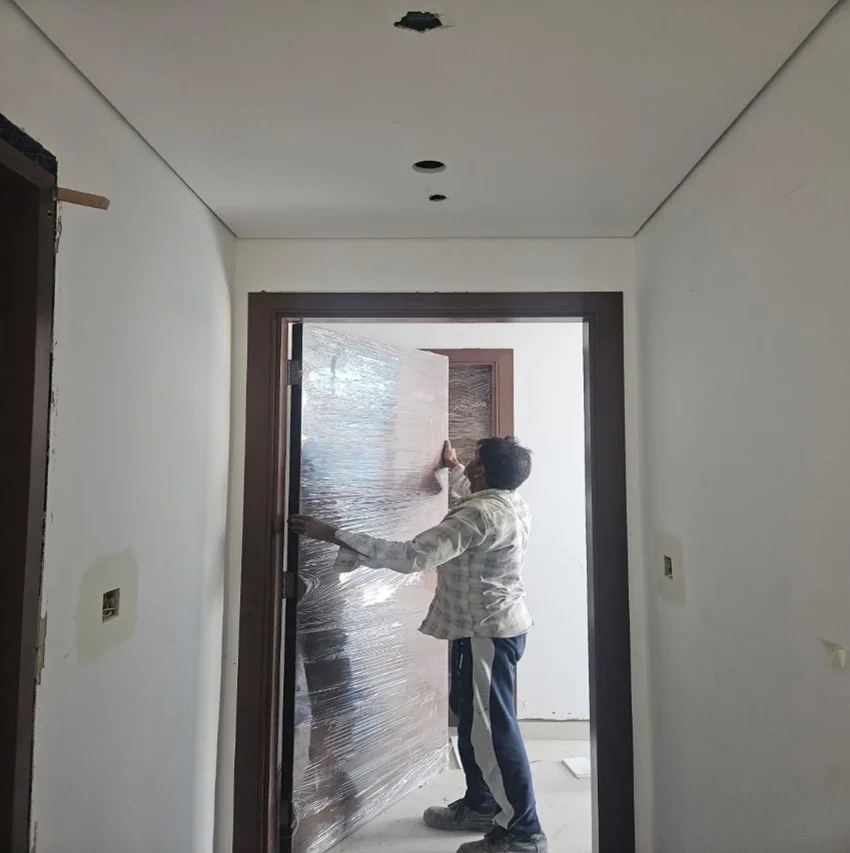

- Paneling works, started
- Unit 2 railing works, 100% completed

Construction start
JULY 2024
Planned completion
30th March 2026

Progress
70.9%
Stage
Ground floor
Finishing works – common area:
- Ceiling paint preparation works, 85% completed
- Wall plaster works, 95% completed
- Aluminum louver, 50% completed
- Main entrance, 50% completed
- LV room, 95% completed
1st floor
- H/L MEP works, 95% completed
- Generator installation, 100% completed
2nd floor
- Planter box structure works, 100% completed
- Terrace area block work, 100% completed
Finishing works
- Planter box & terrace plaster works, 100% completed
- Aluminium works: framing, 100% completed / glassing, 90% completed
- Vanity counters, 95% completed
- Wardrobe fixed, 95% completed

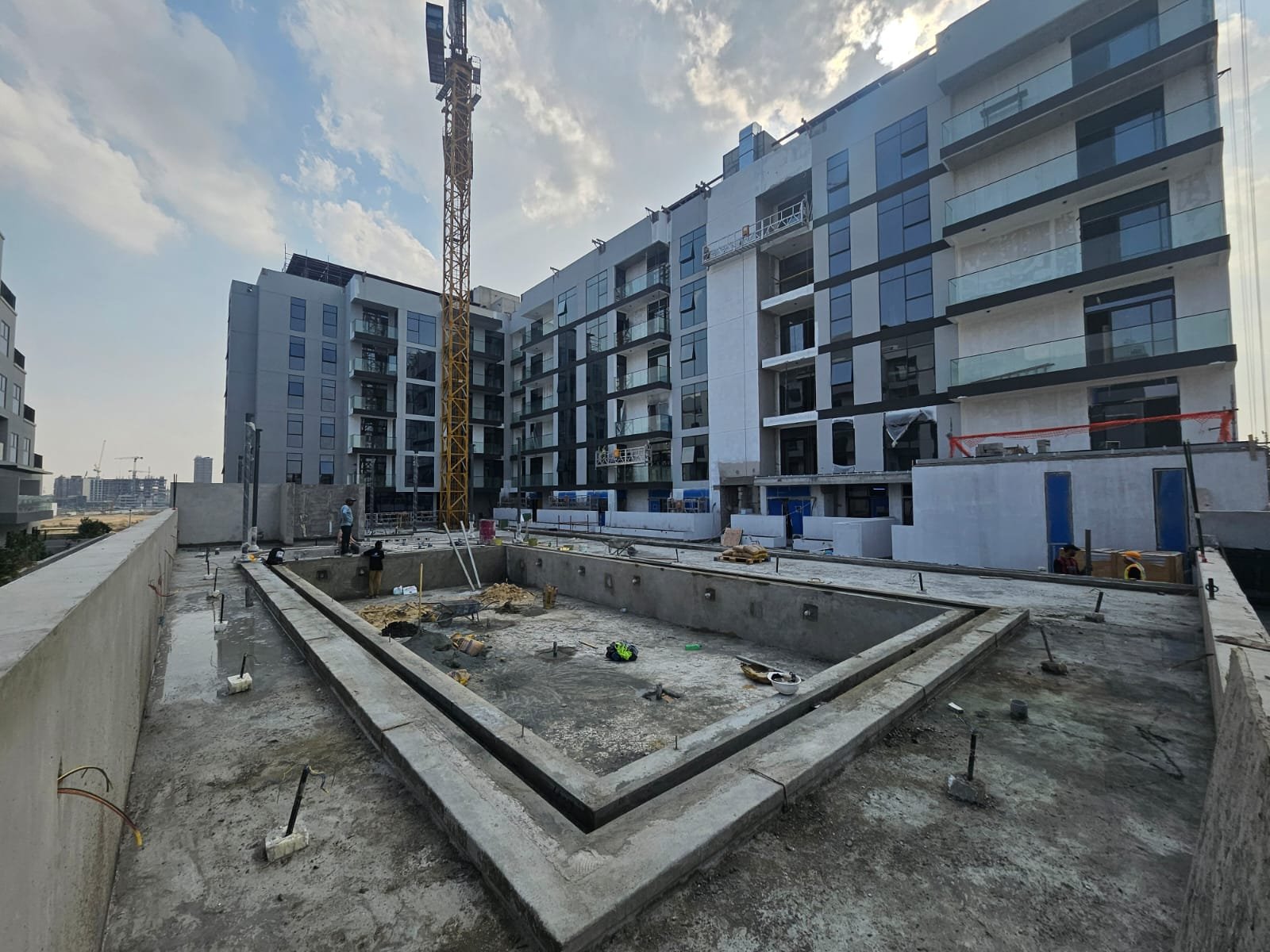

- Swimming pool waterproofing, 30% completed
2nd floor – finishing works
- Aluminium works: framing, 85% completed
- Kitchen work, 30% completed
- Gypsum board closure, 100% completed
- Vanity counters, 90% completed
3rd floor – finishing works
- Aluminium works: framing, 85% completed
- Gypsum board closure, 70% completed
- Paint preparation works, 95% completed
- Tiles works, 100% completed
MEP works
- MEP H/L, 95% completed
4th floor – finishing works
- Aluminium works: framing, 85% completed
- Gypsum board closure, 70% completed
- Paint preparation works, 95% completed
- Tiles works, 100% completed
MEP works
- MEP H/L, 95% completed
5th floor – finishing works
- Wall plaster works, 100% completed
- Flooring tiles works, 65% completed
- Waterproofing wet area, 80% completed
MEP works
- MEP H/L, 85% completed
- MEP 1st fix works, 100% completed
6th floor – finishing works
- Wall plaster works, 100% completed
- Flooring tiles works, 80% completed
- Waterproofing wet area, 70% completed
Roof floor – structure works
- AC foundation, 100% completed
Roof floor – finishing works
- Combo system work – foam, 100% completed
- Screed, 100% completed
- Pergola columns fixed, 70% completed
- Solar columns fixed, 80% completed
MEP works
- MEP 2nd fix works, 100% completed
- Outdoor AC machine delivered, 100% completed
- Water tank installed, 100% completed
External elevation finishing works
- Elevation 1 plaster works, 100% completed
- Elevation 2 plaster works, 100% completed
- Elevation 3 plaster works, 95% completed
- Elevation 4 plaster works, 100% completed
- Elevation 1 paint works, 90% completed
- Elevation 2 primer works, 100% completed
- Elevation 3 primer works, 90% completed
- Elevation 4 primer works, 90% completed
Internal finishing works
Lift works:
- Lift pit waterproofing, 100% completed
- Elevators work, 40% completed
Construction start
15th JULY 2024
Planned handover
30th March 2026

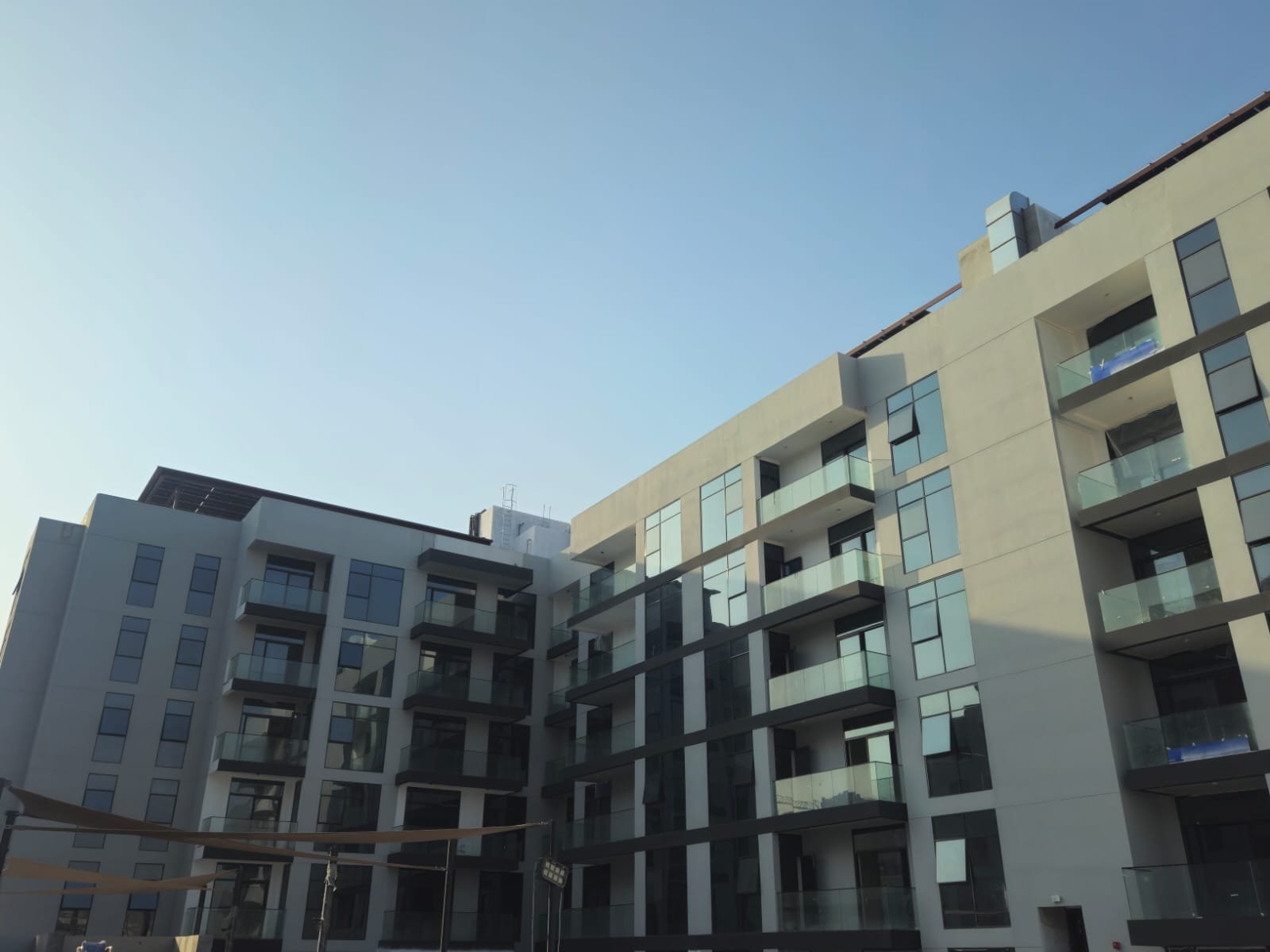

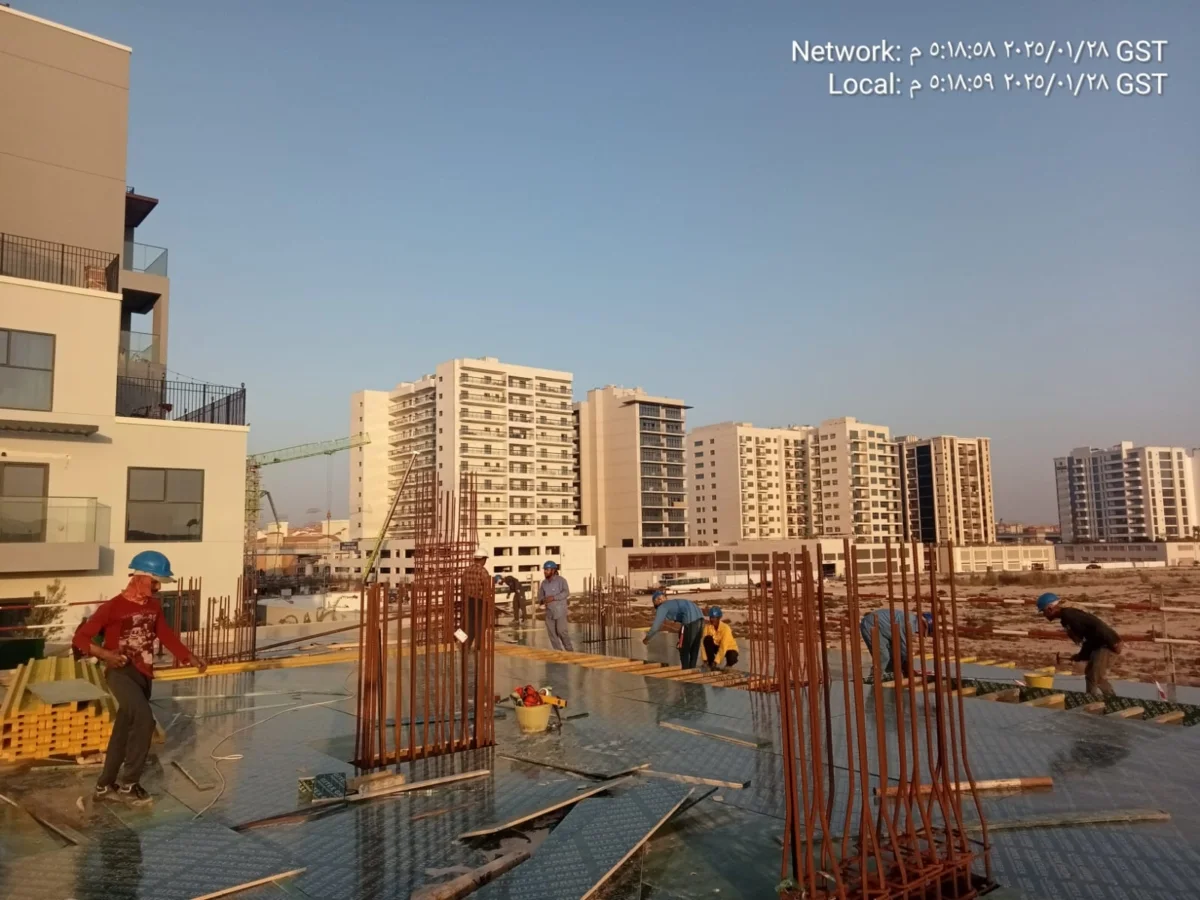

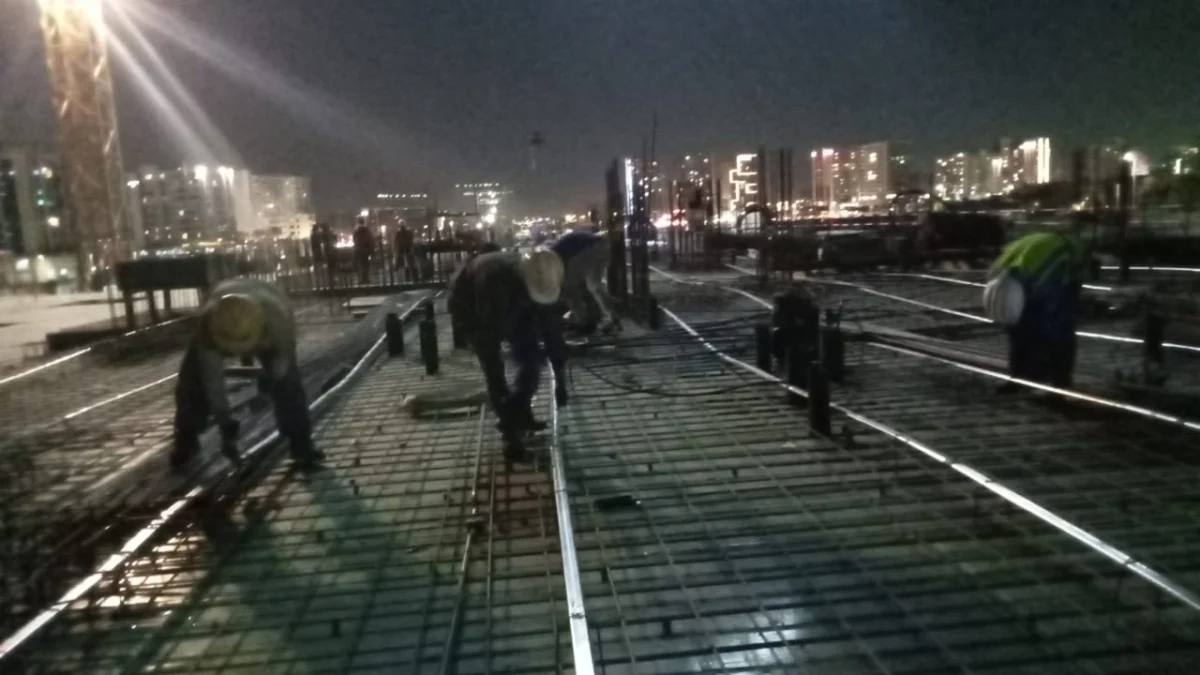

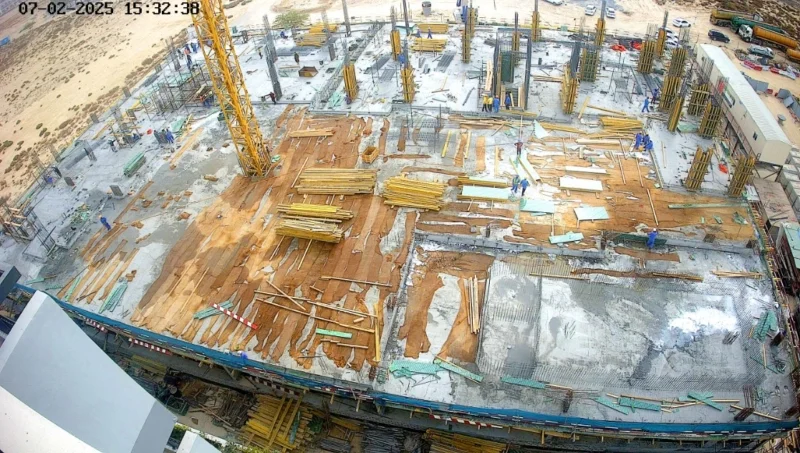

Progress
60.20%
Stage
Ground floor
Structure works – finishing works
- Ceiling paint preparation works, 70% completed
- Wall plaster works, 90% completed
- Epoxy flooring for pump room, 100% completed
- GRP for water tank, 100% completed
- FIC manhole GRP work, 100% completed
MEP works
- H/L MEP works, 45% completed
- Fire pump installed, 100% completed
- Transfer pump installed, 100% completed
1st floor
Structure works
- Swimming pool deck slab & walls, 100% completed
Finishing works
- Wall & floor tile works in apartment, 98% completed
- Floor tile works in corridor, 98% completed
- Aluminium works: framing, 93% completed / glassing, 75% completed
- Vanity counters, 85% completed
- Wardrobe fixed, 85% completed
- Gypsum board closure, 100% completed
- Paint preparation works, 95% completed
MEP works
- MEP works, 95% completed
2nd floor – finishing works
- Wall tile works, 100% completed
- Floor tile works, 100% completed
- Aluminium works: framing, 40% completed
- False ceiling: framing works, 100% completed
- Gypsum board closure, 60% completed
- Vanity counters, 50% completed
- Wardrobe fixed, 50% completed
- Paint preparation works, 95% completed
MEP works
- MEP H/L, 95% completed
3rd floor – finishing works
- Waterproofing wet area, 100% completed
- Floor tile works, 100% completed
- Wall tile works, 100% completed
- Paint preparation works, 90% completed
MEP works
- MEP H/L, 75% completed
4th floor – finishing works
- Wall plaster works, 95% completed
- Waterproofing wet area, 100% completed
- Ceiling anti-fungus wet area paint, 100% completed
- Wall tile works, 15% completed
- Floor tile works, 70% completed
MEP works
- MEP H/L, 35% completed
- MEP 1st fix works, 100% completed
5th floor – finishing works
- Block works, 100% completed
- Wall plaster works, 35% completed
- Ceiling anti-fungus wet area paint, 100% completed
MEP works
- MEP H/L, 25% completed
- MEP 1st fix works, 85% completed
6th floor – finishing works
- Block works, 100% completed
- Wall plaster works, 15% completed
Roof floor – structure works
- Aluminium pergola foundation casted, 100% completed
Roof floor – finishing works
- Parapet plaster works, 100% completed
- Combo system work – foam, 100% completed / screed, 65% completed
MEP works
- MEP 1st fix works, 100% completed
- FAHU delivered, 100%
Top roof floor – structure works
- Combo system works: foam, 0% completed
External elevation finishing works
- Elevation 1 plaster works, 100% completed
- Elevation 2 plaster works, 20% completed
- Elevation 3 plaster works, 45% completed
- Elevation 4 plaster works, 40% completed
- Elevation 1 primer works, 100% completed
- Elevation 2 primer works, 10% completed
- Elevation 4 primer works, 30% completed
- Balcony aluminium U-channel installation, 100% completed
Internal finishing works
Lift works
- Lift pit waterproofing, 100% completed
- Elevators work, 10% completed
Construction start
15th July 2024
Planned handover
30th March 2026

Progress

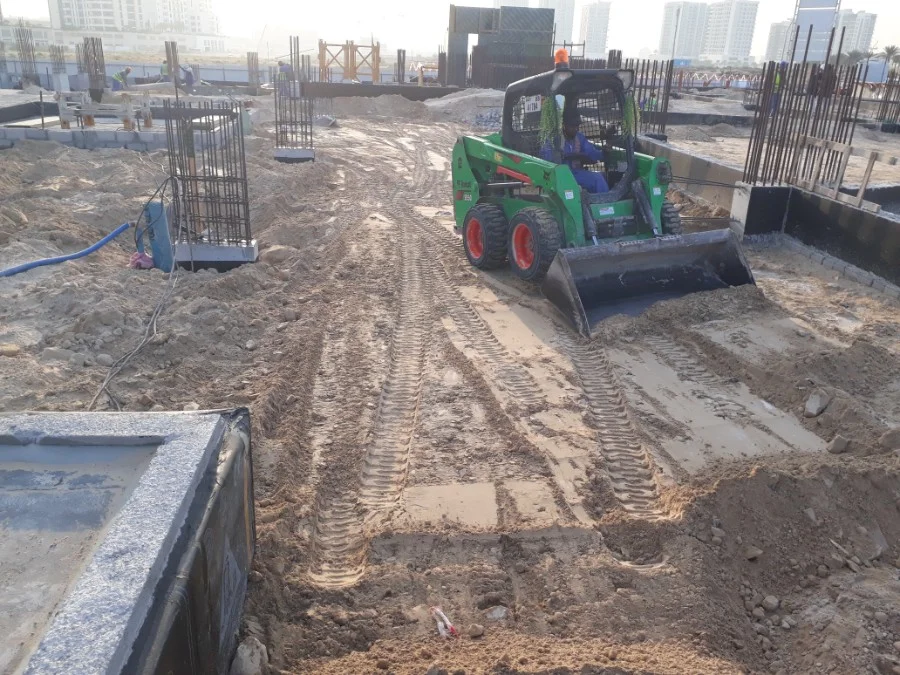

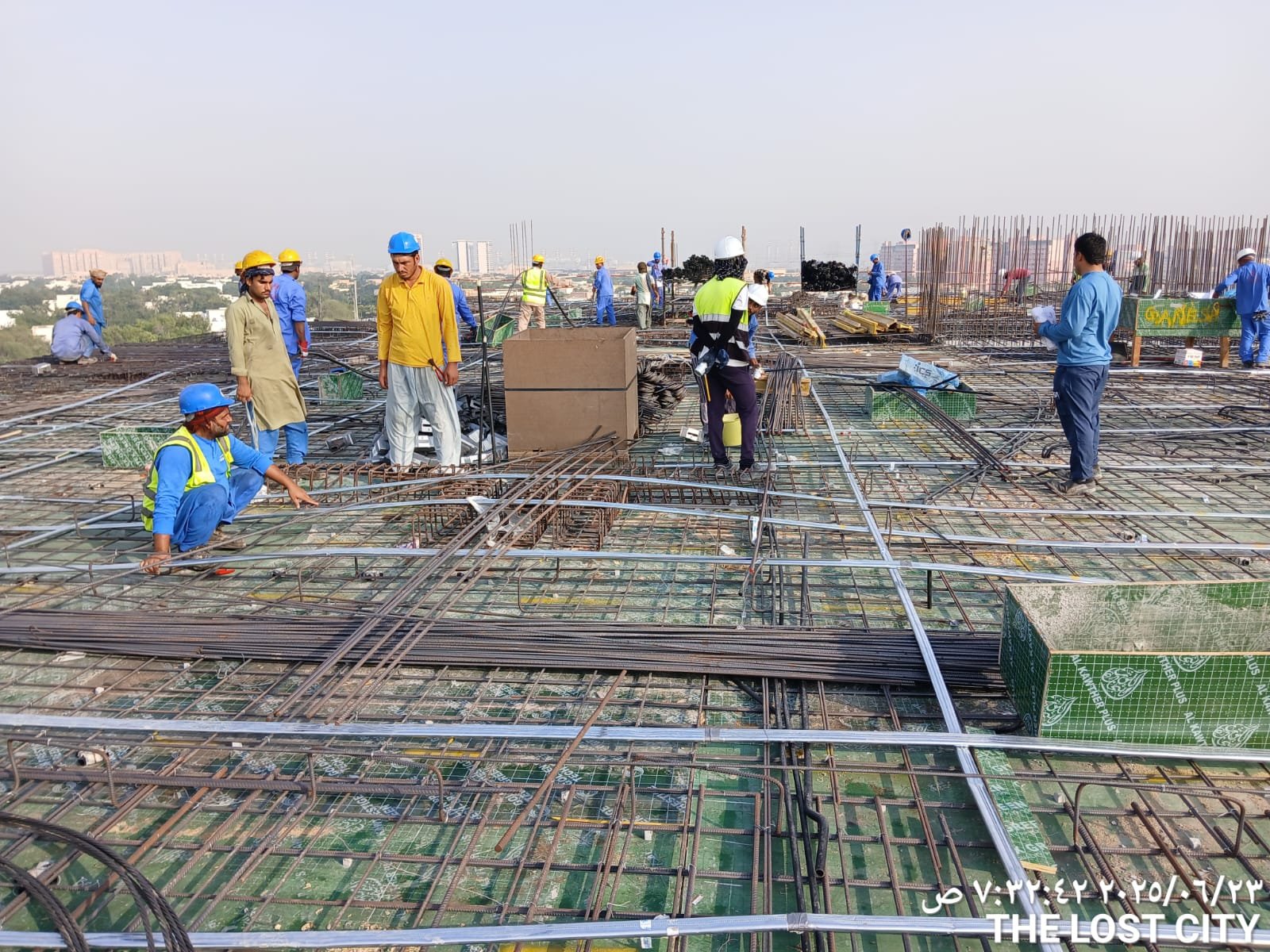

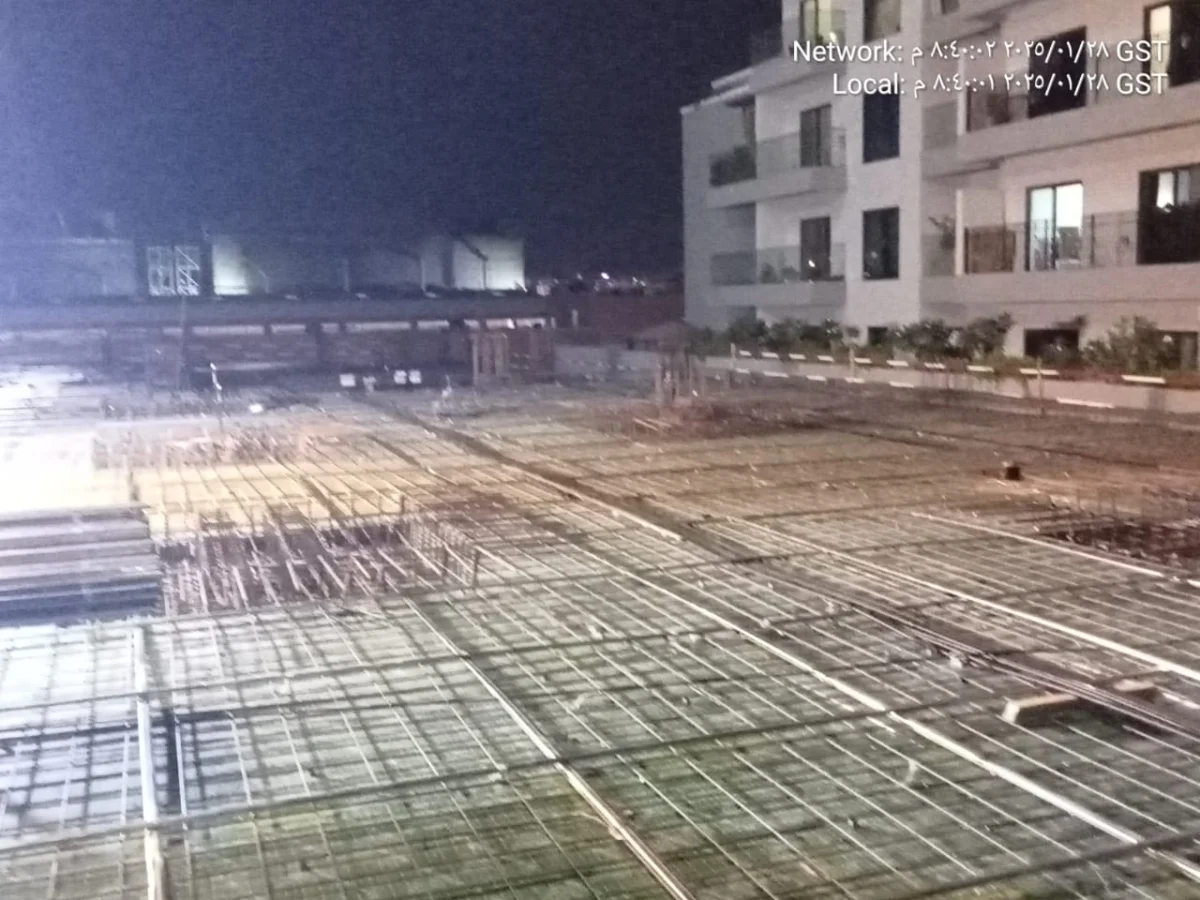

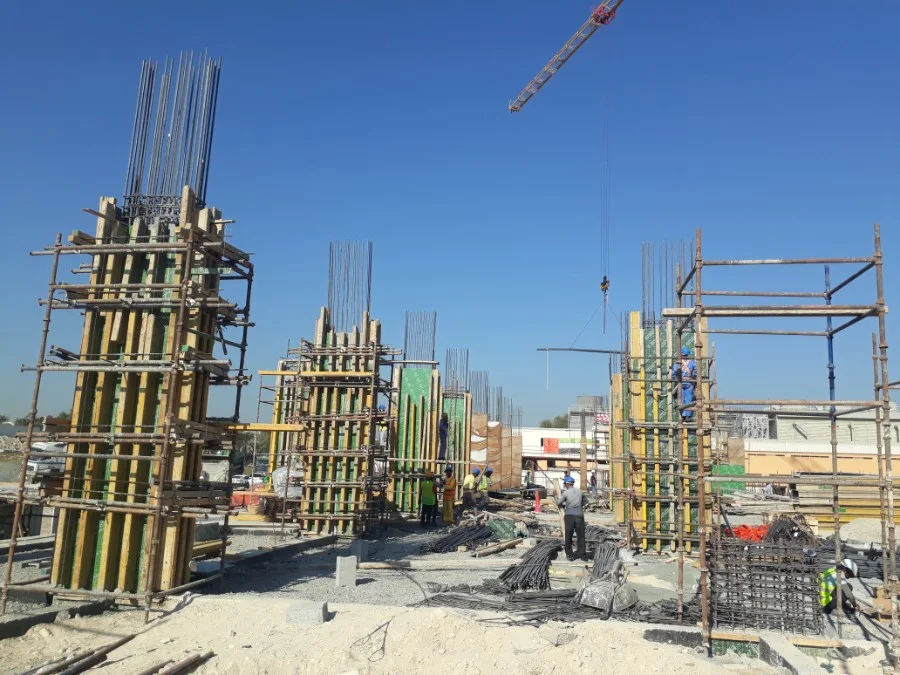

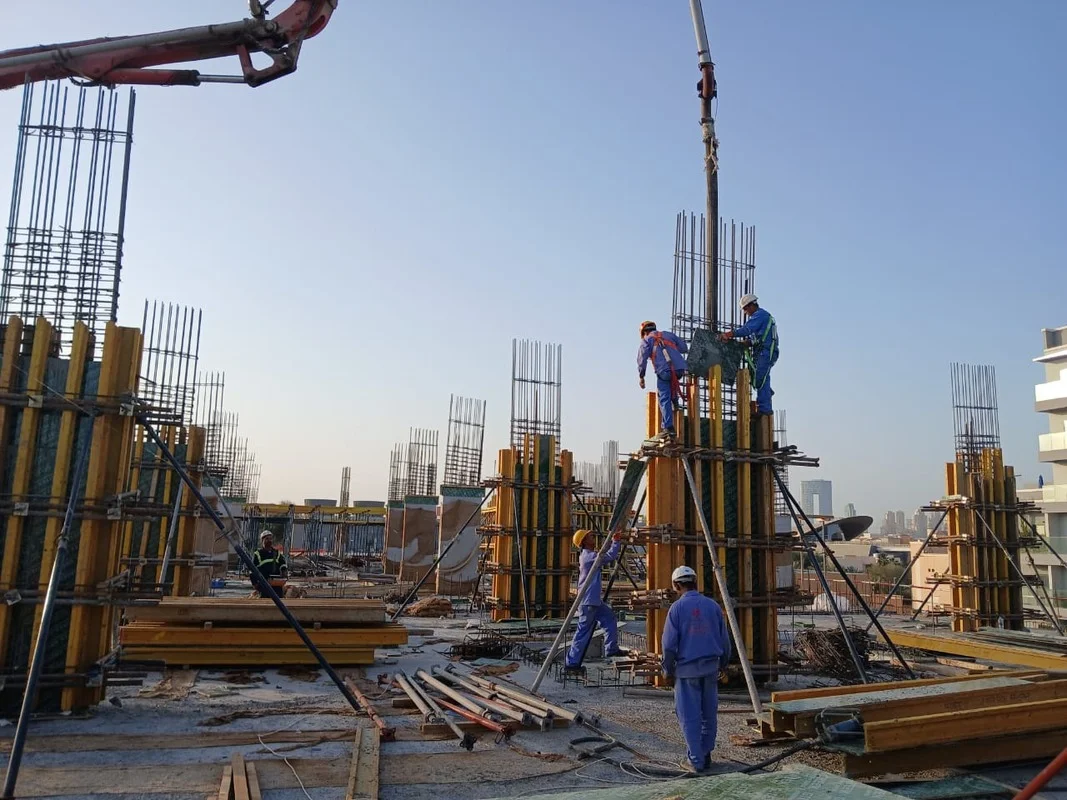

45.30%
Stage
Ground floor
- SOG preparation (part 2), 98% completed
- Ceiling paint preparation works, 60% completed
- Wall plaster works, 90% completed
- Main lobby block works, 100% completed
- Generator room block works, 100% completed
- Epoxy flooring for pump room, 90% completed
- GRP for water tank (preparation work started, materials delivered)
- FIC manhole GRP work, 60% completed
- H/L MEP works, 40% completed
- Fire pump set delivered
- Transfer pump delivered

1st floor

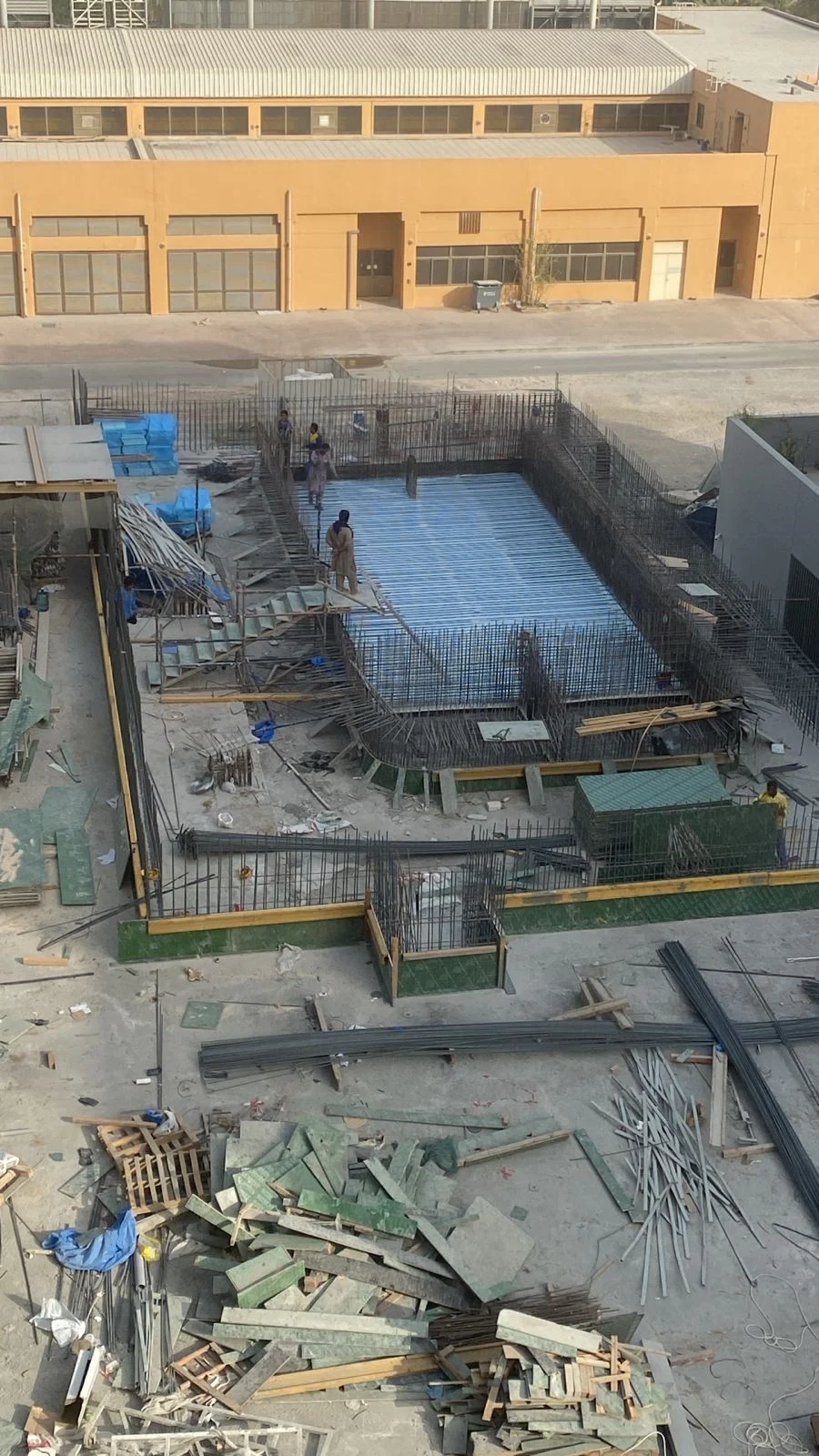

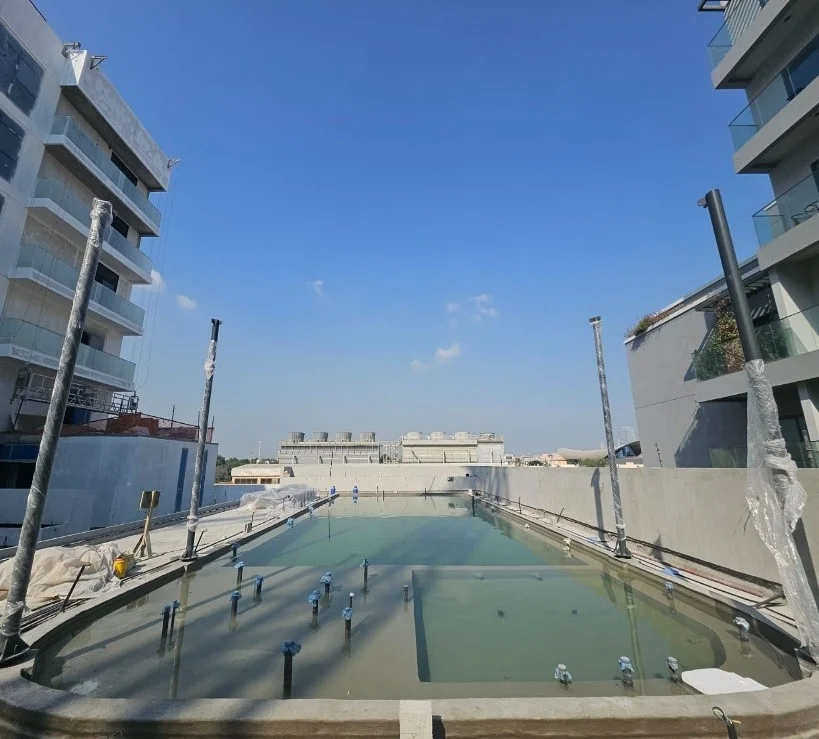

- Swimming pool flooring casted, 100% completed

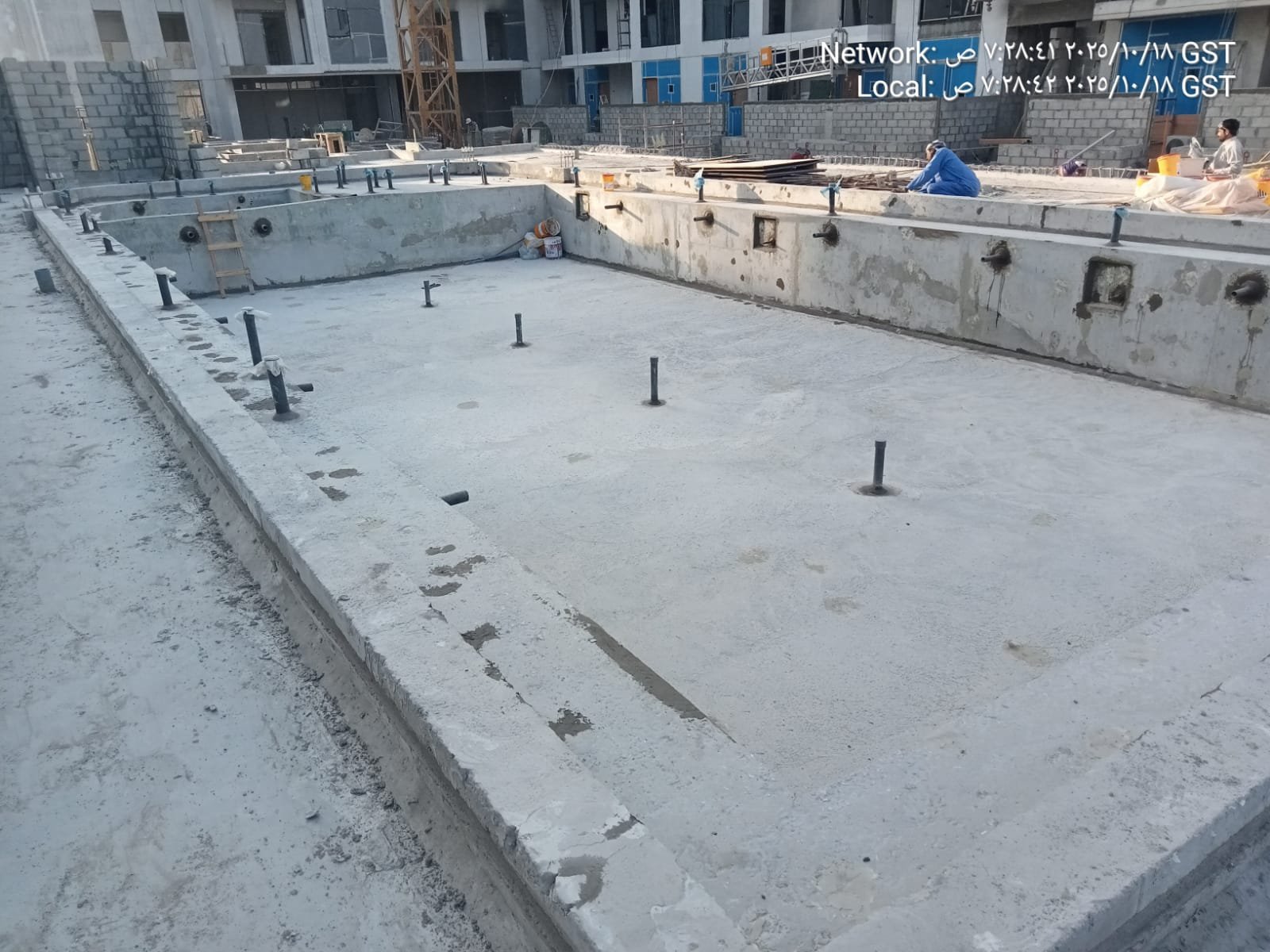

- Swimming pool deck slab & wall shuttering works ongoing

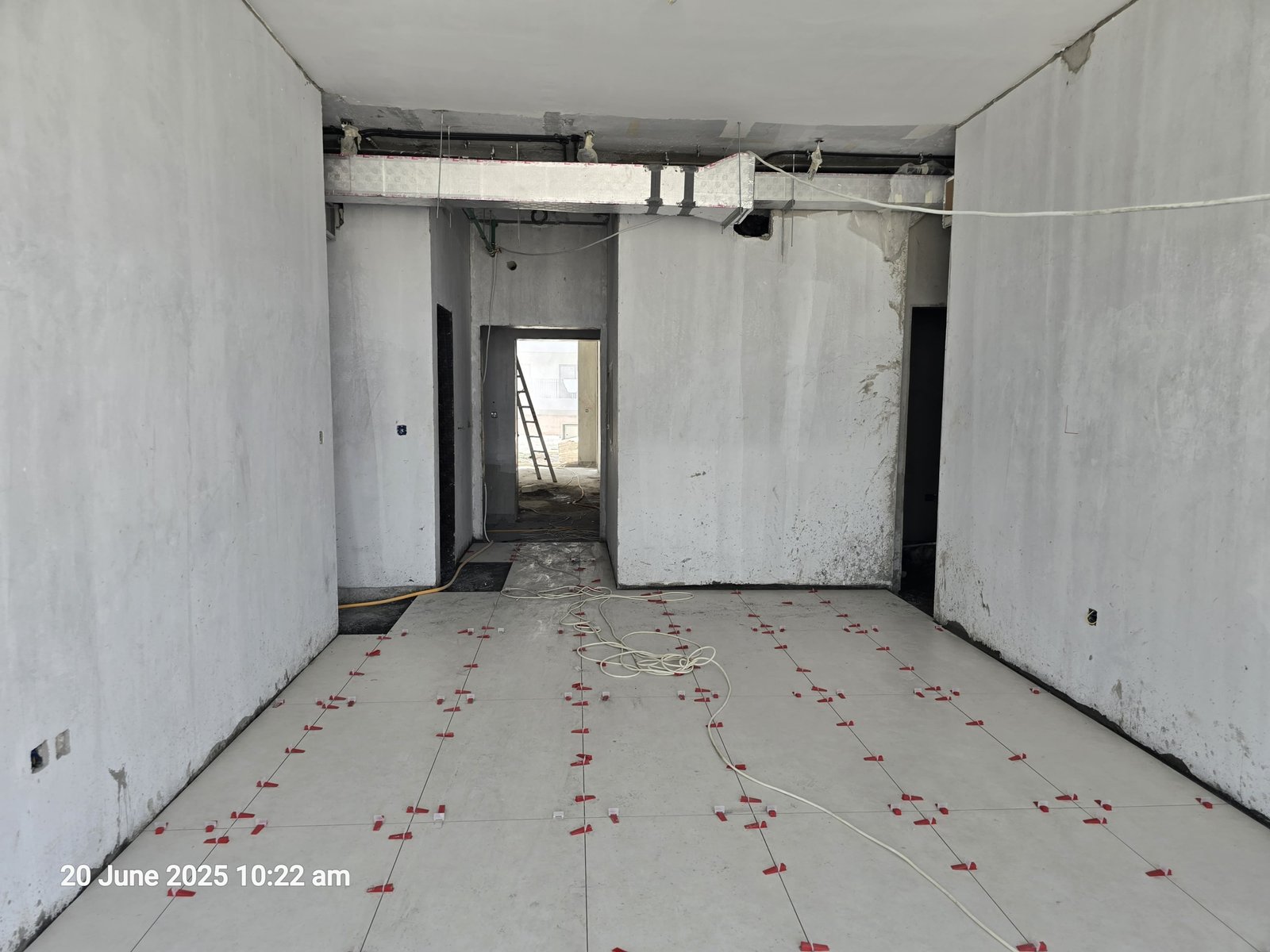

- Wall & floor tile works in apartment, 95% completed
- Floor tile works in corridor, 95% completed

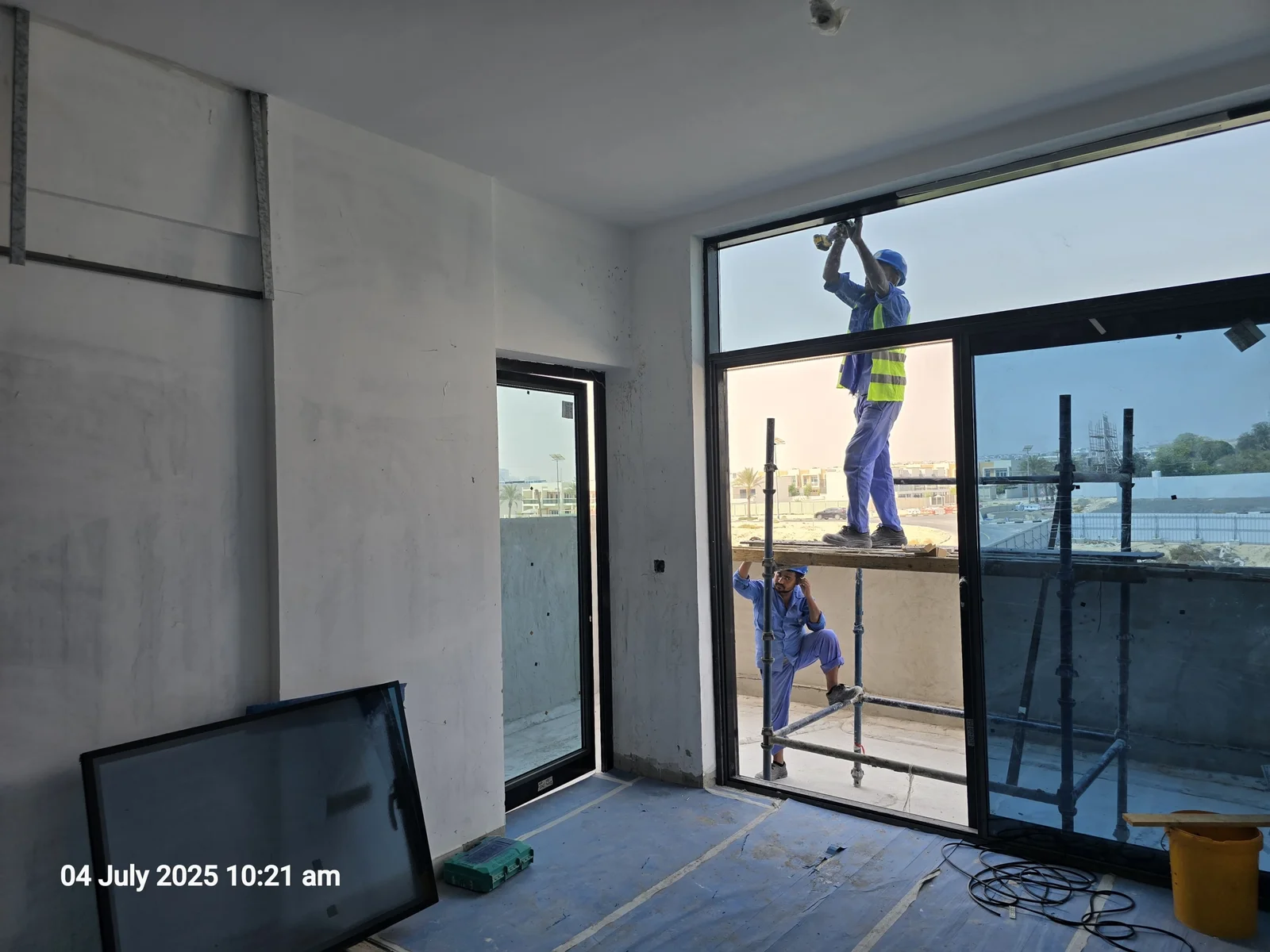

- Aluminum framing works, 90% completed
- Glass delivered
- Timber doors, 100% delivered
- Subframes, 100% completed
- Kitchen cabinet and wardrobe, 100% delivered

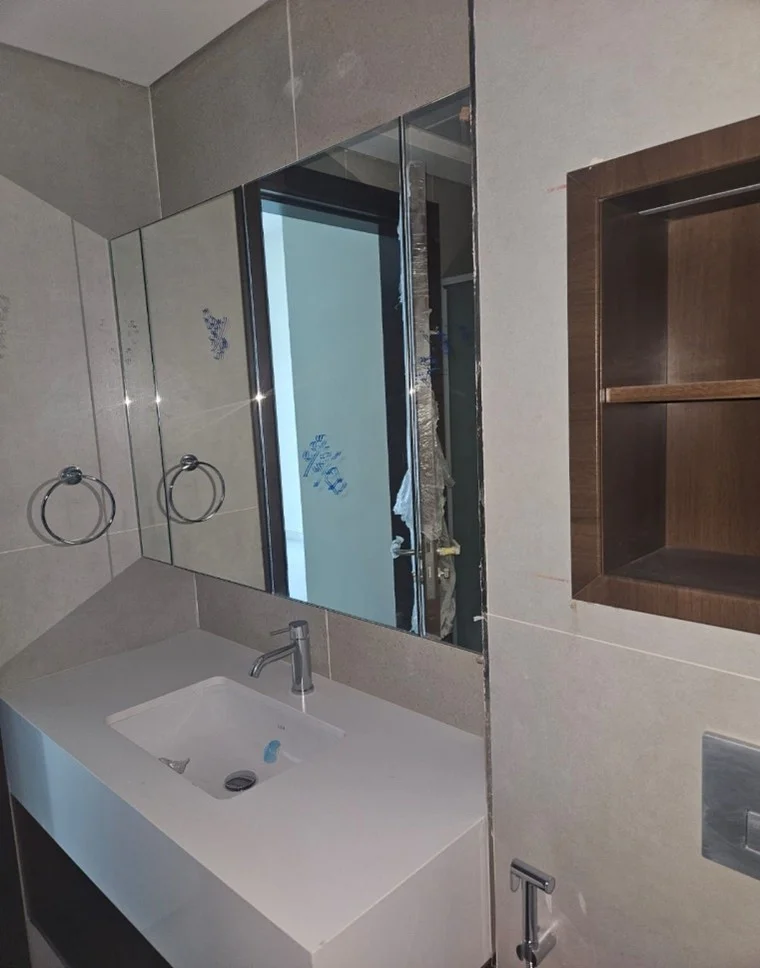

- Vanity counters, 100% material delivered

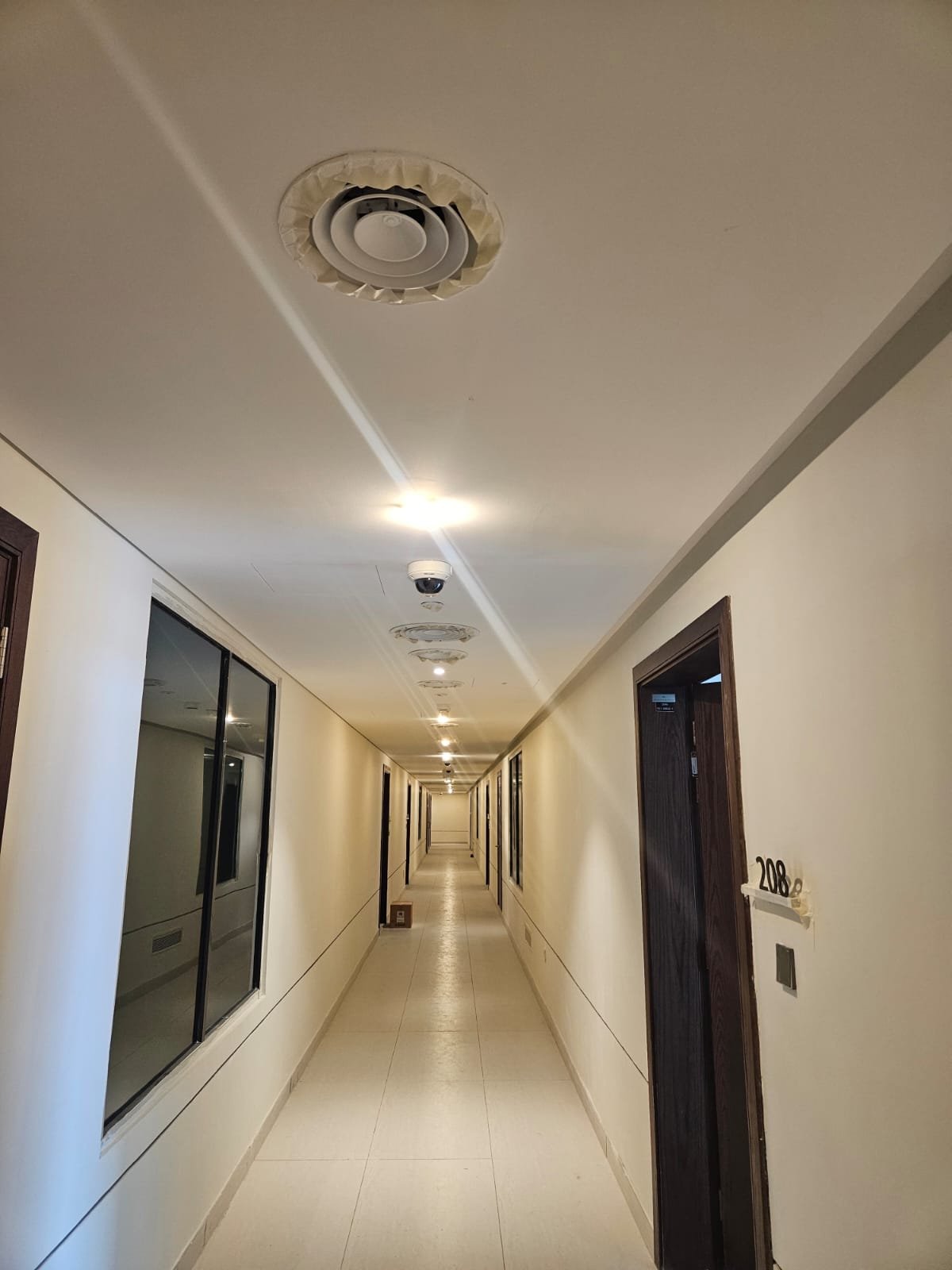

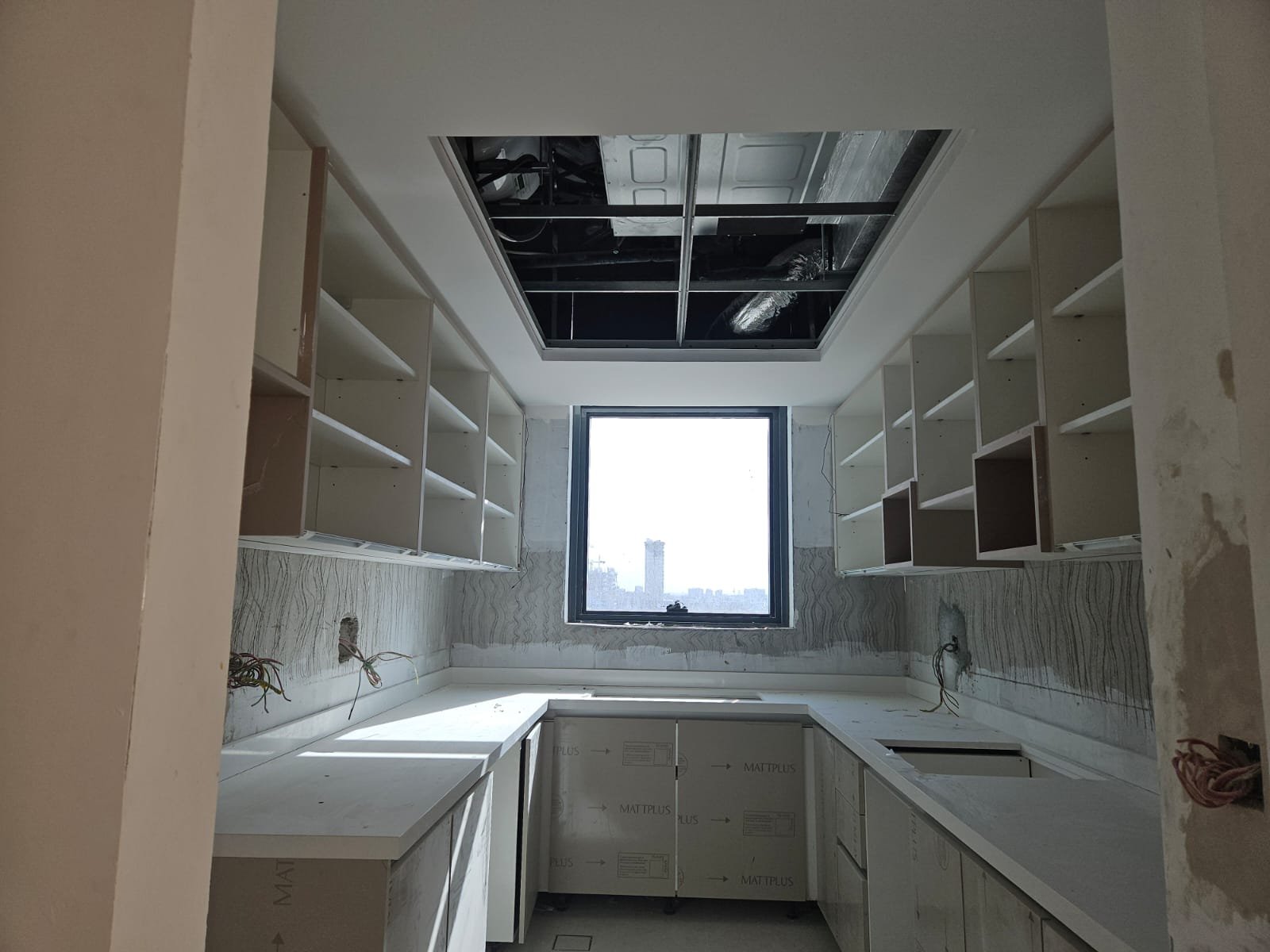

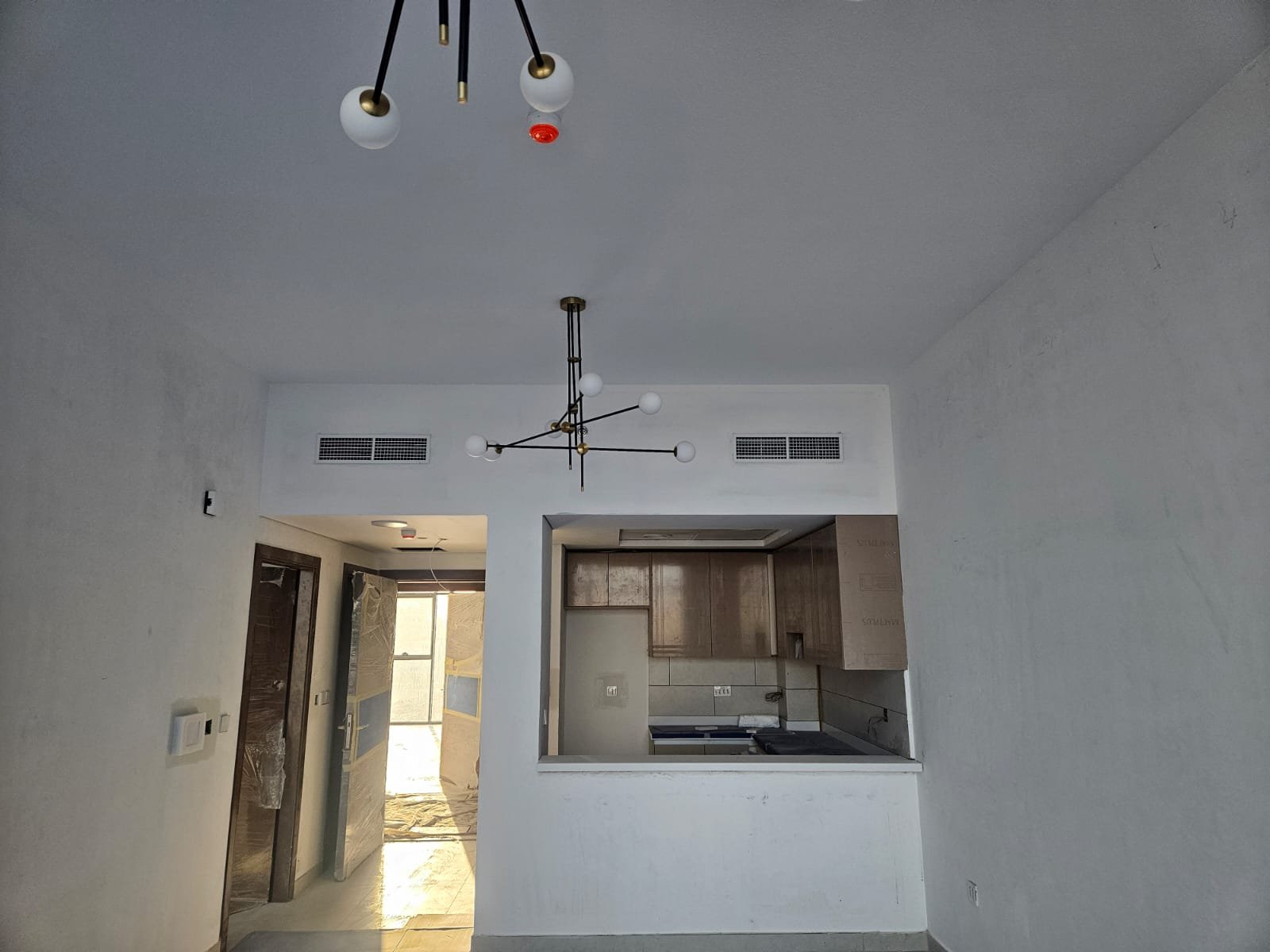

- False ceiling framing works, 100% completed / Gypsum board closure, 10% completed
- Paint preparation works, 90% completed

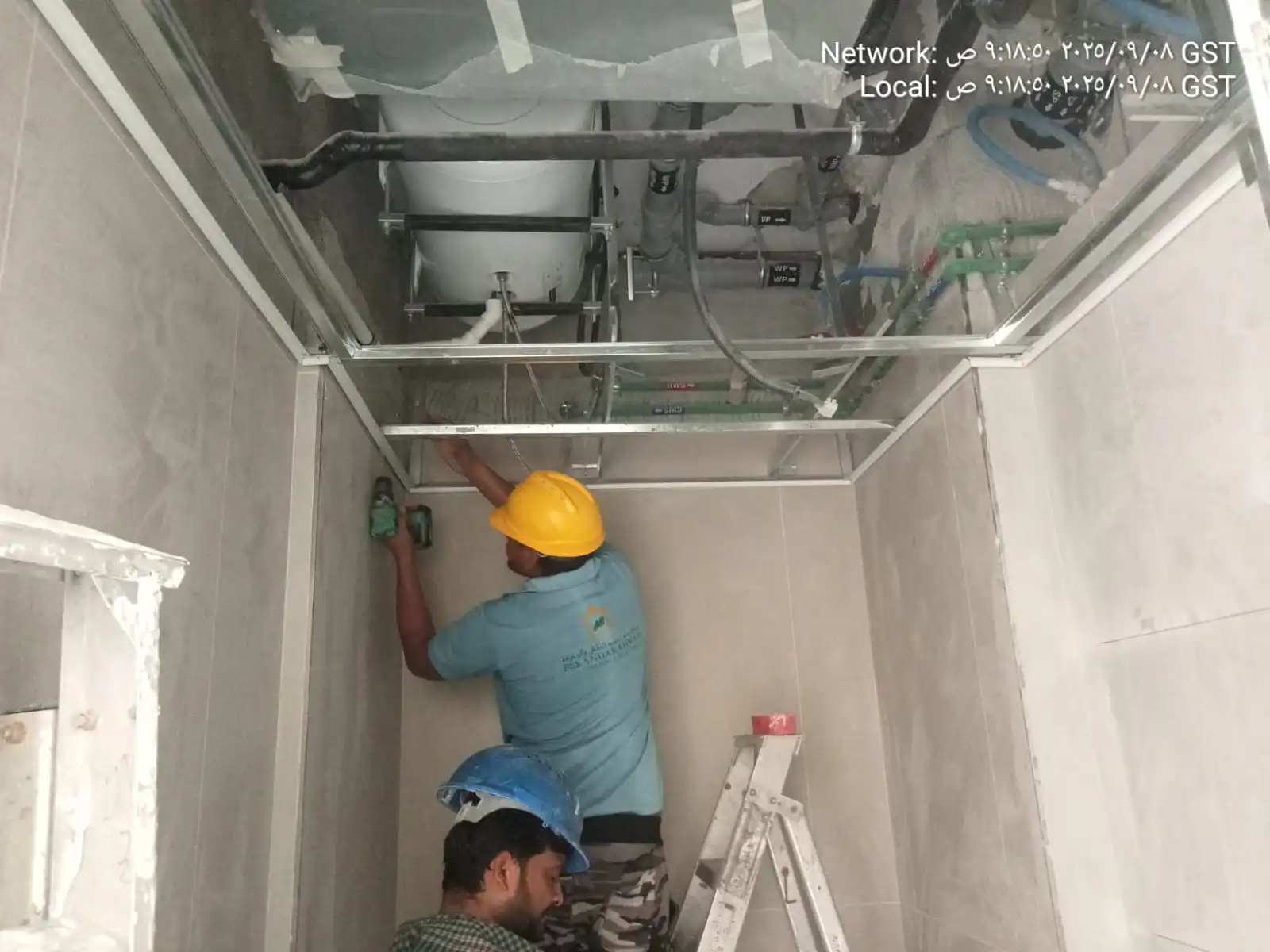

- MEP H/L, 90% completed
2nd floor
- Wall tile works, 70% completed
- Floor tile works, 80% completed
- Aluminum framing works, 20% completed
- Timber doors, 90% delivered | Subframes, 100% completed
- False ceiling framing works, 75% completed
- Paint preparation works, 90% completed
- MEP H/L, 90% completed
3rd floor

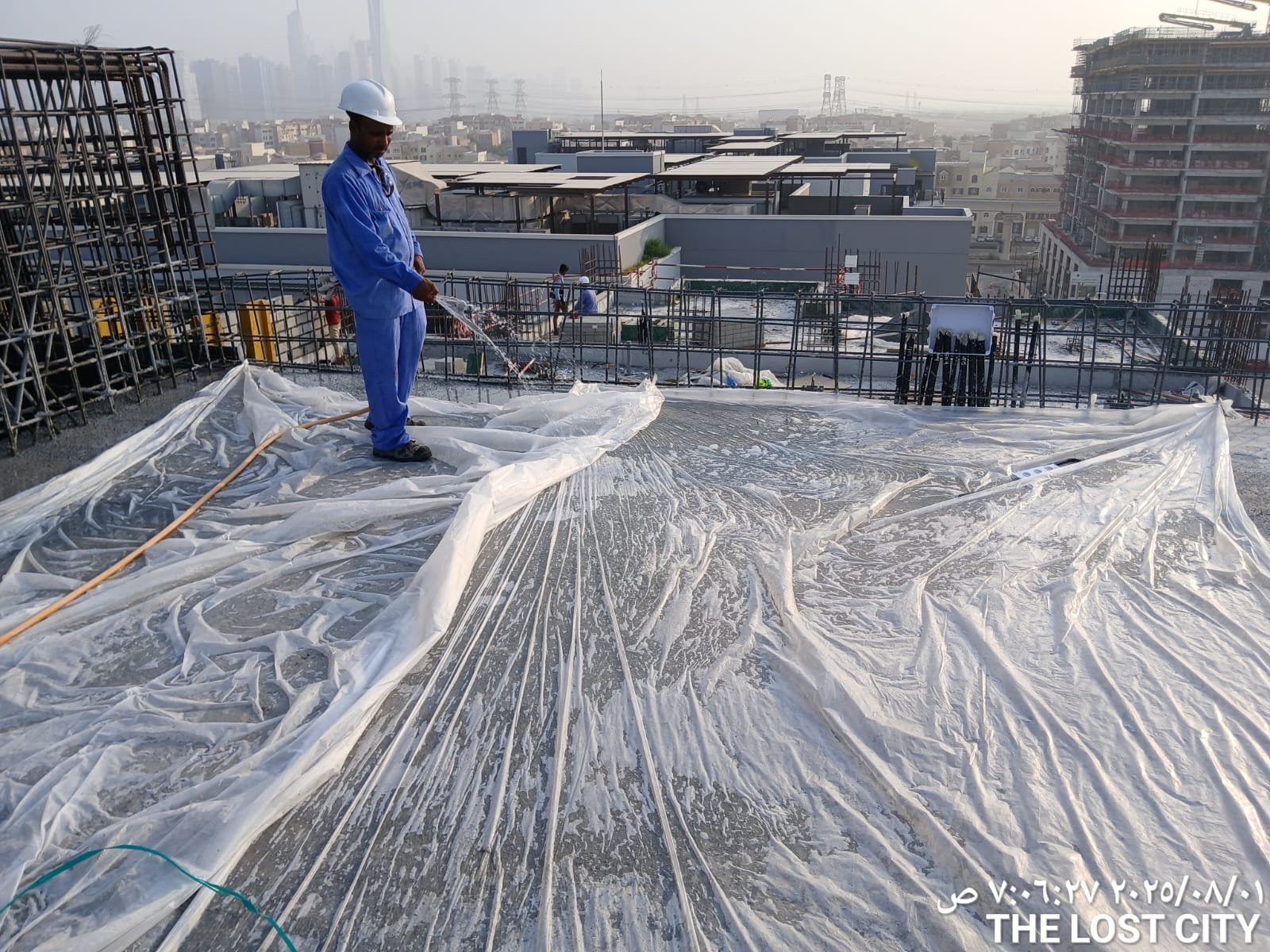

- Waterproofing wet area, 90% completed
- Floor tile works, 70% completed
- Subframes joinery work, 100% completed
- Paint preparation works, 50% completed
- MEP H/L, 50% completed
4th floor
- Wall plaster works, 30% completed
- Ceiling antifungus wet area paint, 90% completed
- MEP H/L, 25% completed
- MEP 1st fix works, 85% completed
5th floor
- Deshuttering of 6th floor slab, 100% completed
- Block works, 75% completed
- Ceiling antifungus wet area paint, 90% completed
- MEP H/L, 15% completed
- MEP 1st fix works, 10% completed
6th floor
- Deshuttering of roof floor slab, 100% completed
- Block works, 30% completed
Roof floor
- Deshuttering of top roof floor slab, 100% completed

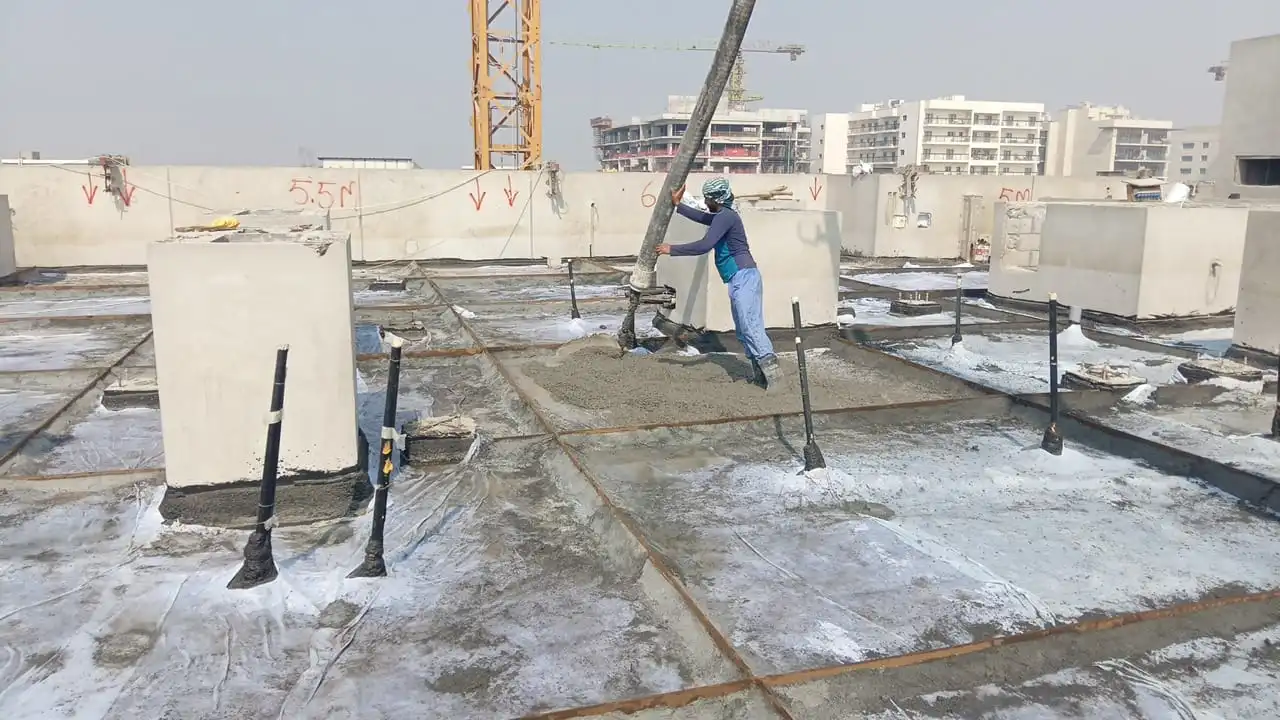

- MEP foundation casted, 100% completed
- Aluminum pergola foundation casted, 100% completed
- Parapet block works, 100% completed
- Parapet plaster works, 60% completed
- Preparation for combo system works, 60% completed
- Floor piping for roof floor
- MEP 1st fix works, 70% completed
Top roof floor
- Top roof floor slab casted, 100% completed
- Lift slab casted, 100% completed
- Top roof parapet casted, 100% completed
- Preparation for combo system works, 10% completed
External elevation finishing works
- Elevation 1 plaster works, 20% completed
- Balcony aluminum U-channel installation, 25% completed
Internal finishing works

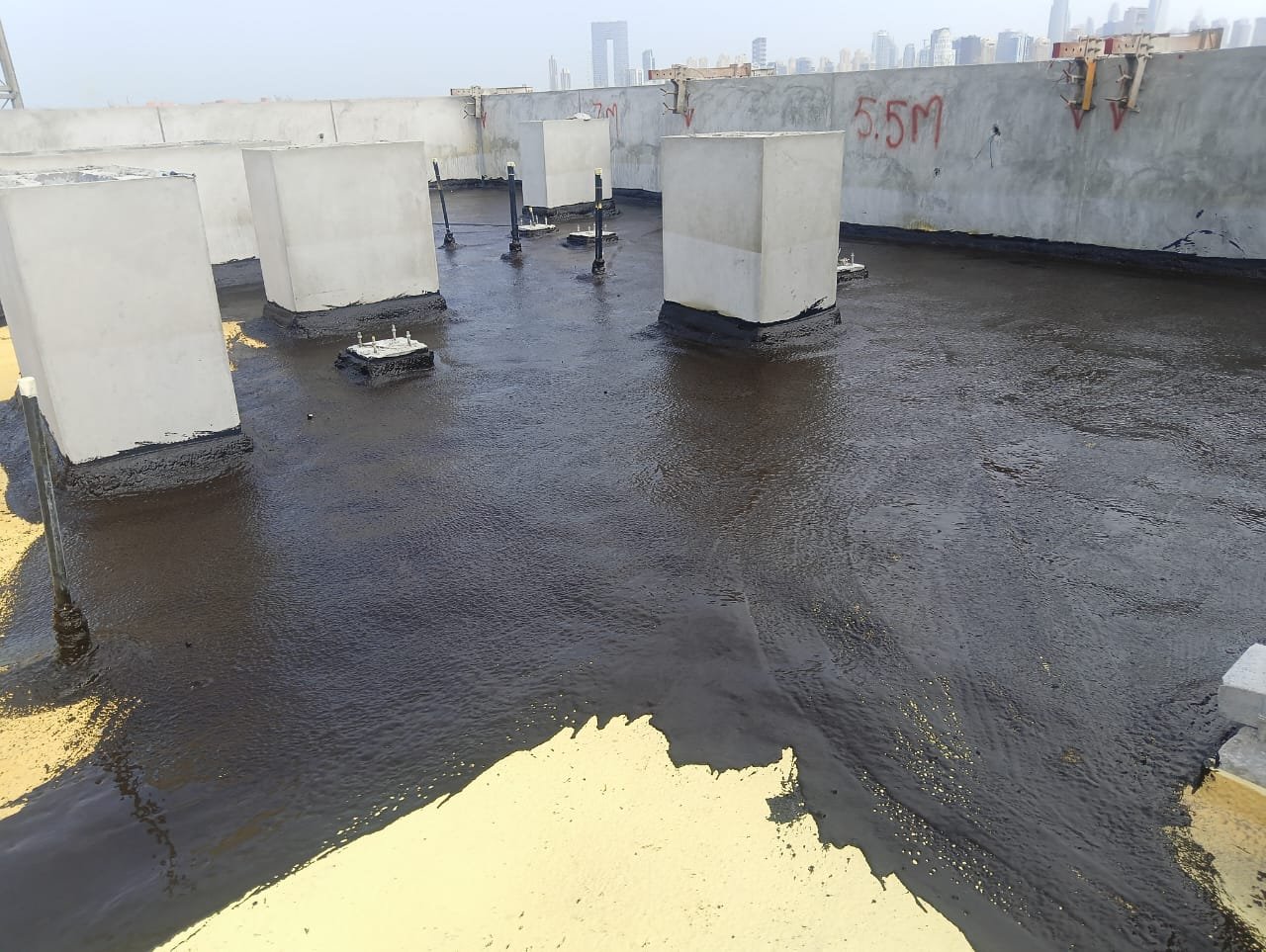

- Lift pit waterproofing, 100% completed
- All elevator materials, 100% delivered
Launched
15th July 2024
Planned handover
30th March 2026

Progress
40.70%
Stage
Ground Floor
- SOG preparation (PART 2), 90% completed.
- Ceiling paint preparation, 20% completed.

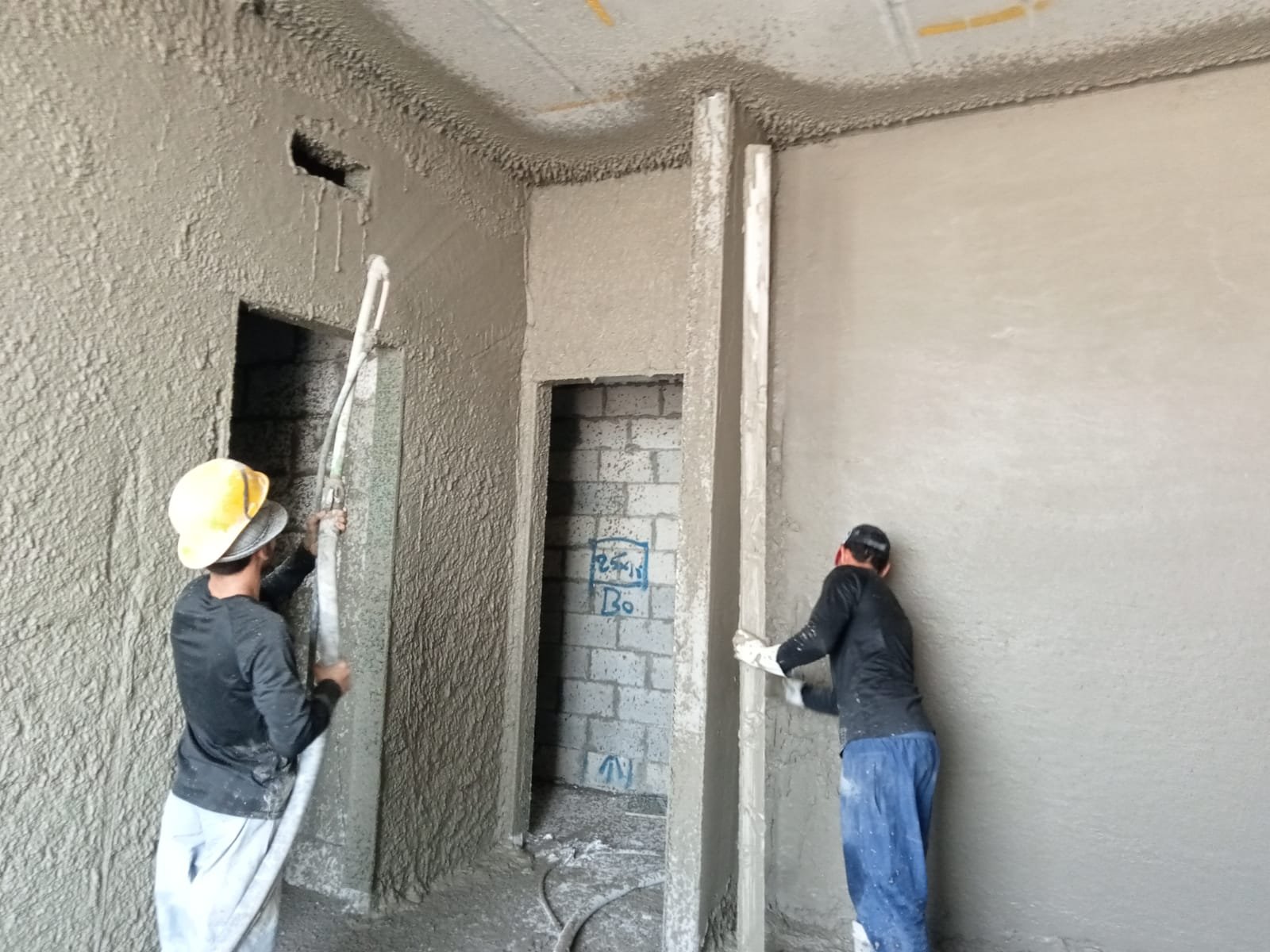

- Plaster work, 90% completed.
1st Floor
- MEP 3rd Fix, 5% completed.
- Ceiling and wall Paint preparation, 90% completed.
- Ceiling Suspension works, 90% completed.
- Walls and floors tiles installation, 90% completed.
- Water proofing works, 100% completed.
2nd Floor
- Blockwork, 100% completed.
- Plaster works, 100% completed.
- MEP 2nd Fix, 100% completed.
- Ceiling and wall Paint preparation, 90% completed.
- Water proofing works, 80% completed.
- Walls and floors tiles installation, 40% completed.
3rd Floor
- Block works, 100% completed.
- Plaster works, 100% completed.
- MEP 2nd Fix, 75% completed.
- Ceiling and wall Paint preparation, 15% completed.
4th Floor
- Block works, 80% completed.
- MEP 1st Fix, 20% completed.
5th Floor
- Block works, 15% completed.
6th Floor
- De-shuttering works, 10% completed.
Roof Floor

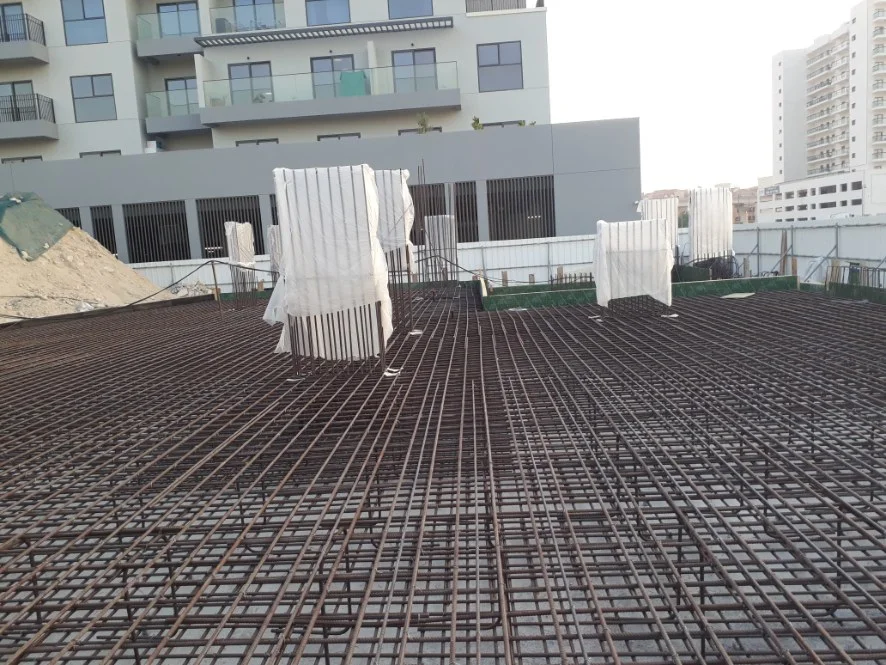

- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority Inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
- Block works, 50% completed.
Top Roof Floor
- Reinforcement work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority Inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
Facade
- External plaster preparation works, 10% completed.
Launched
15th July 2024
Planned Handover
30th March 2026

Progress
40.70%
Stage
Ground floor
- SOG preparation (part 2), 90% completed.
- Ceiling paint preparation, 20% completed.
- Plaster works, 90% completed.
1st floor
- MEP 3rd fix, 5% completed.
- Ceiling and wall paint preparation, 90% completed.
- Ceiling suspension works, 90% completed.
- Wall and floor tile installation, 90% completed.
- Waterproofing works, 100% completed.
2nd floor
- Block works, 100% completed.
- Plaster works, 100% completed.
- MEP 2nd fix, 100% completed.
- Ceiling and wall paint preparation, 90% completed.
- Waterproofing works, 80% completed.
- Wall and floor tile installation, 40% completed.
3rd floor
- Block works, 100% completed.
- Plaster works, 100% completed.
- MEP 2nd fix, 75% completed.
- Ceiling and wall paint preparation, 15% completed.
4th floor
- Block works, 80% completed.
- MEP 1st fix, 20% completed.
5th floor
- Block works, 15% completed.
6th floor
- De-shuttering works, 10% completed.
Roof floor
- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
- Block works, 50% completed.
Top roof floor
- Reinforcement work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
Facade
- External plaster preparation works, 10% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
32.40%
Stage
Ground floor
- Substation & LV room block works, 100% completed.
- Substation aluminium door, 100% completed.

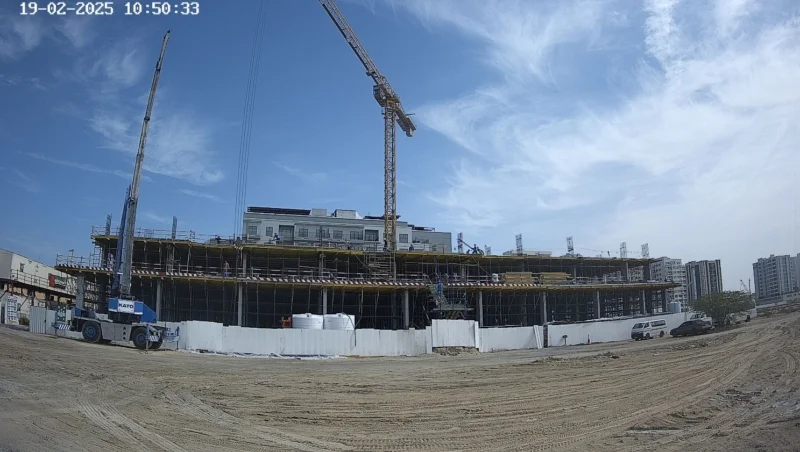

- SOG preparation (part 1), 75% completed.
- External block work, 40% completed.
- De-shuttering (part 2), 50% completed.
1st floor
- Block work, 100% completed.
- Plaster work, 50% completed.
- MEP 2nd fix, 90% completed.
- Ceiling paint & preparation, 30% completed.
- Tiling works, 5% completed.
2nd floor
- Block works, 90% completed.
- Plaster works, 10% completed.
- MEP 2nd fix, 15% completed.
3rd floor
- De-shuttering, 90% completed.
- Block works, 30% completed.

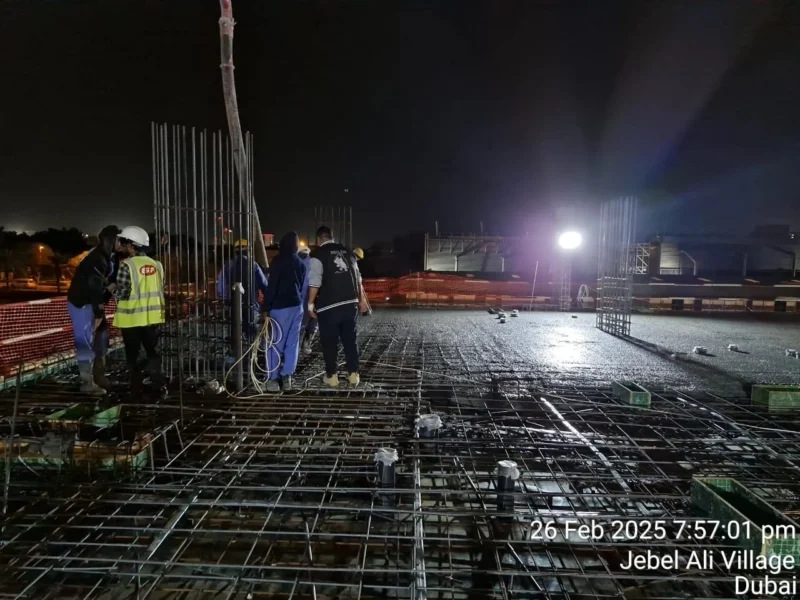

5th floor
- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- MEP work for slab, 100% completed.

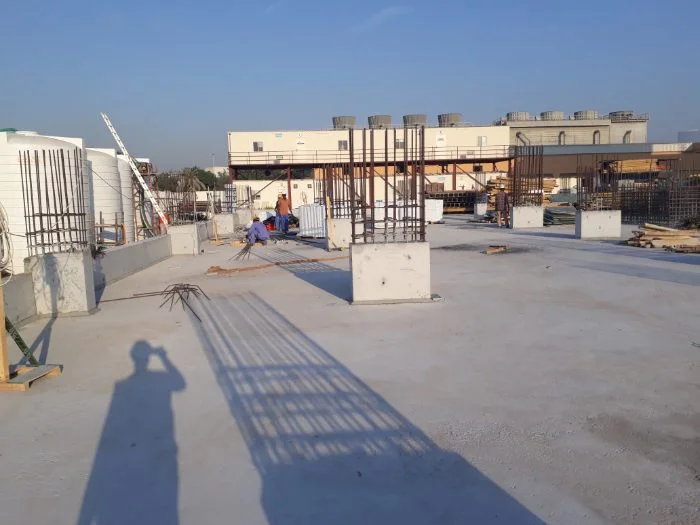

- Slab concrete casting, 100% completed.
- Authority inspection for casting, 100% completed.
- Stressing & patching for slab, 100% completed.
- Column and wall casting, 100% completed.
6th floor
- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
30.25%
Stage
Ground floor
- Substation, LV room block works, 100% completed.
- De-shuttering (part 1), 100% completed.
- SOG preparation (part 1), 75% completed.
- External block work, 40% completed.
1st floor
- Block work, 95% completed.
- Plaster work, 15% completed.
- MEP 2nd fix, 40% completed.
2nd floor
- Block work, 15% completed.
- De-shuttering work, 100% completed.
3rd floor
- Column and wall casting for 3rd floor slab, 100% completed.
- Column and wall de-shuttering & curing.
4th floor
- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
- Stressing & patching for slab, 100% completed.
- Column and wall casting, 100% completed.
- Column and wall de-shuttering & curing.
5th floor

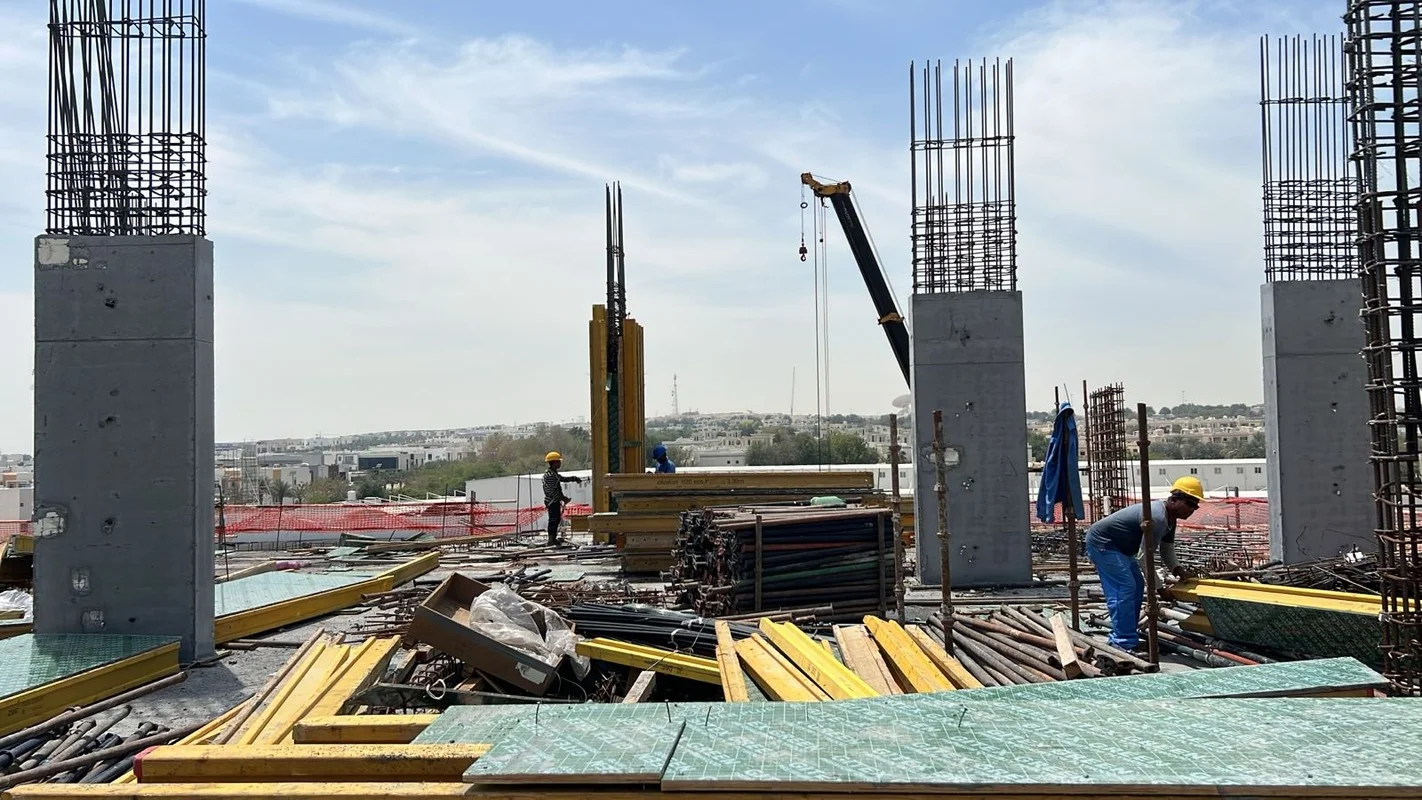

- Reinforcement work for slab, 30% completed.
- PT work for slab, 15% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
20.85%
Stage

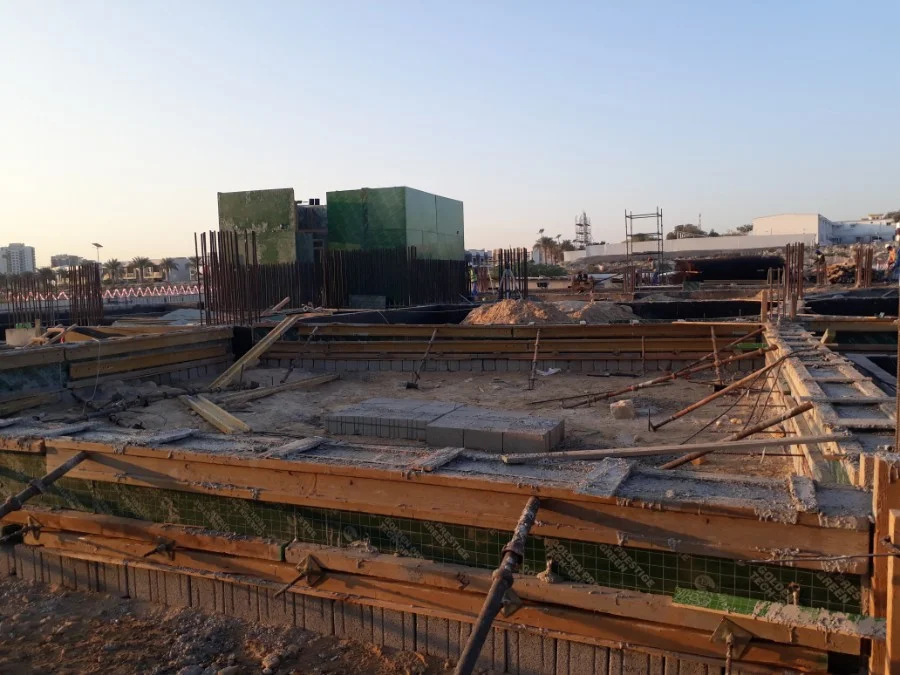

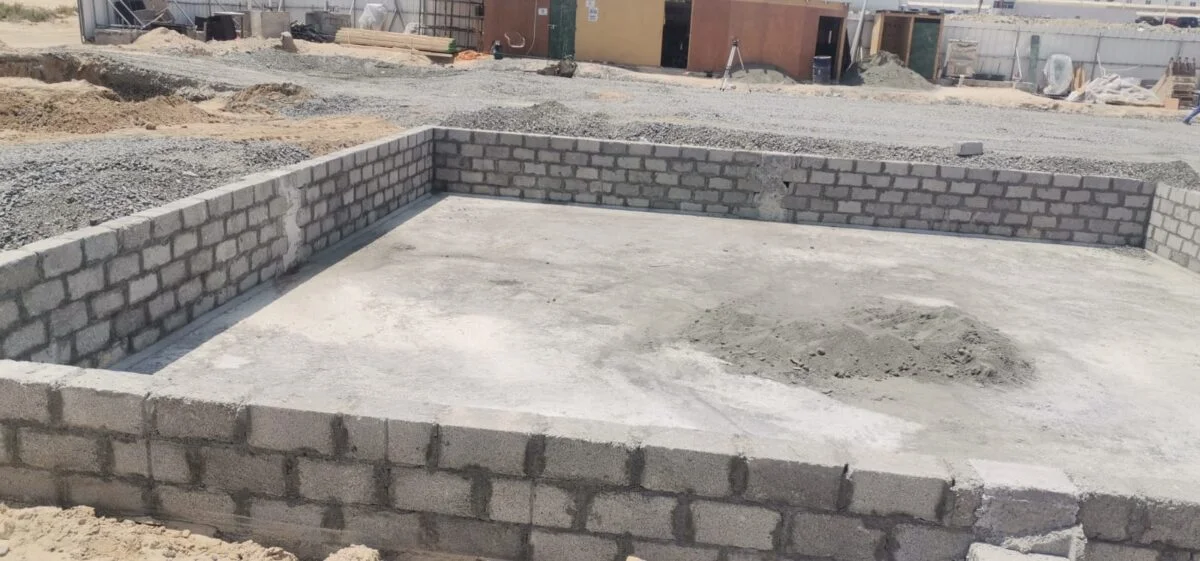

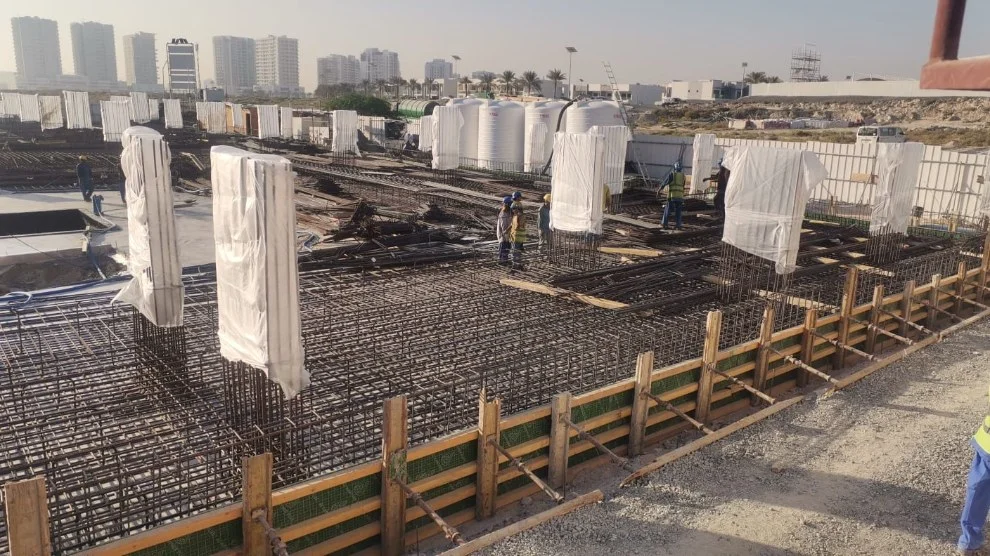

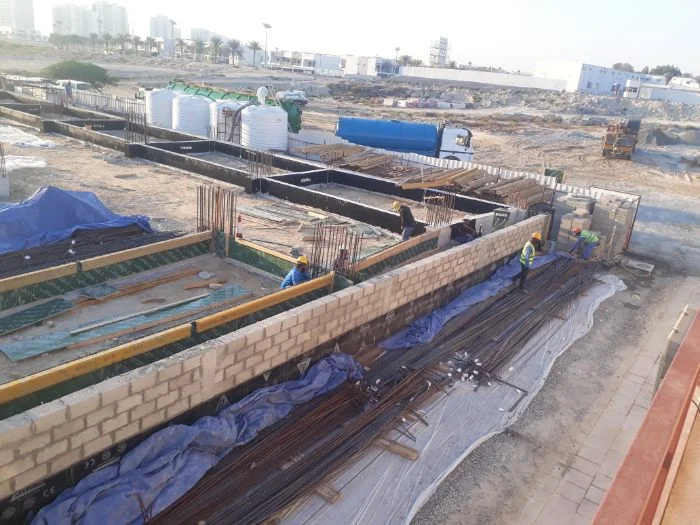

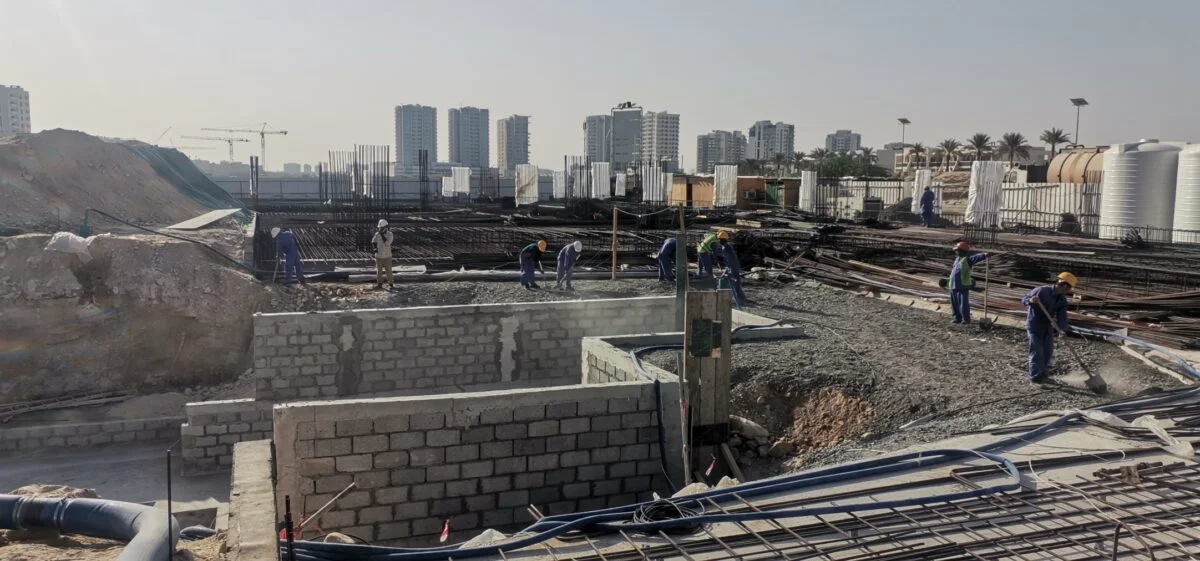

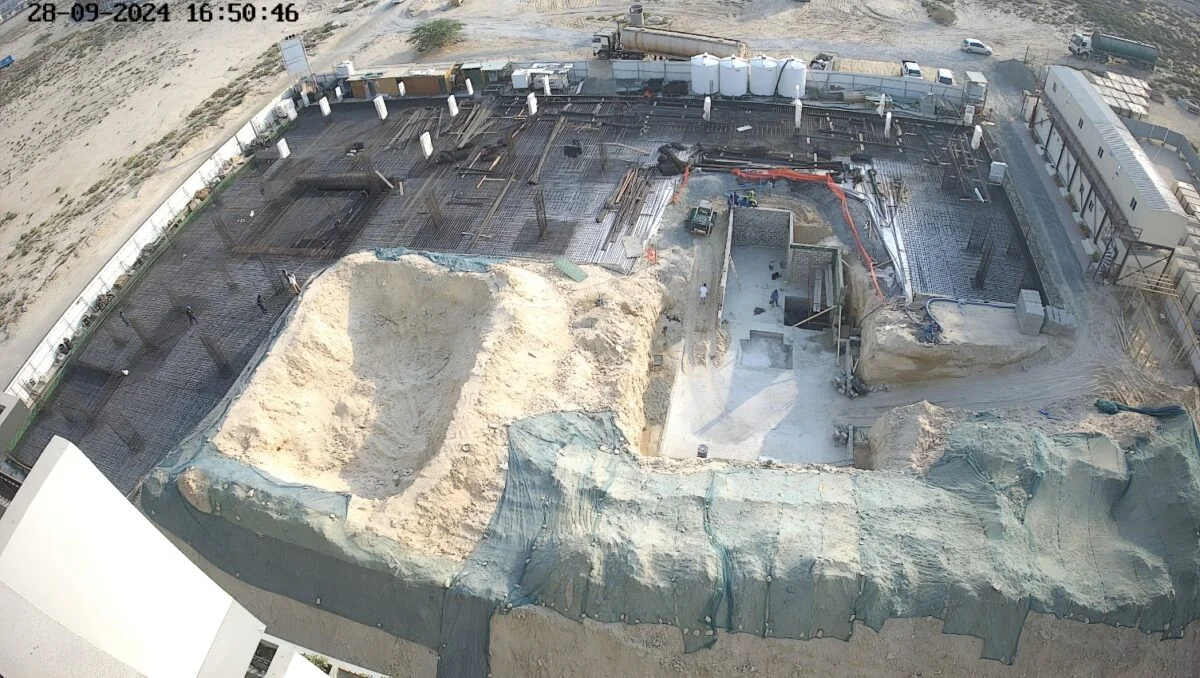

Main raft & foundation:
- Raft & isolated footing casting, 100% completed.
- Casting of tie beams, 100% completed.

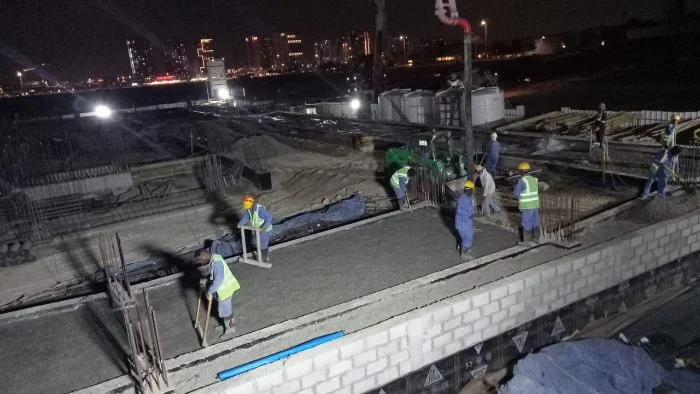

- Road base & screed under grade slab (SOG), 100% completed.
- MEP services under SOG, 70% completed.

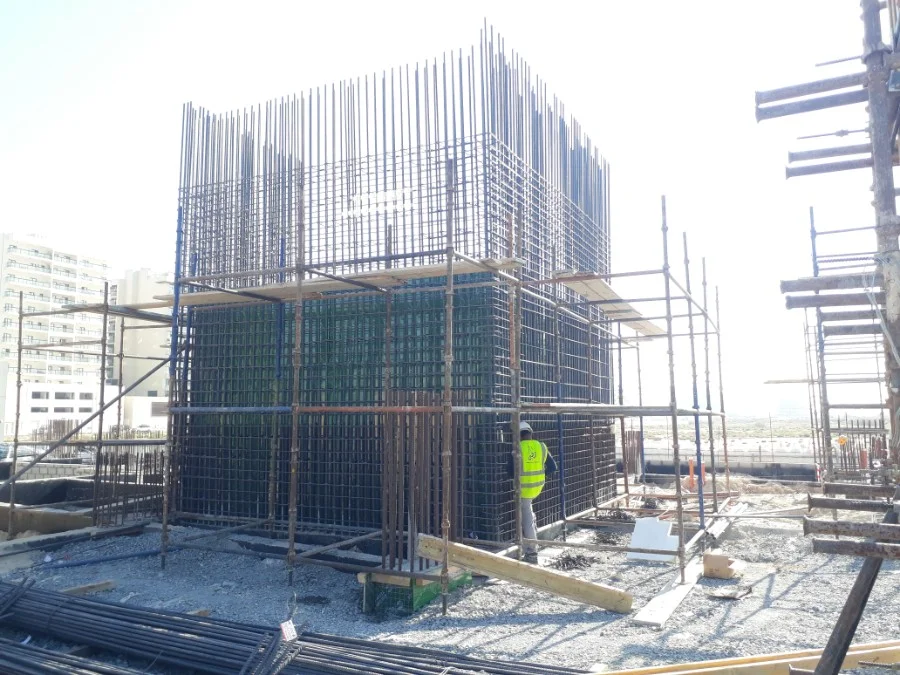

- Ground floor columns and core walls, 100% completed.
- 1st floor slab shuttering, 95% completed.
- 1st floor slab steel and PT works, 95% completed.
- 1st floor slab MEP works, 85% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
40.70%
Stage
Ground floor

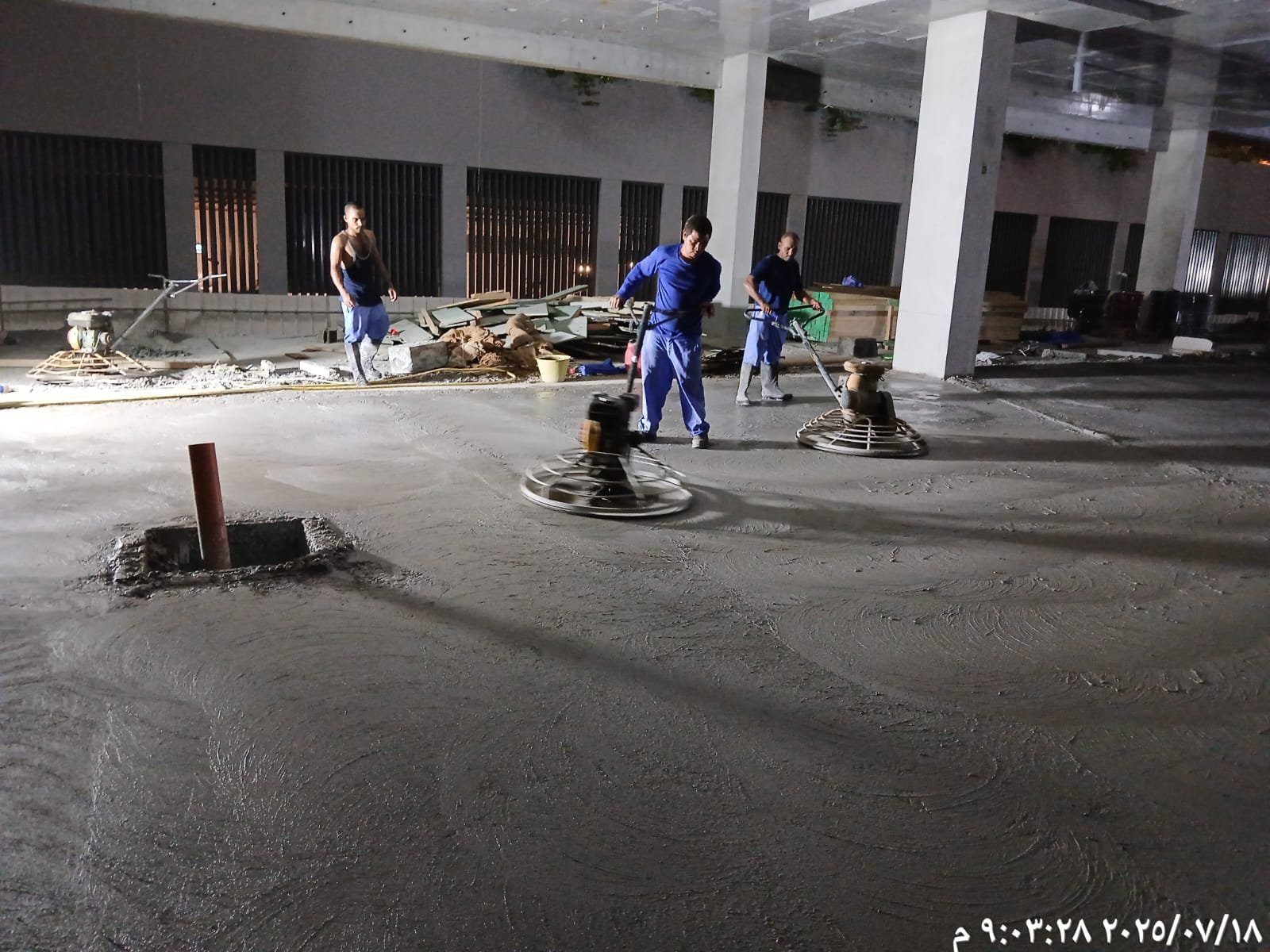

- SOG preparation (part 2), 90% completed.
- Ceiling paint preparation, 20% completed.
- Plaster work, 90% completed.
1st floor
- MEP 3rd fix, 5% completed.
- Ceiling and wall paint preparation, 90% completed.
- Ceiling suspension works, 90% completed.
- Walls and floors tiles installation, 90% completed.
- Waterproofing works, 100% completed.
2nd floor
- Blockwork, 100% completed.
- Plaster works, 100% completed.
- MEP 2nd fix, 100% completed.
- Ceiling and wall paint preparation, 90% completed.
- Waterproofing works, 80% completed.
- Walls and floors tiles installation, 40% completed.
3rd floor
- Block works, 100% completed.
- Plaster works, 100% completed.
- MEP 2nd fix, 75% completed.
- Ceiling and wall paint preparation, 15% completed.
4th floor
- Block works, 80% completed.
- MEP 1st fix, 20% completed.
5th floor
- Block works, 15% completed.
6th floor
- De-shuttering works, 10% completed.
Roof floor
- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
- Block works, 50% completed.
Top roof floor
- Reinforcement work for slab, 100% completed.
- MEP work for slab, 100% completed.
- Authority inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
Facade
- External plaster preparation works, 10% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
26.10%
Stage
Ground floor
- Substation, LV room block works, 50% completed.
- De-shuttering (part 1), 80% completed.
- SOG preparation (part 1), 80% completed.
1st floor
- Blockwork layout, 35% completed.
- Block work, 10% completed.
- De-shuttering work, 100% completed.
2nd floor
- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- Authority inspection for casting, 100% completed.
- Slab concrete casting, 100% completed.
- MEP works for the slab, 100% completed.
- Stressing & patching for 2nd floor slab, 100% completed.
- Column and wall casting on 2nd floor slab, 100% completed.
- Column and wall de-shuttering & curing.
3rd floor
- Reinforcement work for slab, 100% completed.
- PT work for slab, 100% completed.
- Authority inspection for casting slab, 100% completed.
- Slab concrete casting, 97% completed.
- MEP works for the slab, 100% completed.
- Column and wall casting on 3rd floor slab, 20% completed.
- Column and wall de-shuttering & curing, 20% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
16.45%
Stage
Main raft & foundation

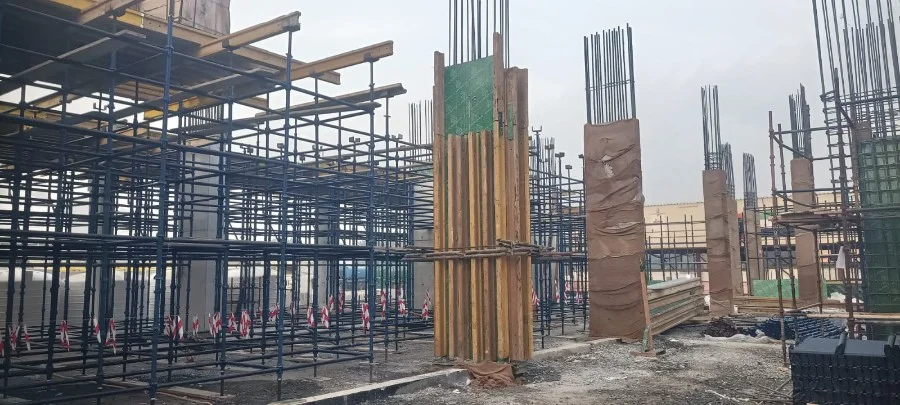

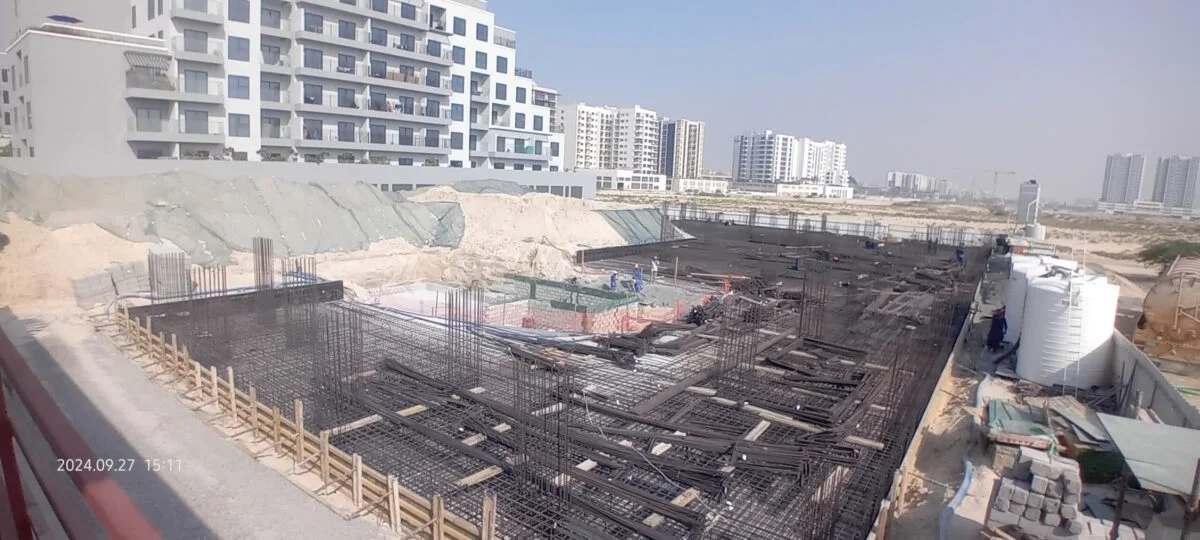

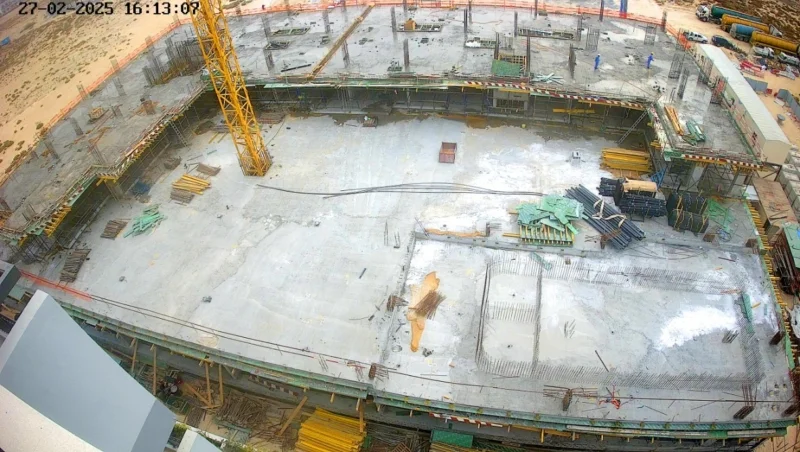

- Raft & isolated footing casting, 100% completed.
- Casting of tie beams, 95% completed.

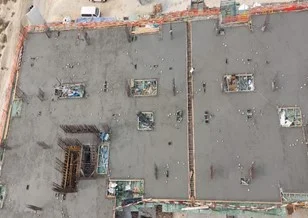

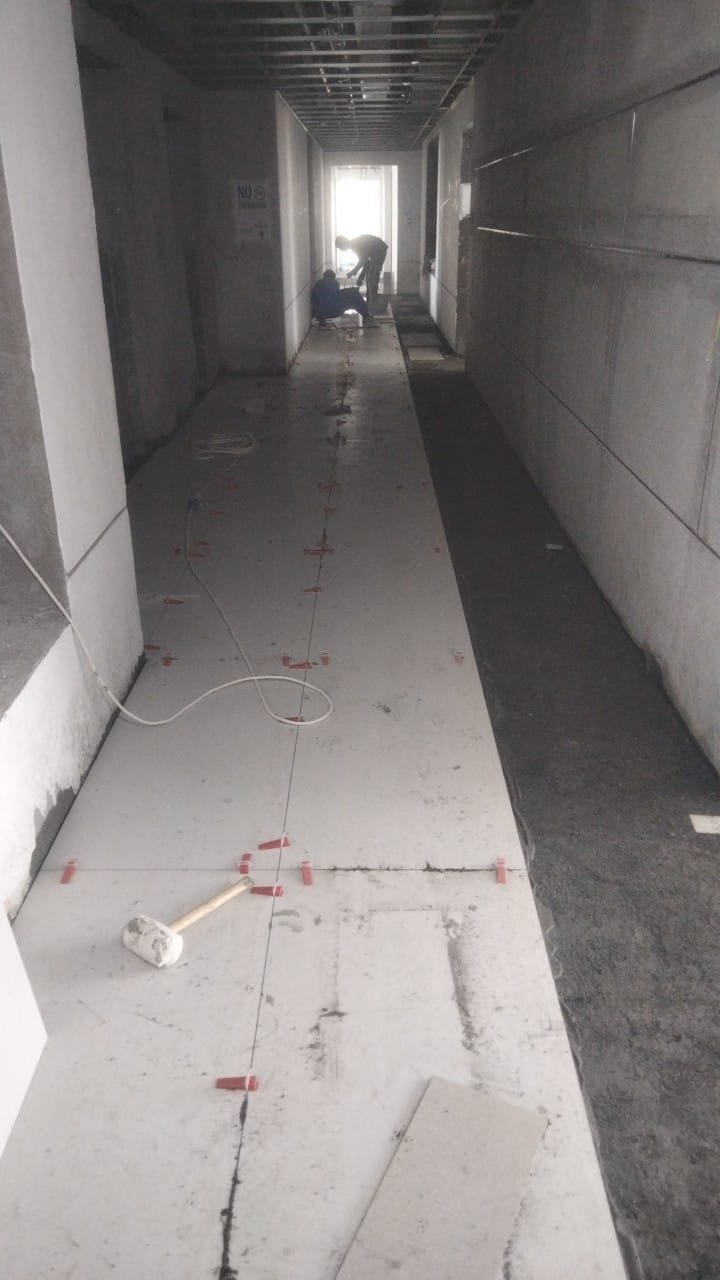

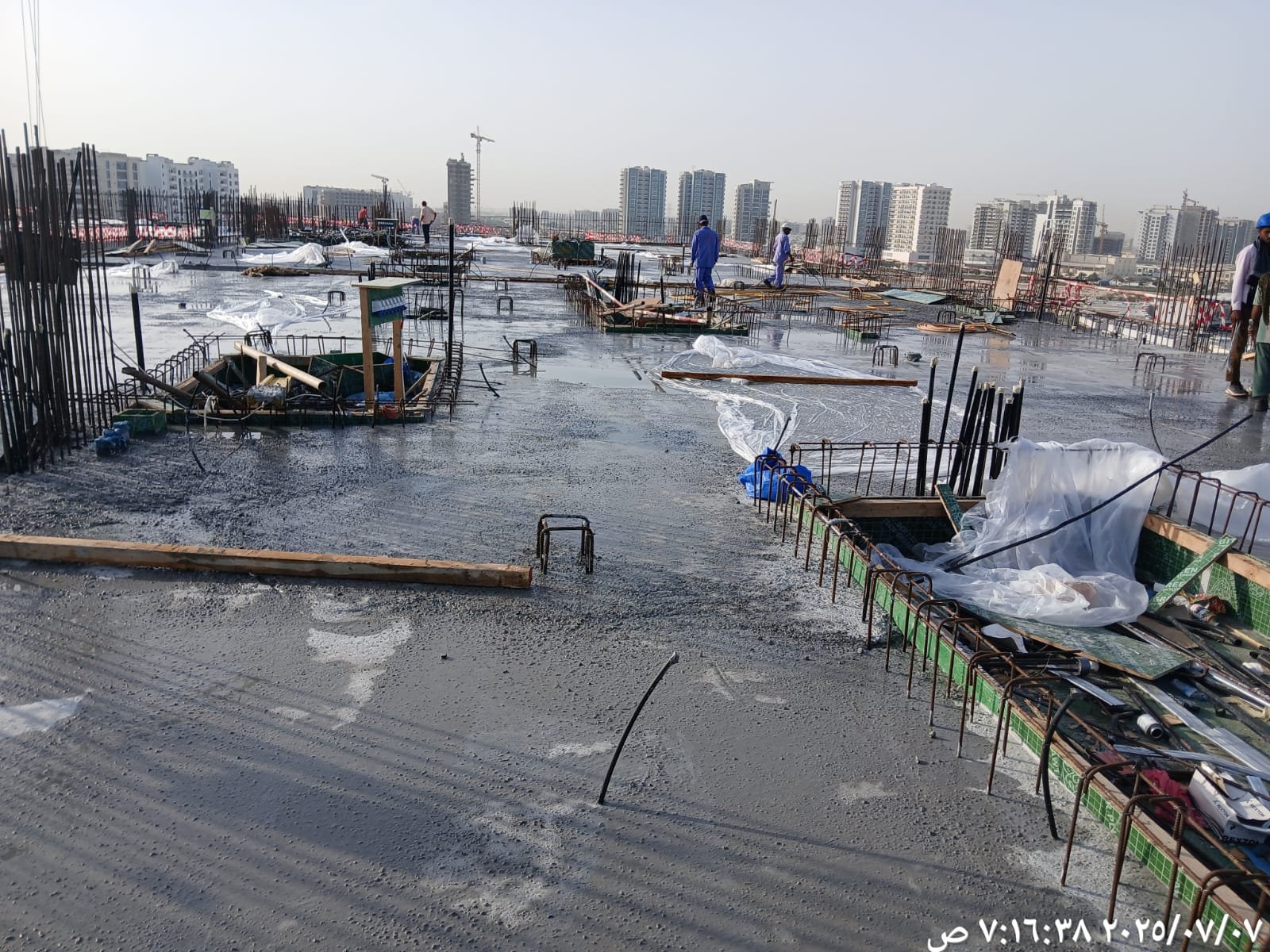

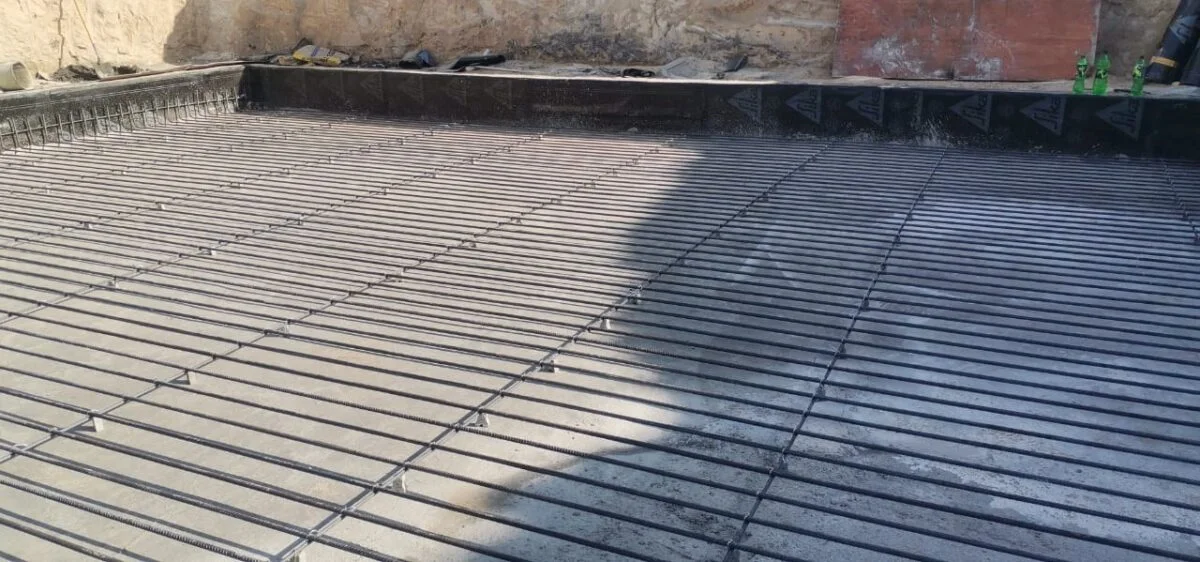

- Road base & screed under grade slab (SOG), 80% completed.

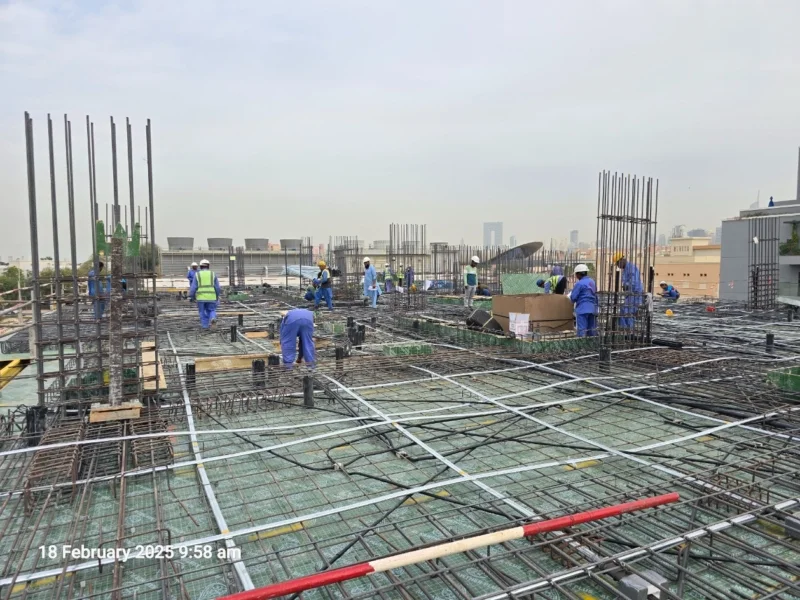

- MEP services under SOG, 60% completed.

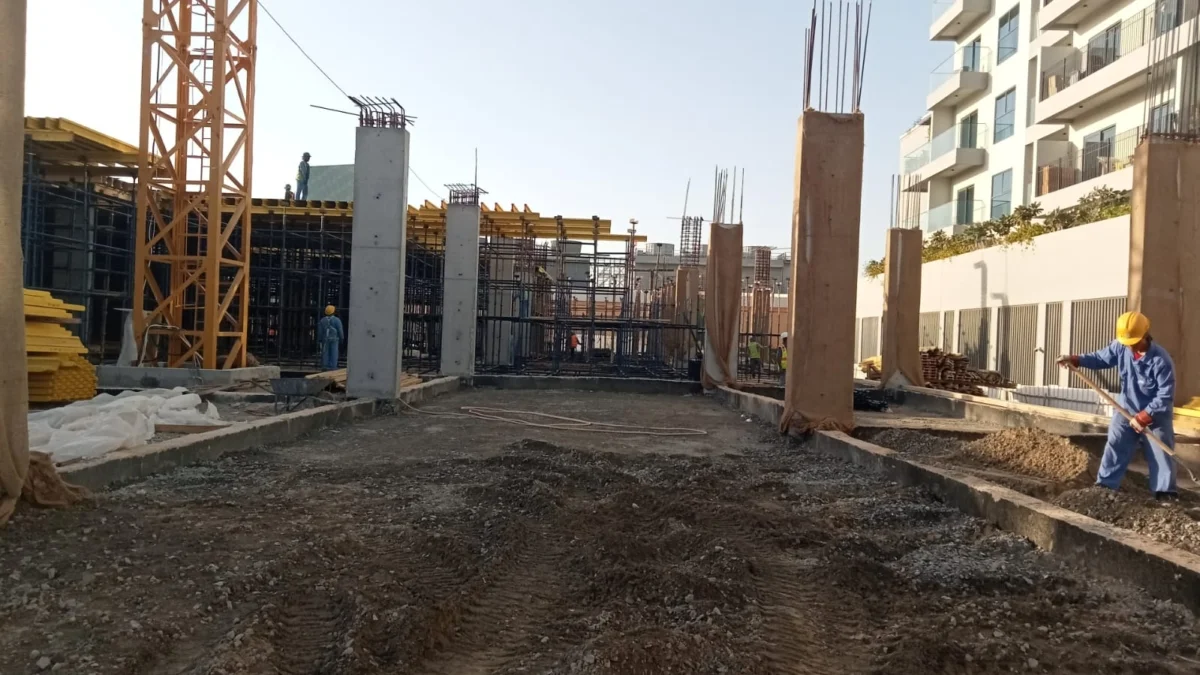

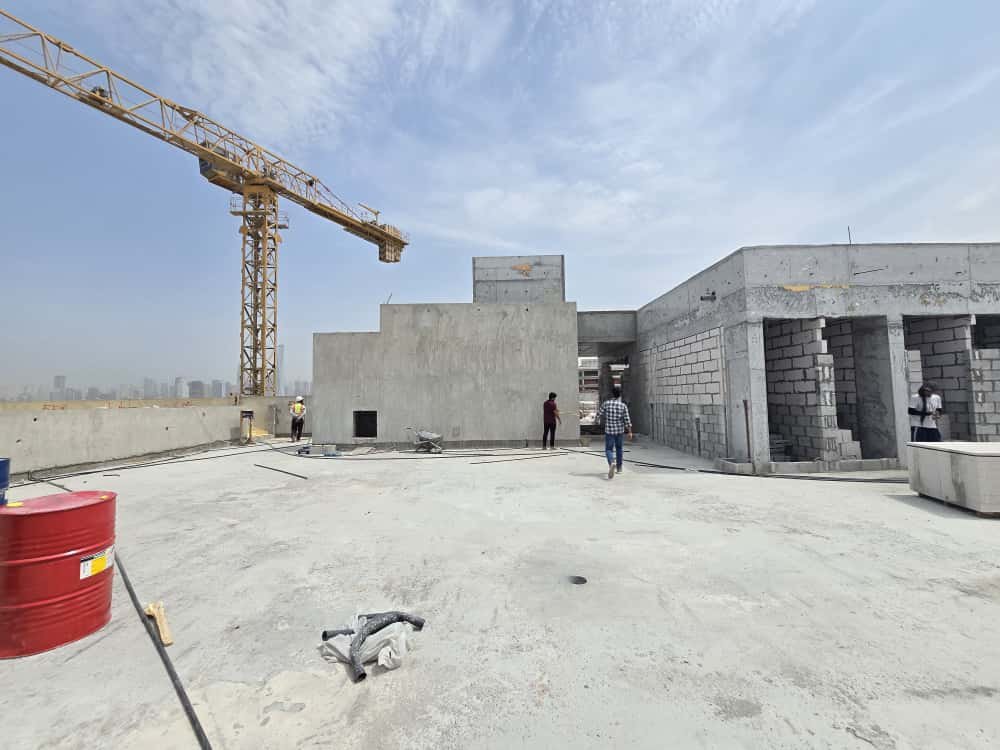

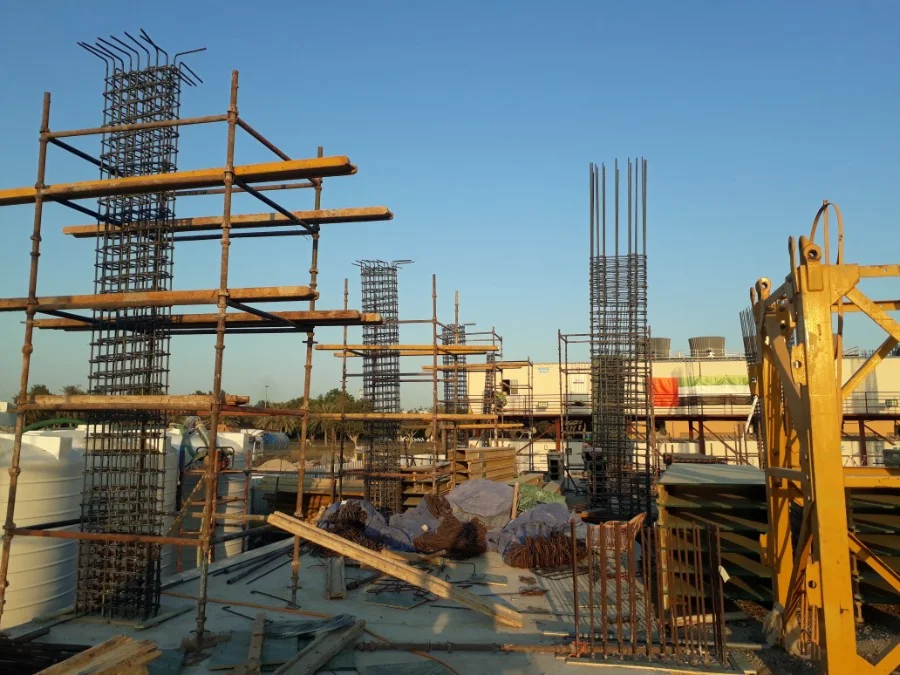

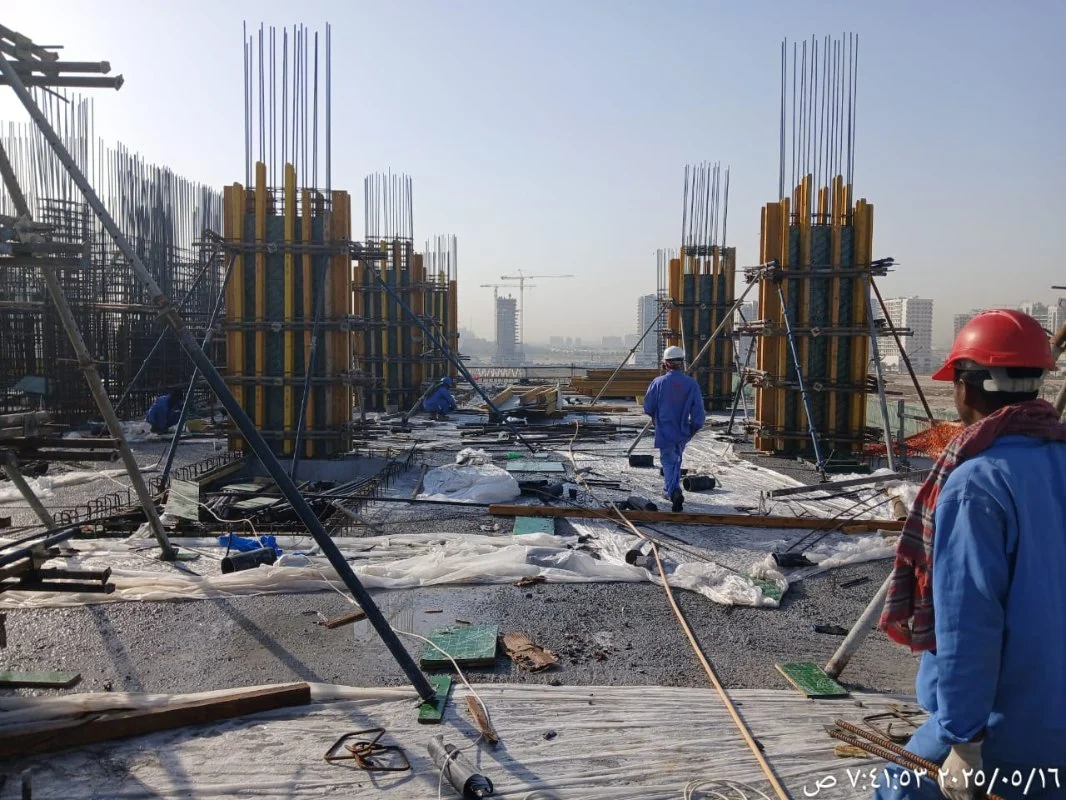

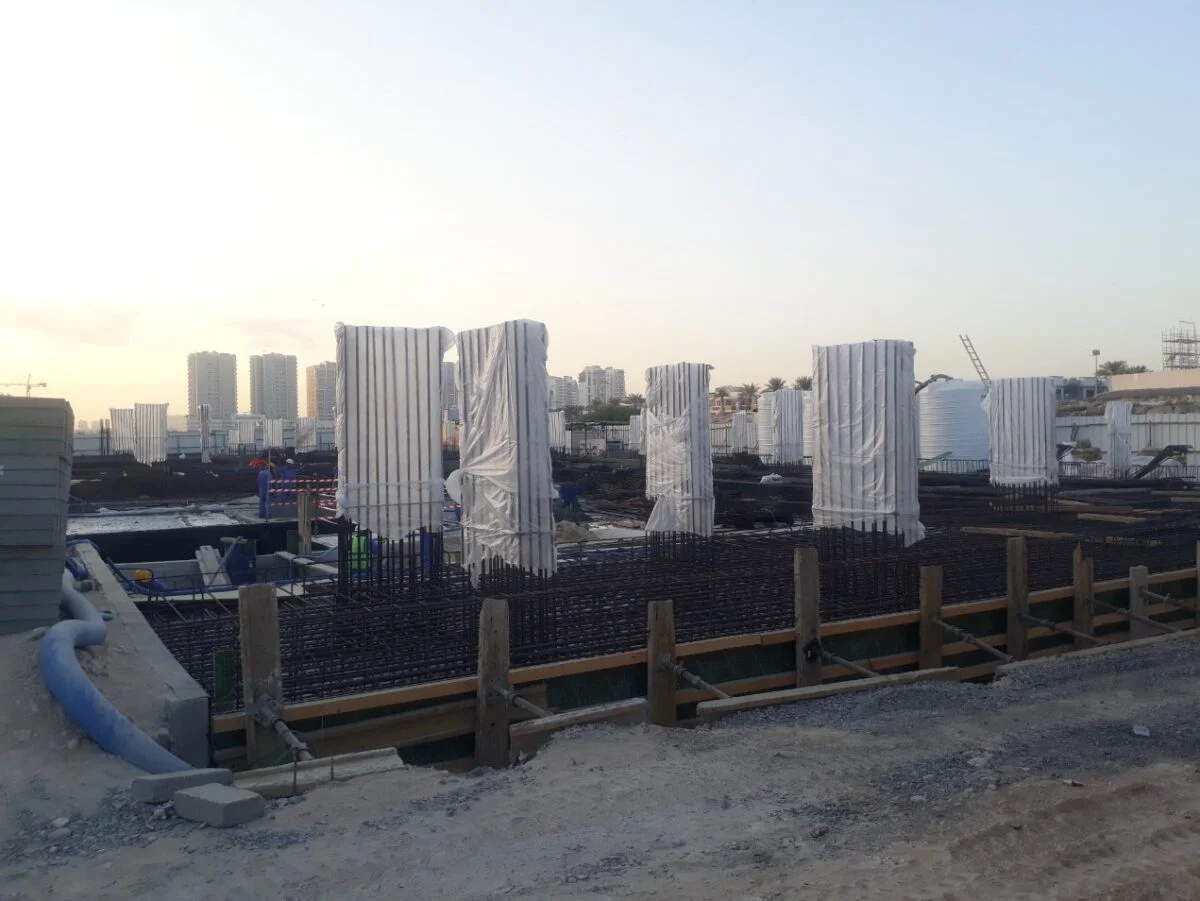

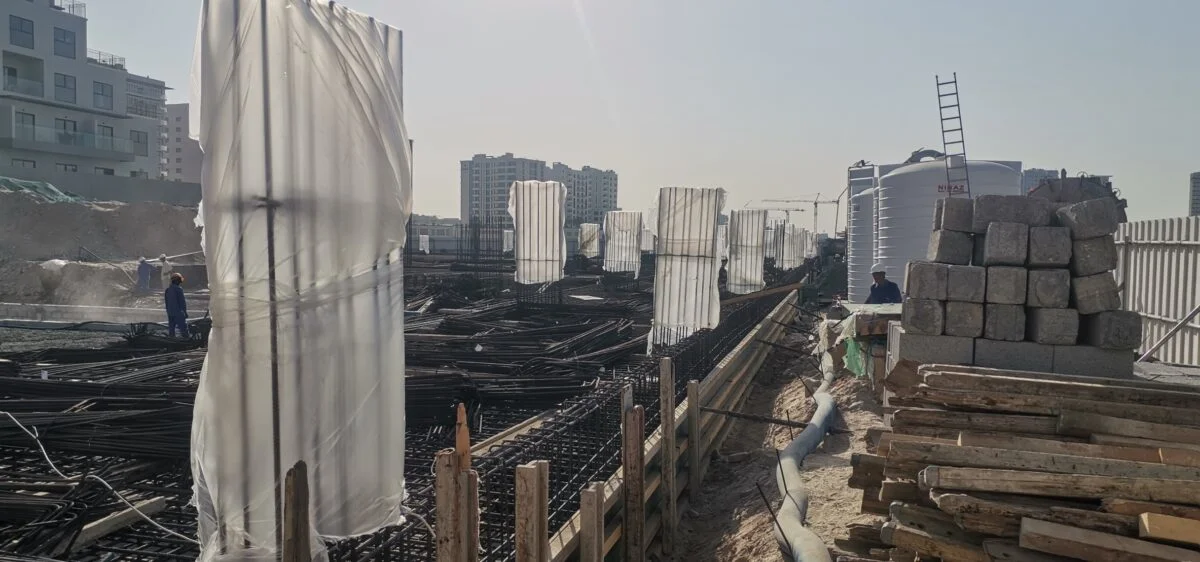

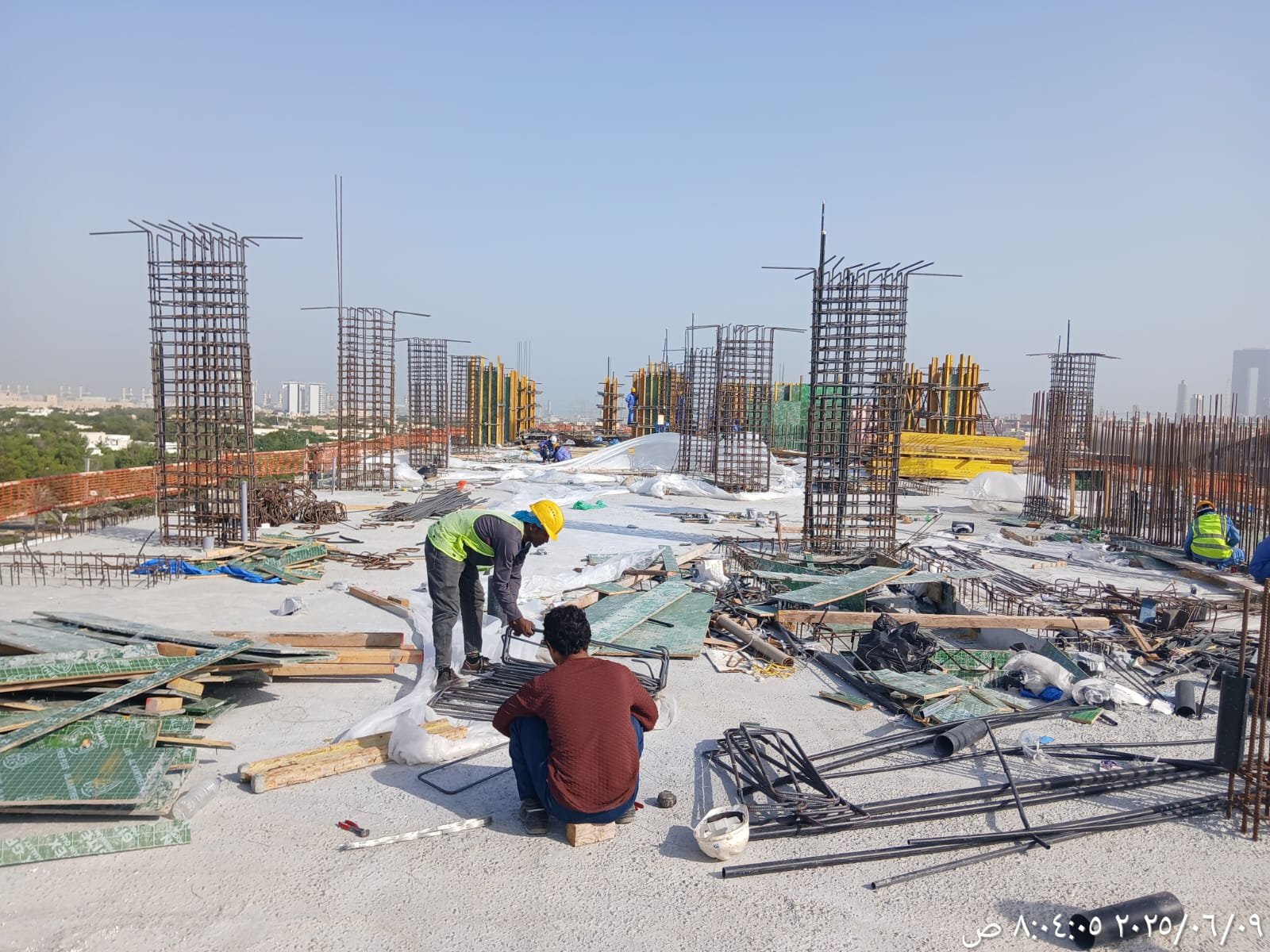

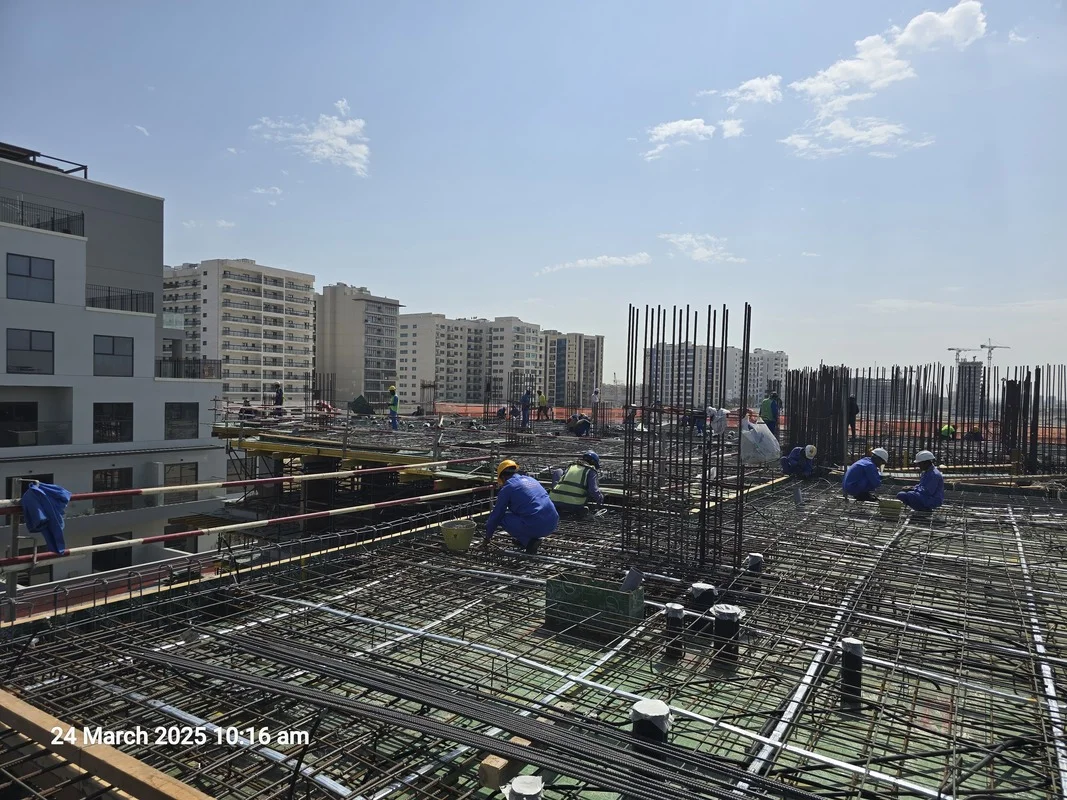

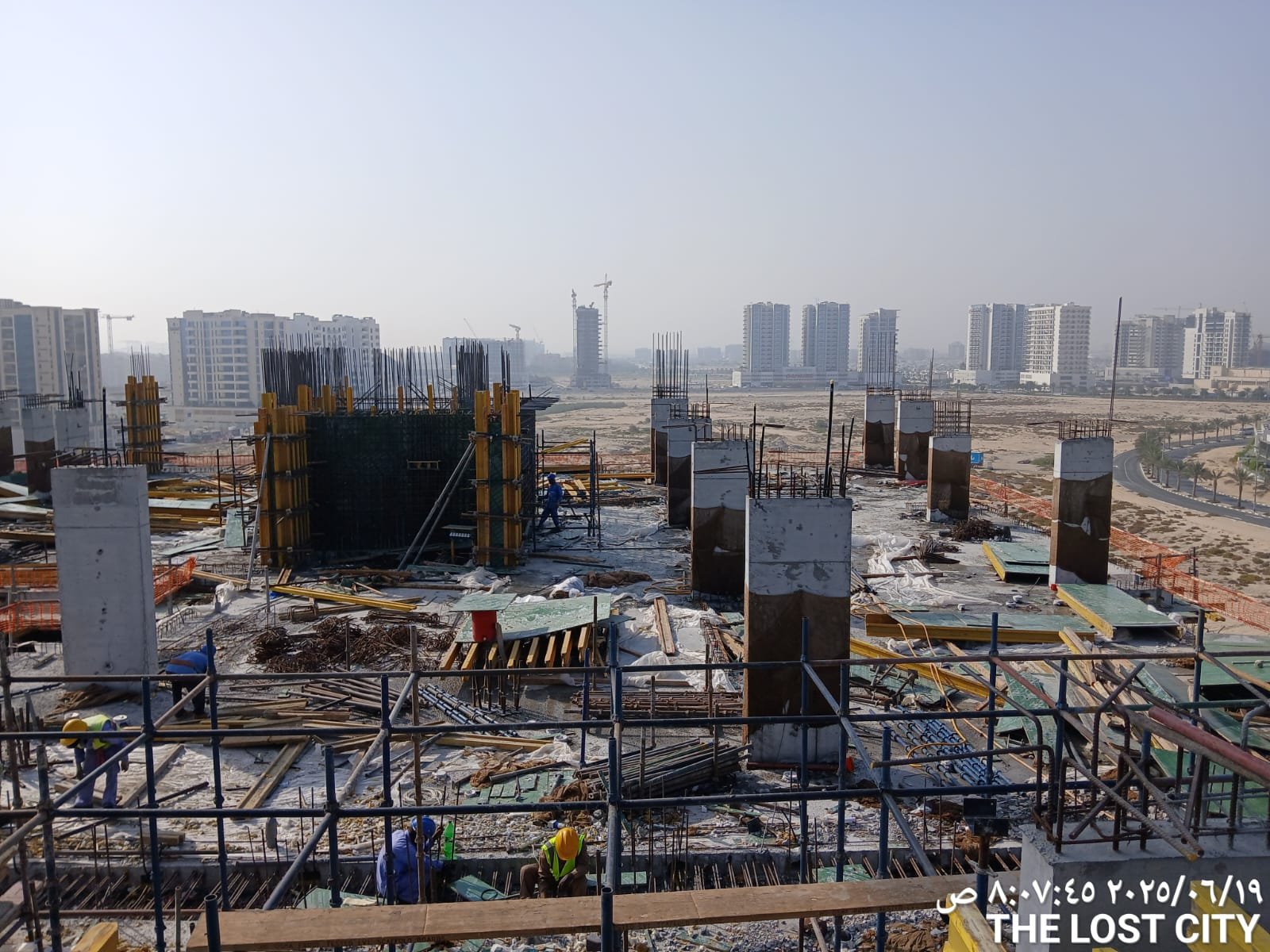

- Ground floor columns and core walls, 60% completed.

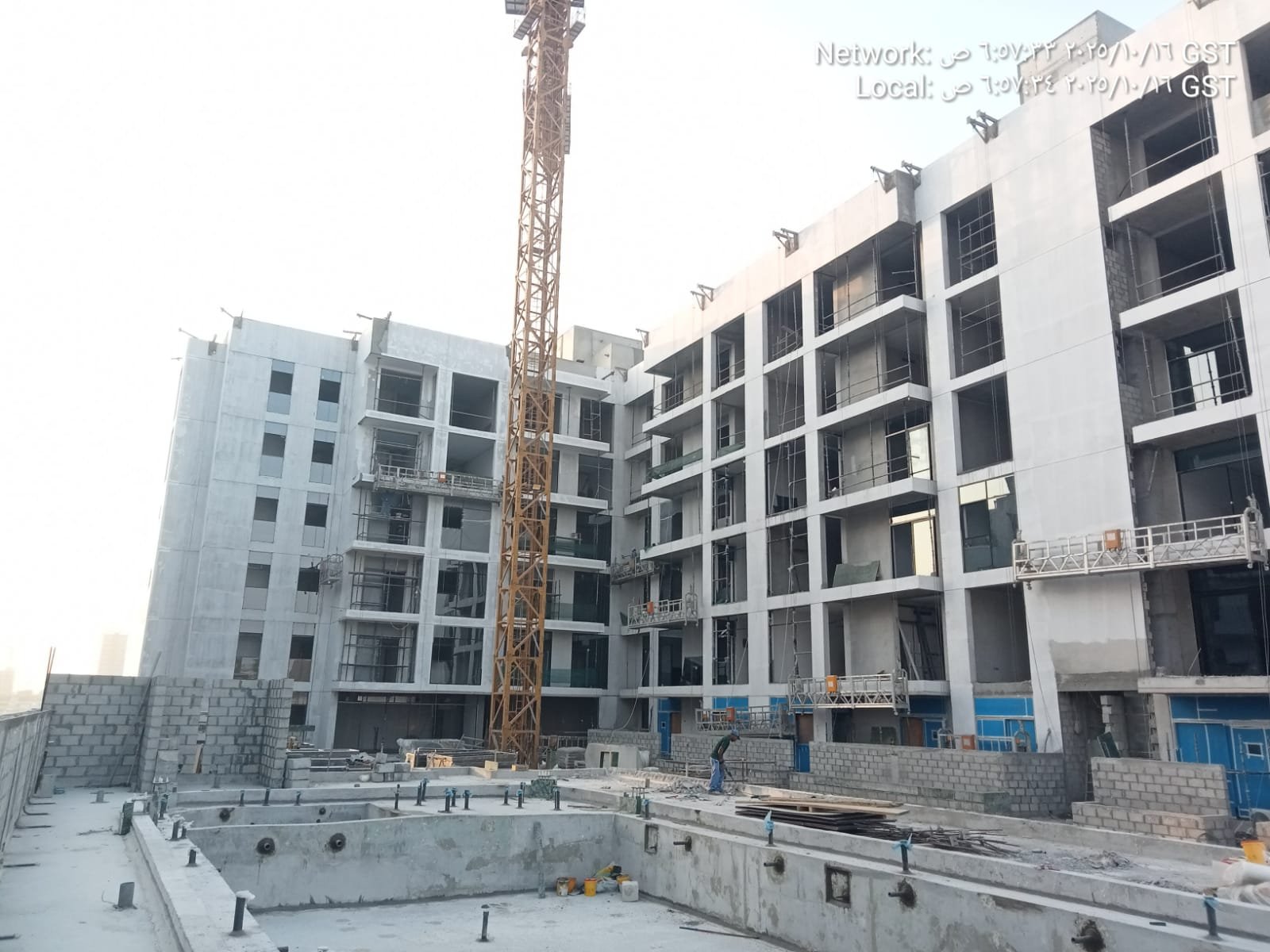

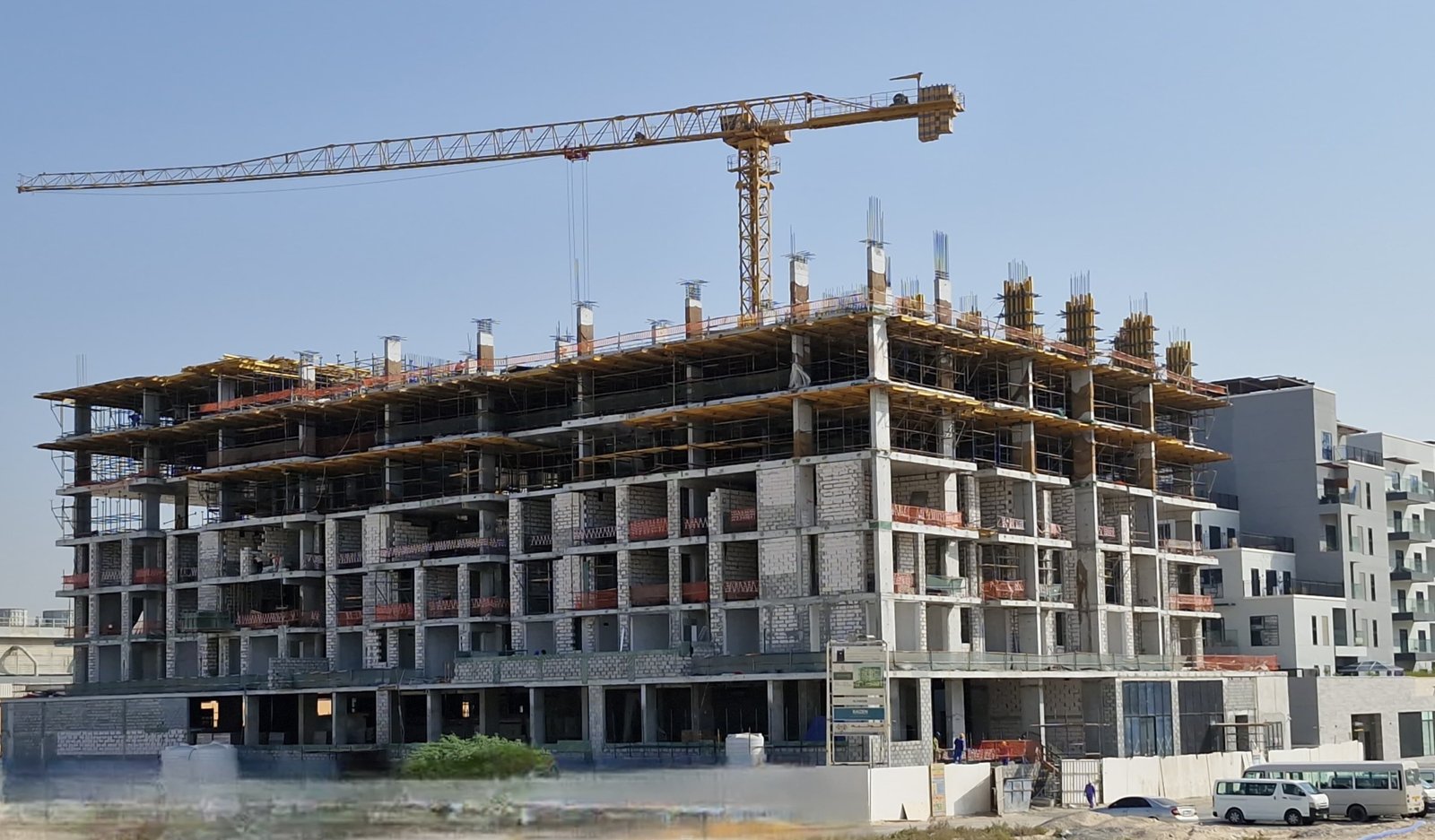

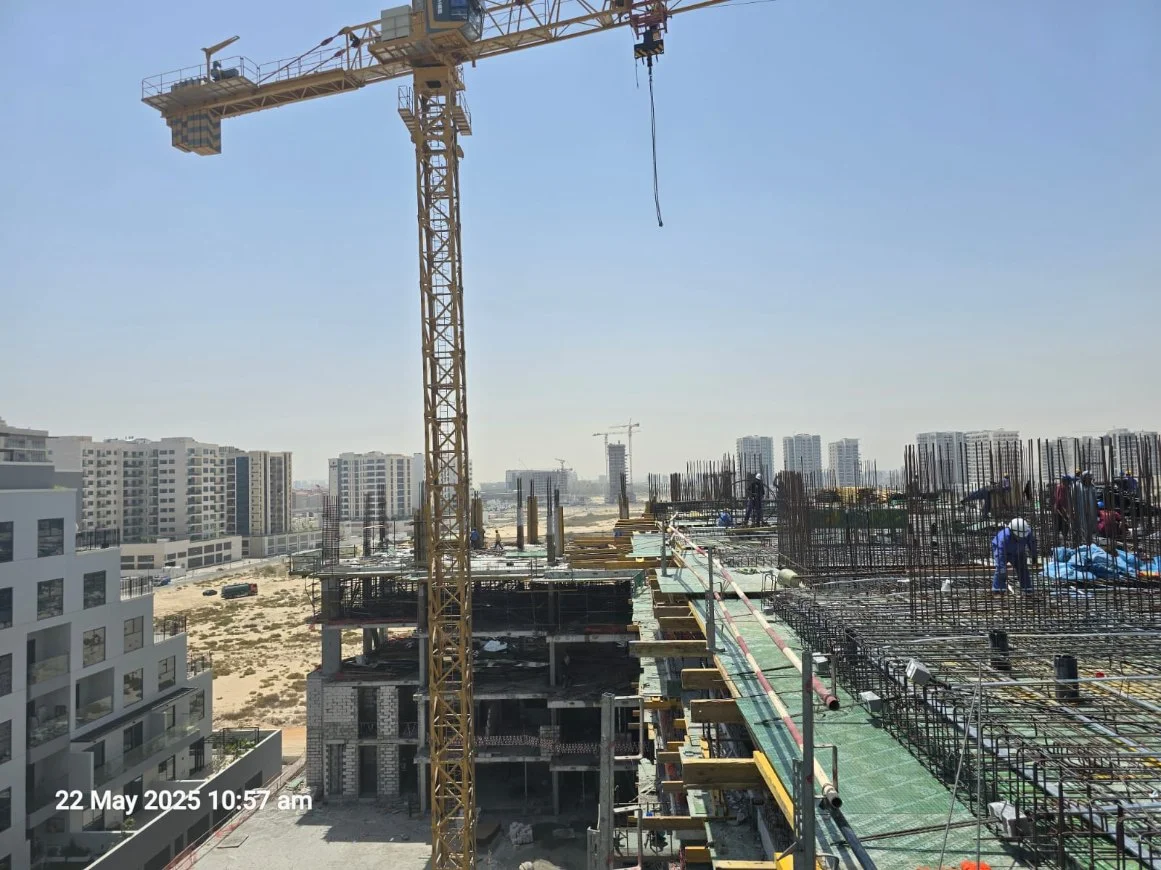

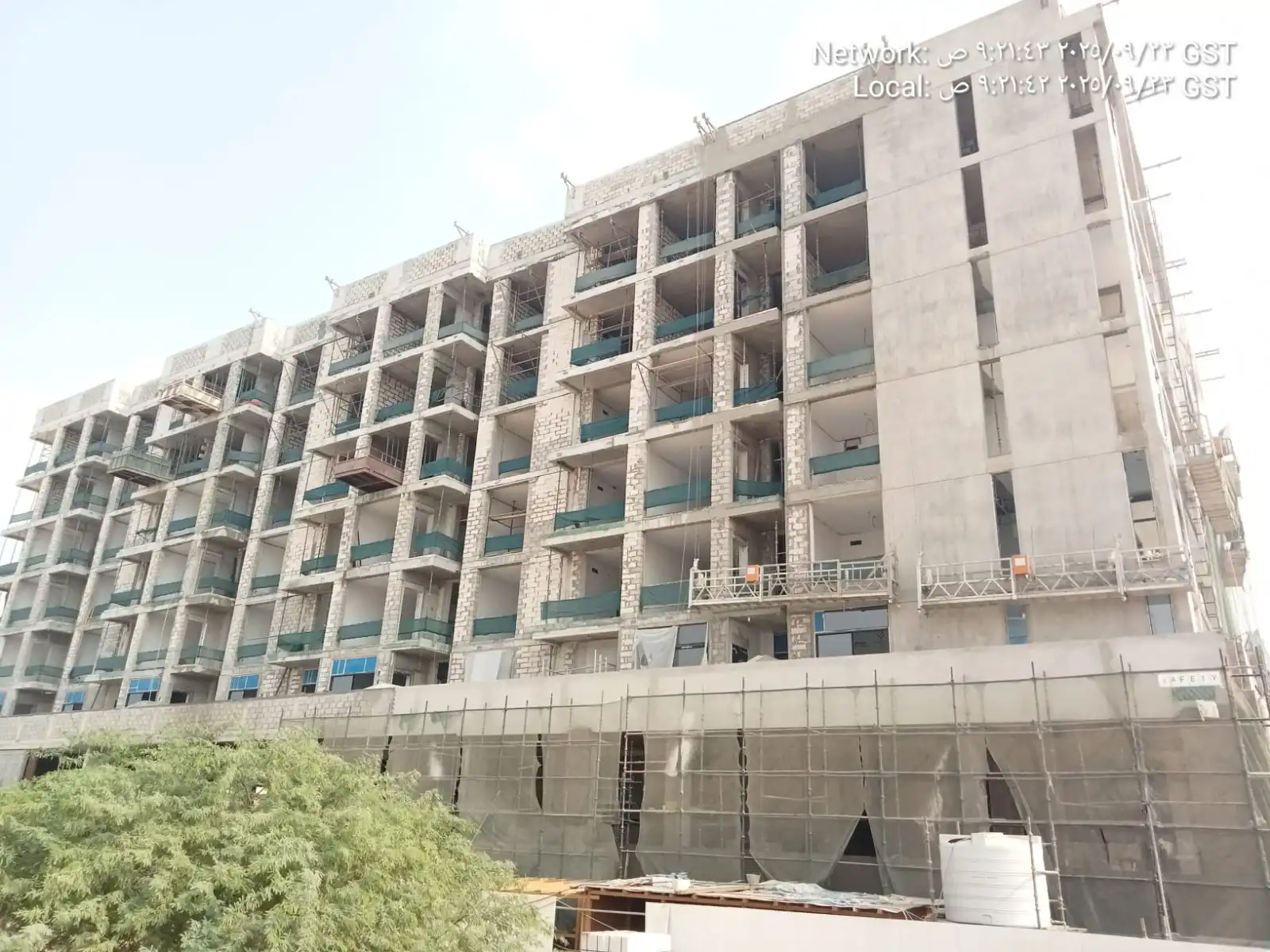

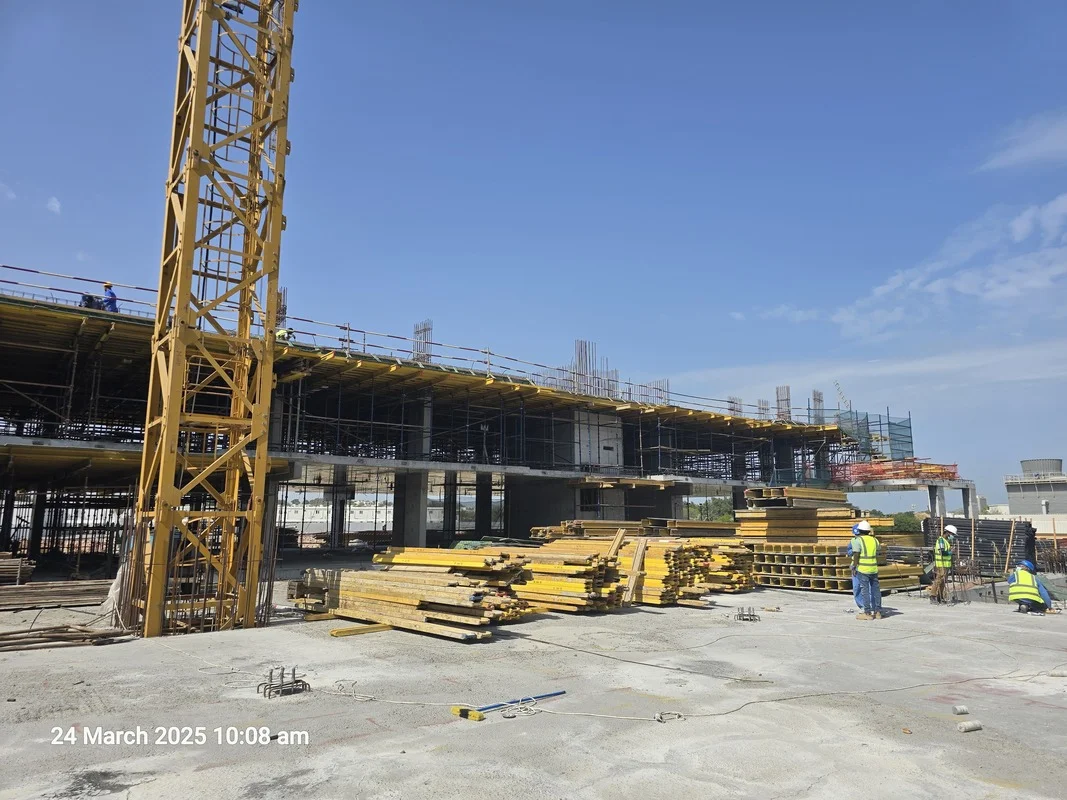

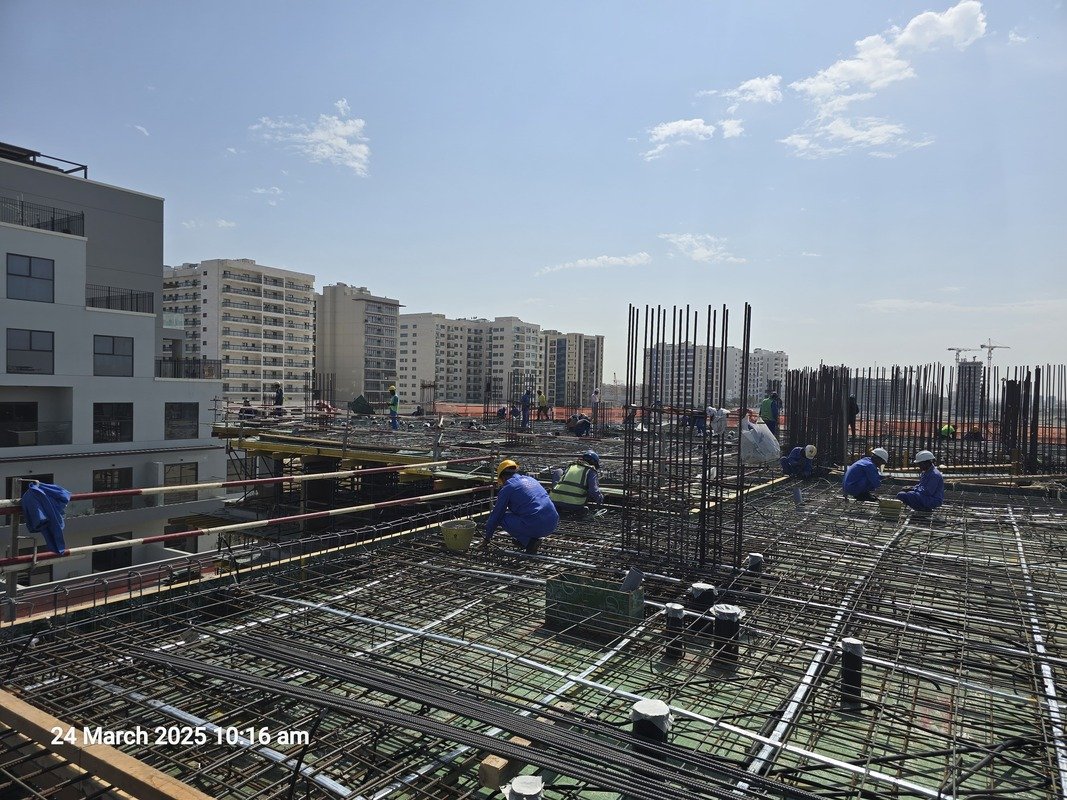

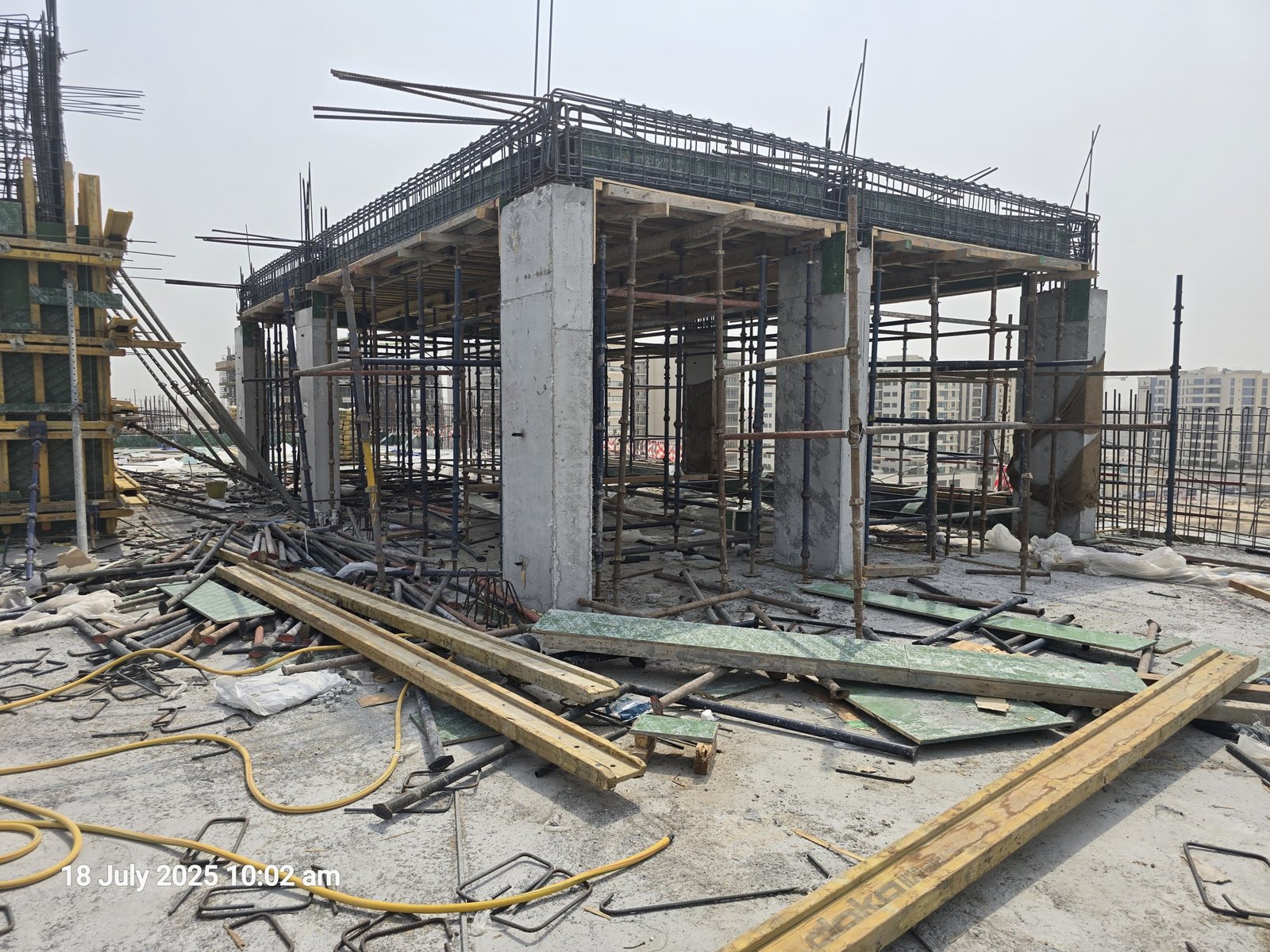

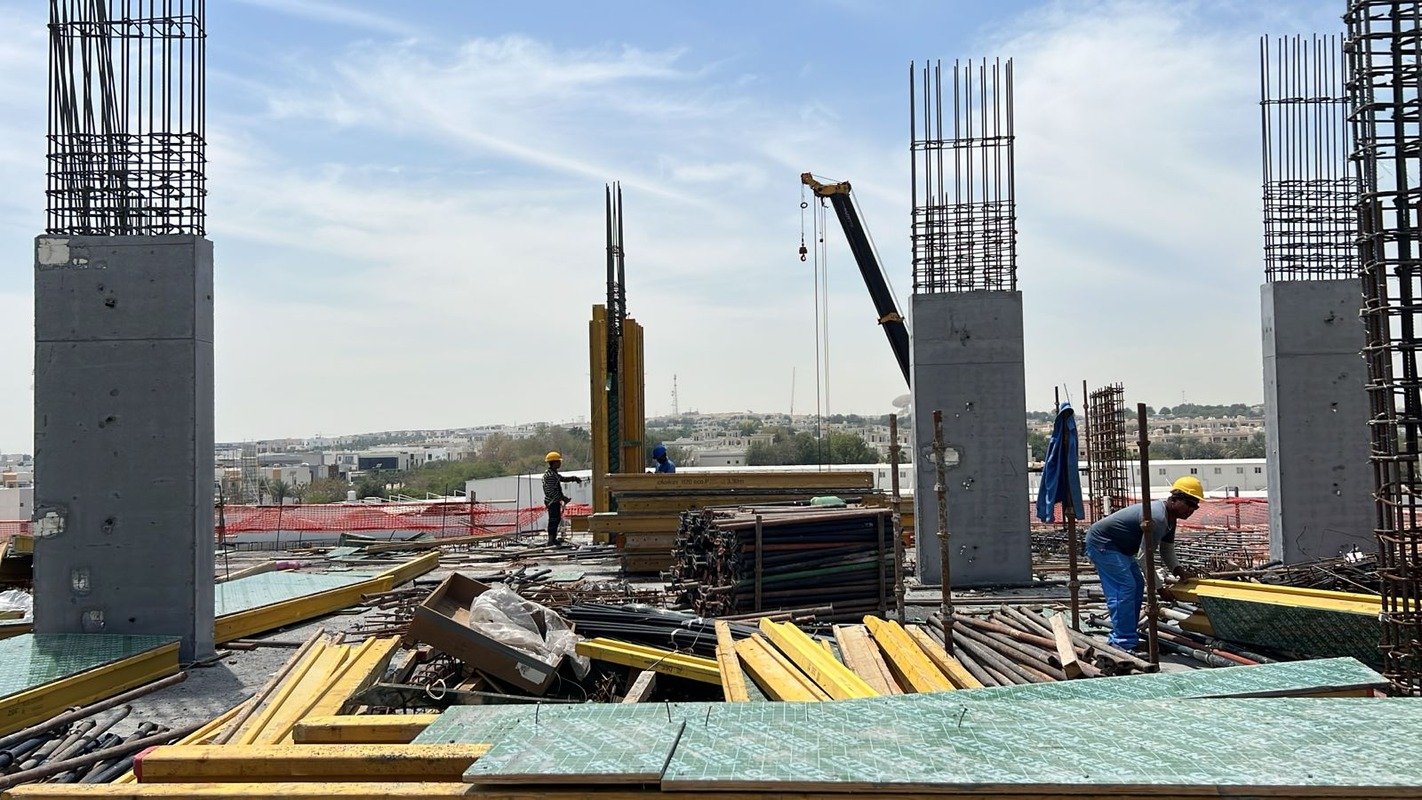

- 1st floor slab shuttering, 40% completed.
- Tower crane setup and operations, 100% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
13.49%
Stage
Main raft & foundation

- 2nd phase waterproofing for main raft top, Zone 1, 100% completed.
- 2 layers of back filling & solid block for substructure, Zone 1, 100% completed.
- Casting slab of water tank, pump rooms and staircase, Zone 1, 100% completed.

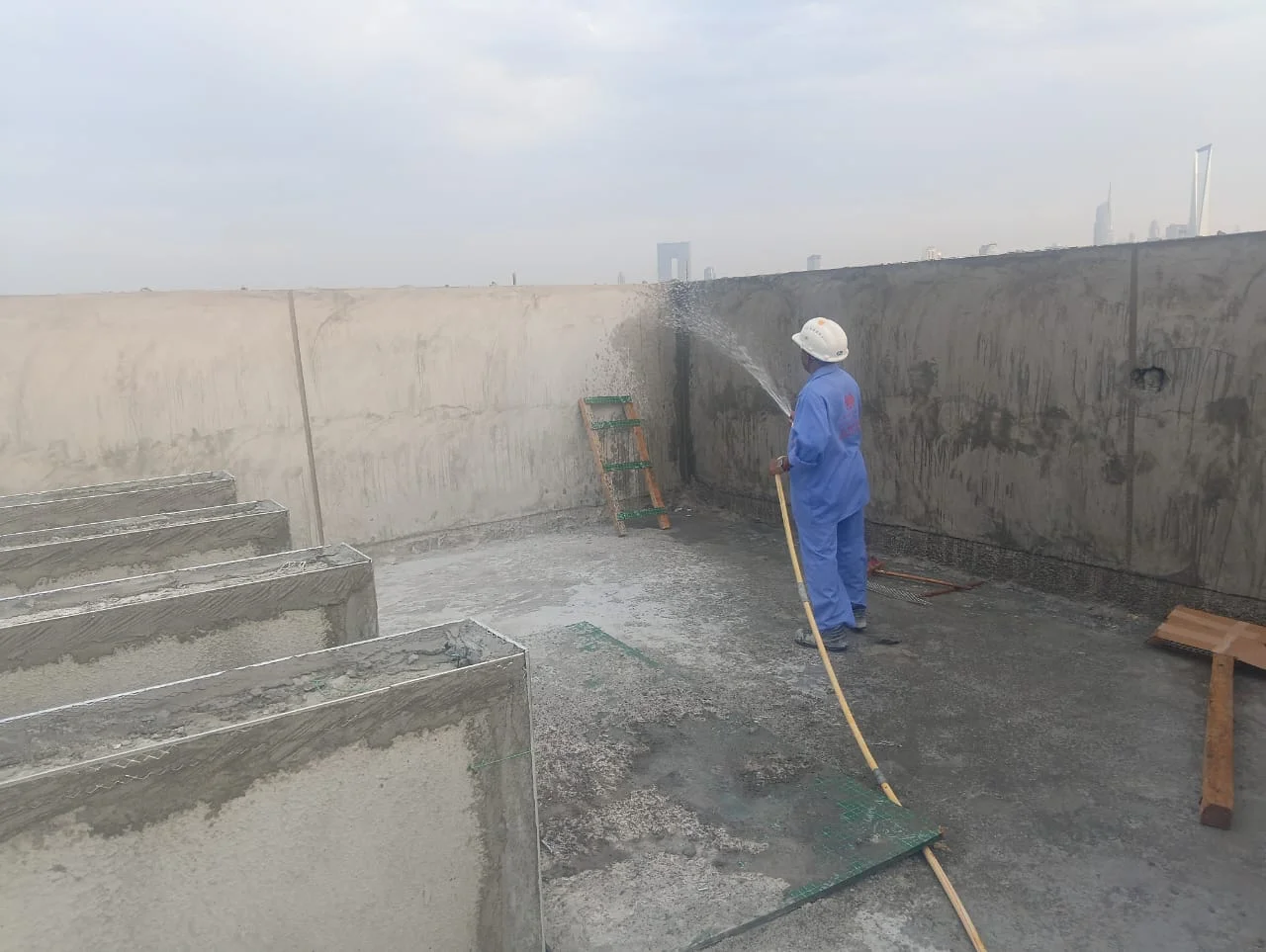

- Waterproofing slab of water tank, pump rooms, Zone 1, 100% completed.

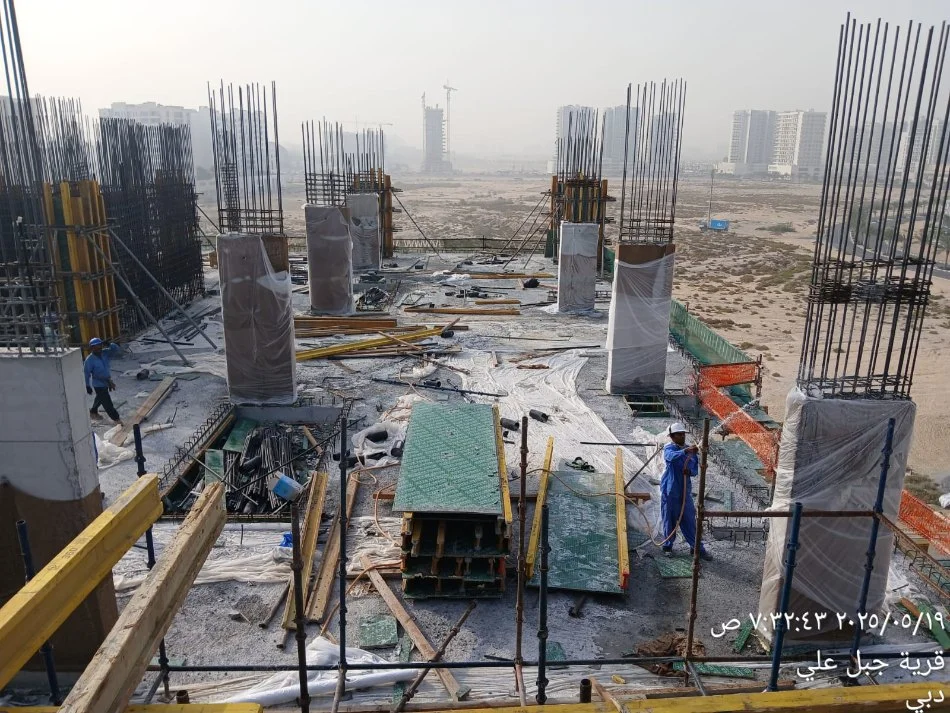

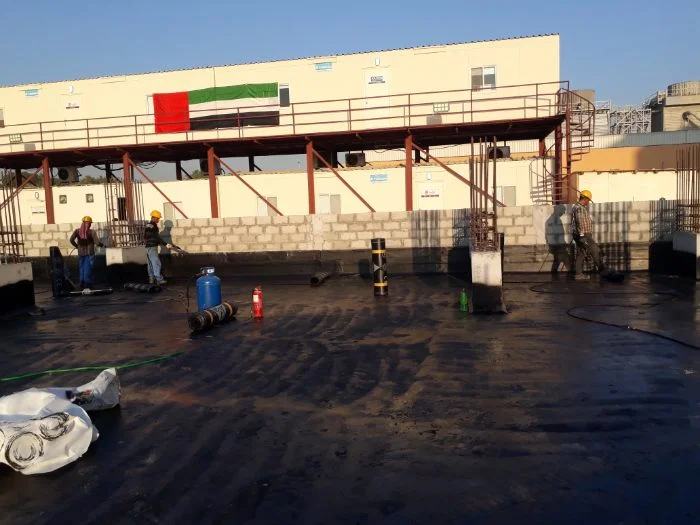

- Casting tie beam and waterproofing, Zone 1, 75% completed.
- Road base & screed under grade slab, Zone 1, 25% completed.
- MEP services under grade slab, Zone 1, 60% completed.

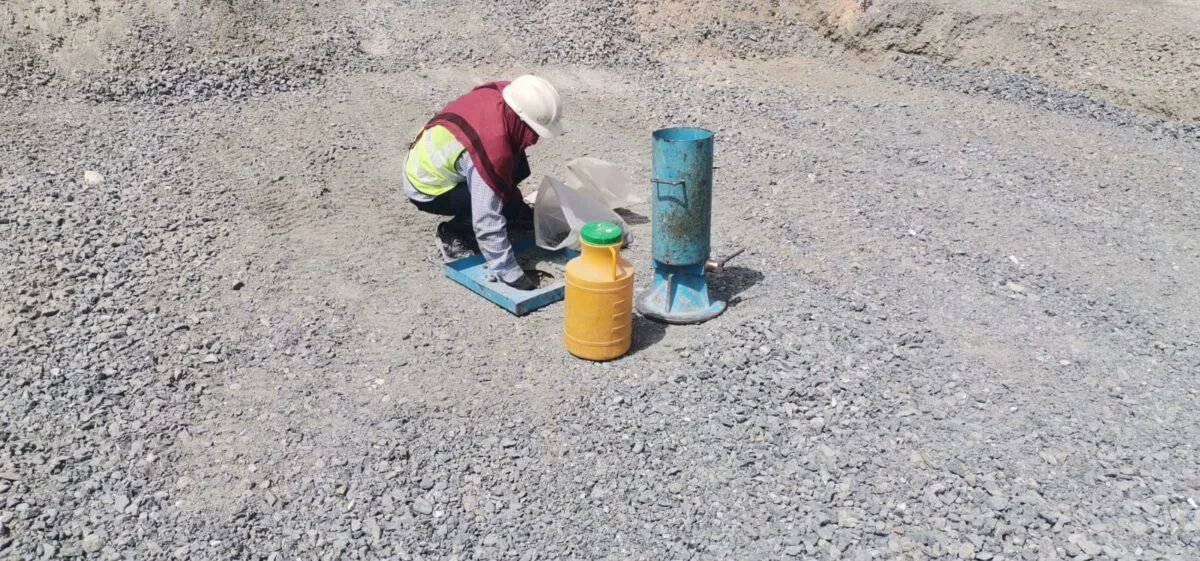

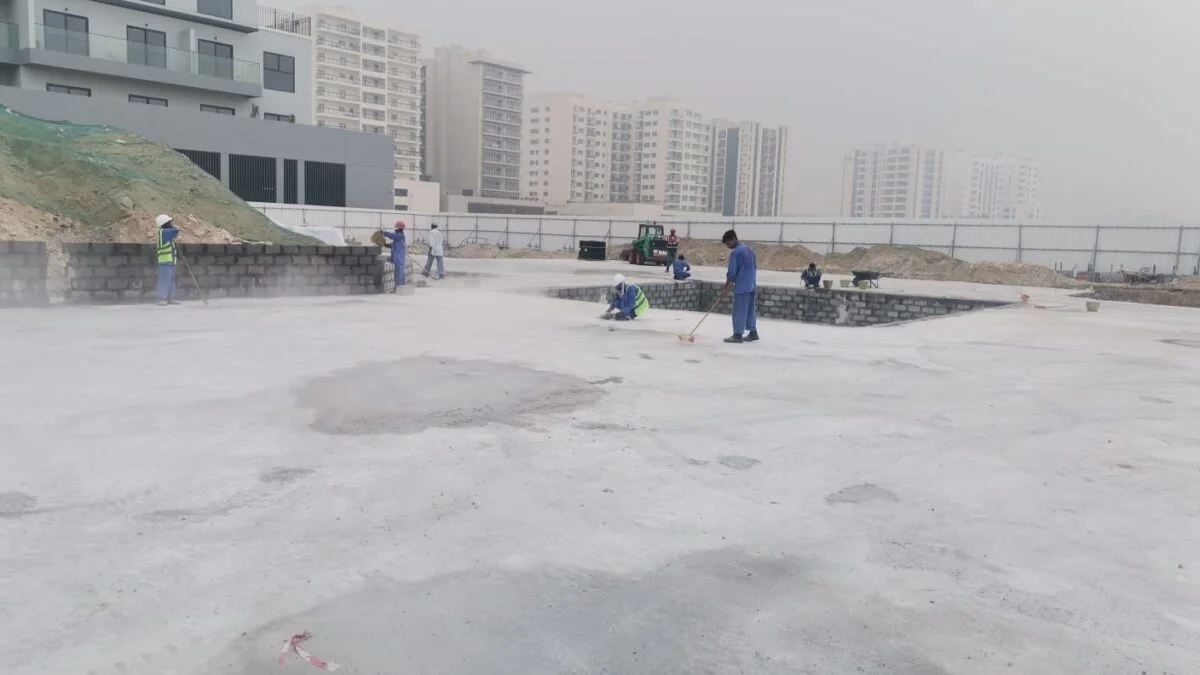

- Excavation of isolated footing, road base & PCC, Zone 2, 75% completed.

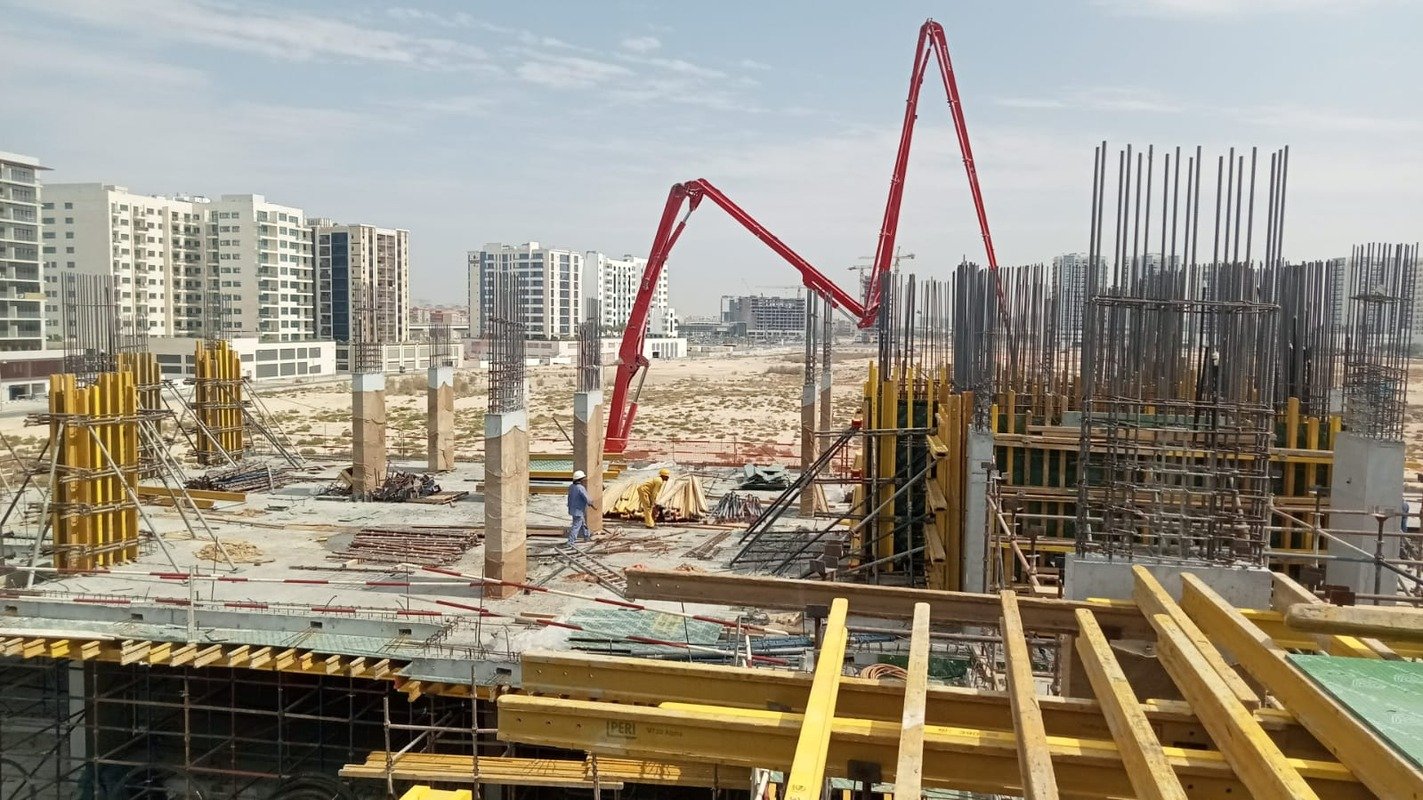

- Casting isolated footing & neck columns, Zone 2, 50% completed.
- Waterproofing isolated footing & neck columns, Zone 2, 45% completed.
- Casting tower crane foundation, Zone 2, 100% completed.
Launched
15th July 2024
Planned handover
30th March 2026

Progress
9.12%
Stage
Main Raft:
- Reinforcement for main raft, lift pit and substation completed.
- Main Raft concrete casting completed.
- 2nd phase waterproofing for main raft top preparation 10% completed.
Under Ground Raft Works:
- 1st phase waterproofing for raft (above PCC) and retaining walls completed.

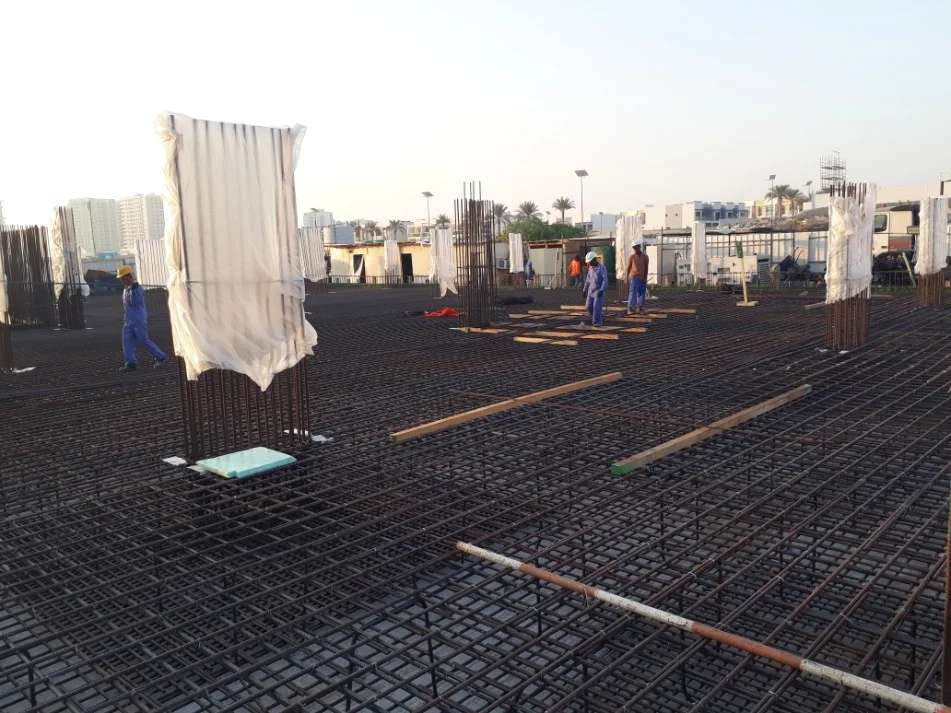

- Raft reinforcement for UG Pump room and Water Tank (WT) completed.
- UG raft and vertical elements for WT and pump room casting completed.
- External waterproofing for WT walls 20% completed.
Launched
15th July 2024
Planned Handover
30th March 2026

Progress
4.32%
Stage
Main Raft
- 1st Phase of Waterproofing for Main Raft (Above PCC) Completed.
- 1st Phase Waterproofing Protection Screed Casted.
- Reinforcement for Main Raft Lift Pit 80% Completed.
Under Ground Raft Works
- Excavation, Levelling, Compaction for U/G Water Tank and Pump Room Raft Completed.
- Solid Blockwork Shuttering for Raft and Retaining Walls Completed.
- Dewatering System Installation Completed. Dewatering Process Ongoing.
- 1st Phase Waterproofing for Raft (Above PCC) and Retaining Walls 50% Completed.
Launched
15th July 2024
Planned Handover
30th March 2026

Progress
3.00%
Stage
Water Tank and Pump Room: Zone 1

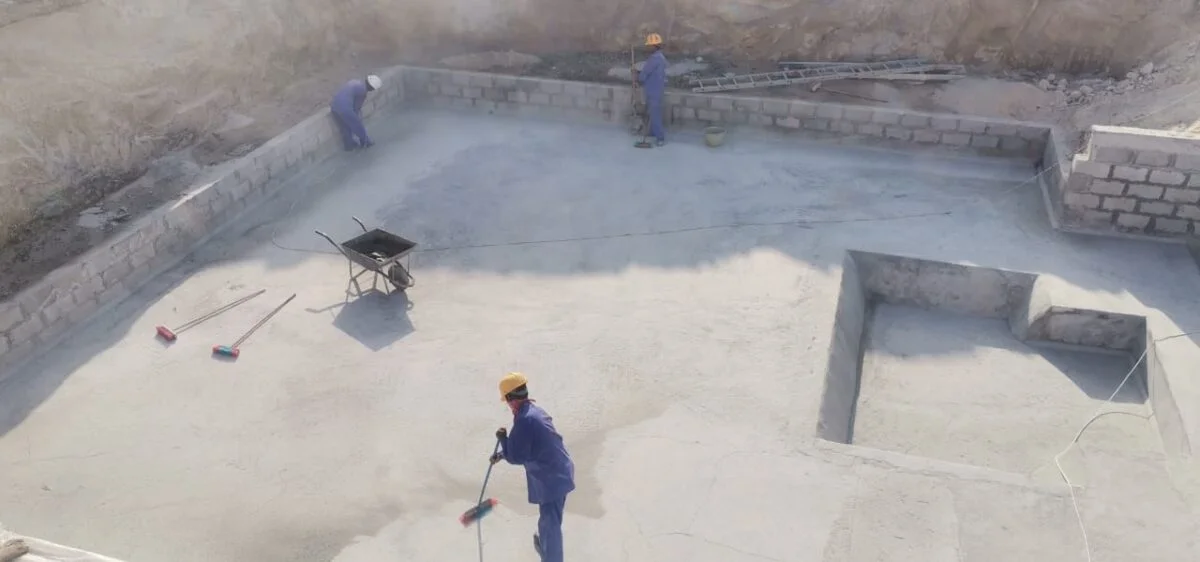

- Excavation Completed.
Under Ground Raft Works
- Excavation completed including lift pits/LV rooms to required levels.
- Compaction testing completed.
- 3 layers road base compaction and testing completed.
- Raft foundation PCC blinding concrete casting completed.
- Lift pit/LV room Raft Shuttering Works completed.
- Water Proofing Preliminary Works completed.
Launched
15th July 2024
Planned Handover
30th March 2026

Progress
1.50%
Stage
Water Tank and Pump Room: Zone 1
- Excavation Started.
Under Ground Raft Works
- Preliminary excavation works ongoing.
- Compaction and levelling of site started.
Launched
15th July 2024
Planned Handover
30th March 2026
