Zazen Gardens Construction Updates

100% Complete

ZāZEN GARDENS

CONSTRUCTION UPDATES
Start Date

OCT 2022

Completion Date

Apr 2024

Al Furjan

This project was delivered on time and handed over on April 30th 2024

TIMELINE

ZāZEN GARDENS – CONSTRUCTION UPDATE

Progress

100%

Stage

Delivered on 30th April

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

99%

Stage

Ground Floor:
  • Installation of Signages Completed
  • Installation of Ironmongeries Completed
  • Painting Works Completed
  • Entrance Lobby ID Works Completed
  • Staircase Epoxy Works Completed
  • MEP 2nd Fix Works Completed (Electrical, Plumbing, Fire Fighting and HVAC Works)
  • MEP 3rd Fix Works Completed
  • Irrigation Works Completed
1st Floor:
  • Painting Works Completed
  • Installation of Herbs/Shrubs and Trees Completed
  • Landscape & Irrigation Works Completed
  • MEP 3rd Fix at Flats, Corridor and Service Rooms Completed
  • Painting Works for Gym & Lounge Completed
  • Open Shower Works Completed
  • Installation of Glass Partition Completed
  • Installation of Gym & Lounge Aluminium & Glazing Works Completed
2nd – 4th Floor:
  • Painting Works Completed
  • MEP 3rd Fix Works Completed
  • Installation of Sanitary Wares Completed
5th Floor:
  • Painting Works Completed
  • Installation of White Goods Completed
  • MEP 3rd Fix Works Completed
  • Installation of Sanitary Wares Completed

6th Floor:
  • Painting Works Completed
  • Installation of White Goods Completed
  • MEP 3rd Fix Works Completed
  • Installation of Sanitary Wares Completed
Roof Floor:
  • Painting Works Completed
  • MEP 3rd Fix Works Completed
  • Snagging & De-snagging in Progress
  • Testing & Commissioning in Progress
Authority Inspection & Approvals:
  • Dubai Civil Defence: Certificate Obtained
  • Demarcation: Demarcation Certificate Obtained
  • Nakheel (NCC): Application completed
  • DEWA (Electrical): DEWA Power Obtained
  • DEWA (Water): Construction of Water Meter Chamber Works under progress by DEWA appointed subcontractor
  • SIRA: Subcontractor following up with Authority to obtain Final Approval
  • Building Completion Certificate (BCC): Obtained from Trakhees (EHS & CED)
  • Dubai Land Department Completion: In process

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

95.36%

Stage

Ground Floor:
  • Installation of Signages, Ironmongery & Painting Works in Progress
  • Installation of Glazing, Doors, False Ceiling, Staircase Epoxy, Paving, Irrigation, Fountain Works Completed
  • Entrance Lobby ID Works in Progress
  • MEP 2nd & 3rd Fix Works in Progress
LV Room:
  • MEP 3rd Fix Works Completed
1st Floor:
  • 80% Painting Works Completed
  • Installation of Herbs/Shrubs and Trees in Progress
  • Landscape & Irrigation Works in Progress
  • MEP 3rd Fix at Apartments, Corridor and Service Rooms in Progress
  • Painting Works for Gym & Lounge in Progress
2nd – 4th Floor:
  • Snagging & De-snagging in Progress
  • 90% of Painting Works Completed
  • Epoxy for Staircase Completed
  • MEP 3rd Fix Works in Progress
5th Floor:
  • 80% of Painting Works Completed
  • Installation of Glass Partition Completed
  • Installation of White Goods in Progress
  • Epoxy for Staircase Completed
  • MEP 3rd Fix Works in Progress
  • Installation of Sanitary Ware in Progress
6th Floor:
  • Dry Area False Ceiling Works Completed
  • 80% of Painting Works Completed
  • Installation of Vanity Counter Completed
  • Installation of Kitchen Completed
  • Installation of White Goods in Progress
  • Installation of Glass Partition in Progress
  • Installation of Sanitary Ware in Progress
Roof Floor:
  • Installation of LPG Tank & Accessories Completed
  • Painting Works in Progress
  • MEP 2nd Fix Works Completed
  • Installation of Louvers/Fence around LPG Tank Completed
Authority Inspection & Approvals:
  • Dubai Civil Defence: Breaching Inlet Inspection & Approval Completed by DCD
  • Demarcation: Demarcation Certificate Obtained
  • Nakheel (NCC): Application Completed
  • DEWA (Electrical): 2nd DEWA LV Inspection Completed, Payment, Receipt & Installation Completed
  • DEWA (Water): Water Meter Chamber Works on hold by DEWA subcontractor (Expected to start next week)

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

89.04%

Stage

Pump Room:
  • MEP 3rd Fix Works in Progress
  • Epoxy Works Completed
  • Installation of Staircase Handrail Completed
  • Doors & Equipment Installation Completed
Ground Floor:
  • 50% of Paving Works (Interlock) Completed
  • Corridor False Ceiling Works Completed
  • Installation of Swimming Pool Equipment Completed
  • Kerbstone Works Completed
  • Service Room MEP 2nd & 3rd Fix Works in Progress
LV Room:
  • MEP 2nd Fix Works Completed
  • MEP 3rd Fix Works in Progress
  • Installation of FM 200 Completed
1st Floor:
  • Balcony Tiling Works Completed
  • Aluminium & Glazing Works Completed
  • Landscape, Irrigation & Soil Filling of Planter Box Completed
  • Installation of Sanitary Wares Completed
  • Installation of Wardrobes Completed
  • Installation of White Goods Completed
  • Signage, Balcony Tiling & Handrail Completed
  • Landscape & Irrigation Works in Progress
  • MEP 3rd Fix at Apts, Corridor & Service Rooms in Progress
  • Painting Works for Gym & Lounge in Progress
2nd Floor:
  • 80% of Painting Works Completed
  • MEP 3rd Fix Works Completed
  • Installation of White Goods Completed
  • Installation of Sanitary Wares Completed
  • 1st Coat Paint Completed
3rd Floor:
  • Installation of Glass Partition Completed
  • Aluminium & Glazing Works Completed
  • Installation of Sanitary Wares Completed
  • MEP 3rd Fix Works Completed
  • Wall & Ceiling Painting in Progress
4th Floor:
  • Installation of Kitchen Cabinet Completed
  • Installation of Glass Partition Completed
  • Wall & Ceiling Painting Completed
  • Aluminium & Glazing Works Completed
  • Balcony Handrail Completed
  • Installation of Sanitary Wares Completed
  • MEP 3rd Fix Works in Progress
5th Floor:
  • Installation of Doors Completed
  • Installation of Vanity Counter Completed
  • Installation of Kitchen Cabinet Completed
  • Wet Area Tiling Completed
  • Corridor False Ceiling Works Completed
  • Aluminium & Glazing Works Completed
  • Balcony Handrail Completed
  • MEP 3rd Fix Works in Progress
  • Wall & Ceiling Painting in Progress
  • Installation of Sanitary Wares in Progress
6th Floor:
  • Installation of Kitchen Cabinet Completed
  • Installation of Doors Completed
  • Installation of Wardrobe Completed
  • Ceiling Painting Completed
  • Wet Area Tiling Completed
  • Aluminium & Glazing Works Completed
  • Balcony Handrail Completed
  • Installation of Sanitary Wares in Progress
  • Wall & Ceiling Painting in Progress
  • MEP 3rd Fix Works in Progress
Roof Floor:
  • Installation of LPG Tank & Accessories in Progress
  • Painting Works in Progress
  • Planter Box Works in Progress
  • MEP 2nd Fix Works in Progress
  • Solar PV System Works Completed

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

80.19%

Stage

Pump Room:
  • MEP 2nd Fix Works & Equipment Installation Completed
  • MEP 3rd Fix Works in Progress
  • Epoxy Paint in Progress
Ground Floor:
  • 25% of Paving Works (Interlock) Completed
  • Corridor False Ceiling Works Completed
  • 70% of Installation of Swimming Pool Equipment Completed
  • Service Room MEP Works in Progress
  • Staircase Epoxy in Progress
  • Wet Area Tiling Works in Progress
LV Room:
  • MEP 2nd Fix Works in Progress
1st Floor:
  • Balcony Tiling Works in Progress
  • Aluminium & Glazing Works 80% Completed
  • Landscape, Irrigation & Soil Filling of Planter Box in Progress
  • MEP 3rd Fix for Apts, Corridor & Service Rooms in Progress
  • Painting Works for Gym & Lounge in Progress
  • Swimming Pool & Water Body Works in Progress
  • Wet Area Tiling Works for Gym & Lounge Completed
  • 1st Coat Paint Completed
2nd Floor:
  • Installation of Pergola Completed
  • Installation of Glass Partition Completed
  • 80% of Painting Works Completed
  • MEP 3rd Fix Works in Progress
  • LPG Installation in Progress
  • 1st Coat Paint Completed
3rd Floor:
  • Installation of Kitchen Cabinet & Vanity Counter Completed
  • Wet Area Tiling Completed
  • 1st Coat Paint Completed
  • Installation of Glass Partition in Progress
  • Wall & Ceiling Painting in Progress
  • Staircase Epoxy in Progress
  • Aluminium & Glazing Works in Progress
  • Installation of Balcony Handrail Completed
  • Installation of Sanitary Wares in Progress
  • MEP 3rd Fix Works in Progress
4th Floor:
  • Installation of Doors Completed
  • Wet Area Tiling Completed
  • Installation of Kitchen Cabinet in Progress
  • Installation of Glass Partition in Progress
  • Wall & Ceiling Painting in Progress
  • Aluminium & Glazing Works in Progress
  • Balcony Handrail in Progress
  • Installation of Sanitary Wares in Progress
  • MEP 3rd Fix Works in Progress
5th Floor:
  • Installation of Doors Completed
  • Installation of Vanity Counter Completed
  • Wet Area Tiling Completed
  • Corridor False Ceiling Works Completed
  • Installation of Kitchen Cabinet in Progress
  • Wall & Ceiling Painting in Progress
  • Aluminium & Glazing Works in Progress
  • Balcony Handrail in Progress
  • Installation of Sanitary Wares in Progress
  • MEP 3rd Fix Works in Progress
6th Floor:
  • Dry Area False Ceiling Works Completed
  • Corridor False Ceiling Works Completed
  • Installation of Kitchen Cabinet in Progress
  • Installation of Doors in Progress
  • Installation of Vanity Counter in Progress
  • Ceiling Painting in Progress
  • Aluminium & Glazing Works in Progress
  • Balcony Handrail in Progress
  • Installation of Sanitary Wares in Progress
  • MEP 3rd Fix Works in Progress
Roof Floor:
  • Installation of LPG Tank & Accessories in Progress
  • Painting Works in Progress
  • Planter Box Works in Progress
  • MEP 2nd Fix Works in Progress

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

72.09%

Stage

Pump Room:
  • Installation of Equipment in Progress
  • MEP 3rd Fix in Progress
Ground Floor:
  • 30% of Corridor Suspension Works Completed
  • 30% of Installation of Swimming Pool Equipment Completed
  • MEP 2nd Fix Works in Progress
  • Service Room MEP Works in Progress
LV Room:
  • MEP 2nd Fix Works in Progress
1st Floor:
  • Wall & Ceiling Painting Completed
  • Balcony Upstand Completed
  • False Ceiling Works Completed
  • Installation of Kitchen Cabinets Completed
  • Installation of Wardrobes Completed
  • MEP 3rd Fix in Apartments in Progress
  • MEP 2nd Fix Works for Gym & Lounge in Progress
  • Aluminium & Glazing Works in Progress
  • Swimming Pool & Water Body Works in Progress
2nd Floor:
  • Wall & Ceiling Painting Completed
  • Balcony & Corridor Tiling Completed
  • Vanity Counter Works Completed
  • Kitchen Cabinet Works Completed
  • Sanitary Ware Installation Completed
  • MEP 2nd Fix Completed
  • MEP 3rd Fix Works in Progress
  • LPG Installation in Progress
3rd & 4th Floor:
  • Wall & Ceiling Painting in Progress
  • Balcony & Corridor Tiling in Progress
  • Aluminium & Glazing Works in Progress
  • Sanitary Ware Installation in Progress
  • MEP 2nd Fix Completed
  • MEP 3rd Fix Works in Progress
5th & 6th Floor:
  • Wall & Ceiling Painting in Progress
  • Aluminium & Glazing Works in Progress
  • Balcony & Corridor Tiling Works in Progress
  • False Ceiling Works in Progress

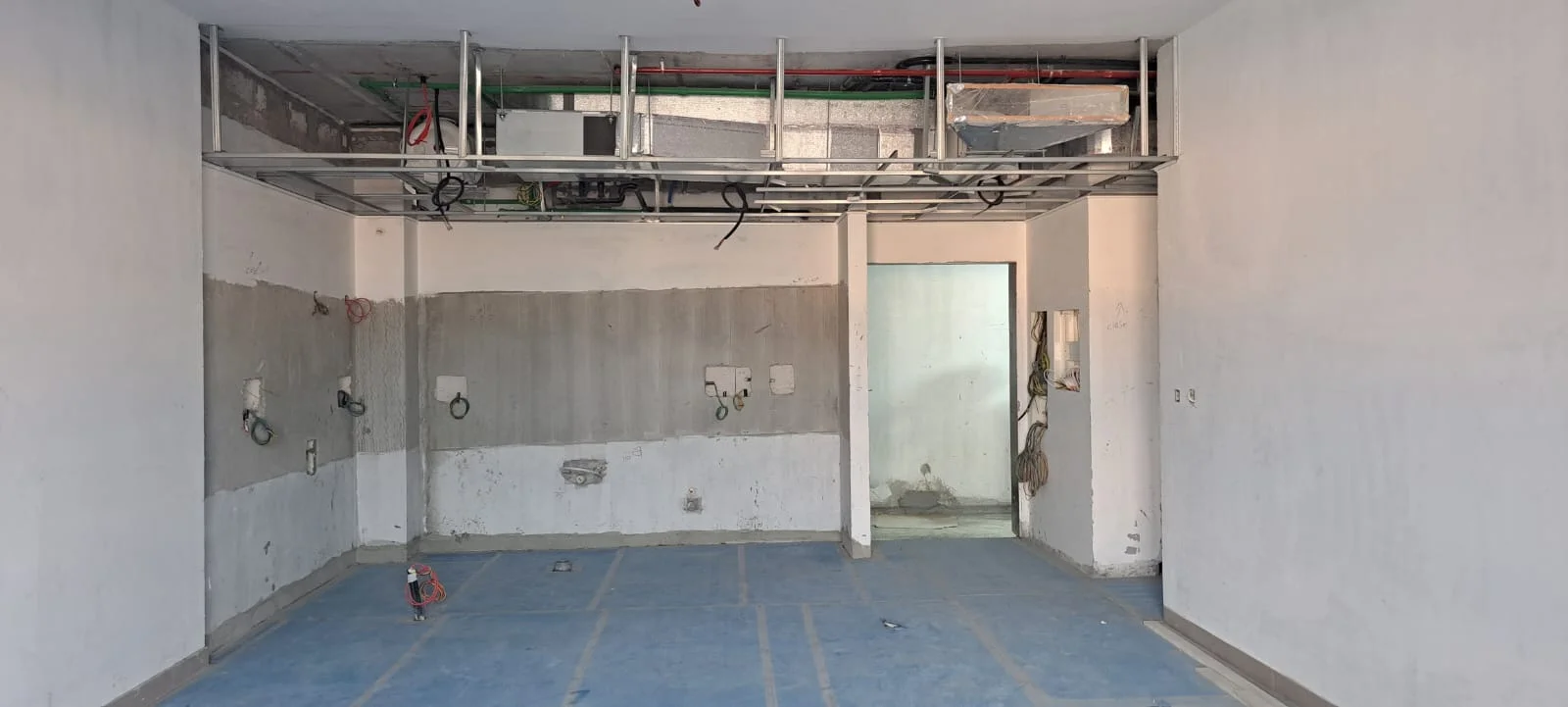

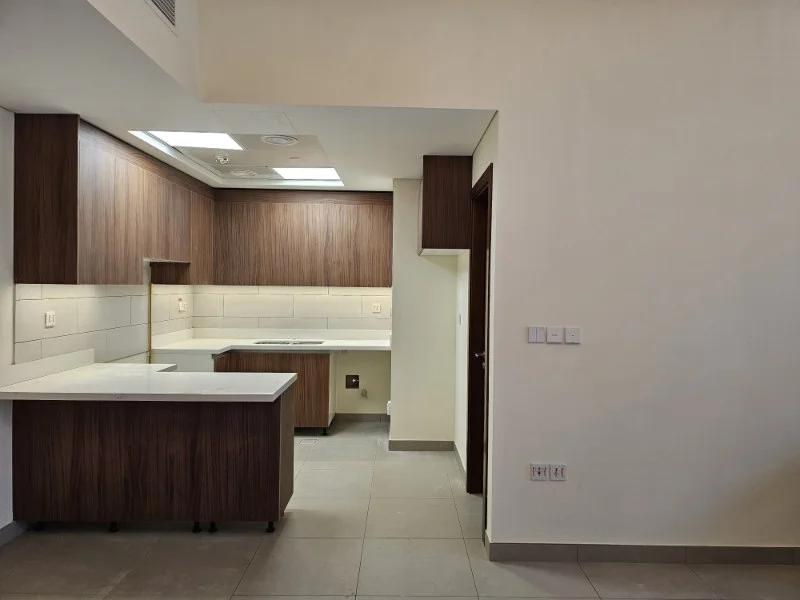

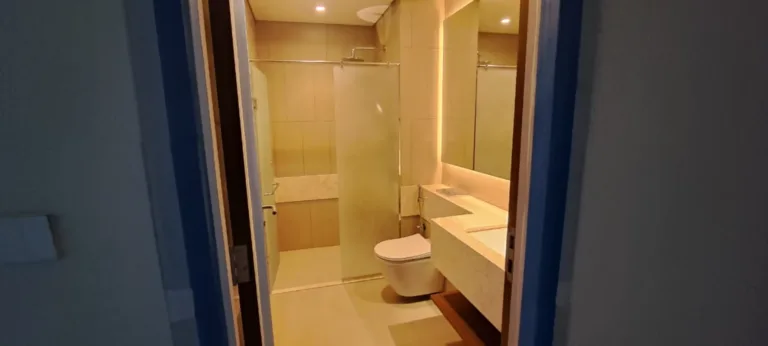

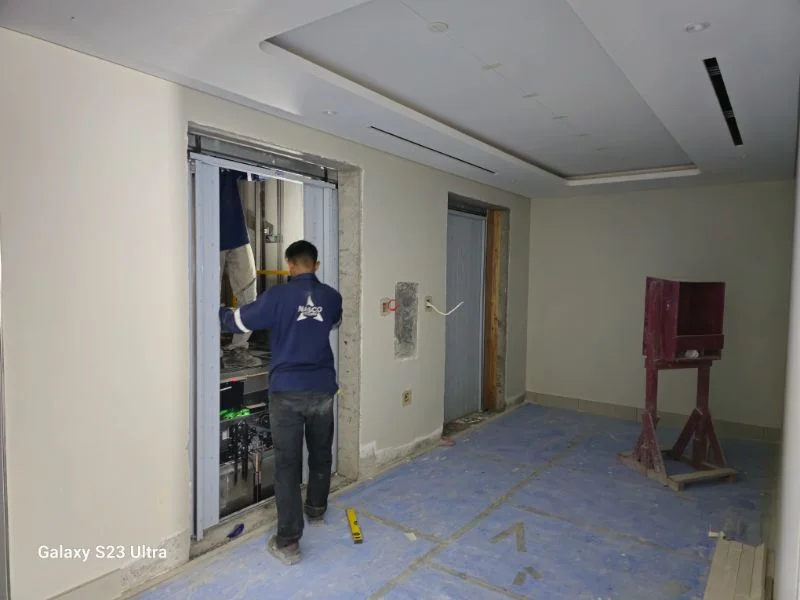

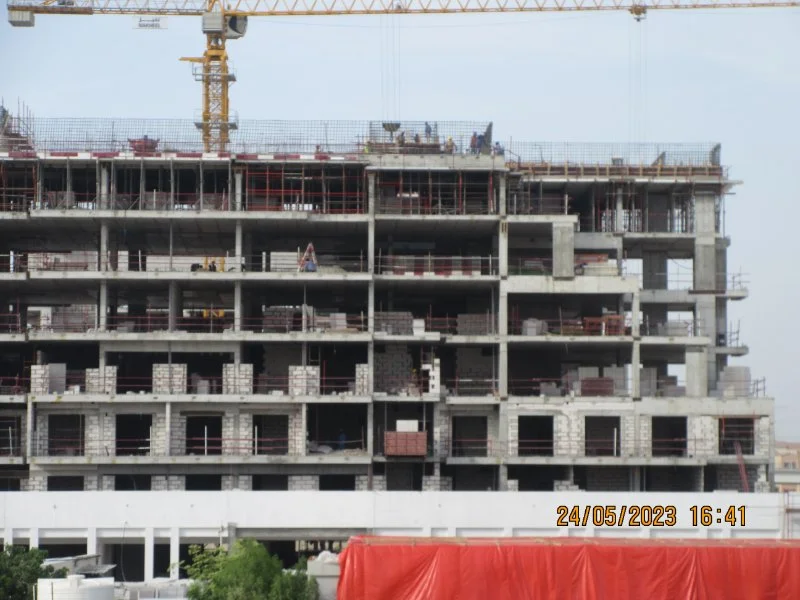

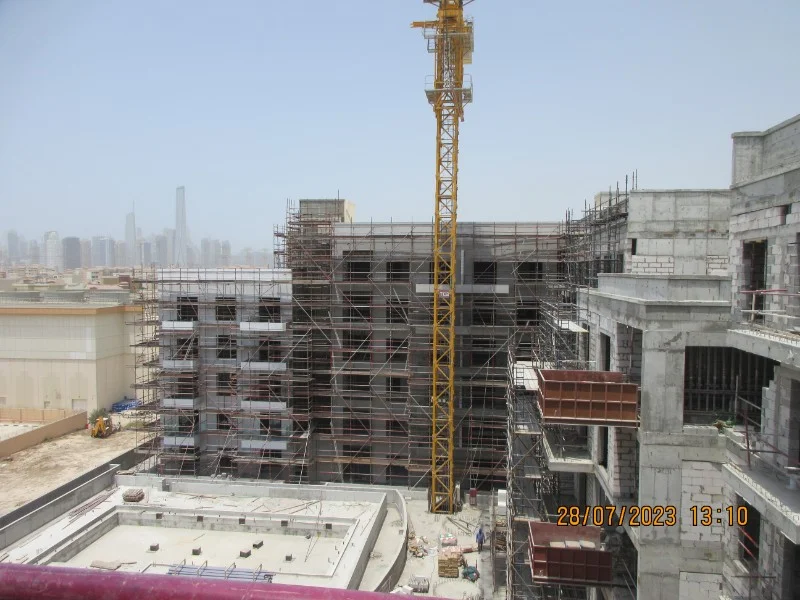

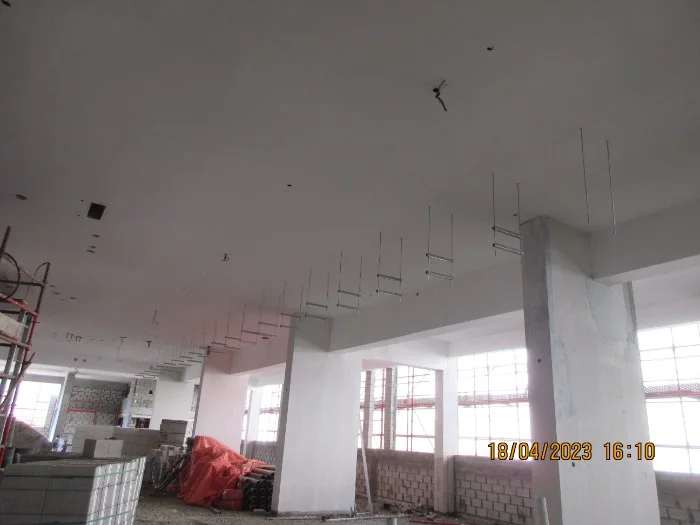

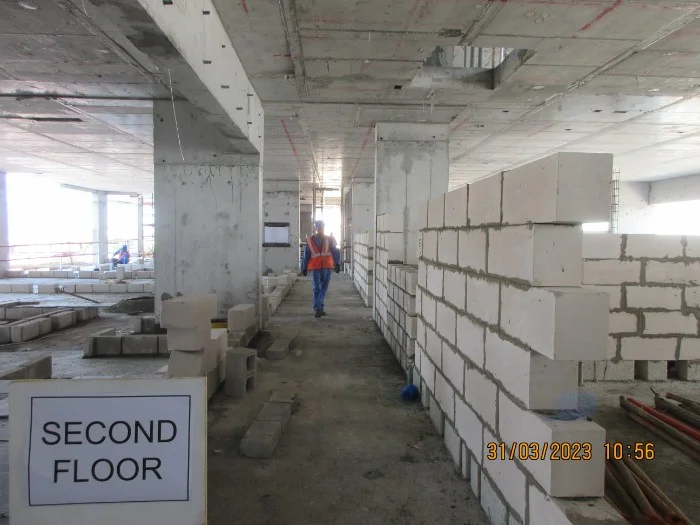

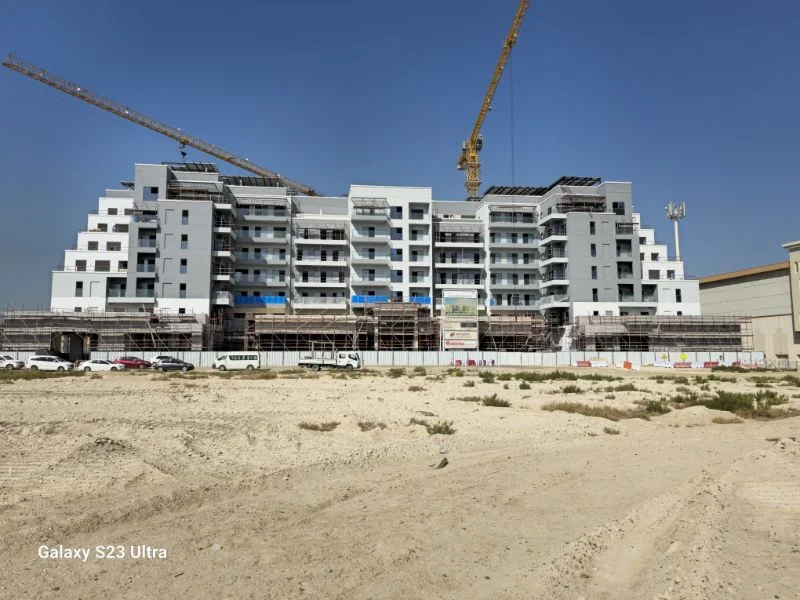

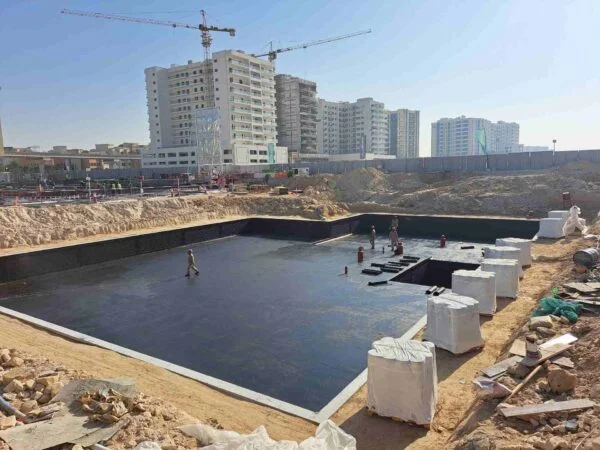

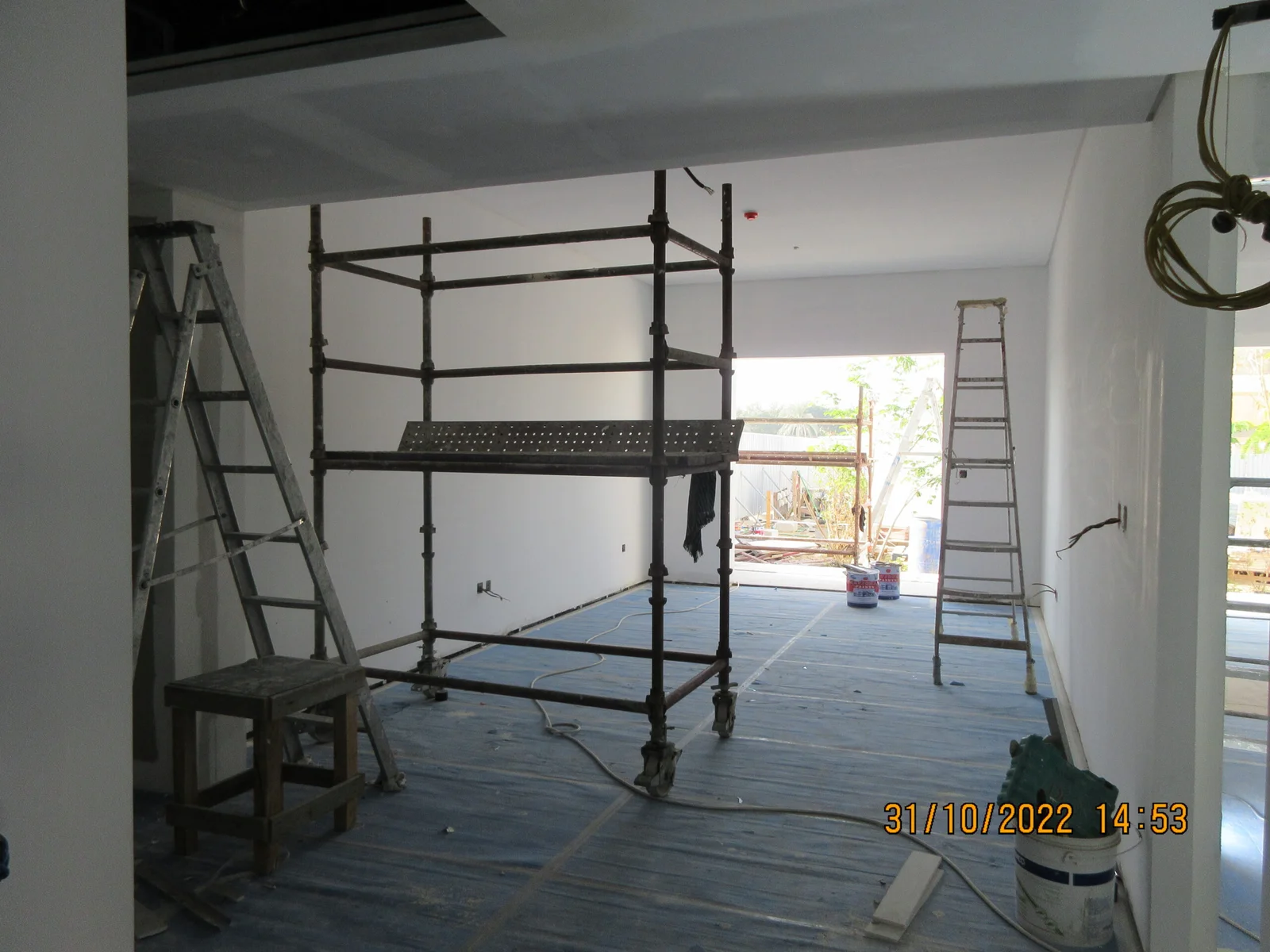

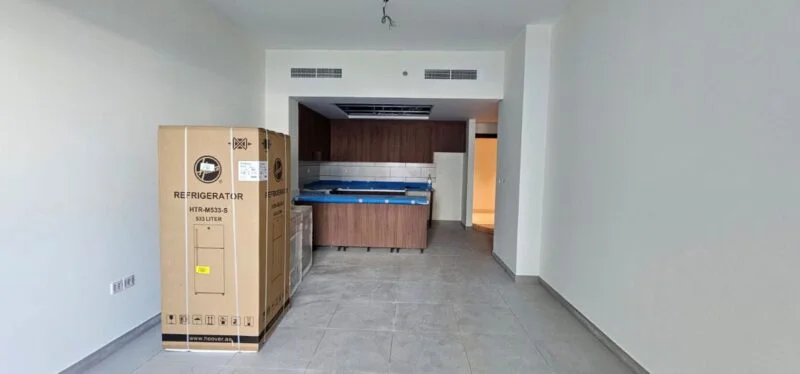

  • MEP 2nd & 3rd Fix Works in Progress
Roof Floor:
  • Erection of Steel Structure Completed
  • Solar Works Completed

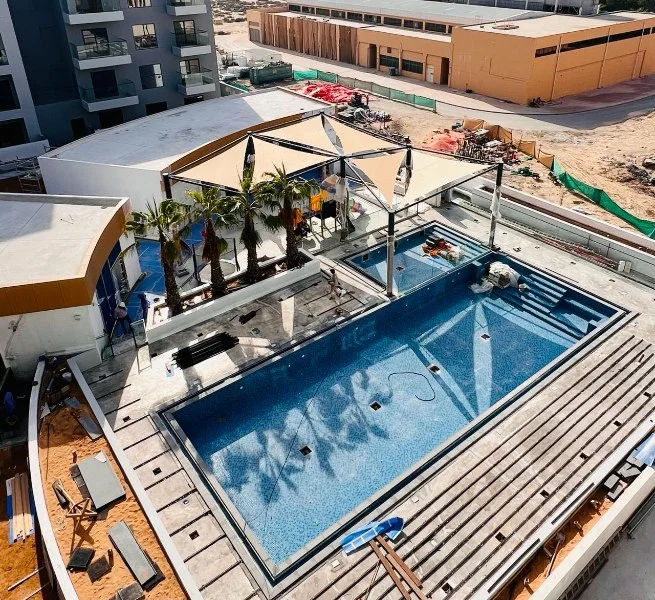

  • MEP 2nd Fix Works in Progress
Façade:

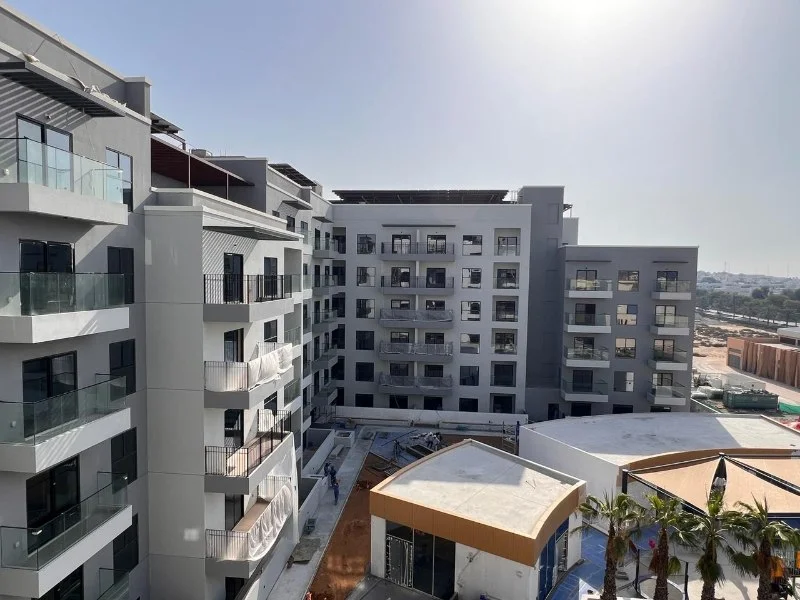

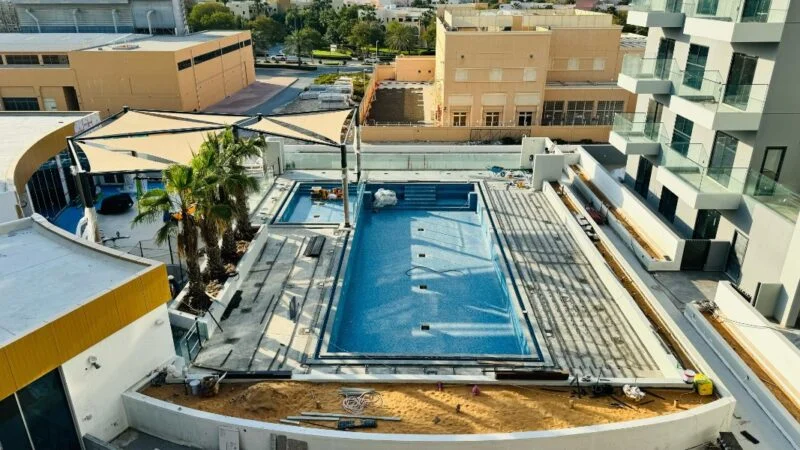

  • 95% of External Painting for Façade (1st Floor to Roof Floor) Completed
  • Ground Floor Aluminium Screens / Louvers in Progress

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

65.52%

Stage

Pump Room:
  • Installation of Equipment in Progress
  • MEP 3rd Fix in Progress

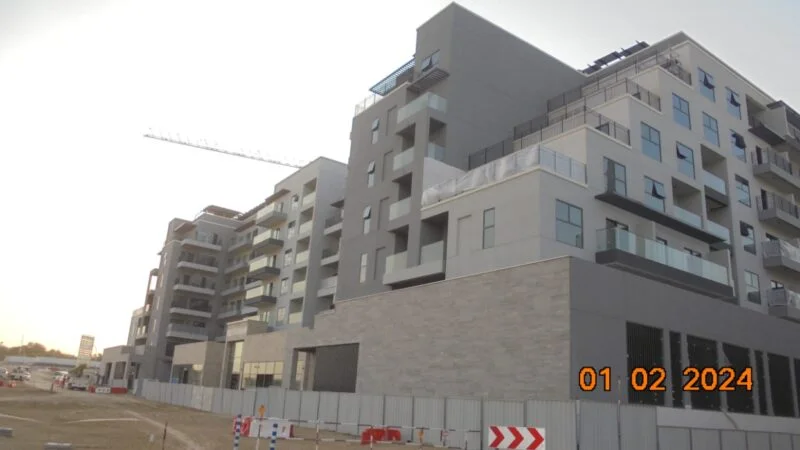

Ground Floor:

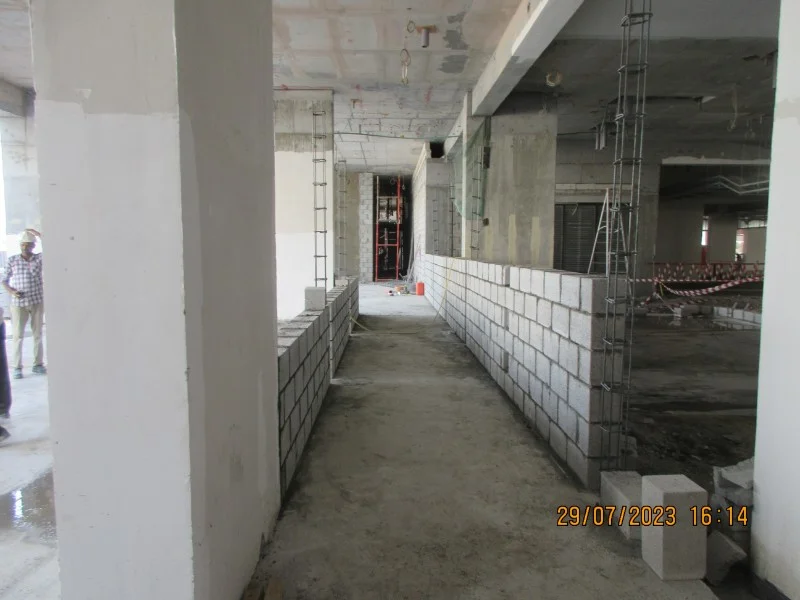

  • 100% of Block Work Completed
  • 100% of Ceiling Completed
  • 100% of Corridor Plaster Completed
  • MEP 2nd Fix Works in Progress

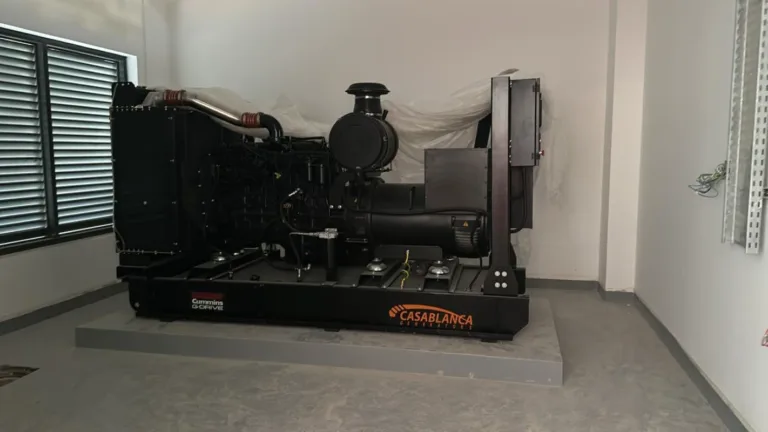

  • Installation of Generator Completed
LV Room:
  • MEP 2nd Fix Works in Progress
1st Floor:
  • Wall & Ceiling Painting in Progress
  • Balcony Upstand in Progress
  • False Ceiling Works in Progress
  • Tiling Works in Progress

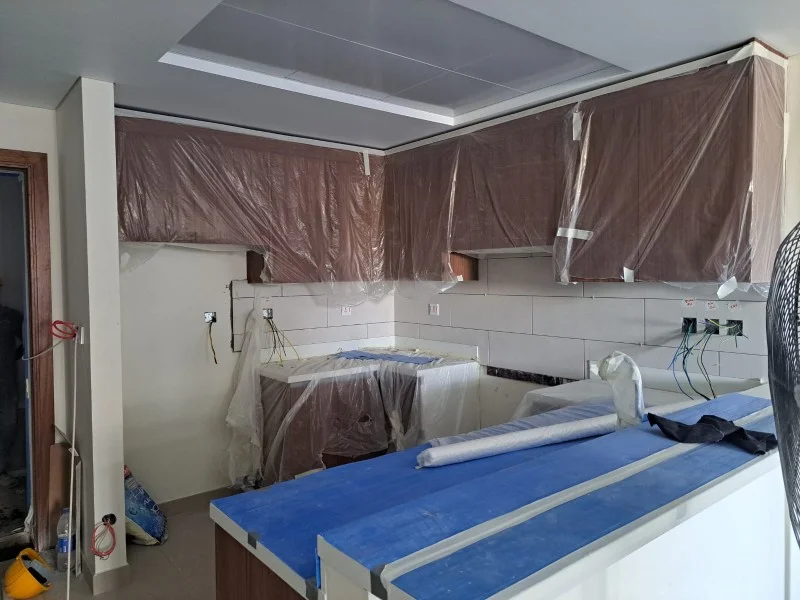

  • Kitchen Cabinet Works in Progress
  • MEP 2nd Fix in Progress
  • 100% Block Works at Gym & Lounge Completed
  • Swimming Pool Works in Progress
2nd Floor:
  • Wall & Ceiling Painting in Progress
  • Balcony & Corridor Tiling in Progress
  • Vanity Counter Works in Progress
  • Kitchen Cabinet Works in Progress
  • Sanitary Ware Installation in Progress
  • MEP 2nd Fix in Progress
  • MEP 3rd Fix in Progress
3rd & 4th Floor:
  • Wall & Ceiling Painting in Progress
  • Balcony & Corridor Tiling in Progress
  • Aluminium & Glazing Works in Progress
  • Sanitary Ware Installation in Progress
  • MEP 2nd Fix in Progress
  • MEP 3rd Fix in Progress
5th & 6th Floor:
  • Wall & Ceiling Painting in Progress
  • Aluminium & Glazing Works in Progress
  • Balcony & Corridor Tiling Works in Progress
  • False Ceiling Works in Progress
  • MEP 2nd & 3rd Fix in Progress
Roof Floor:
  • Roof Waterproofing Completed

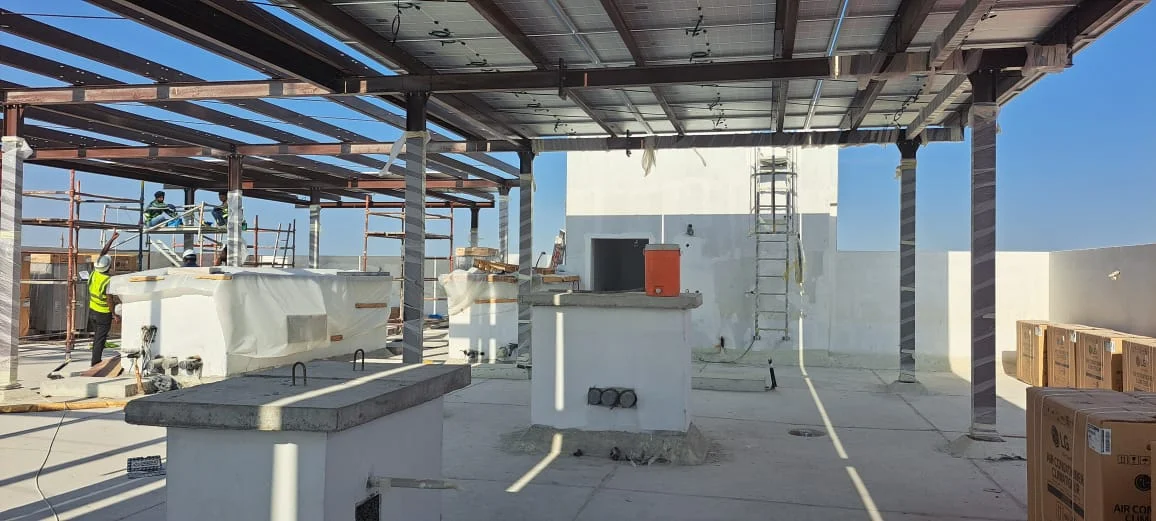

  • Erection of Steel Structure Works for Solar in Progress
  • MEP 2nd Fix Works in Progress
Façade:
  • External Painting for Façade (1st Floor to Roof Floor) in Progress
  • Ground Floor Aluminium Screens / Louvers in Progress

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

58.32%

Stage

Pump Room:
  • Staircase Surface Epoxy Completed
  • Primer in Progress
  • Stucco in Progress
  • MEP 3rd Fix in Progress
Ground Floor:
  • 90% of Ceiling & Corridor Plaster Completed
  • Service Room MEP Works in Progress
  • Installation of Generator in Progress
LV Room:

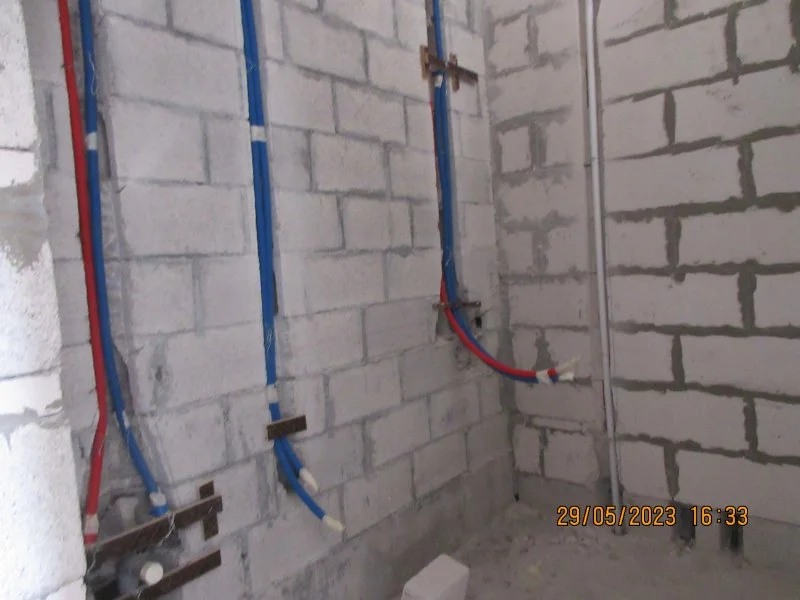

  • MEP 2nd Fix Works in Progress
1st Floor:
  • Wall & Ceiling Painting in Progress
  • Balcony Upstand in Progress
  • False Ceiling Works in Progress
  • 100% Erection of Steel Structure for Gym Completed

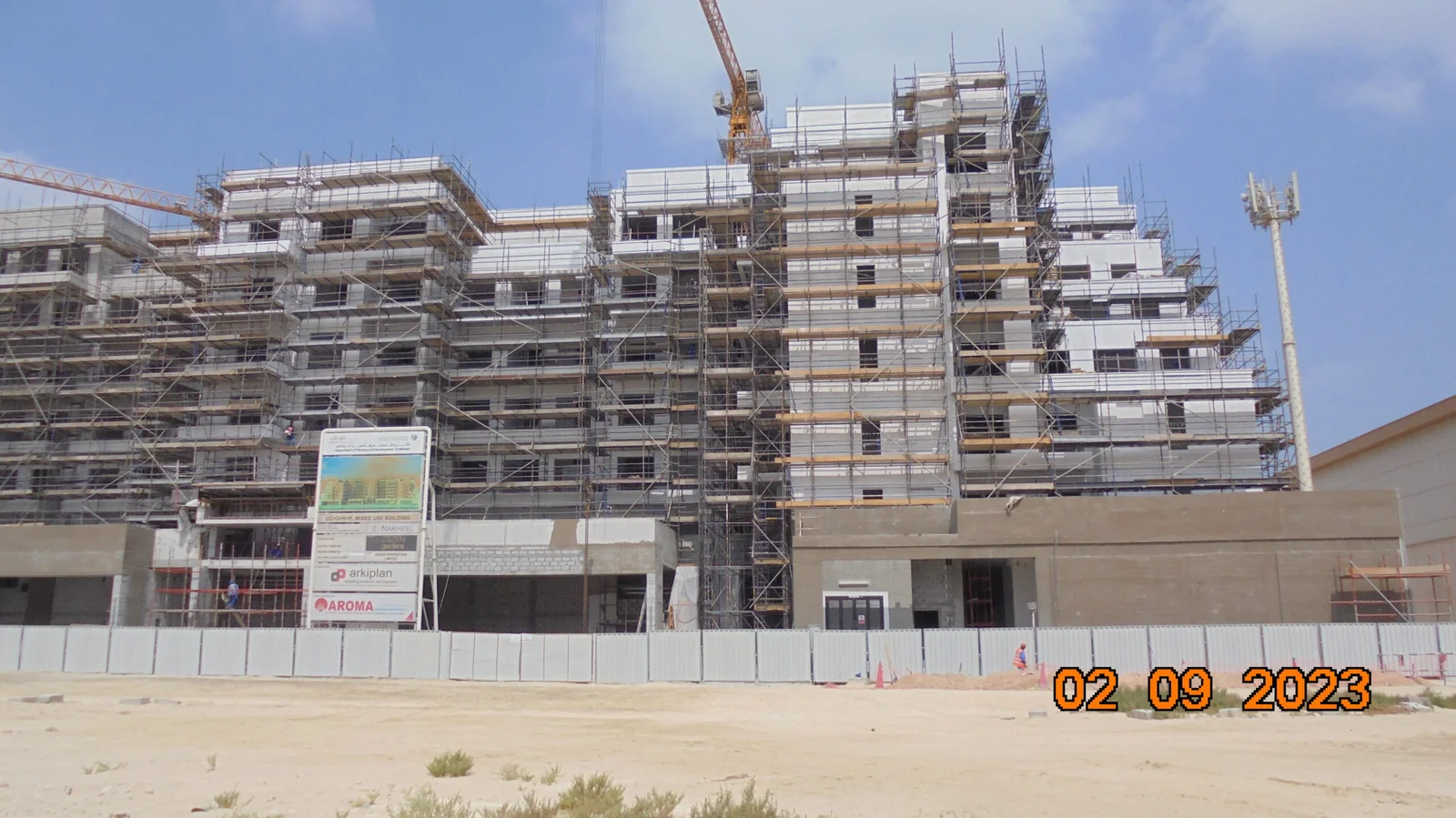

  • 60% of Block Works at Gym & Lounge in Progress
  • Aluminium & Glazing Works in Progress
2nd Floor:
  • Wall & Ceiling Painting in Progress
  • Balcony Upstand in Progress
  • False Ceiling Works in Progress
  • Kitchen Cabinet Works in Progress
3rd & 4th Floor:
  • MEP 2nd Fix for Apartments Completed
  • False Ceiling Works in Progress
  • MEP 3rd Fix Completed

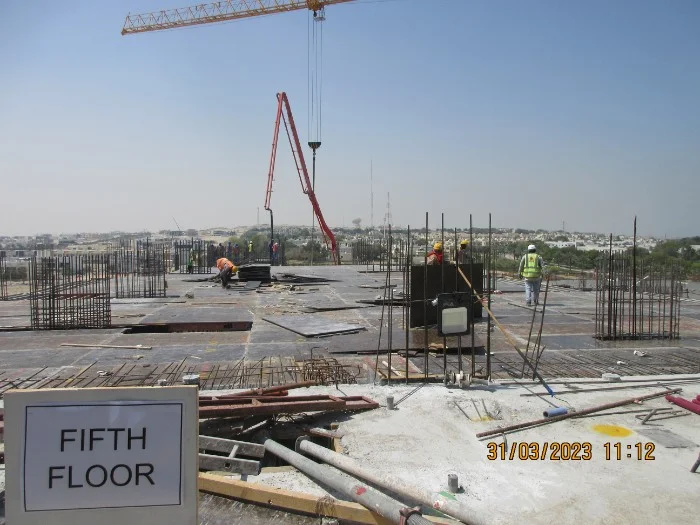

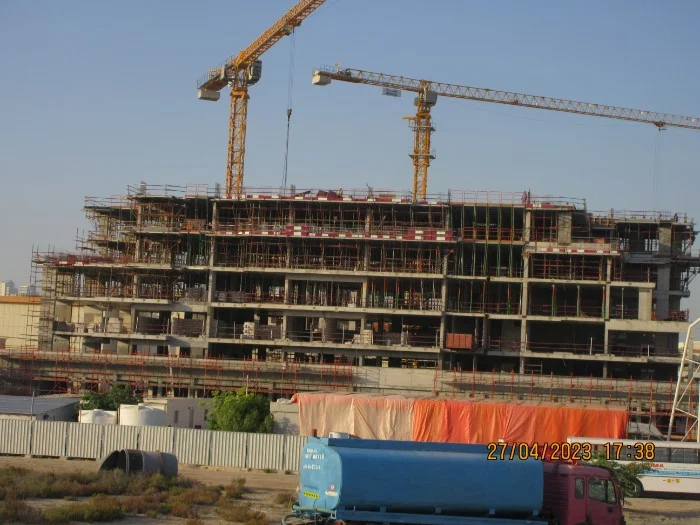

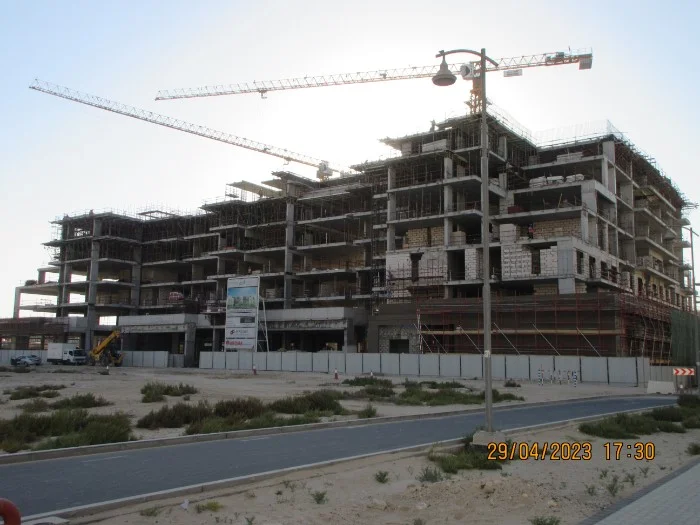

5th Floor:
  • 100% of Internal Plastering Completed
  • 100% of Corridor Plastering Completed
  • MEP 2nd Fix in Progress
  • False Ceiling Under Progress
6th Floor:
  • 100% of Plastering Works Completed
  • Tiling Works in Dry Area in Progress
  • Tiling Works in Wet Area in Progress
  • 100% of Corridor Plaster Completed
Façade:
  • External Plaster Ground Floor to 1st Floor Completed
  • Façade Plaster Completed
  • Ground Floor Aluminium Screens / Louvers in Progress

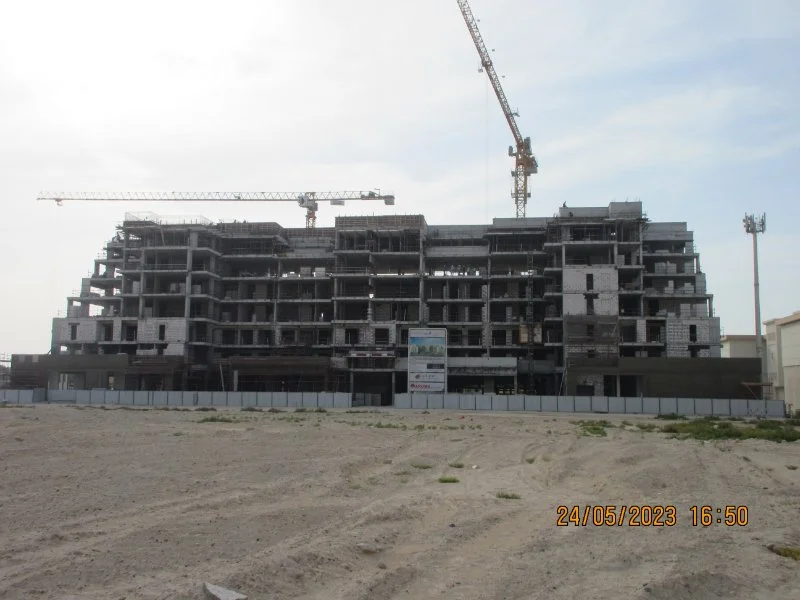

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

52.23%

Stage

Pump Room:
  • Installation of Equipment in Progress
Ground Floor:
  • 99% of Block Work Completed

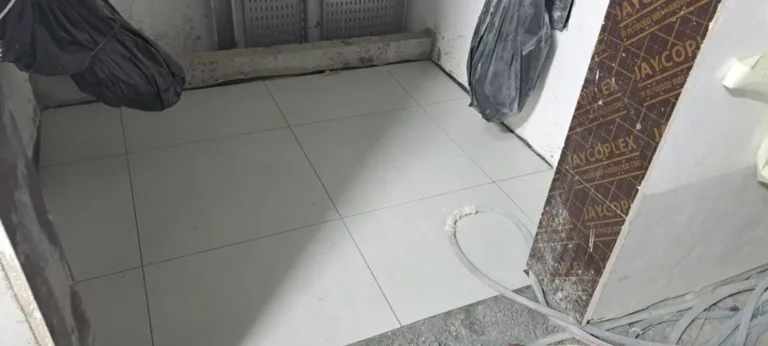

  • 70% of Tiling Work Completed
  • MEP 2nd Fix Under Progress
Substation:
  • DEWA Authority approval obtained
1st Floor:
  • MEP 2nd Fix for Apartments Under Progress
  • Installation of Sanitary Ware in Progress
2nd Floor:
  • MEP 2nd Fix for Apartments Under Progress
  • Balcony Tiling in Progress
3rd & 4th Floor:
  • MEP 2nd Fix for Apartments Under Progress
  • Plastering Works Completed
5th Floor:
  • 90% of Plastering Completed
  • Wall & Ceiling Painting Completed
  • Balcony Plaster Completed
6th Floor:
  • Block Work Completed
  • 30% of Ceiling Preparation Completed
  • MEP 1st Fix Completed
Façade:
  • External Plaster & Painting for Façade in Progress

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

47.50%

Stage

Pump Room:
  • Foundation Completed
  • Installation of Equipment in Progress
Ground Floor:
  • 90% of Block Work Completed
  • 80% of Ceiling Painting/Plaster Completed
Substation:
  • Work Completed
  • DEWA Authority Inspection for Substation applied
1st Floor:
  • Plastering Completed
  • Wall & Ceiling Painting in Progress
  • Tiling Works in Progress
  • False Ceiling Work in Progress
  • Upstand for Balconies & Partition Works in Progress
3rd & 4th Floor:
  • Plastering in Progress
  • Wall & Ceiling Painting in Progress
  • Tiling in Wet Area in Progress
  • Upstand Works in Progress
  • MEP 2nd Fix Works in Progress
5th Floor:
  • Plastering in Progress
  • Wall & Ceiling Painting in Progress
  • MEP 2nd Fix Works in Progress
6th Floor:
  • MEP 1st Fix in Progress
  • MEP 2nd Fix in Progress
Façade:
  • External Plaster Ground Floor to 1st Floor Completed
  • External Plaster for Façade in Progress

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

41.49%

Stage

Ground Floor:
  • Plant Room Plastering Completed
  • MEP 2nd Fix in Progress (Electrical, Plumbing, Fire Fighting and HVAC)
Substation:
  • Plaster Preparation Completed
  • Painting in Progress
1st Floor:
  • Block Work & MEP 1st Fix Works Completed
  • Plastering & MEP 2nd Fix Works in Progress
2nd Floor:
  • Plastering in Progress
  • MEP 1st Fix Works in Progress
3rd & 4th Floor:

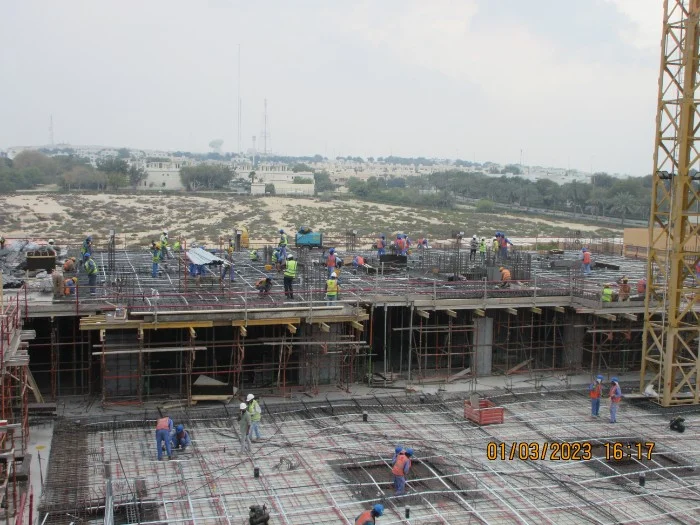

  • Block Work Completed
  • MEP 1st Fix Works in Progress
5th Floor:
  • 75% of Block Work Completed
6th Floor:
  • 60% of Block Work Completed
Roof Floor:
  • De-Shuttering of Roof at Pour 02 Completed

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

38.25%

Stage

Ground Floor:
  • Block Work and Ceiling Painting/Plaster in Progress
  • MEP 1st Fix Completed, 2nd Fix in Progress
Substation:
  • Block Work Completed
  • MEP 1st Fix Works Completed
1st Floor:
  • 95% of Block Work Completed
  • MEP 1st & 2nd Fix Works in Progress
2nd Floor:
  • 97% of Block Work Completed
  • MEP 1st Fix Works Under Progress
3rd & 4th Floor:
  • 75% of Block Work Completed
5th Floor:
  • De-Shuttering of 5th Floor, Pour 01 & 02 Completed
  • 20% of Block Work Completed
6th Floor:
  • Casting of 6th Floor Slab Pour 01 & 02 Completed
  • 15% of Block Work Completed
Roof Floor:
  • Casting of Slab 02 Completed
  • 15% of Block Work Completed
  • De-Shuttering in Progress
Swimming Pool:
  • Structural Works Completed
  • Plaster for Swimming Pool Completed
Facade:
  • External Plaster from Ground to 1st Floor Completed

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

31.35%

Stage

Ground Floor:
  • Plaster Preparation and Plaster for Lobby and Staircase Completed
  • Block Work, Ceiling Painting and Plaster Works in Progress
Substation:
  • Casting of Trench Completed
  • Block Work in Progress
1st Floor:
  • De-Shuttering of 1st Floor Slab at Pour 03 Completed
1st to 3rd Floor:
  • Block Work in Progress
4th Floor:
  • Casting of 4th Floor Slab Pour 02 Completed
  • Block Work in Progress
  • De-Shuttering of 4th Floor Slab Pour 01 & 02 Completed
5th Floor:
  • Casting and Vertical Works at 5th Floor Slab Pour 02 Completed
6th Floor:

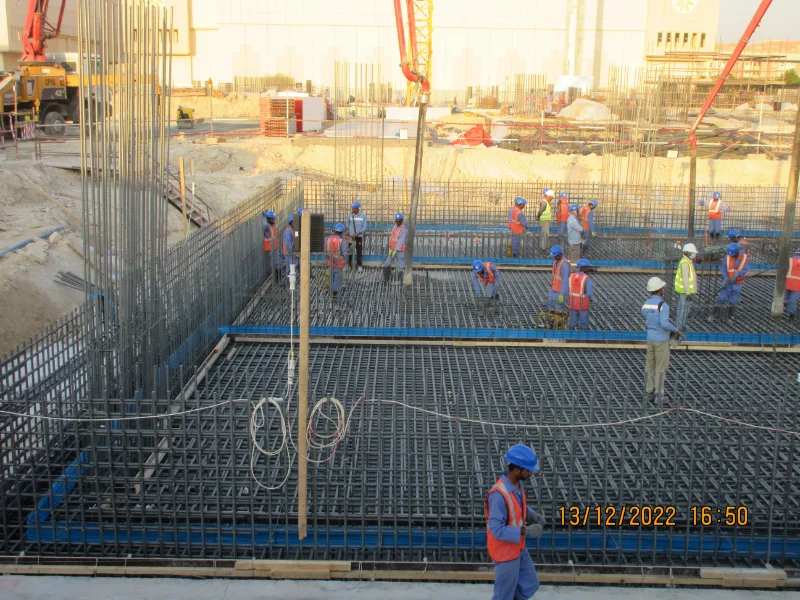

  • Casting of Verticals and Floor Slab at 6th Floor Pour 01 & 02 Completed
Roof Floor:
  • Casting of Verticals and Floor Slab at Roof Pour 01 Completed

  • Pour 02 in Progress

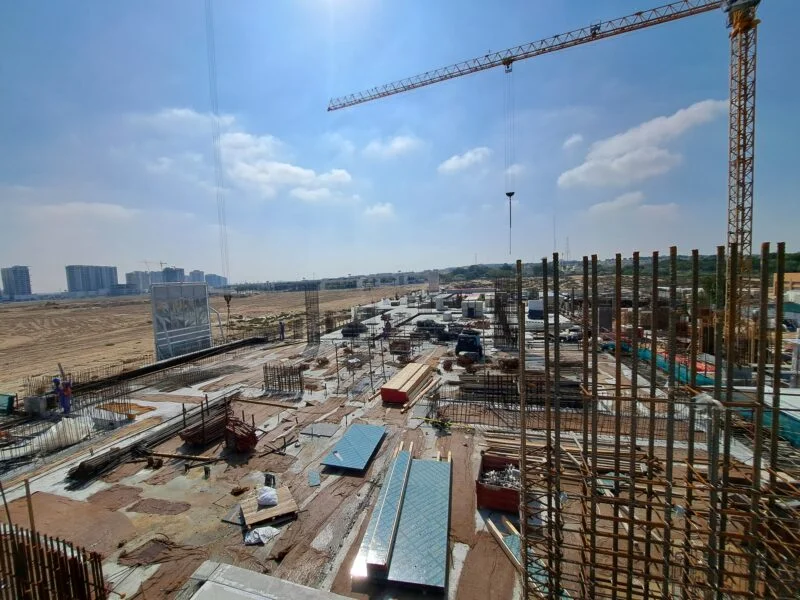

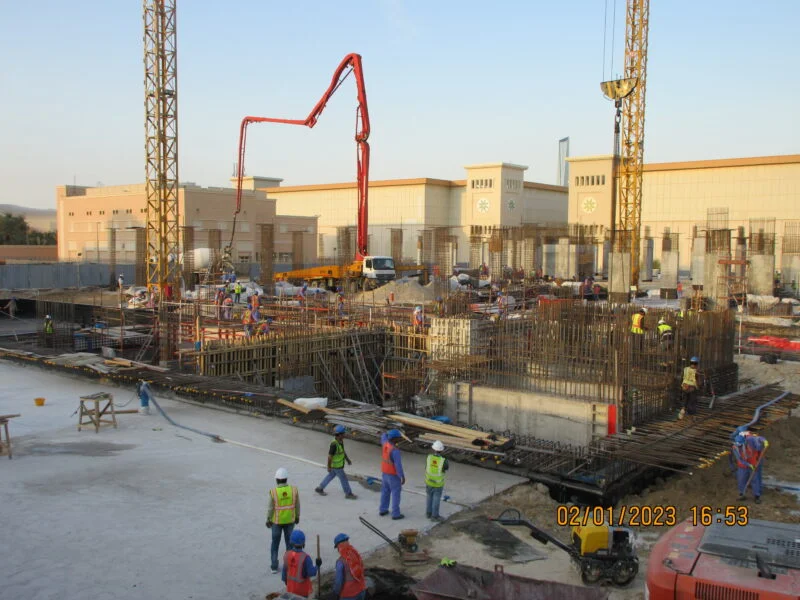

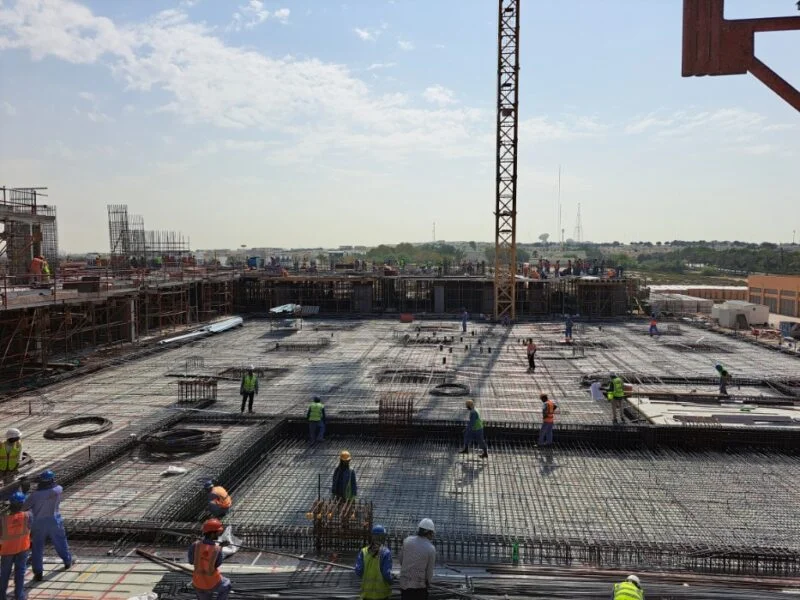

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

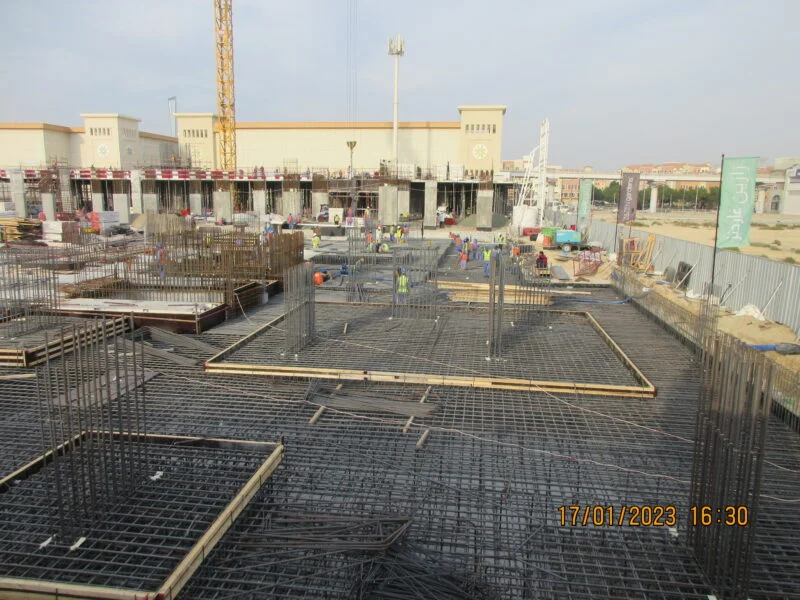

23.22%

Stage

Underground:

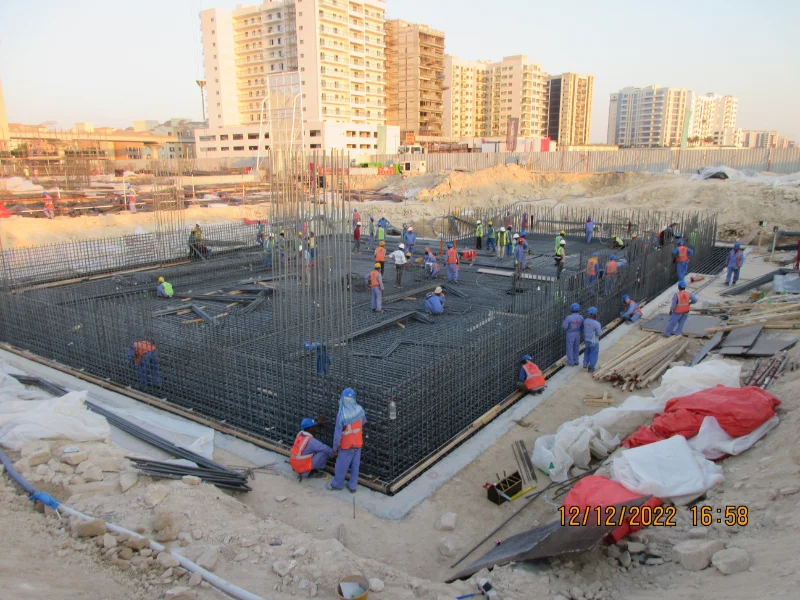

  • Tank Cleaning and Preparation of Tanks are in Progress
  • Pump Room Plaster Preparation Completed and MEP 1st Fix Works in Progress
1st Floor:
  • Casting of 1st Floor Slab Pour 03 Completed
  • De-Shuttering of 1st Floor Slab at Pour 01 & 02 Completed
  • Stressing & Patching for 1st Floor at Pour 01, 02 & 03 Completed
2nd Floor:
  • Casting and De-Shuttering of 2nd Floor Slab Pour 02 Completed
3rd Floor:
  • Casting and De-Shuttering of 3rd Floor Slab Pour 01 & 02 Completed
4th Floor:
  • Casting of 4th Floor Slab Pour 01 Completed. Pour 02 is Partially Completed
  • Stressing & Patching for 4th Floor at Pour 01 Completed and Pour 02 in Progress
5th Floor:
  • Casting of 5th Floor Slab Pour 01 Completed. Vertical Works at 5th Floor Pour 02 in Progress
6th Floor:
  • Casting of Verticals at 6th Floor Slab Pour 01 in Progress
  • Scaffolding & Shuttering Works at 6th Floor at Pour 01 in Progress

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

16.22%

Stage

Sub Structure:

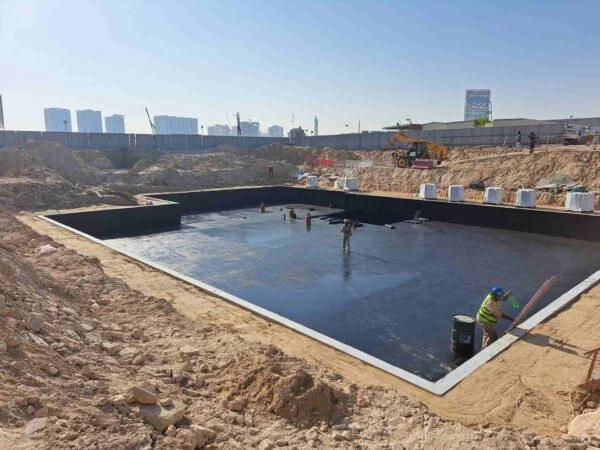

  • Water Proofing for Exposed Surface at Phase 03 Completed
  • Backfilling at Phase 03 Completed
1st Floor:
  • 100% of Stressing, Patching and Grouting for 1st Floor Slab at Pour 01 Area Completed
  • 100% of Authority Inspection and Casting of 1st Floor Slab Pour 02 Completed
  • 70% De-shuttering of 1st Floor Slab Pour 01 Area Completed
2nd Floor:
  • 100% Verticals (Columns & Core Walls) 1st to 2nd Floor at Pour 01 Area Completed
  • 100% of Authority Inspection and Casting of 2nd Floor Slab Pour 01 Completed
  • 75% Verticals (Columns & Core Walls) 1st to 2nd Floor at Pour 02 Area Completed
3rd Floor:
  • 100% of Scaffolding and Shuttering Works for 3rd Floor Slab Pour 01 Completed
  • 50% of Authority Inspection and Casting of 3rd Floor Slab Pour 01 Completed
  • 10% Verticals (Columns & Core Walls) 2nd to 3rd Floor at Pour 02 Area Completed

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

10.50%

Stage

  • 100% Vertical Columns & Core Walls at Pour Areas 1 to 3 Completed
  • 100% Reinforcement, PT Works, Inspection and Casting of Pour Area 1 Completed
  • De-watering at Water Tank & Pump Room in Phase 1 Area Completed
  • Reinforcement, Formwork and Casting of Water Tank Top Slab Completed
  • Backfilling at Phase 1 and 2 Area Completed
  • Levelling, Anti-termite, PCC and Water Proofing below Raft at Phase 4 Completed
  • Reinforcement, Formwork and Casting of Raft at Phase 4 Completed

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

7.50%

Stage

  • 100% of Reinforcement for Raft at Phase 2 Completed
  • 100% of Form Work/Periphery Block Works for Raft Completed
  • 100% of Casting of Raft at Phase 2 Completed
  • 100% of Floor Beams at Phase 2 Completed
  • 100% of Excavation Works at Phase 3 Completed
  • 100% of Reinforcement for Footings at Phase 3 Completed
  • 100% Water Proofing above PCC at Phase 2 Area Completed
  • 90% Verticals (Columns & Core Walls) at Phase 2 Completed

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

3.75%

Stage

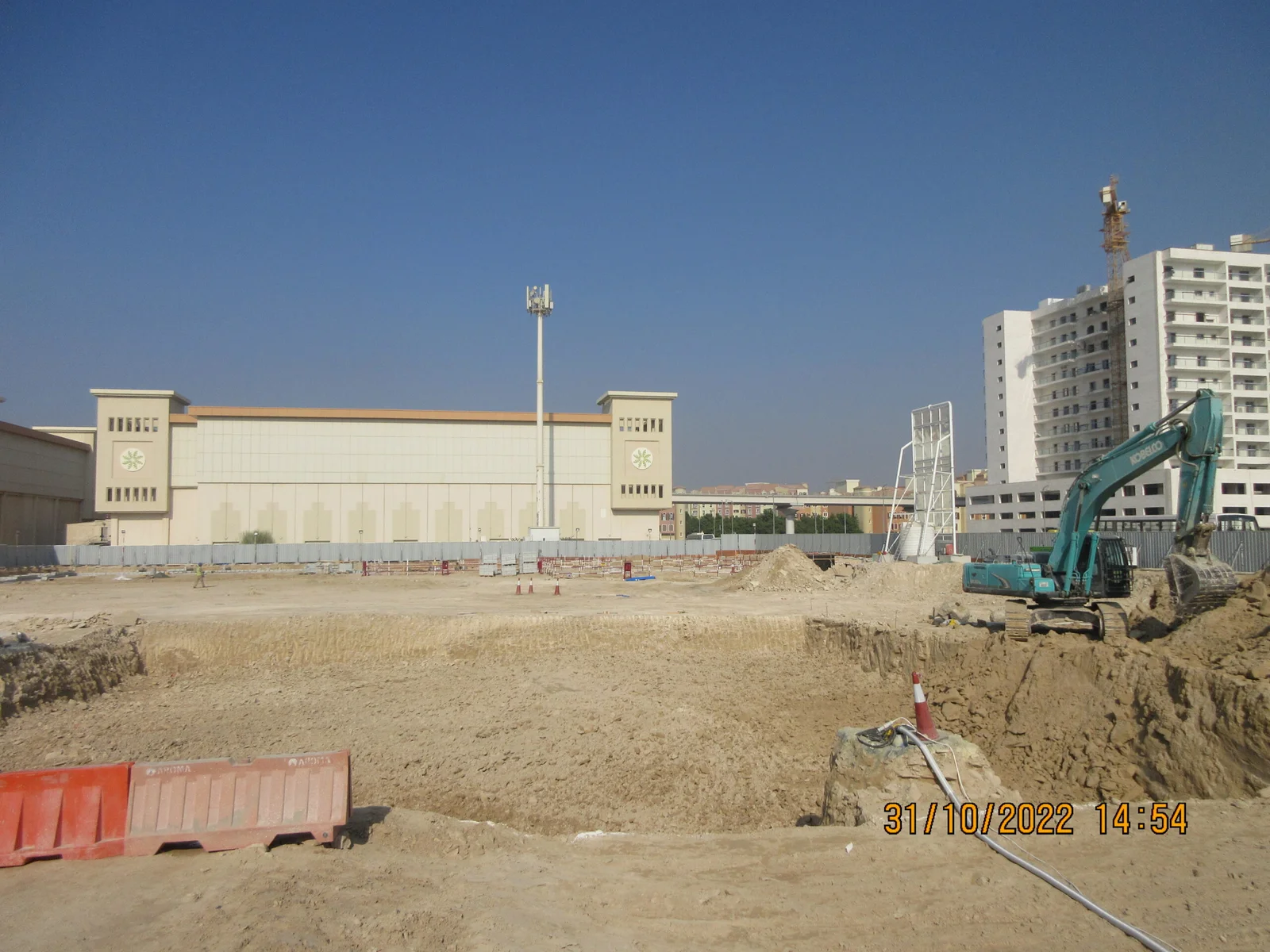

  • Mobilization Completed
  • Excavation Works for Water Tank & Pump Room Area (Phase-1A) Completed
  • Installation of De-Watering System at Water Tank Completed
  • 100% of Excavation Works at Phase 2 Area Completed
  • 100% of Levelling and Compaction at Phase 2 Area Completed

  • 100% of Antitermite and PCC at Phase 2 Area Completed

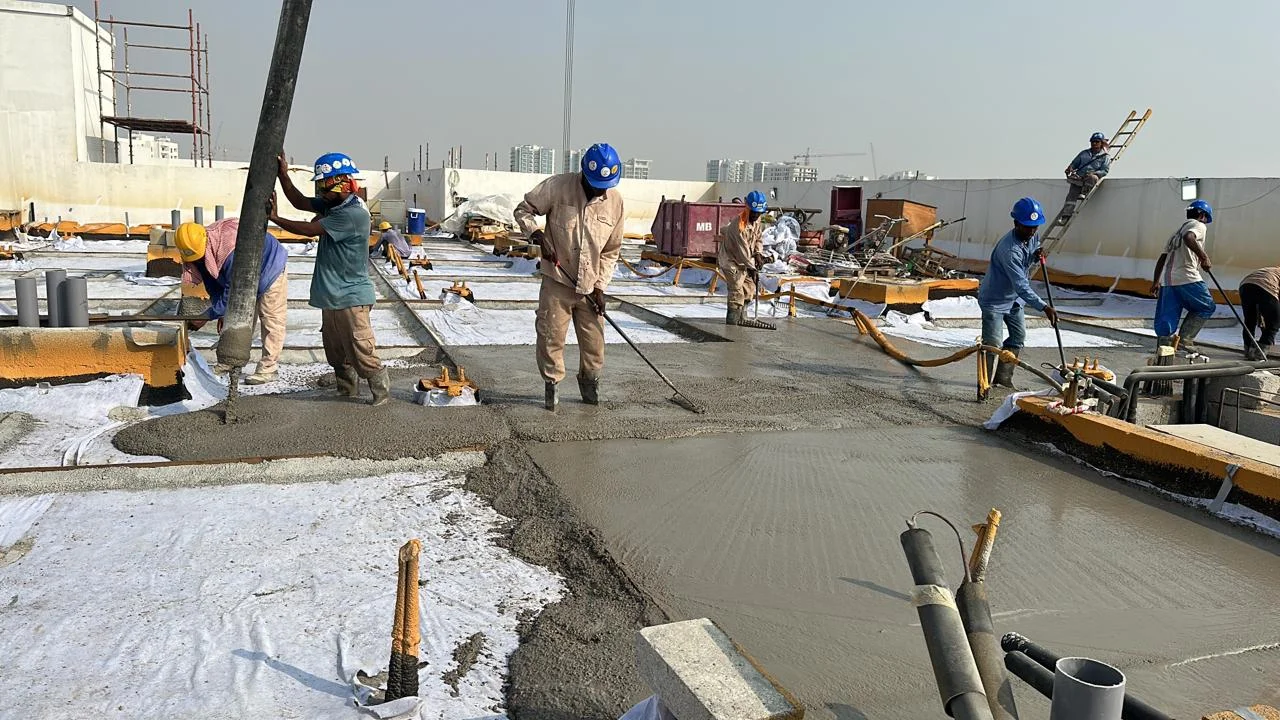

  • 100% Water Proofing above PCC at Phase 2 Area Completed

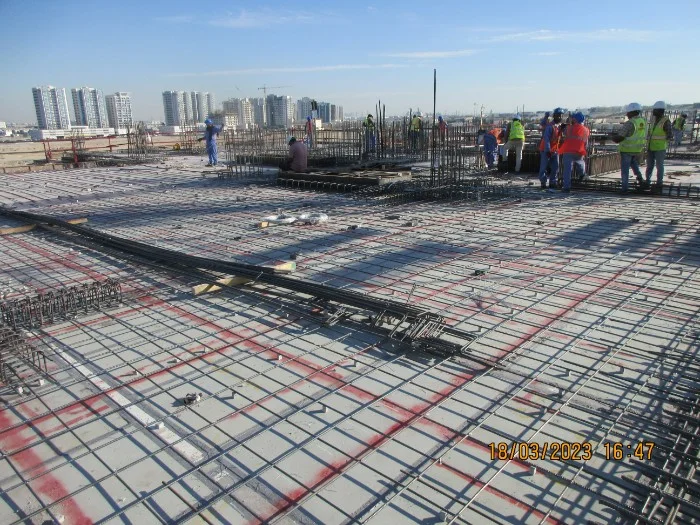

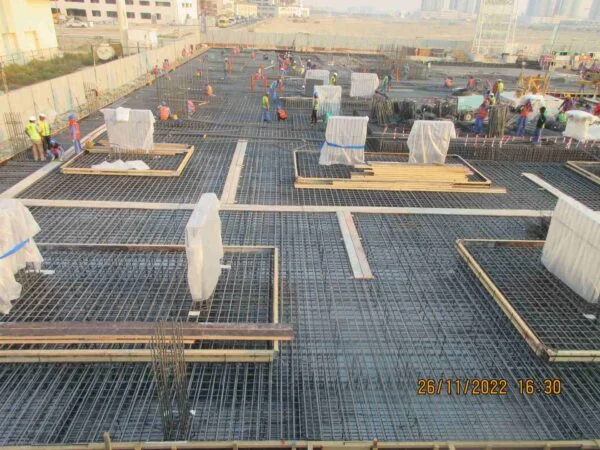

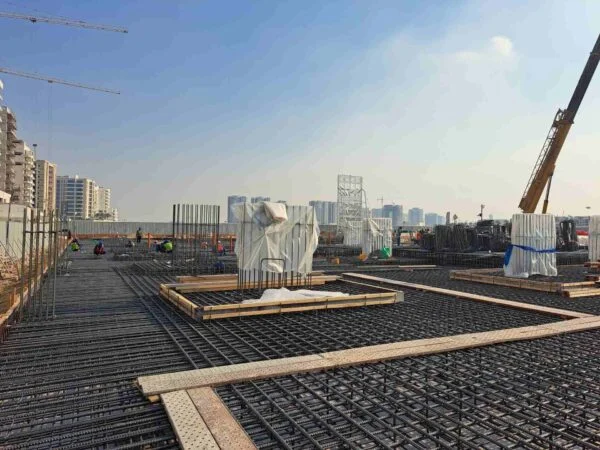

  • 40% of Reinforcement for Raft at Phase 2 / Pour No.01 Completed

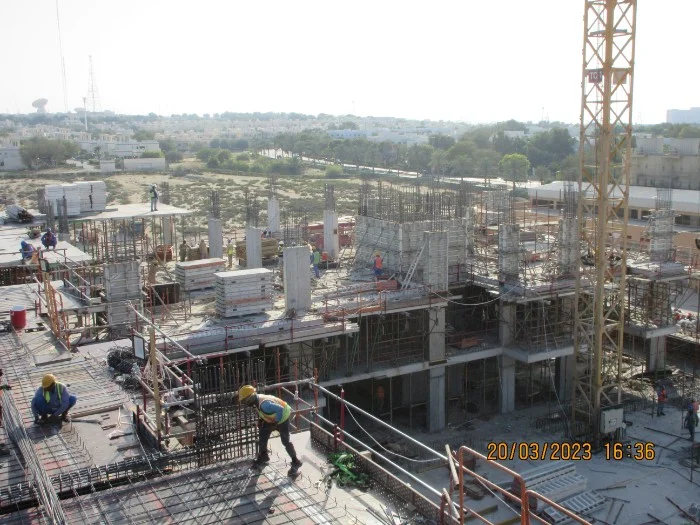

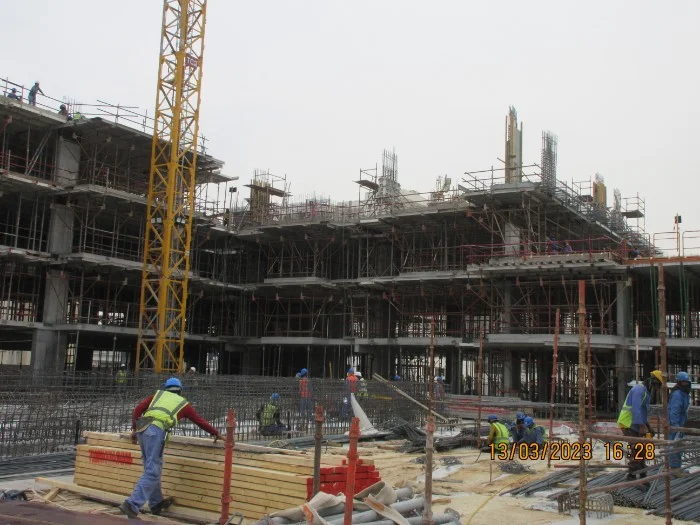

  • 20% of Form Work/Periphery Block Works for Raft Completed

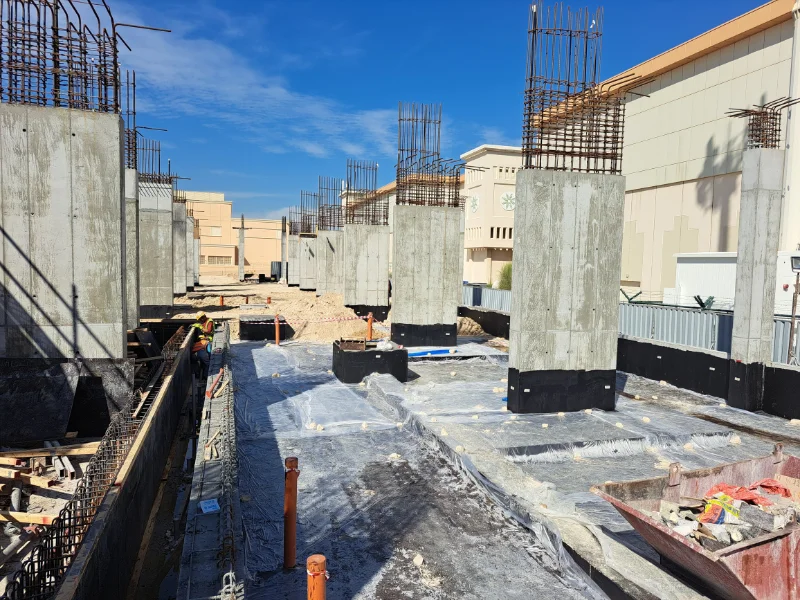

  • 60% of Excavation Works at Phase 03 & 04 Area Completed

Launched

10th October 2022

Planned Handover

30th April 2024

Progress

1.01%

Stage

  • 30% of Excavation Works for Water Tank & Pump Room Area (Phase-1A) Completed
  • 80% of Excavation Works for Lift Pit Area (Phase-1B) Completed

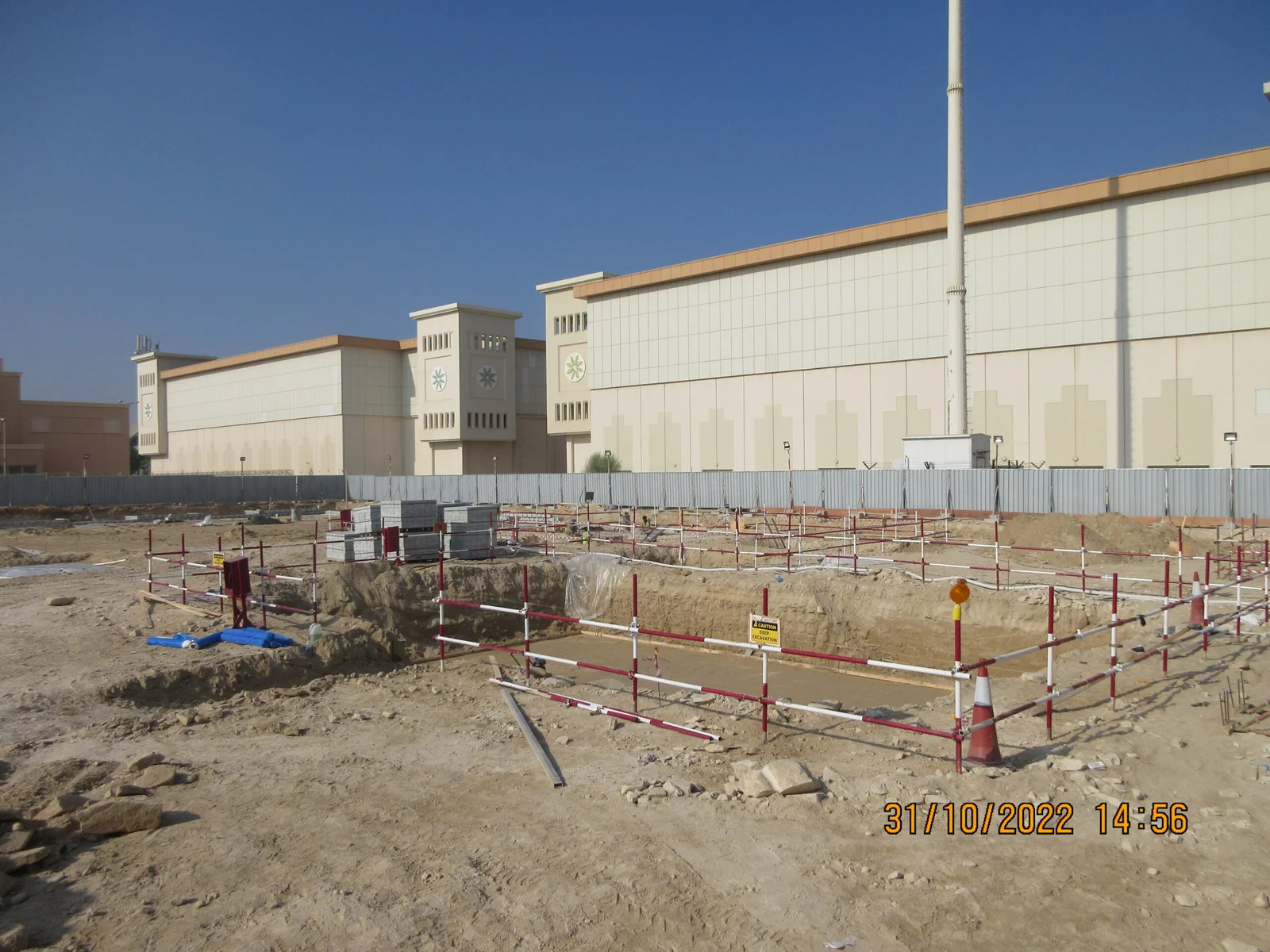

  • 30% of Excavation Works at Phase 2 Area Completed

Launched

10th October 2022

Planned Handover

30th April 2024
