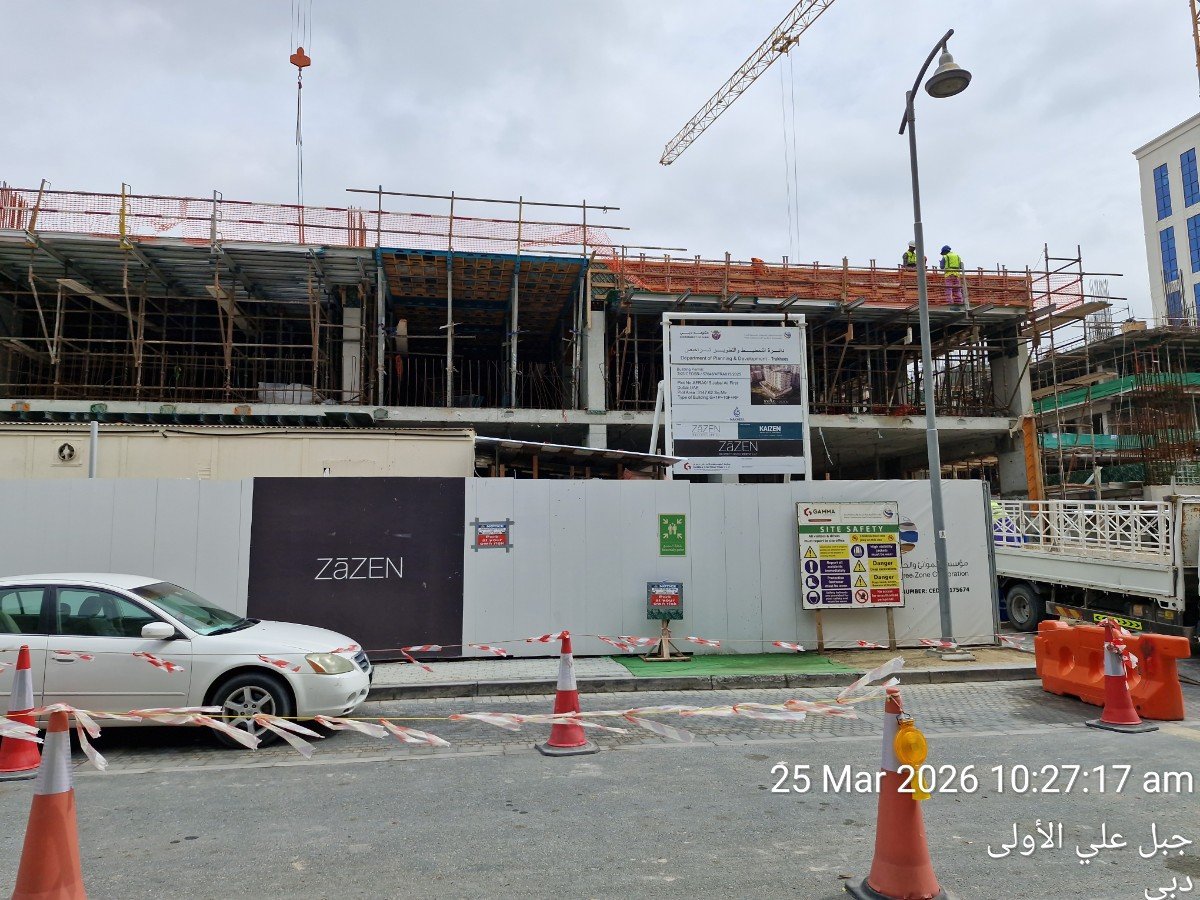

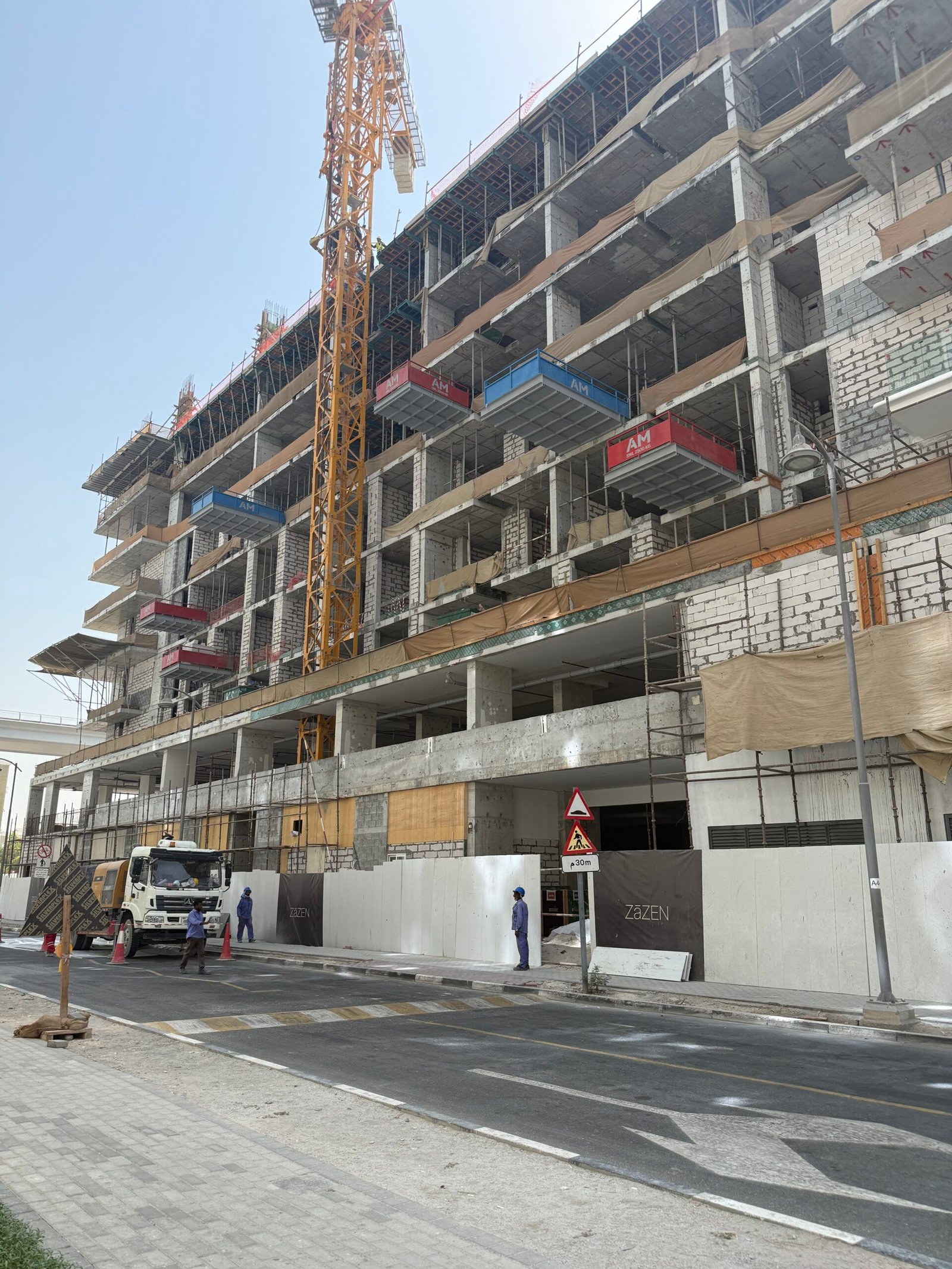

The Hub Residences By Zazen Construction Update

14.50% Complete

The Hub Residences by ZāZEN

CONSTRUCTION UPDATES
Start Date

JUL 2025

Completion Date

MAR 2027

Al Furjan

It is currently under construction and is planned for completion in March 2027 . This project is registered under RERA project number 3419.

9.50% Complete
CONSTRUCTION UPDATES Start Date

Nov 2024

Completion Date

Jan 2027

The Hub Residences by ZāZEN

Al Furjan

It is currently under construction and is planned for completion in January 2027 . This project is registered under RERA project number 3419.

VIEW PROJECT

TIMELINE

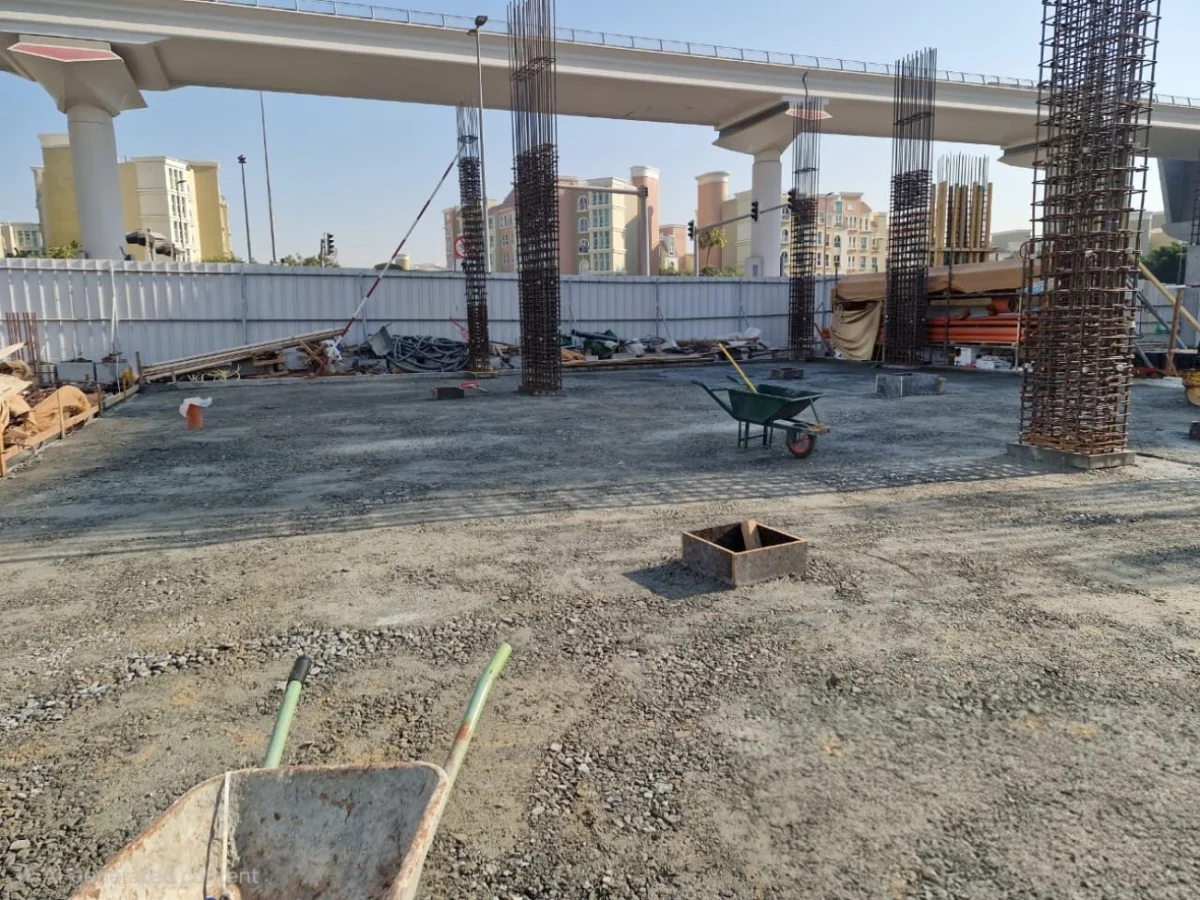

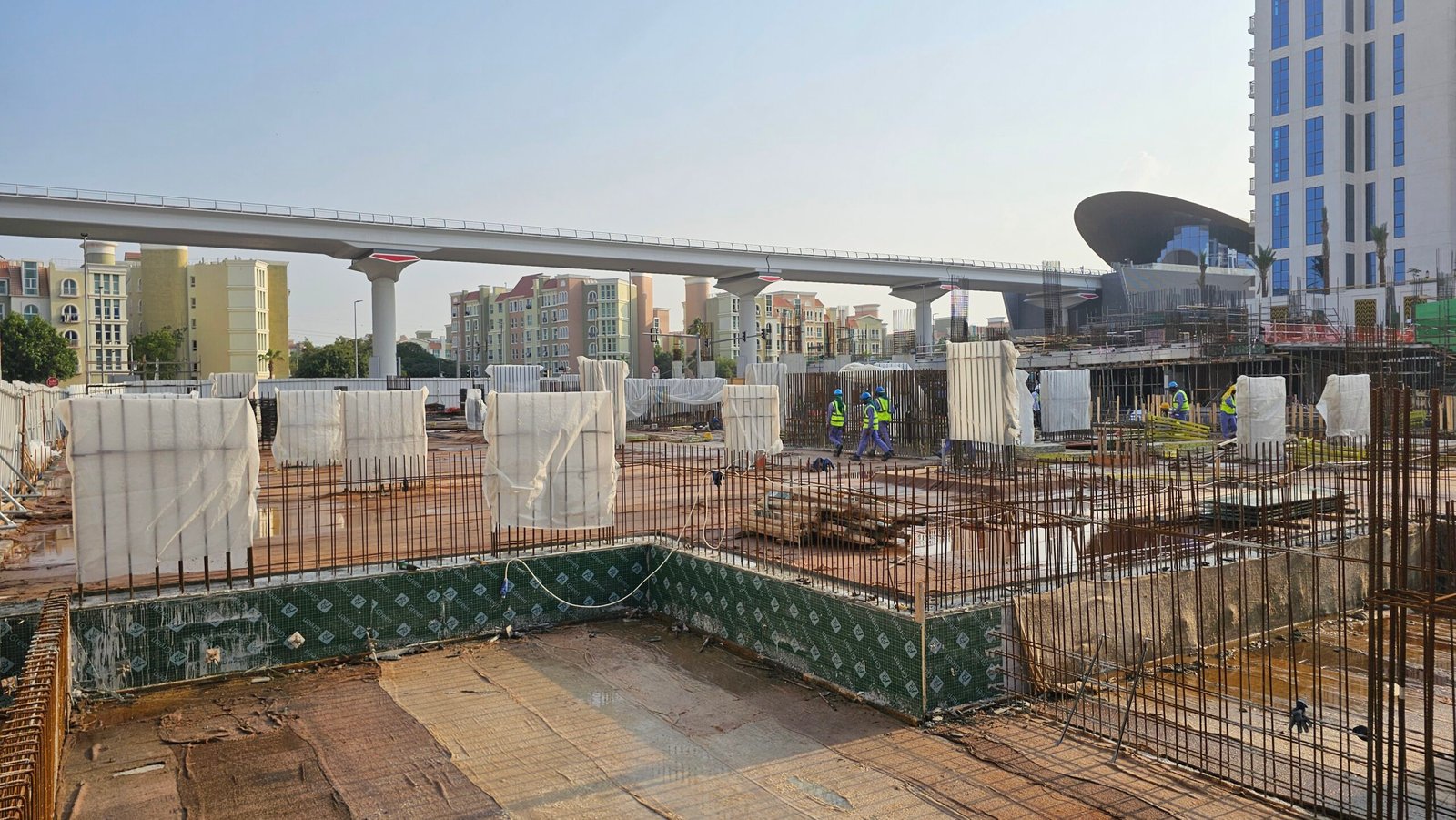

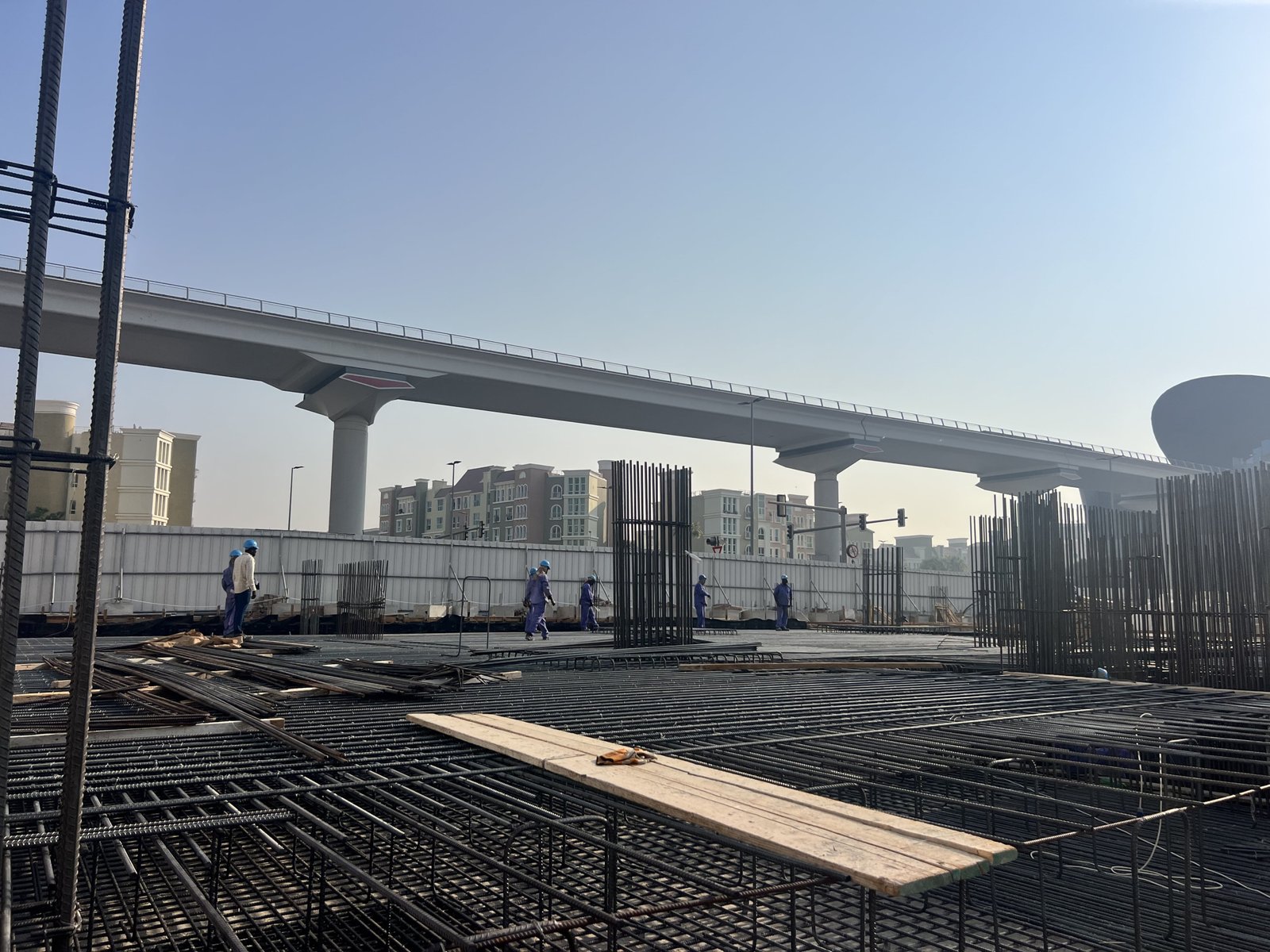

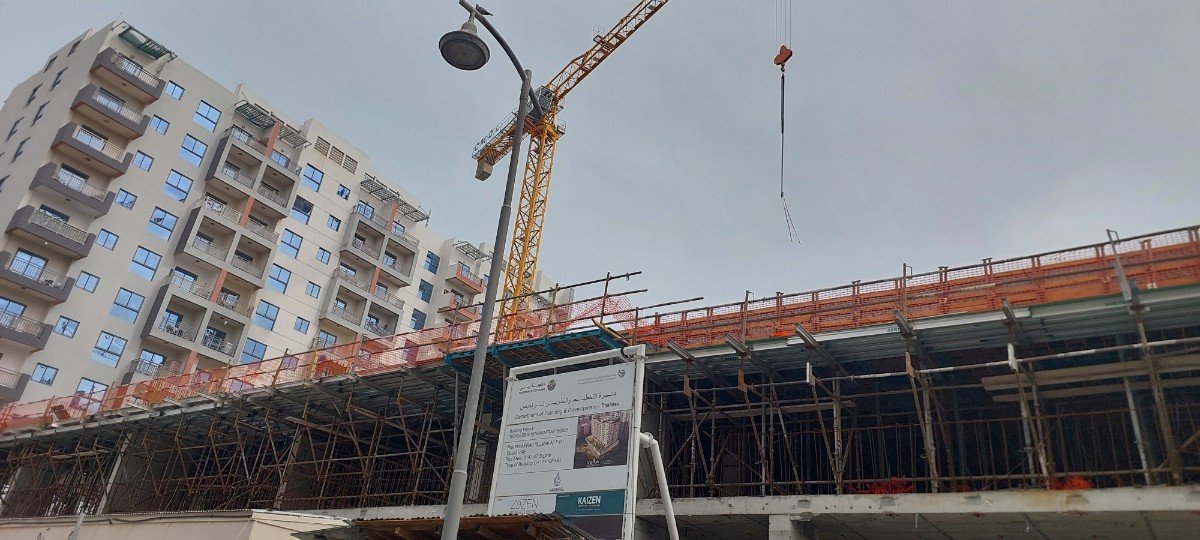

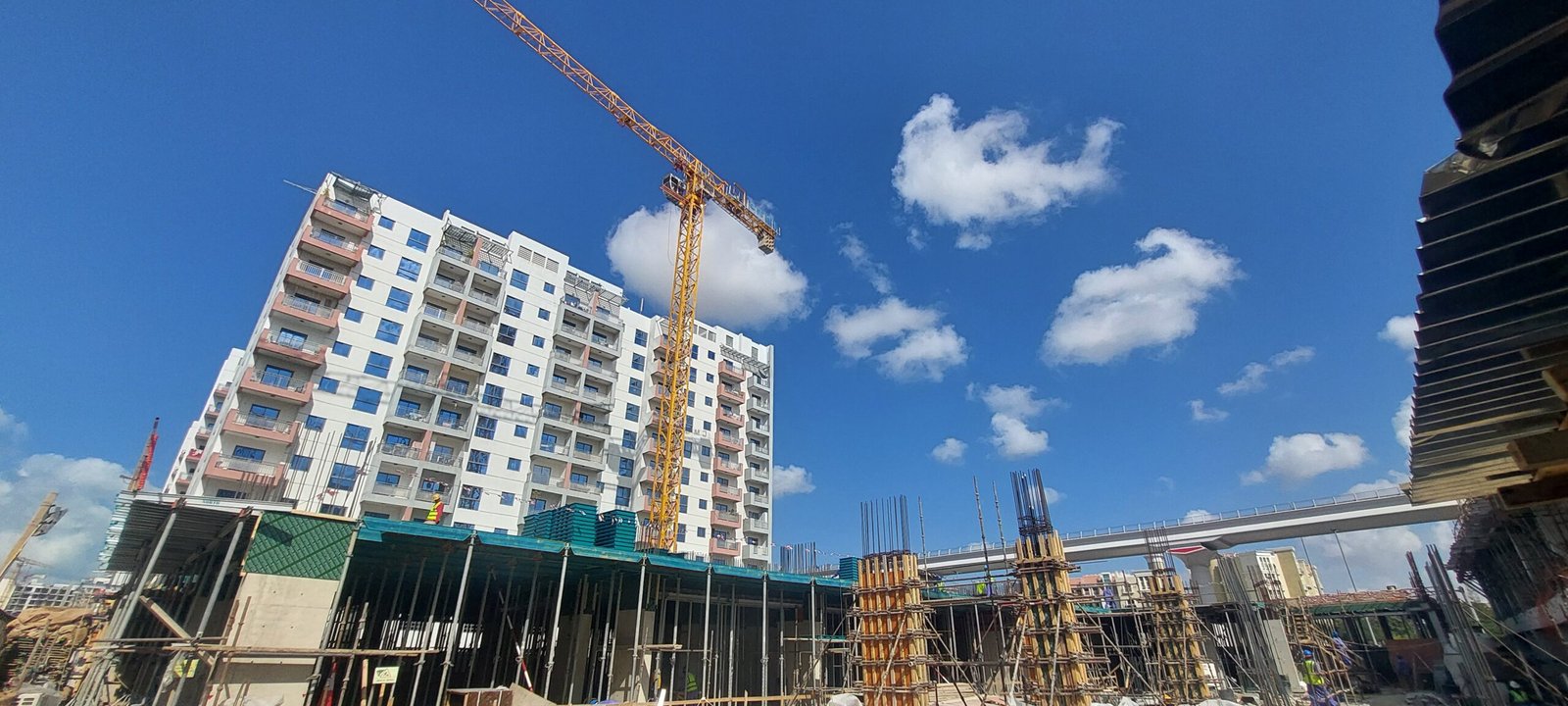

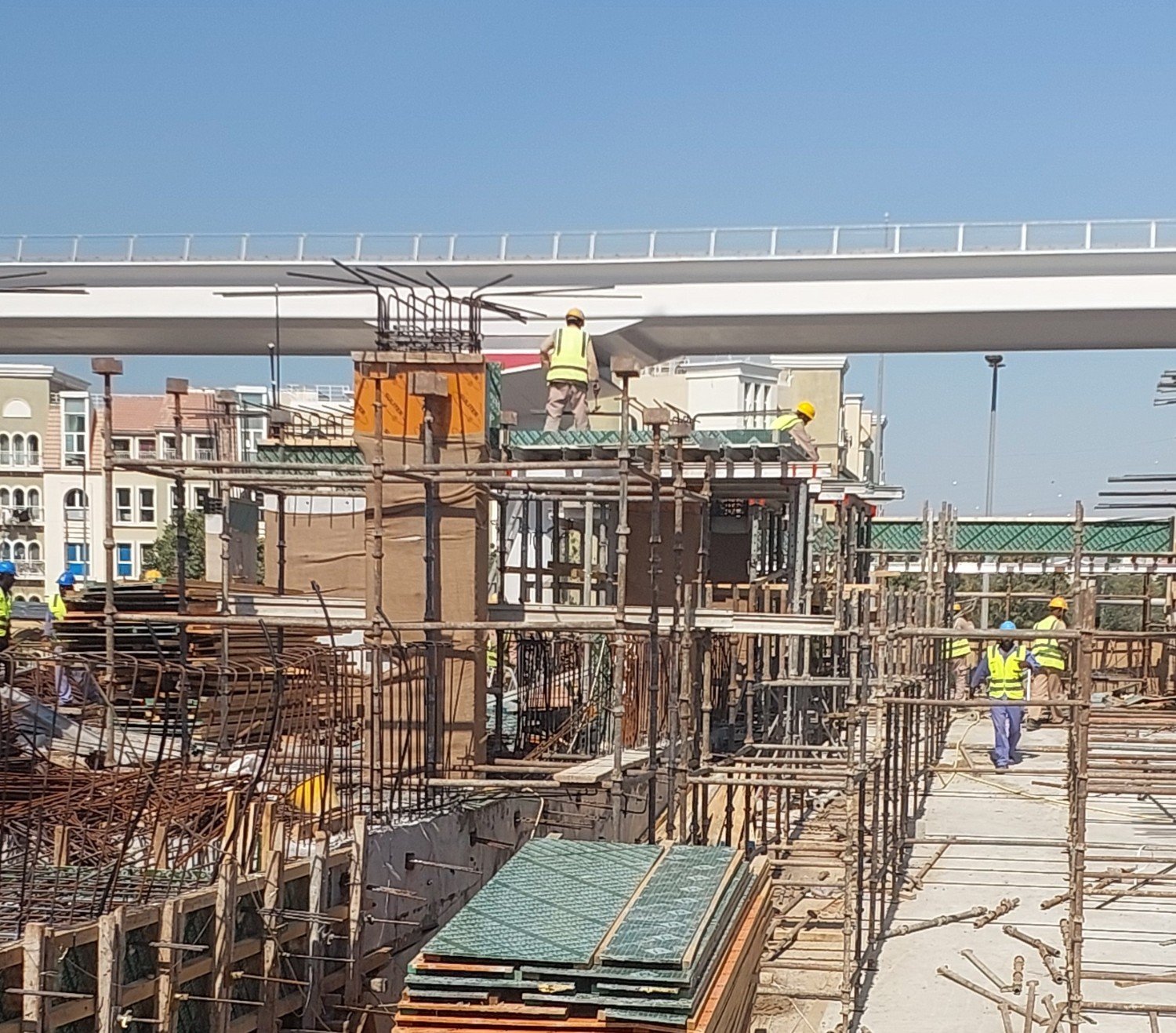

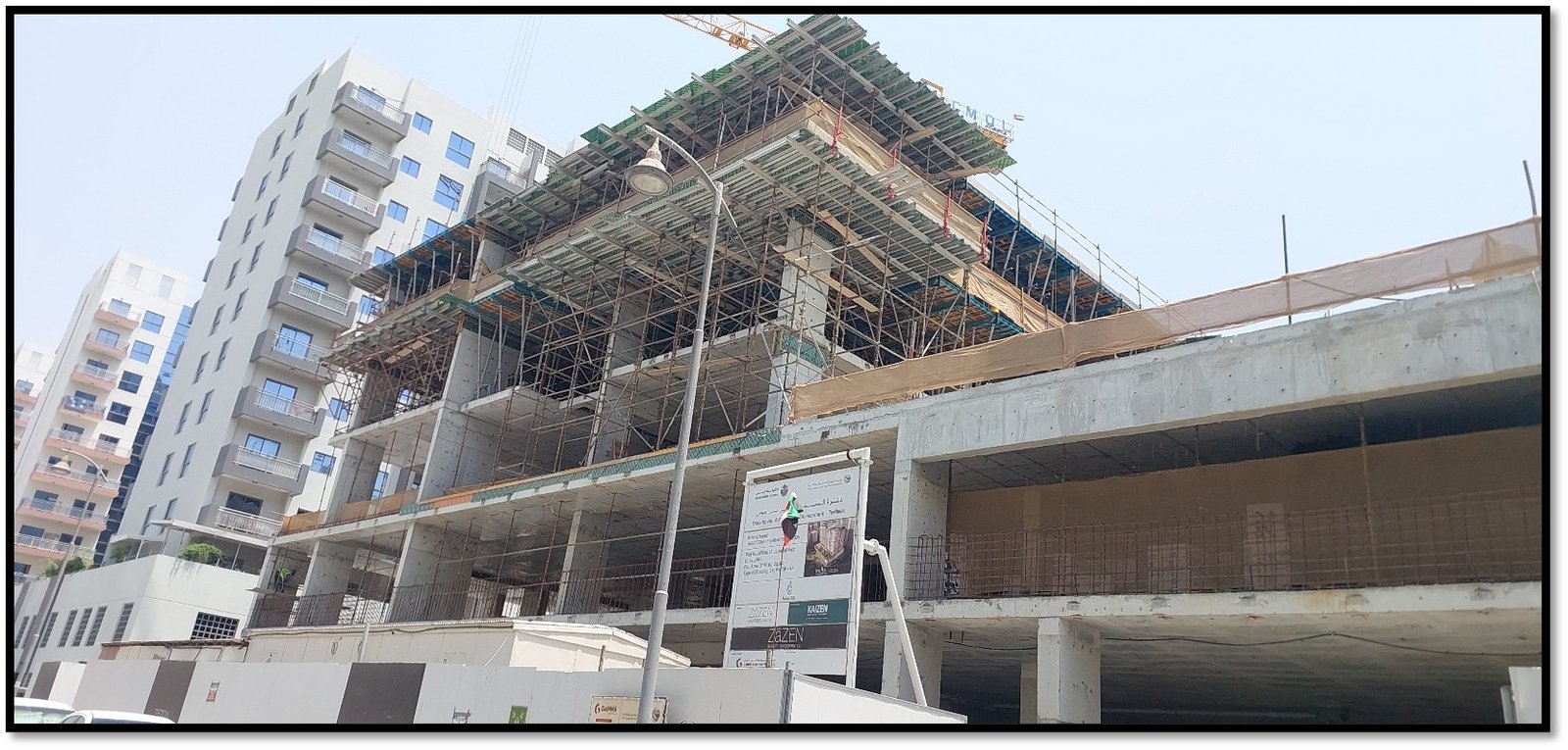

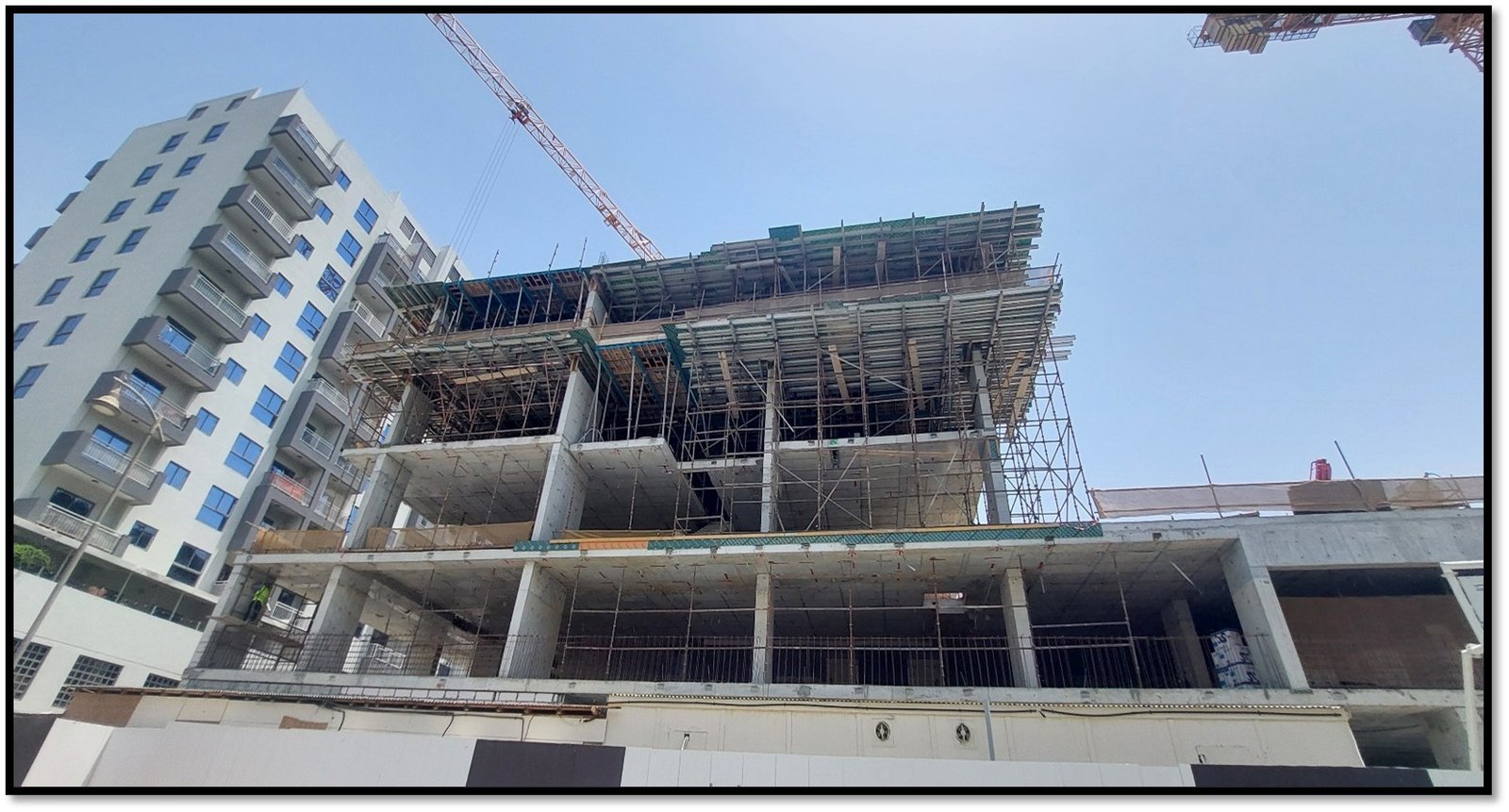

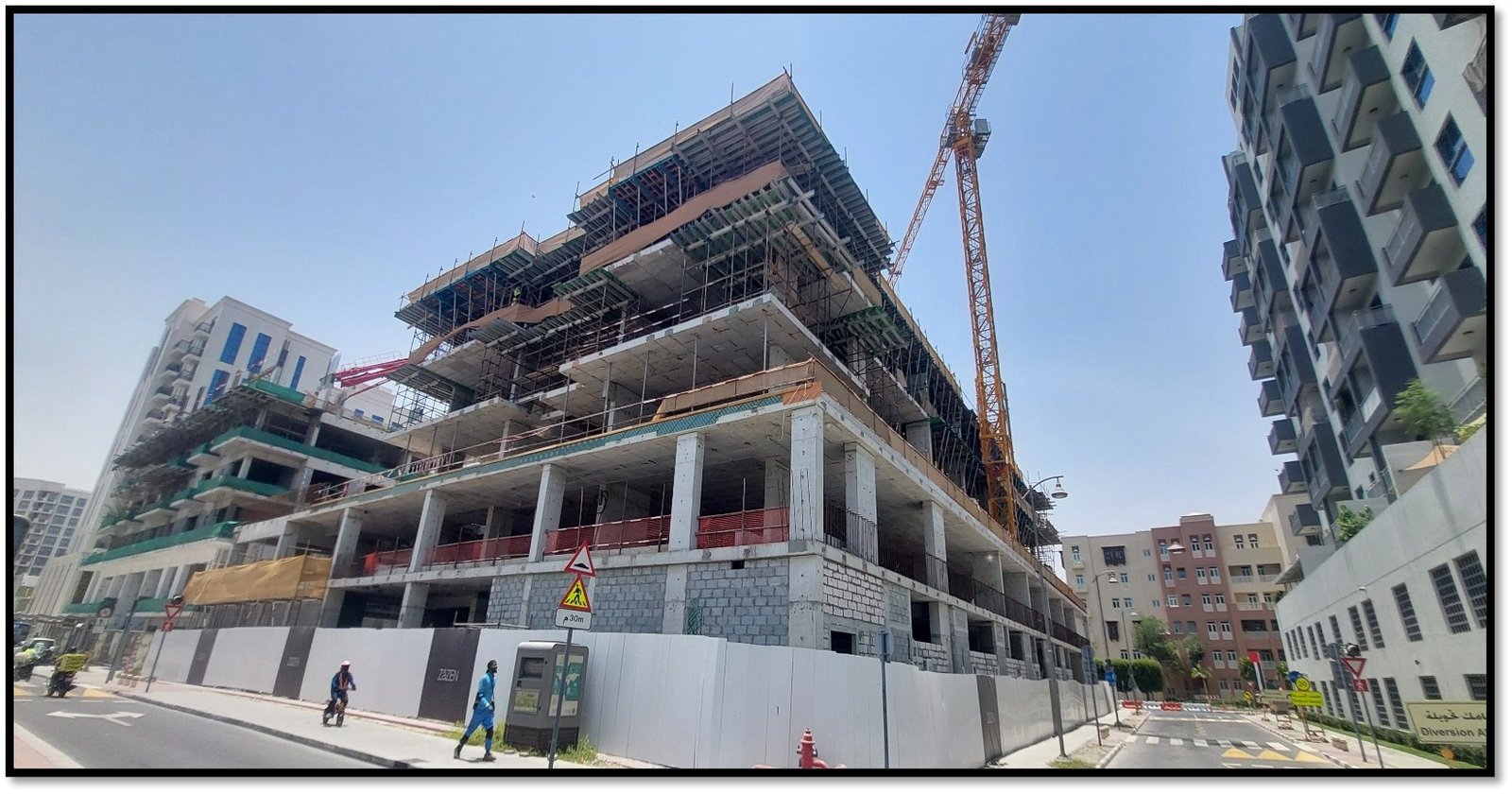

The Hub Residences – CONSTRUCTION UPDATE

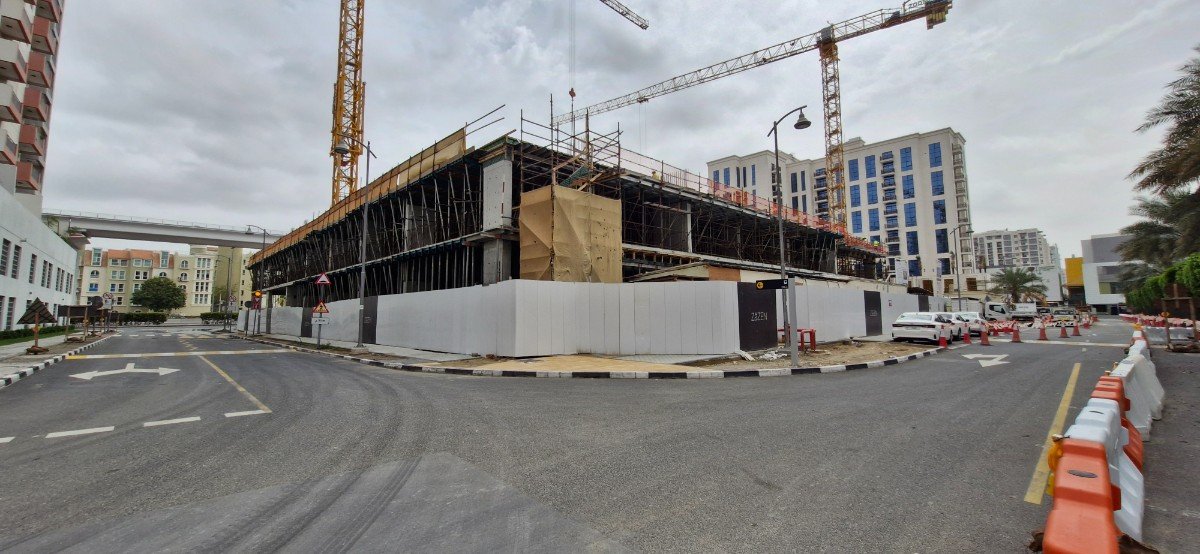

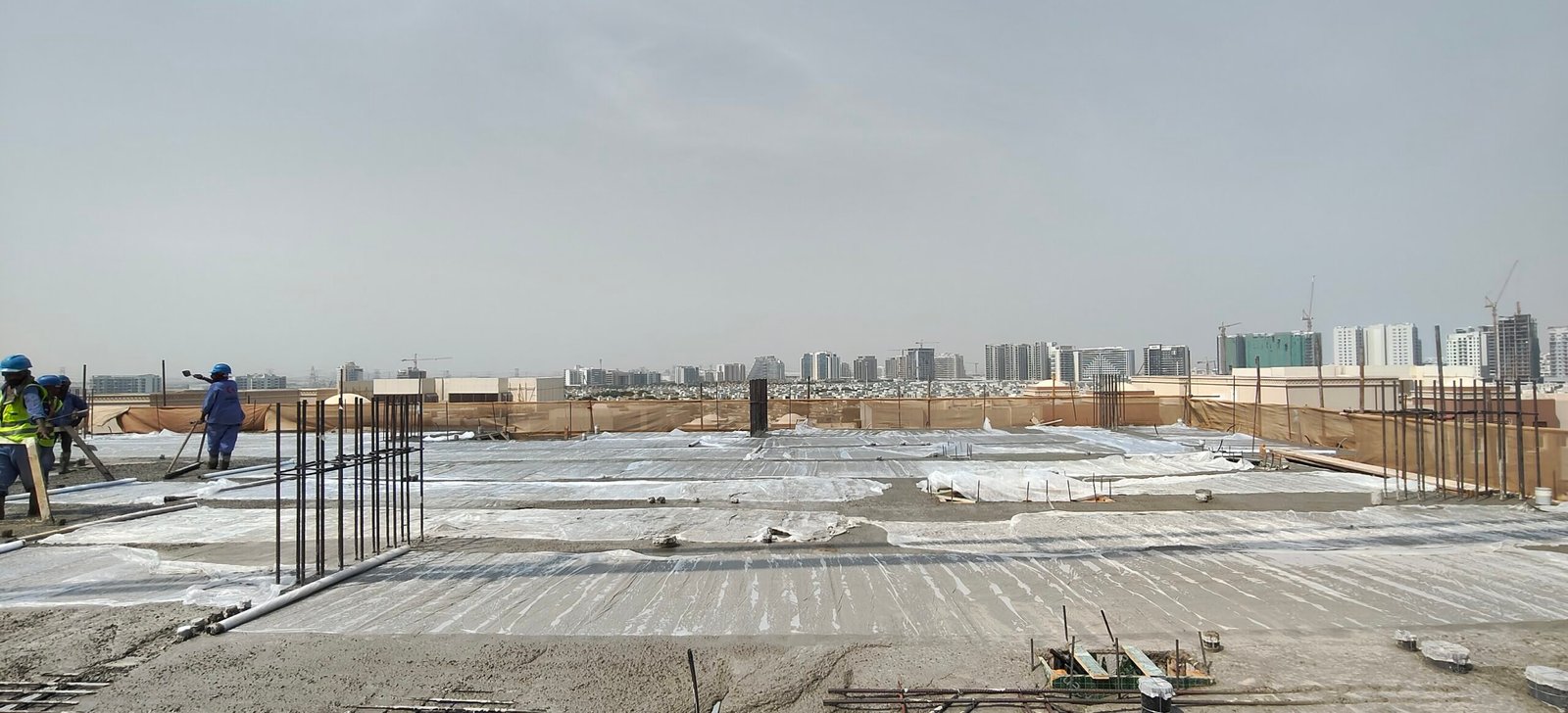

Progress

14.75%

Stage

Dewatering Works
  • Dewatering – Under progress
Roadbase & Compaction Works
  • Isolated footing – 90% completed
PCC Works
  • PCC below isolated footing – 90% completed

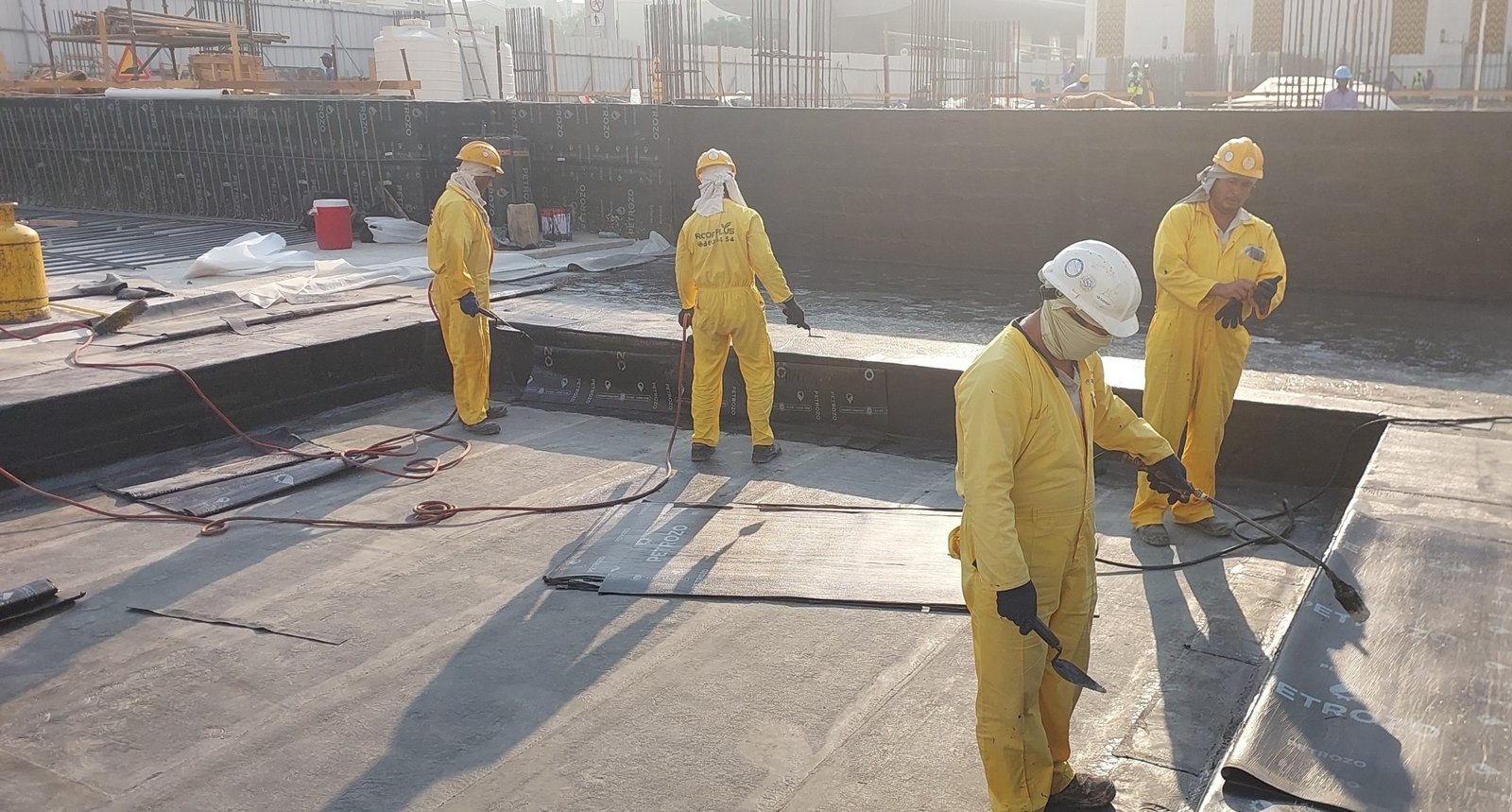

Waterproofing Works
  • Waterproofing for isolated footing – 75% completed
Reinforcement & Concrete Works

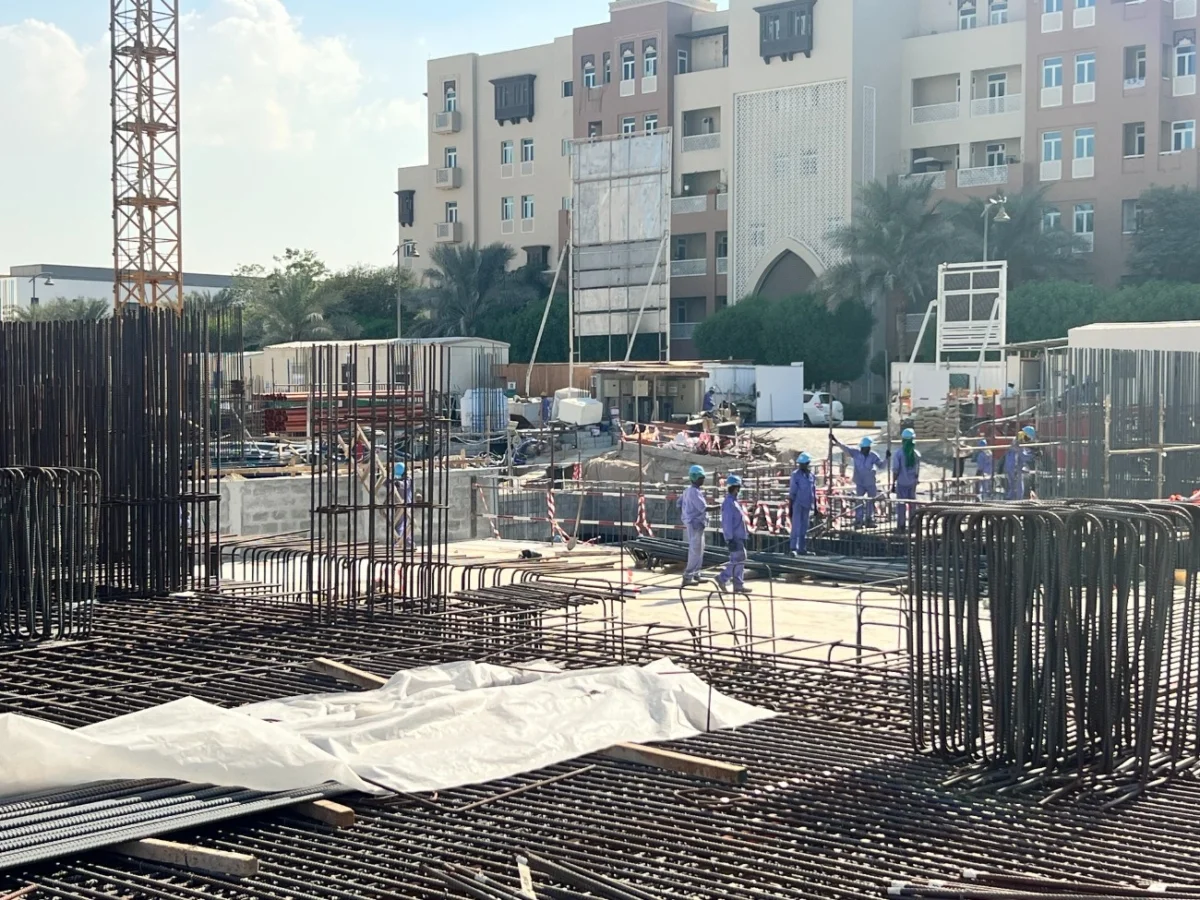

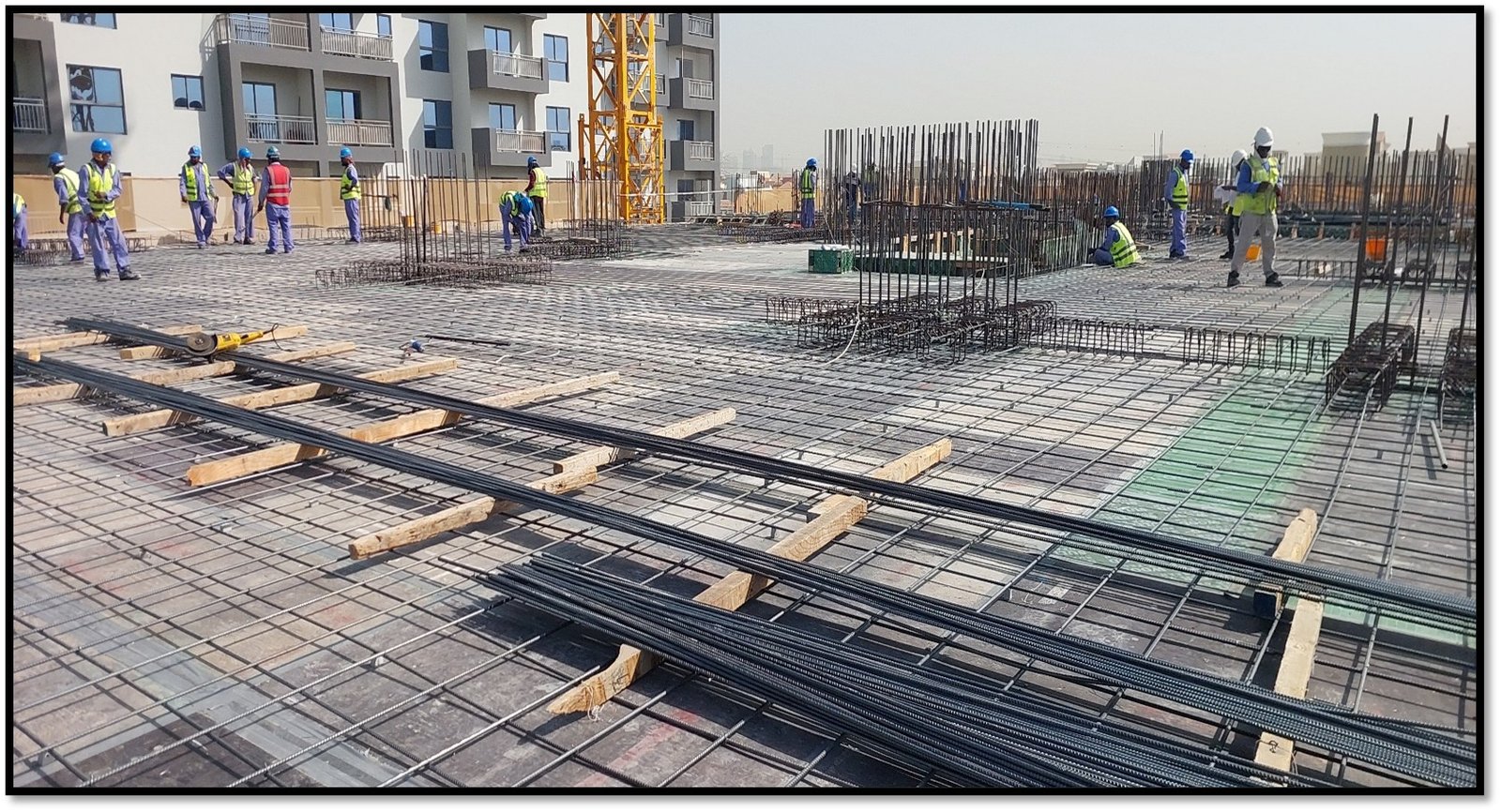

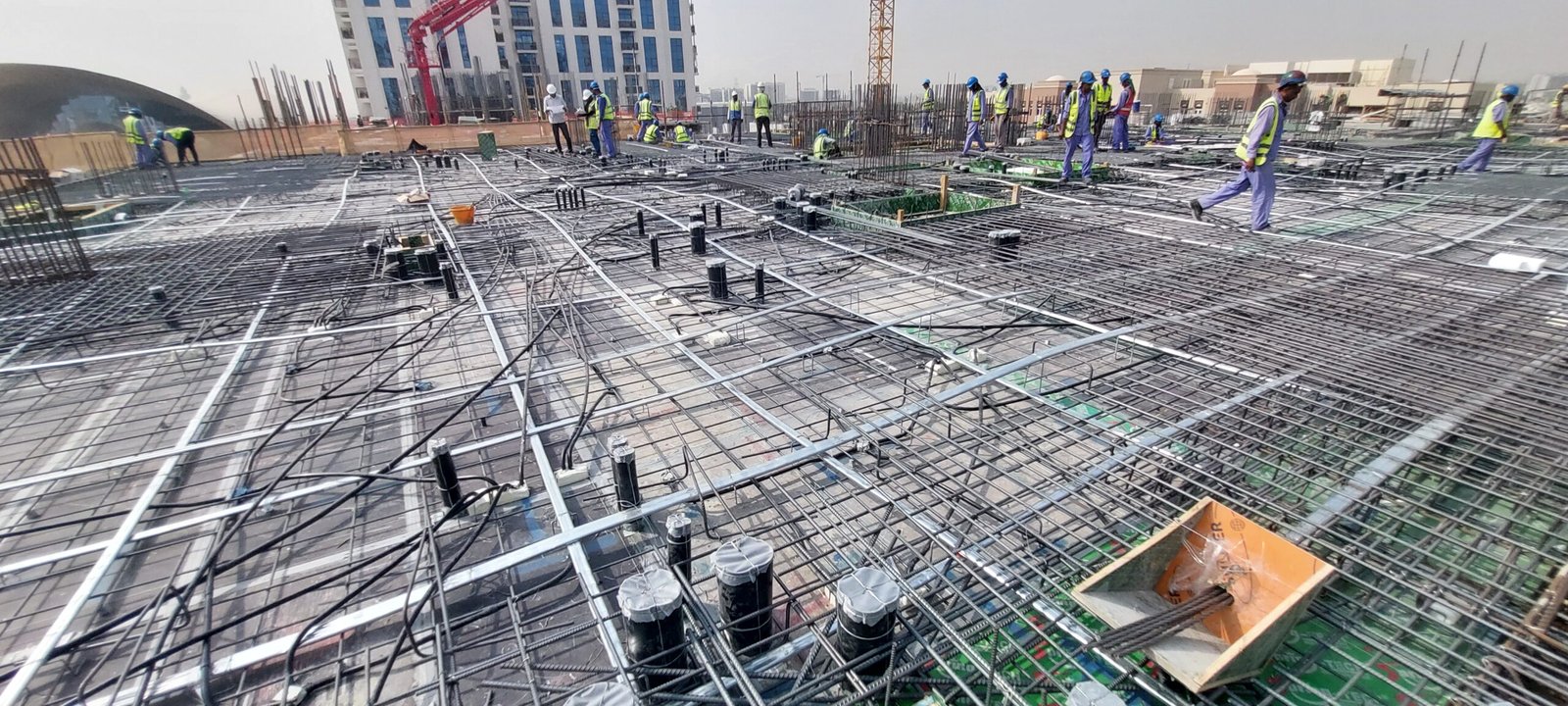

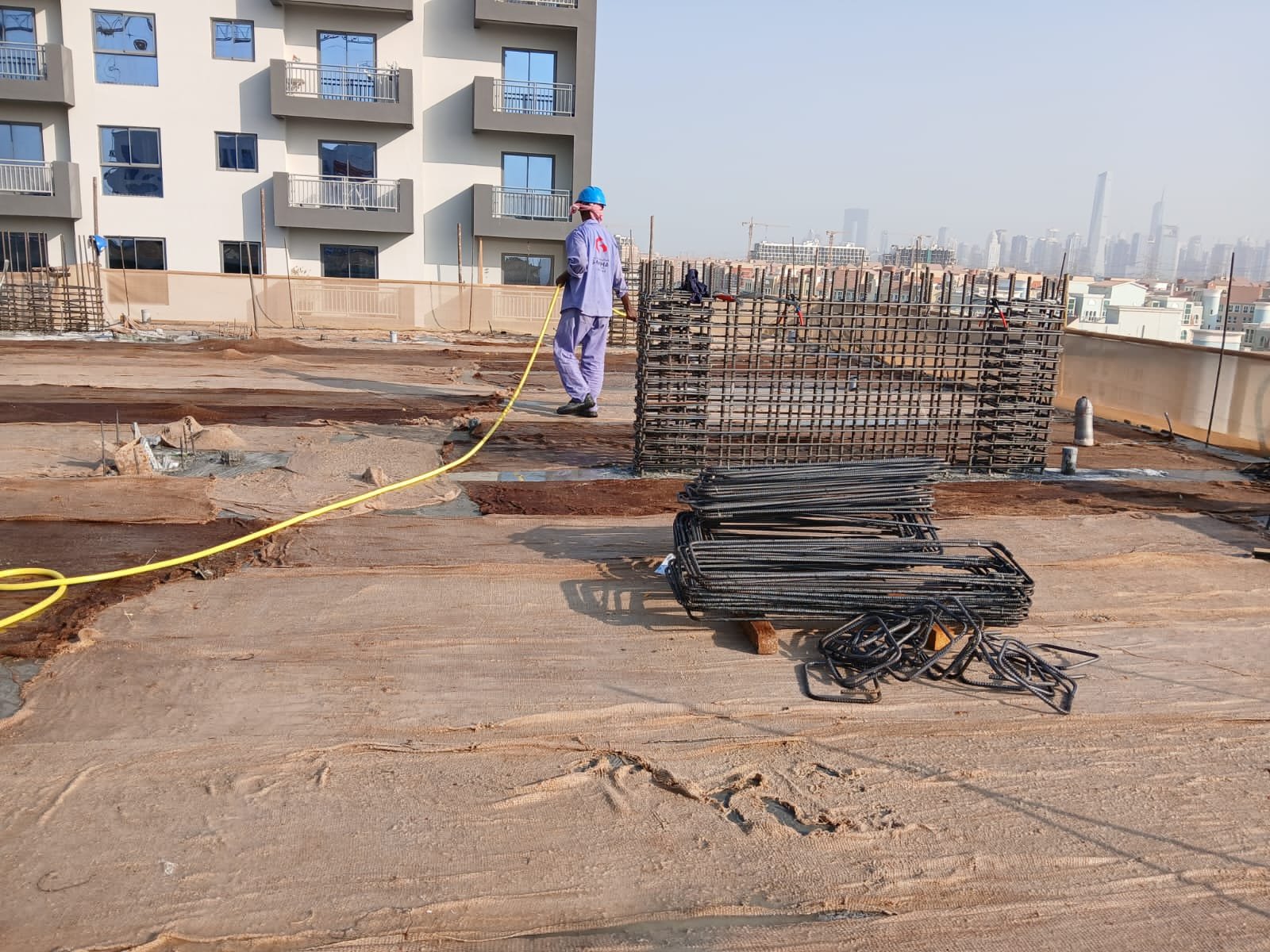

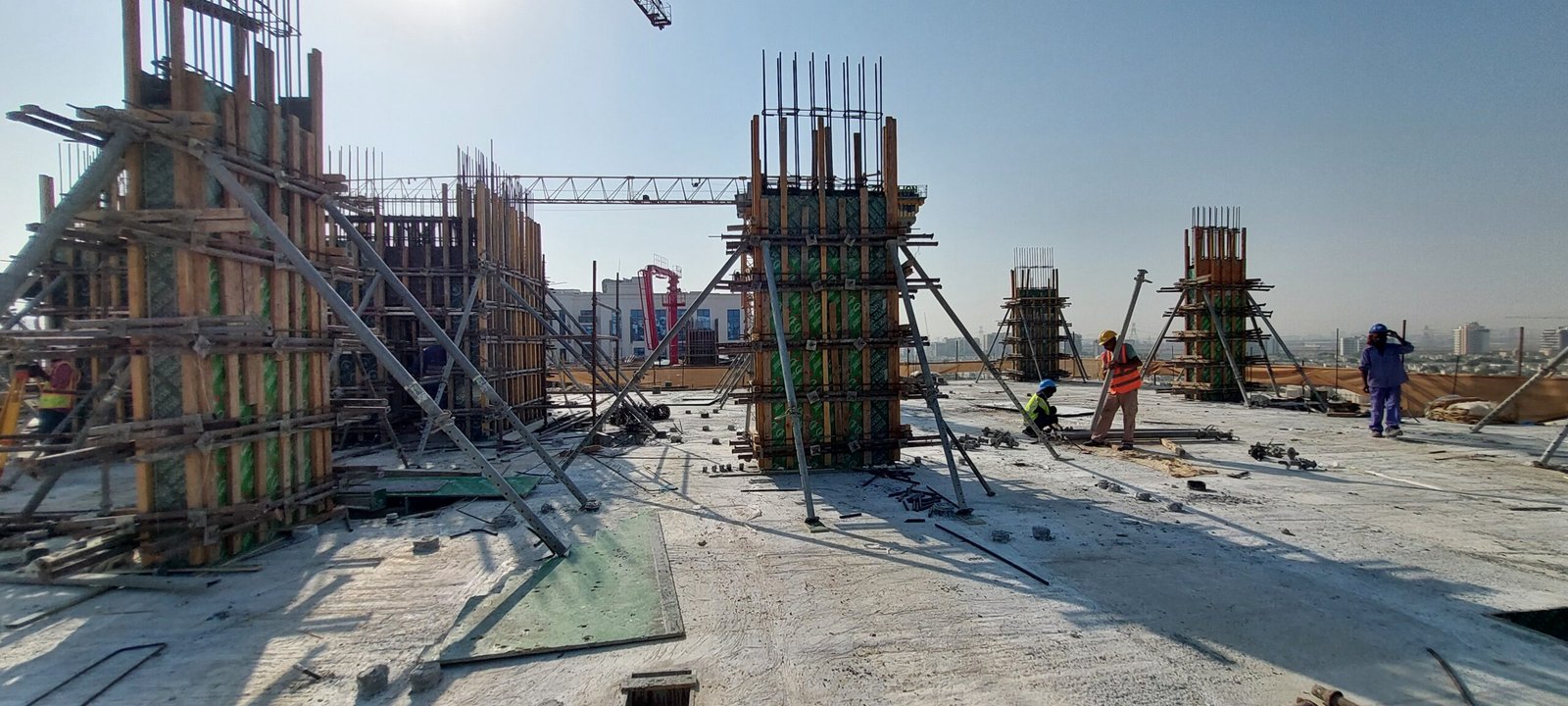

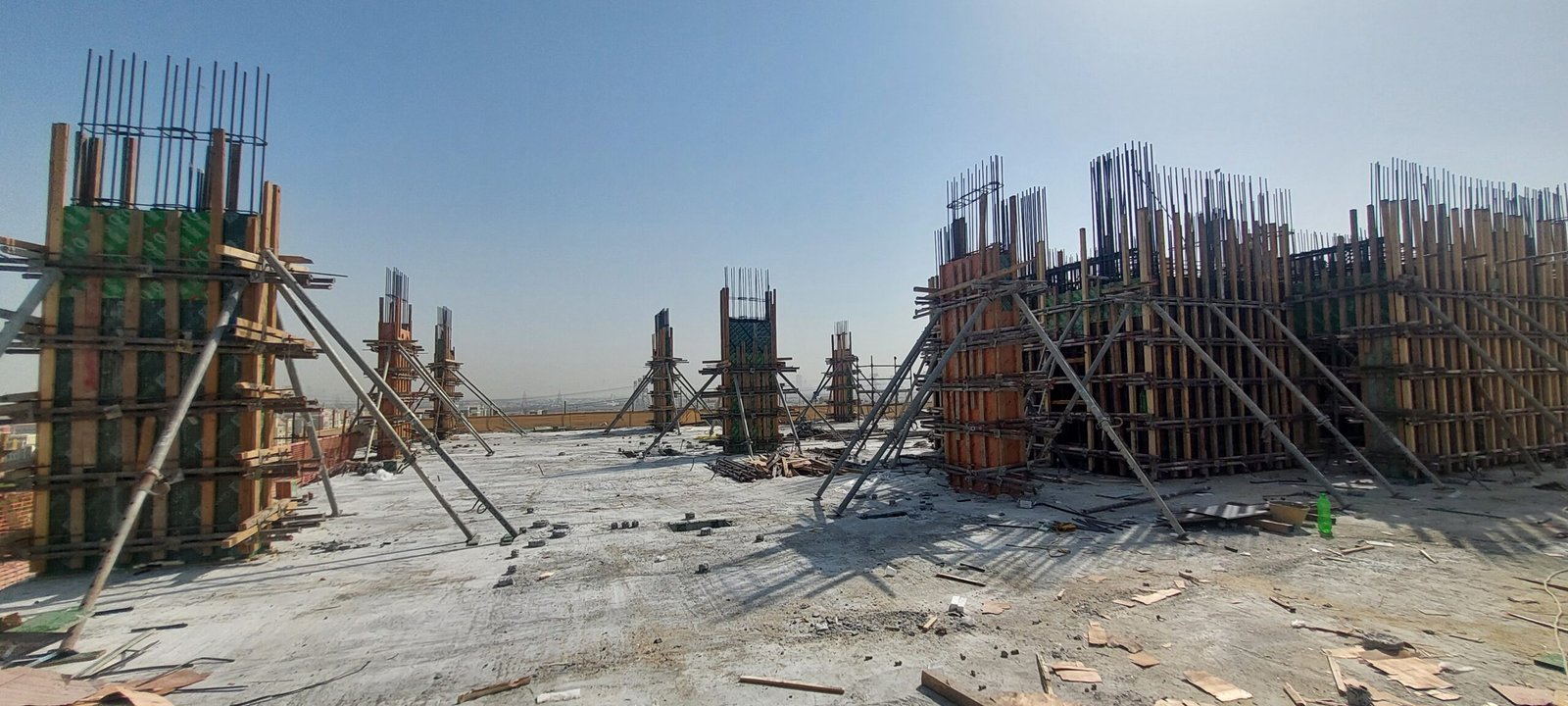

  • Steel reinforcement work for isolated footing – 85% completed
  • Isolated footing concrete casting – 85% completed

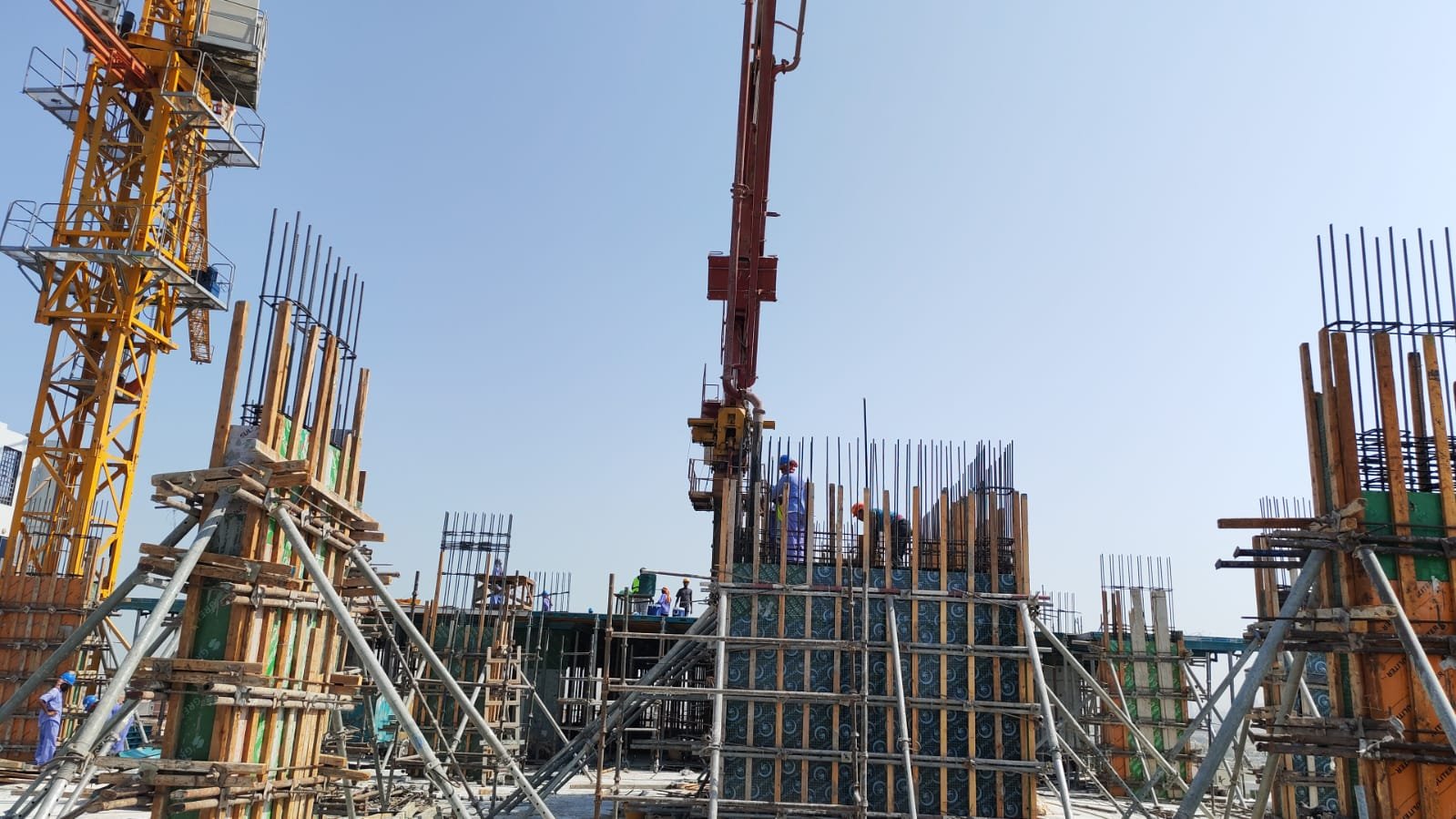

  • Steel reinforcement work for neck column at isolated footing – 80% completed
  • Neck column concrete casting at isolated footing – 80% completed

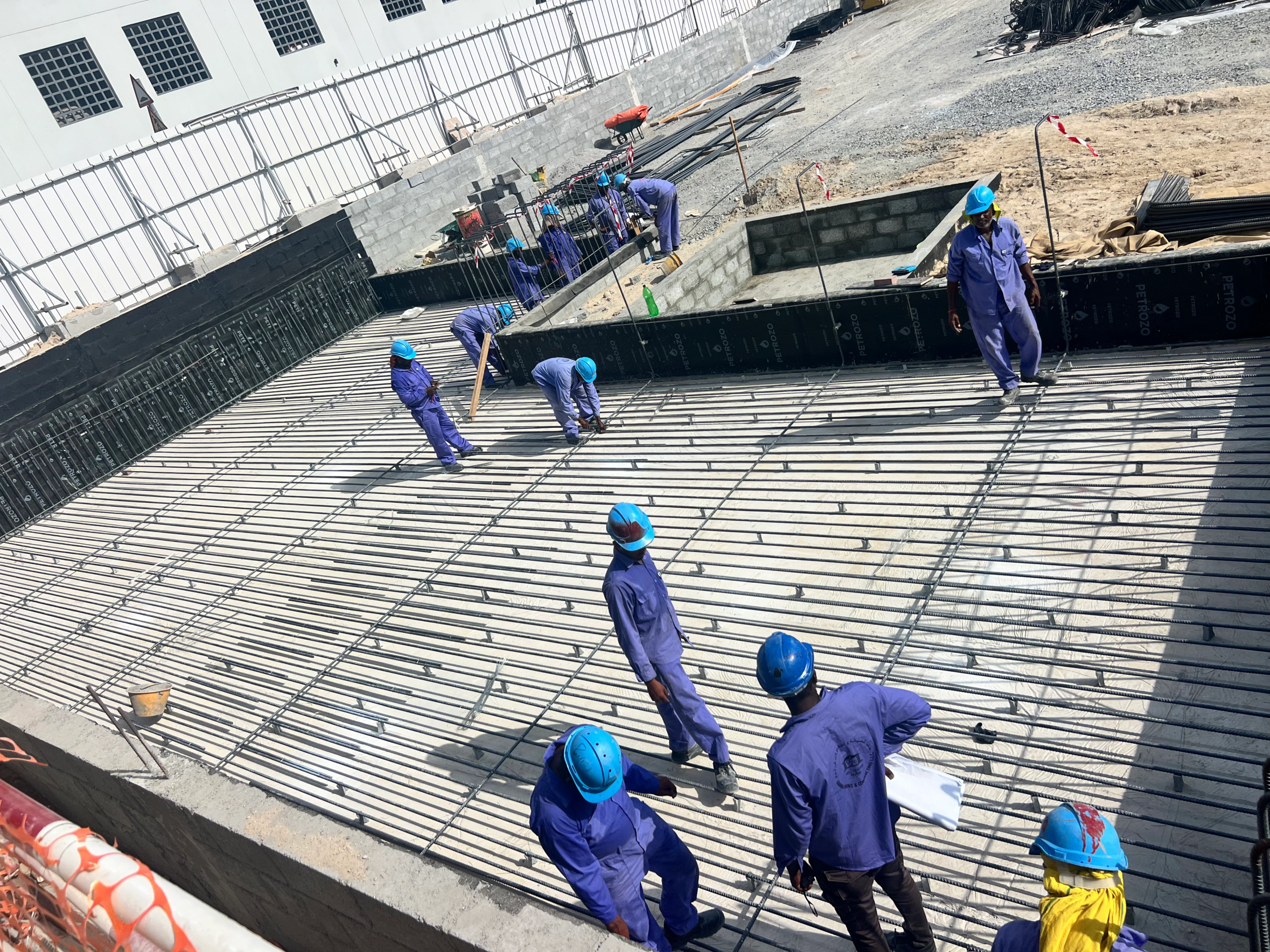

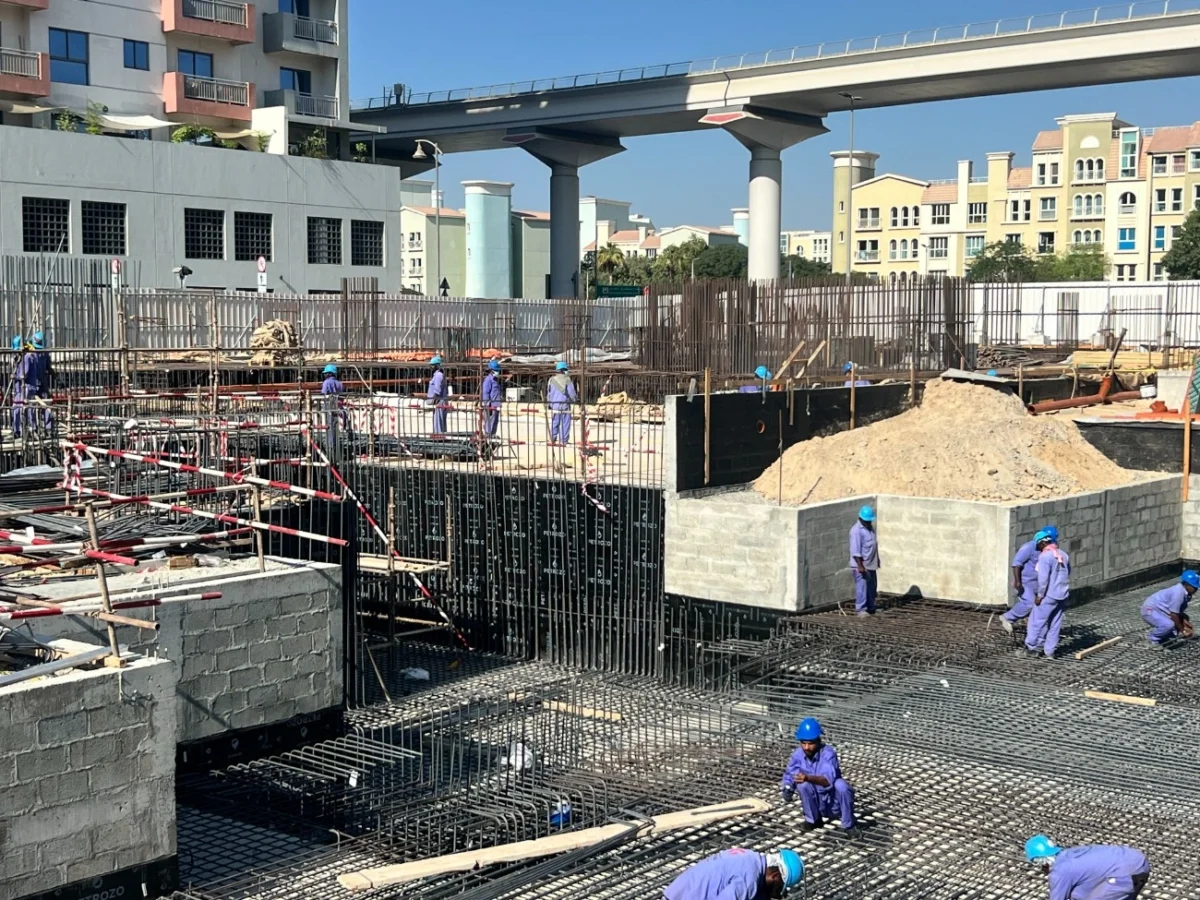

Underground Water Tank & Pump Room
  • Shuttering work for wall – 100% completed
  • Concrete casting for wall – 100% completed

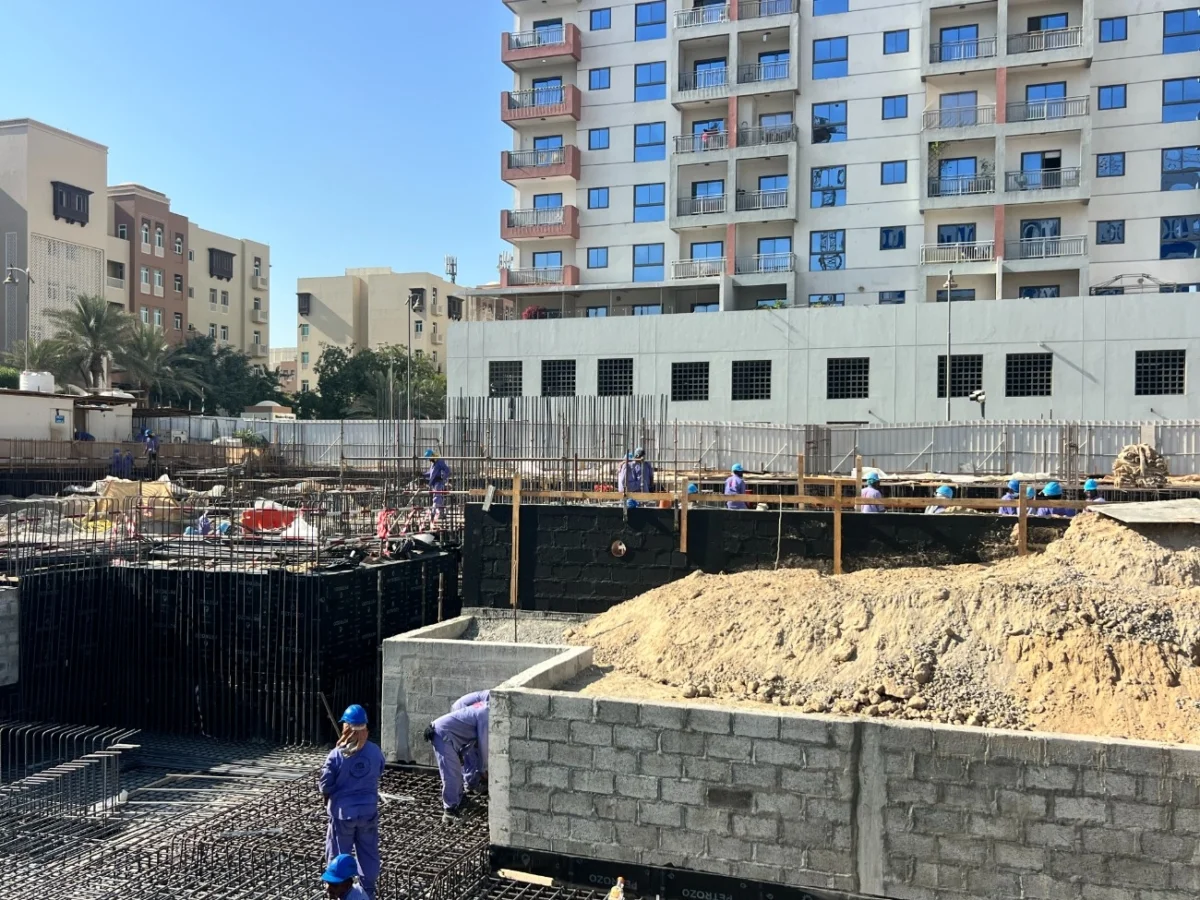

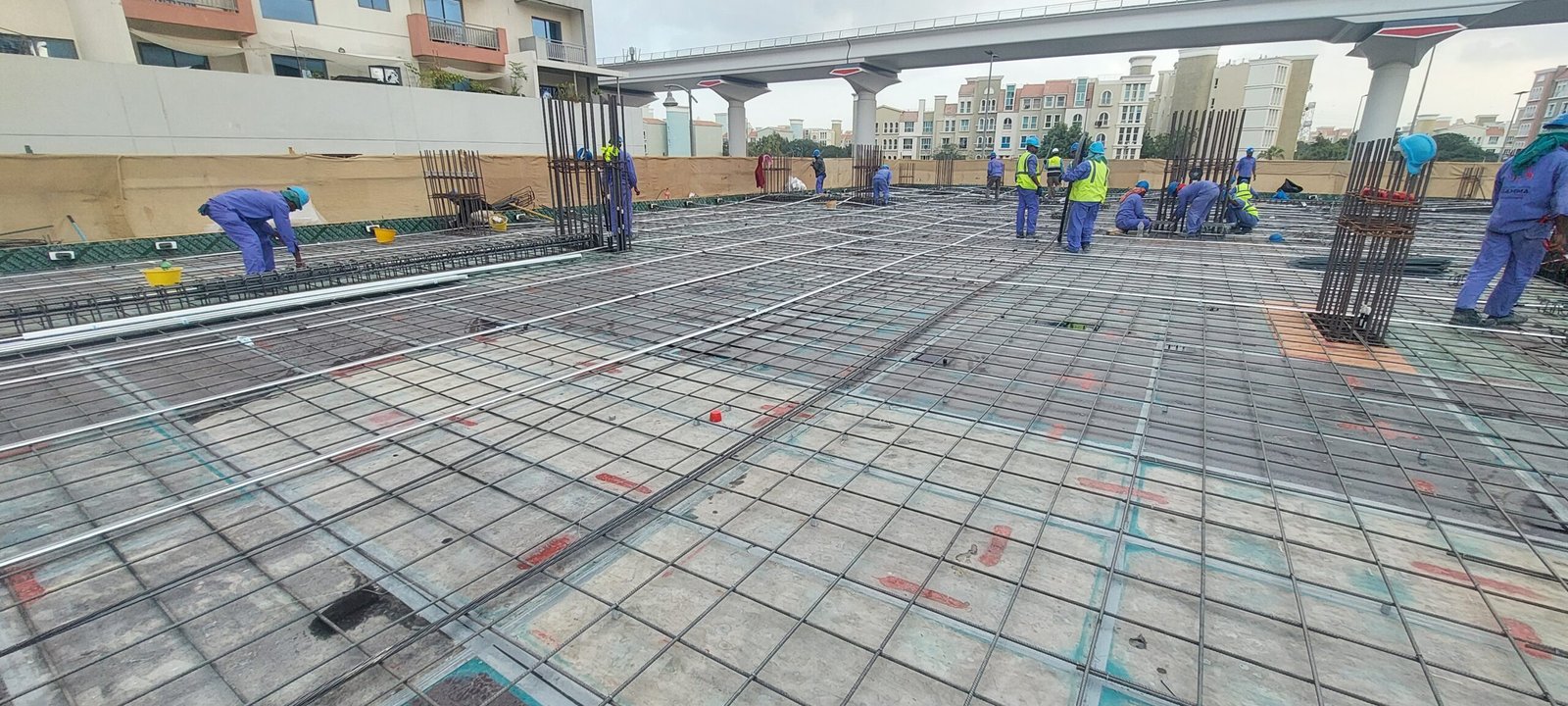

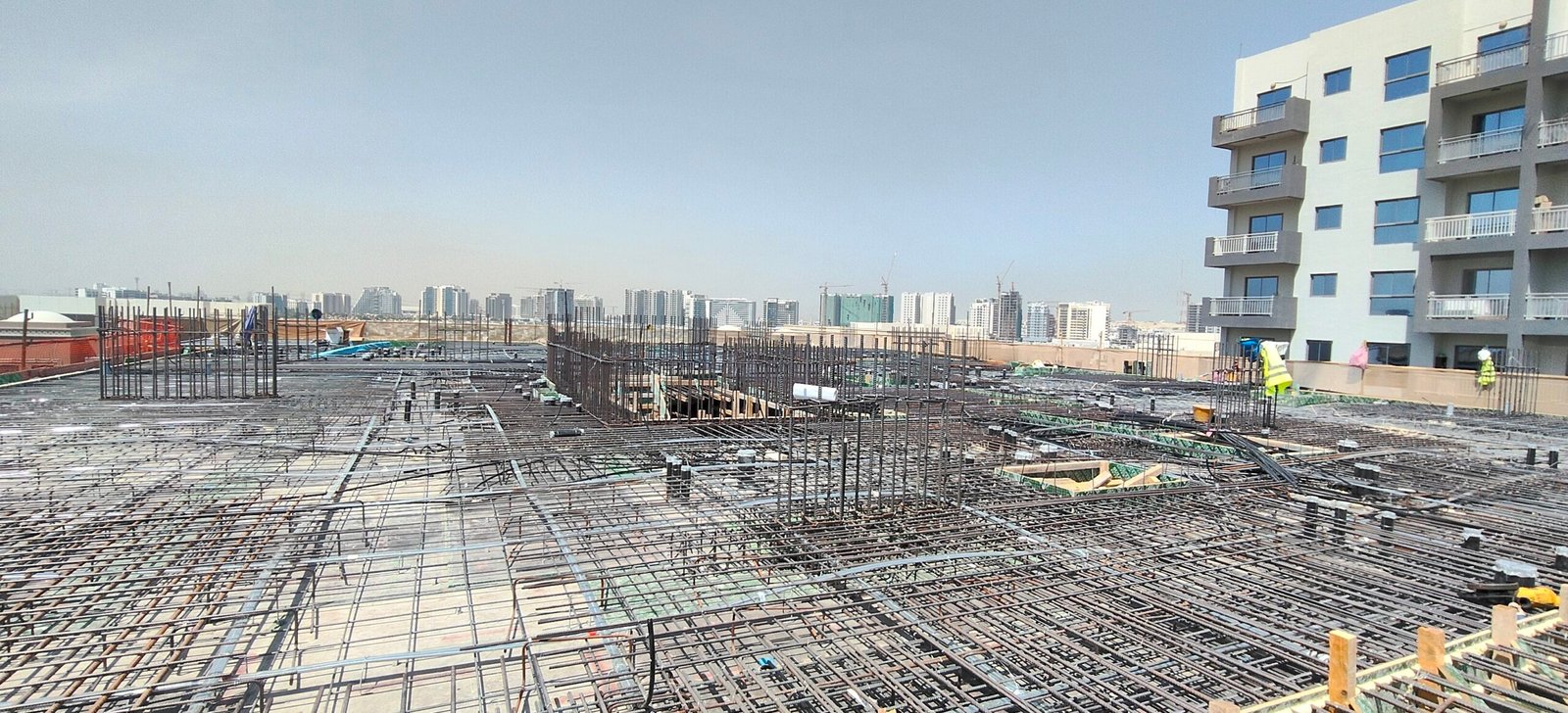

Ground Floor

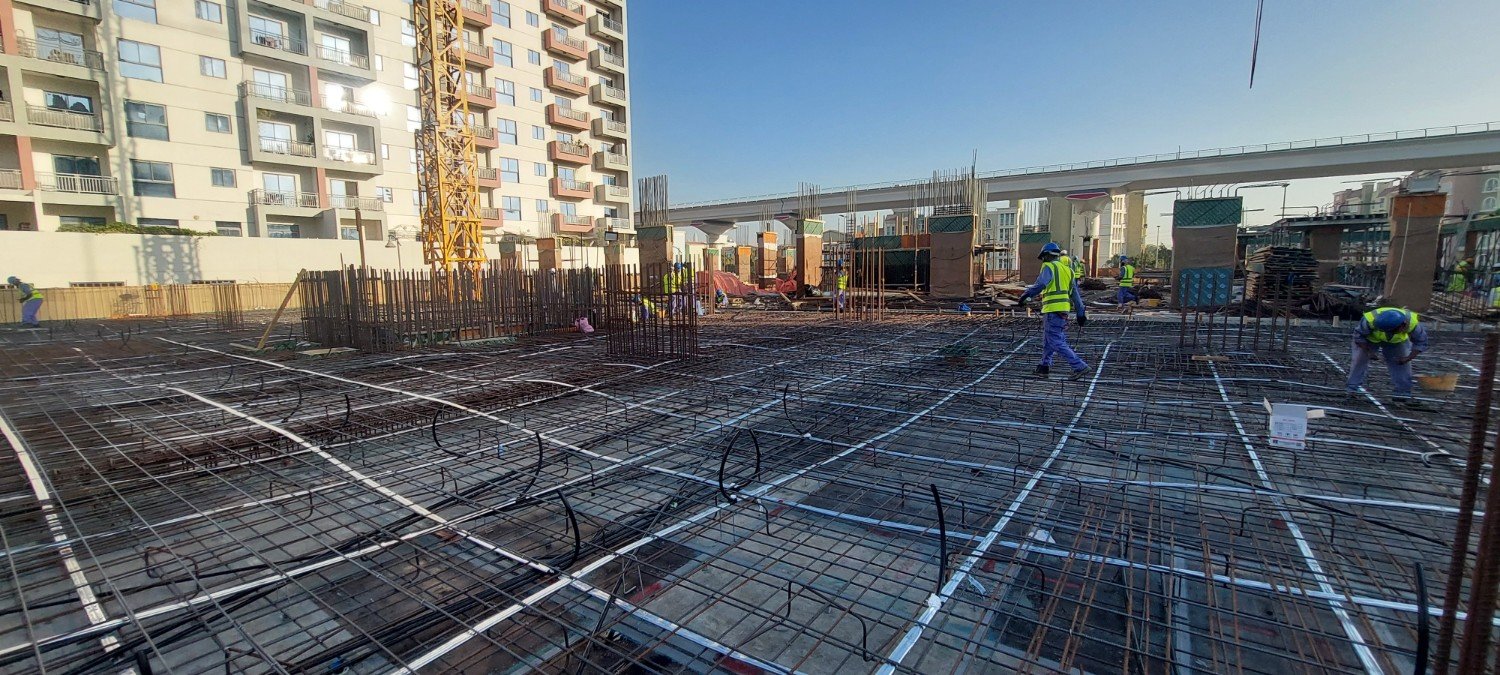

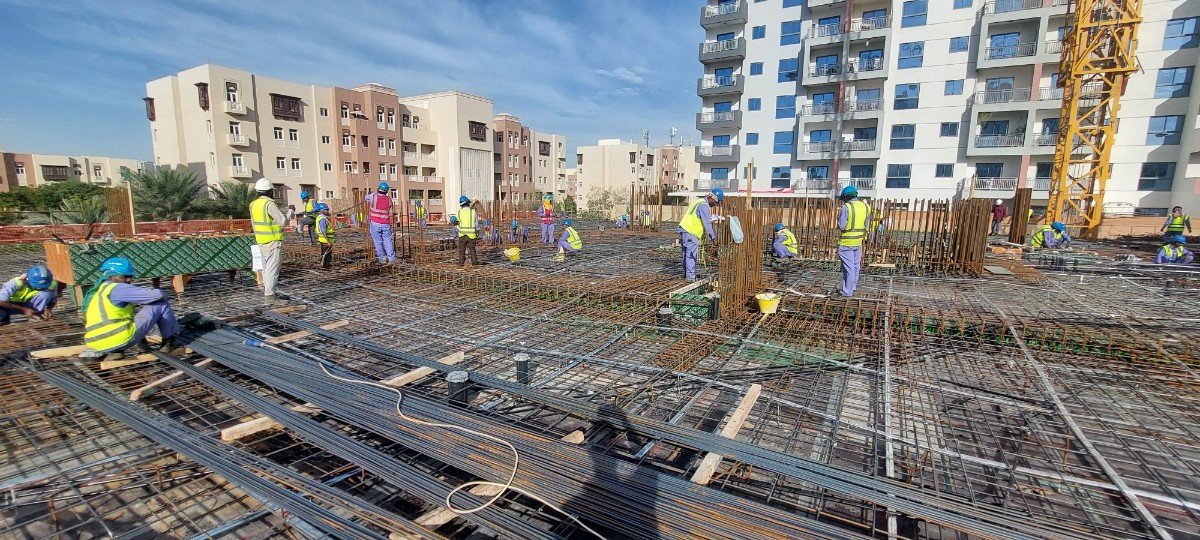

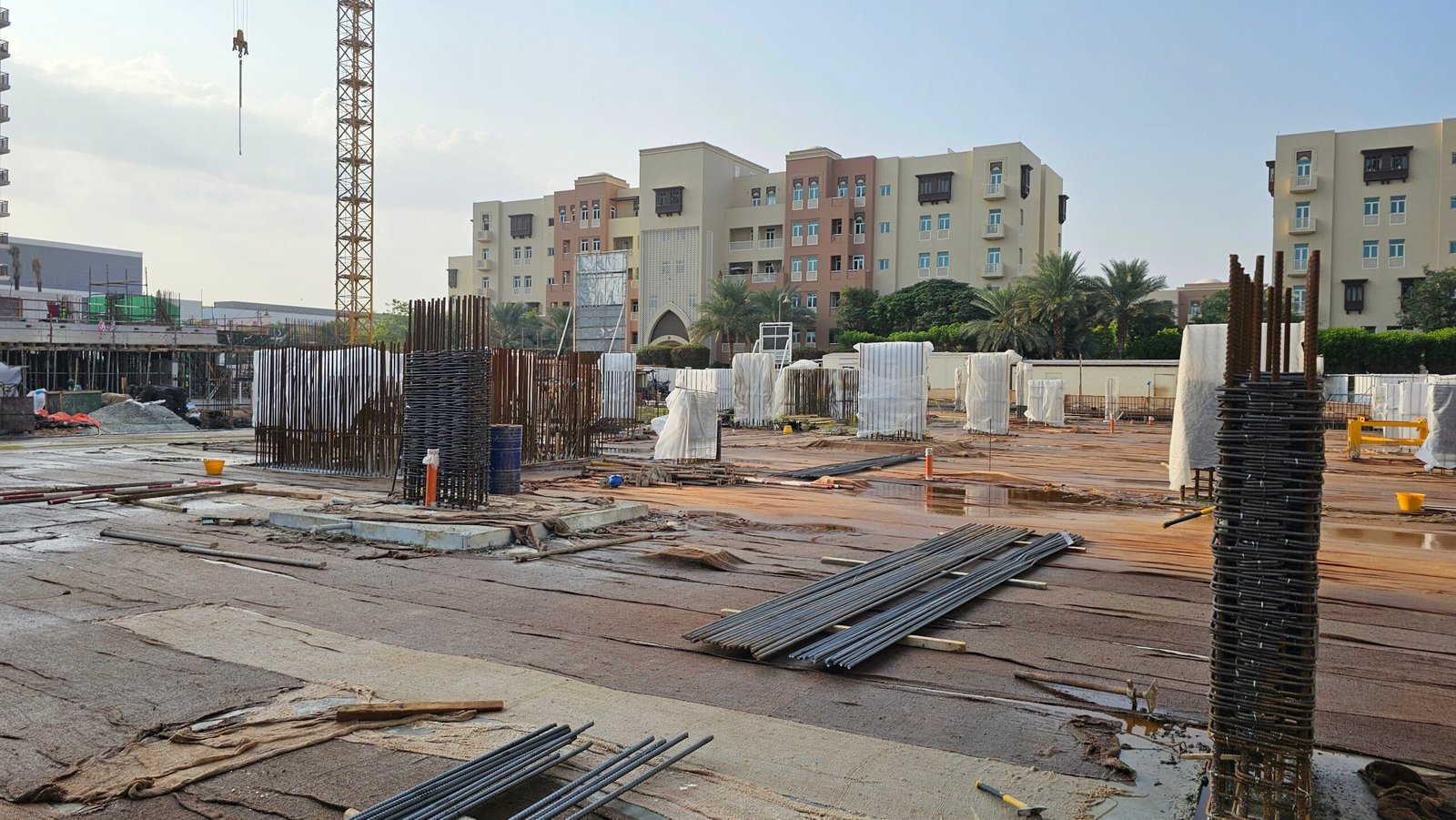

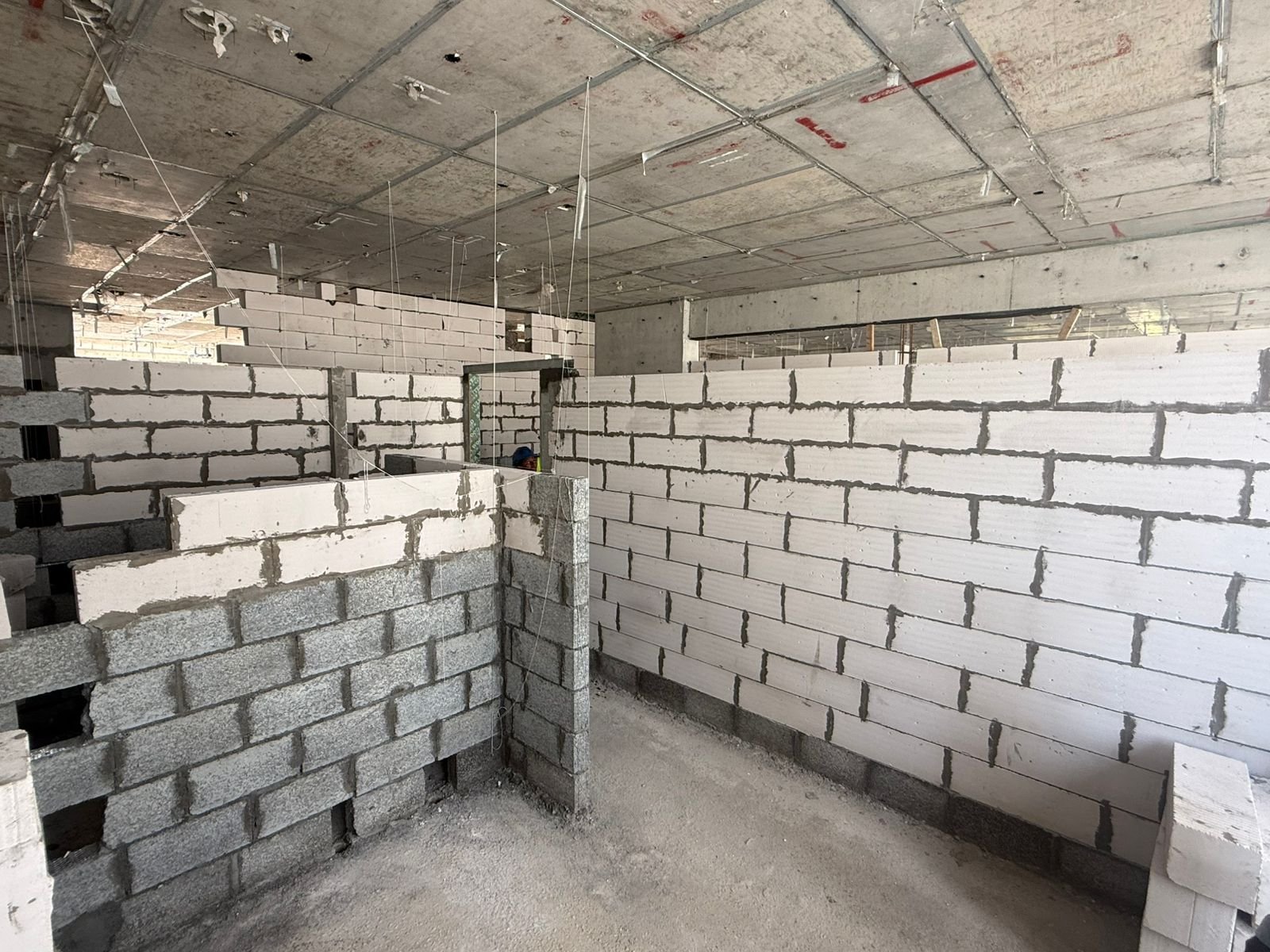

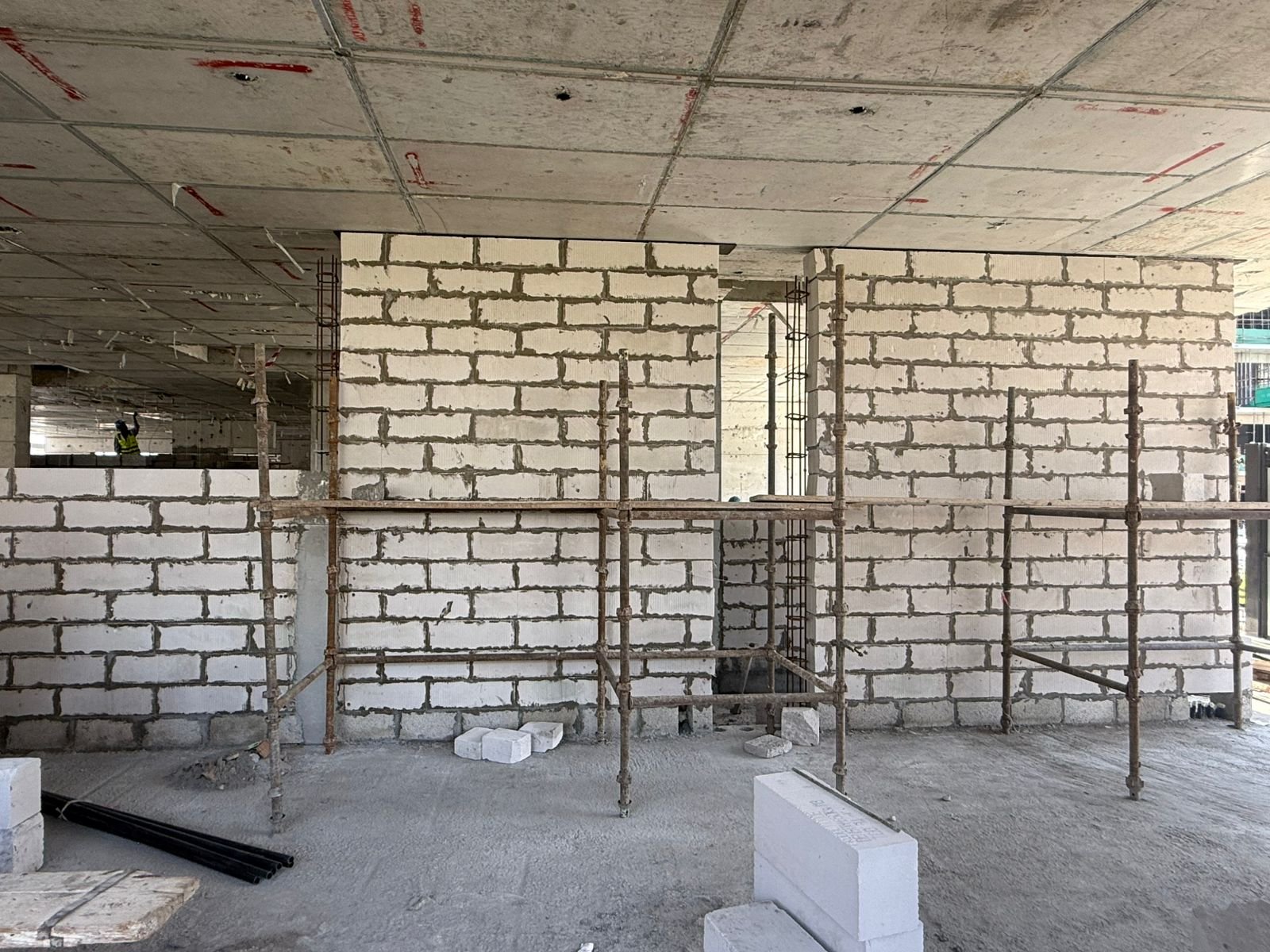

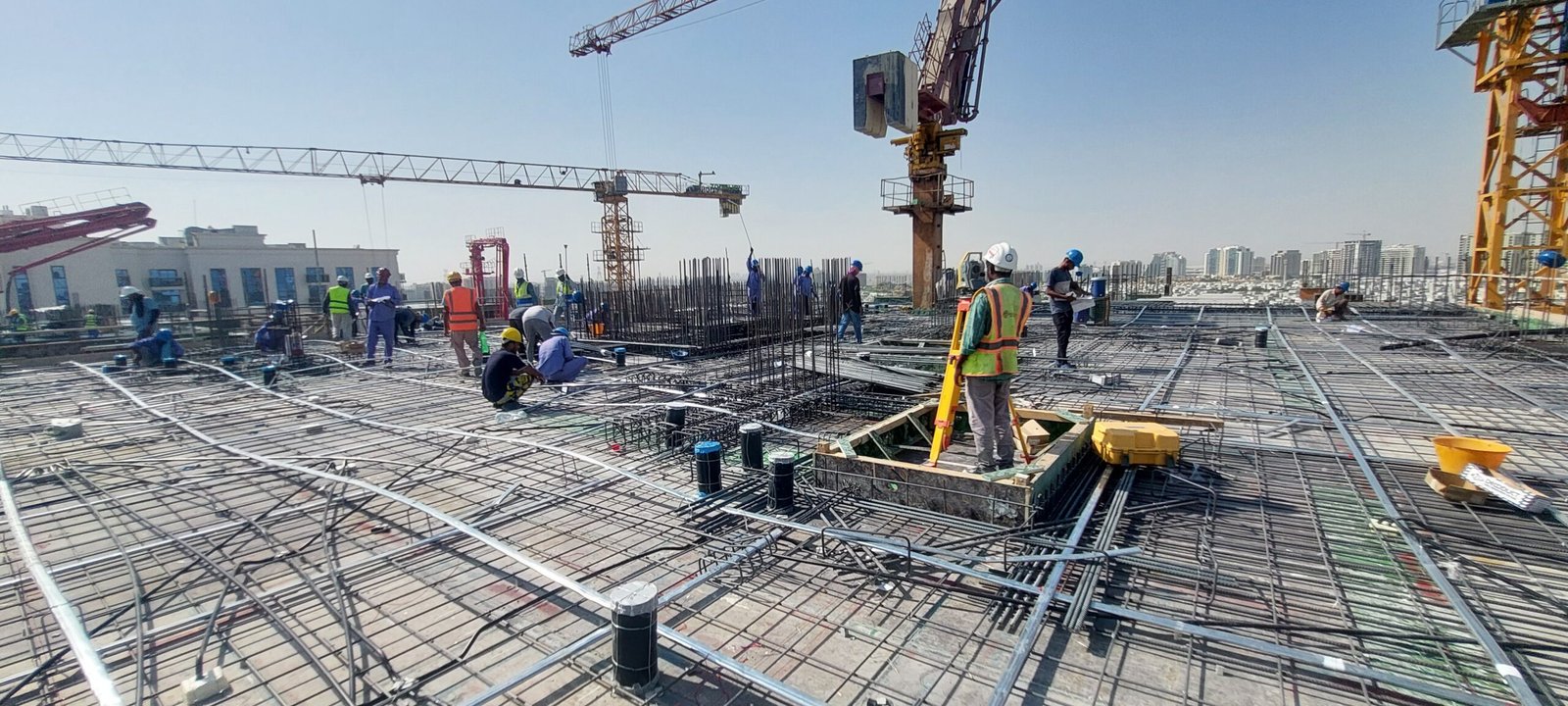

  • Reinforcement work for ground floor columns – 85% completed
Podium Floor

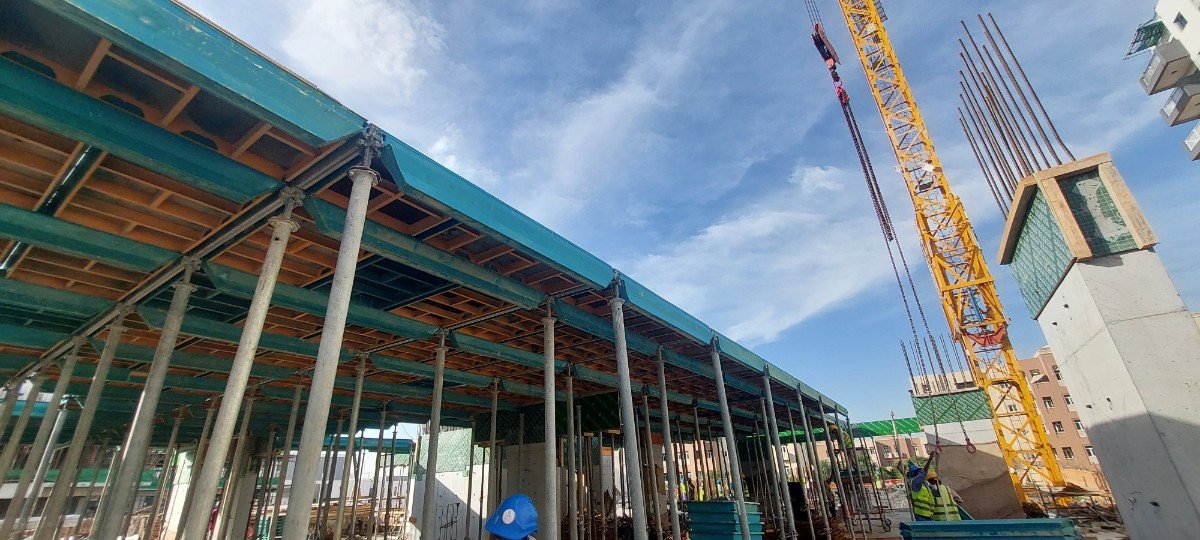

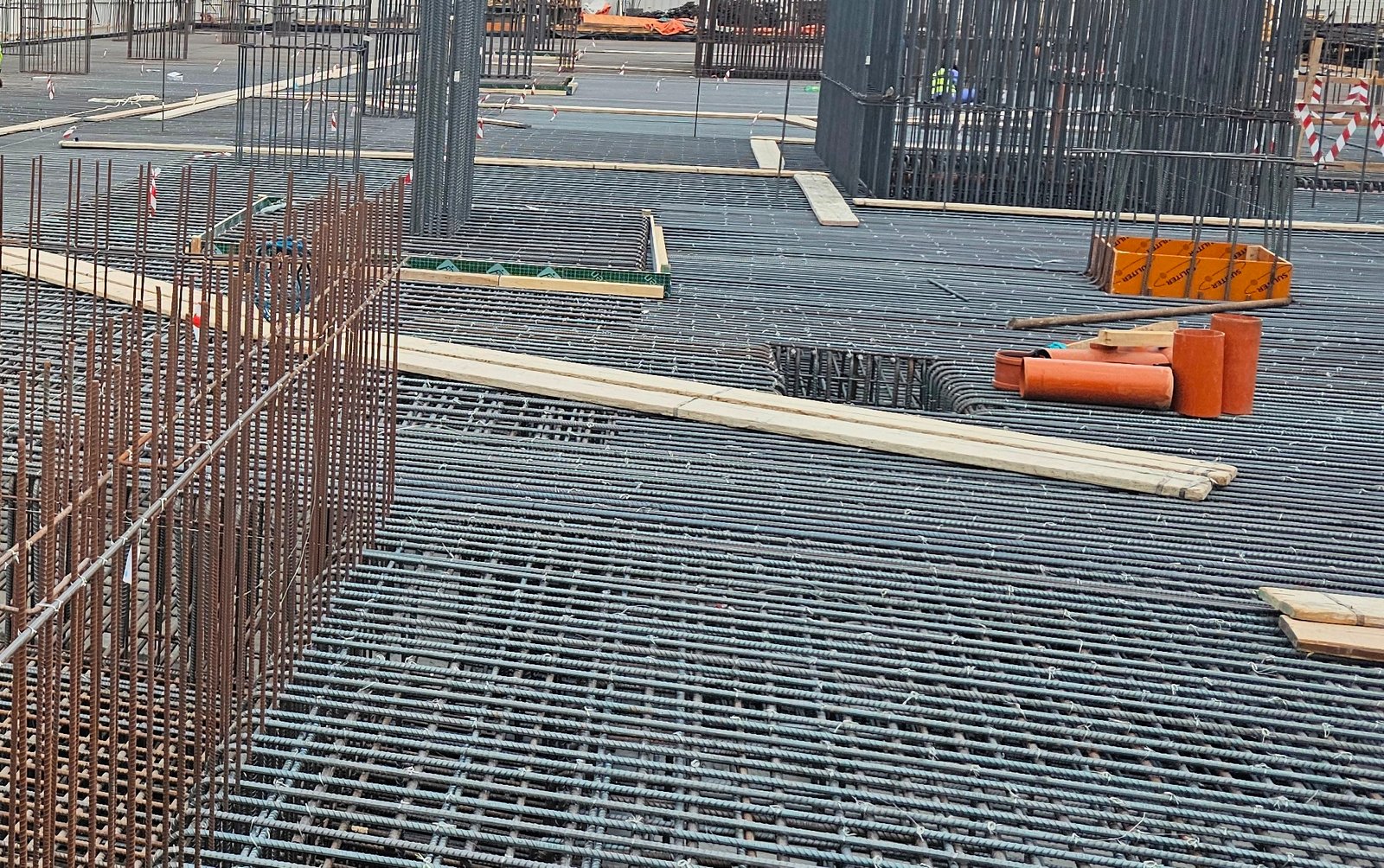

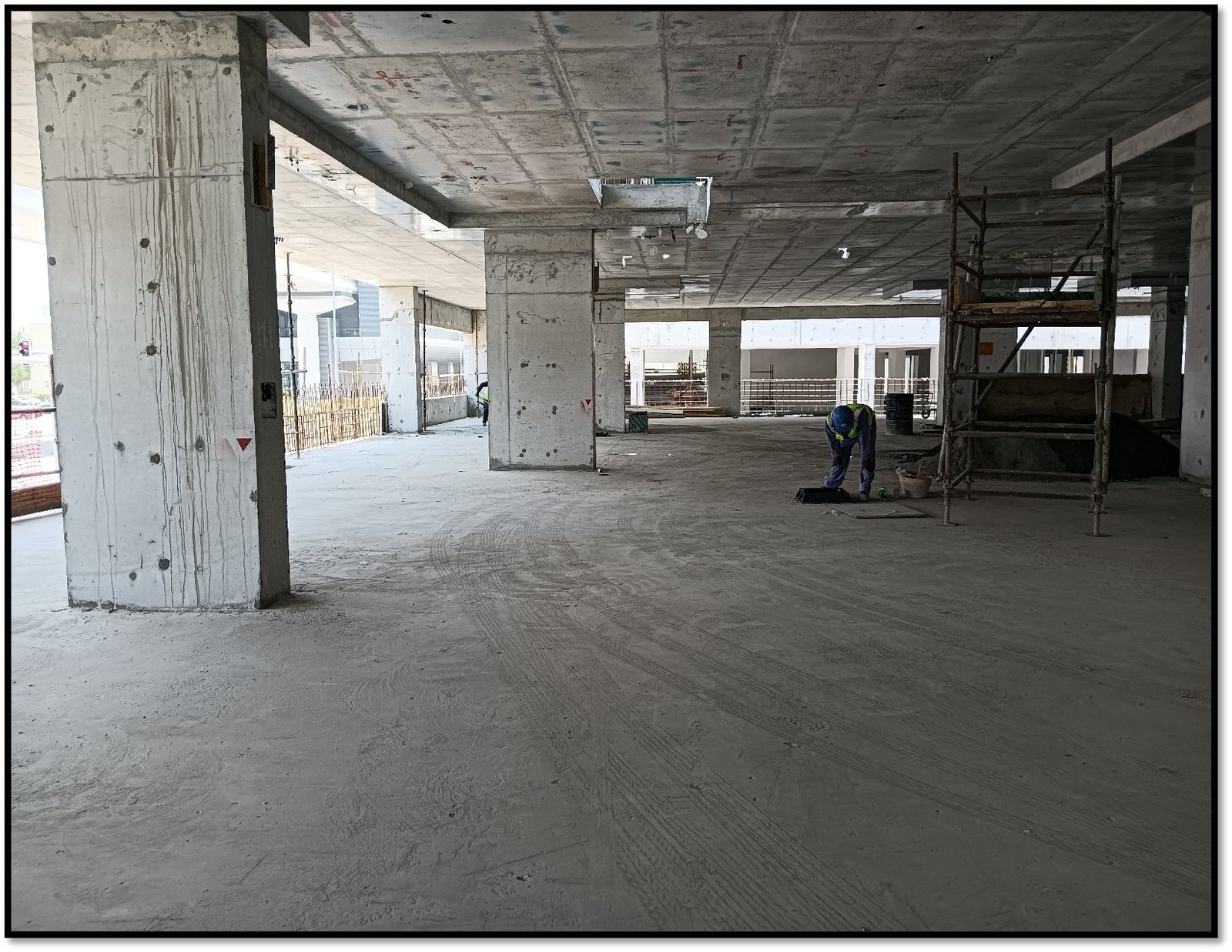

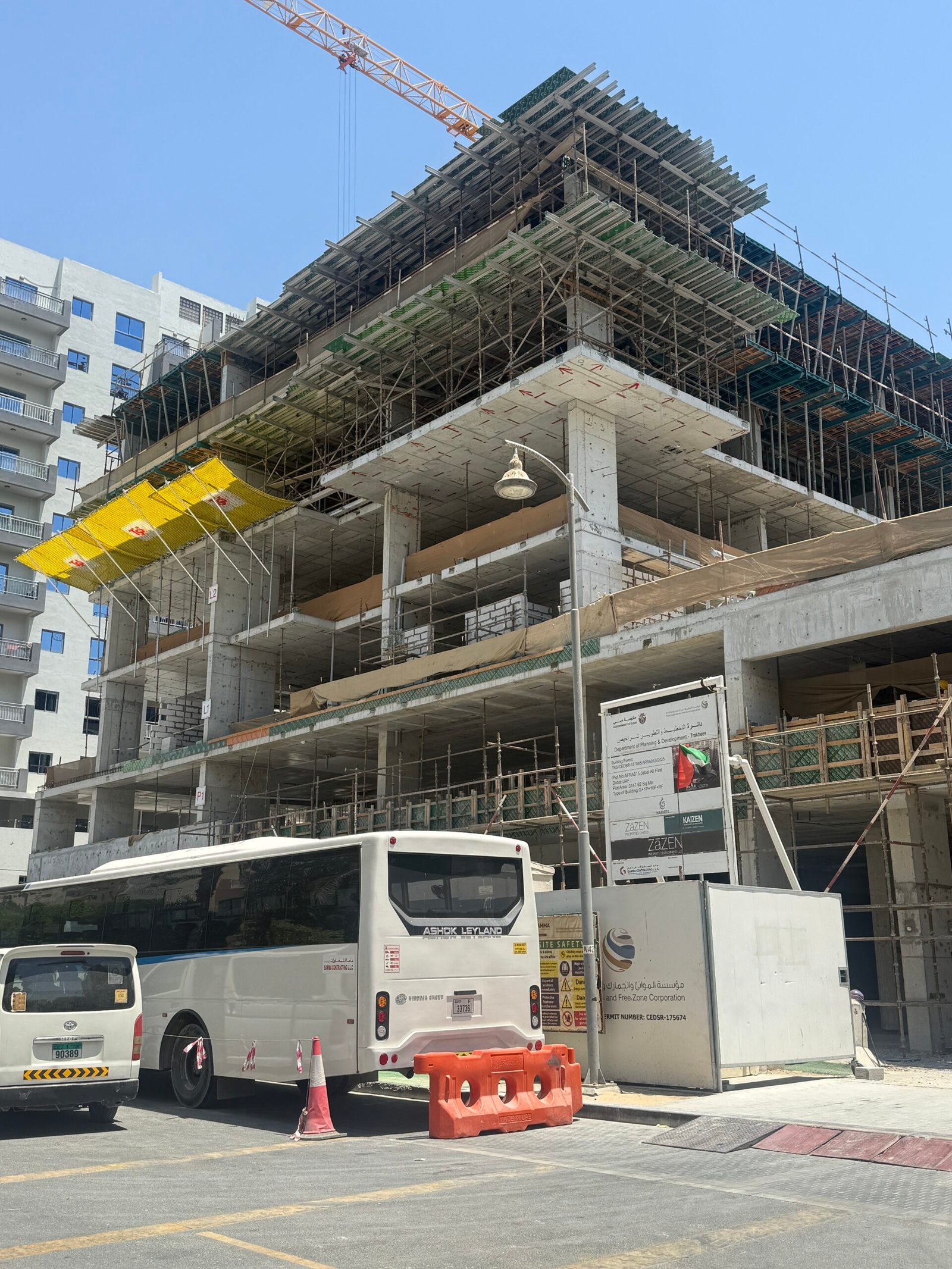

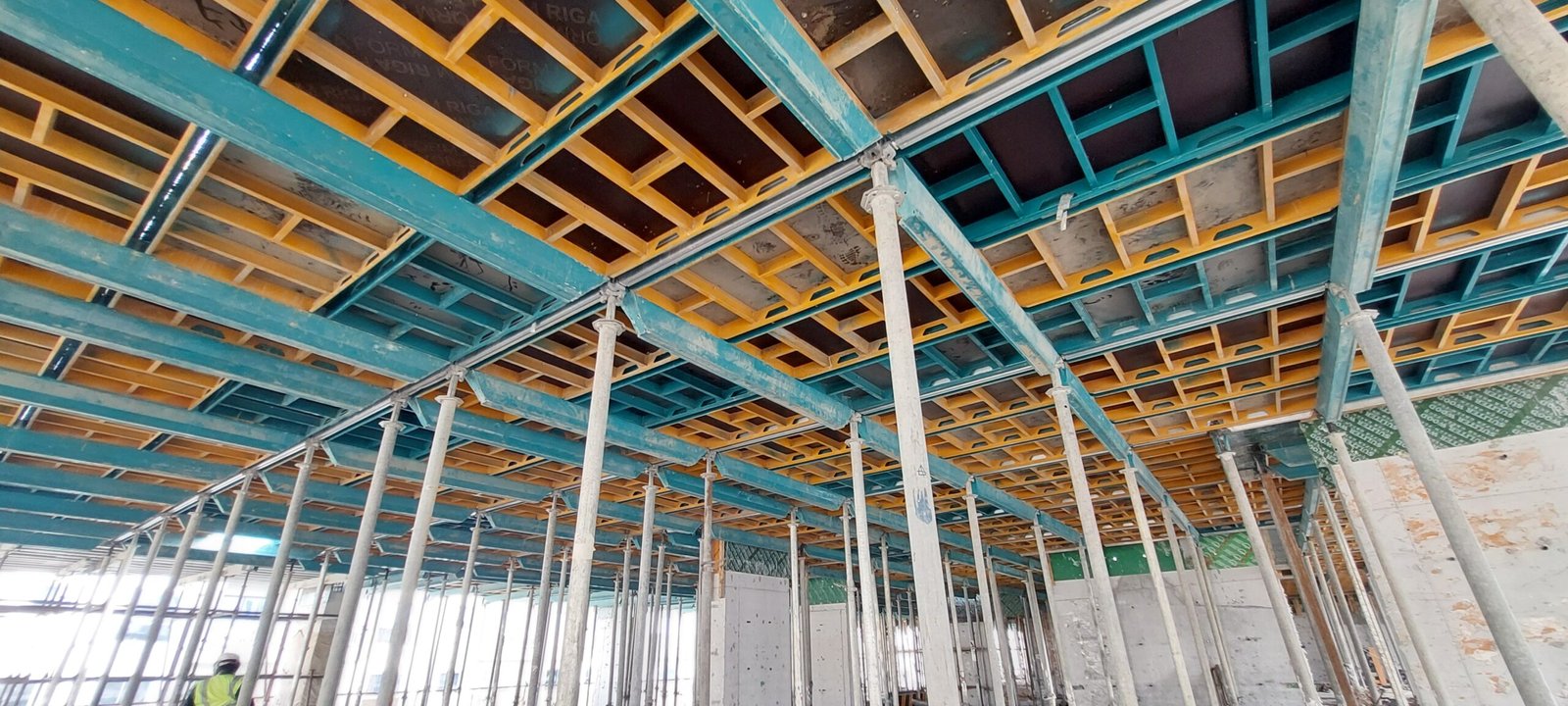

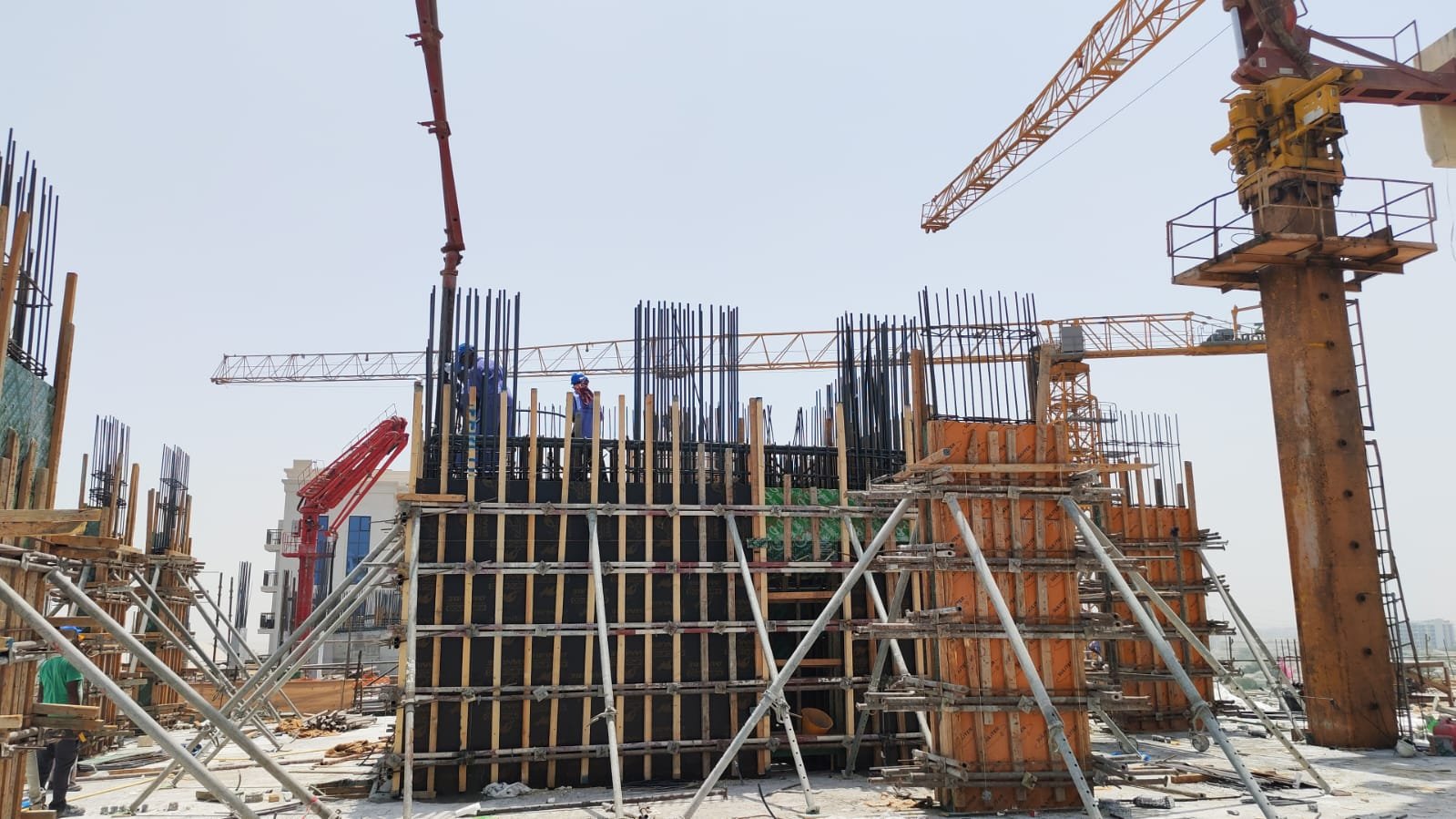

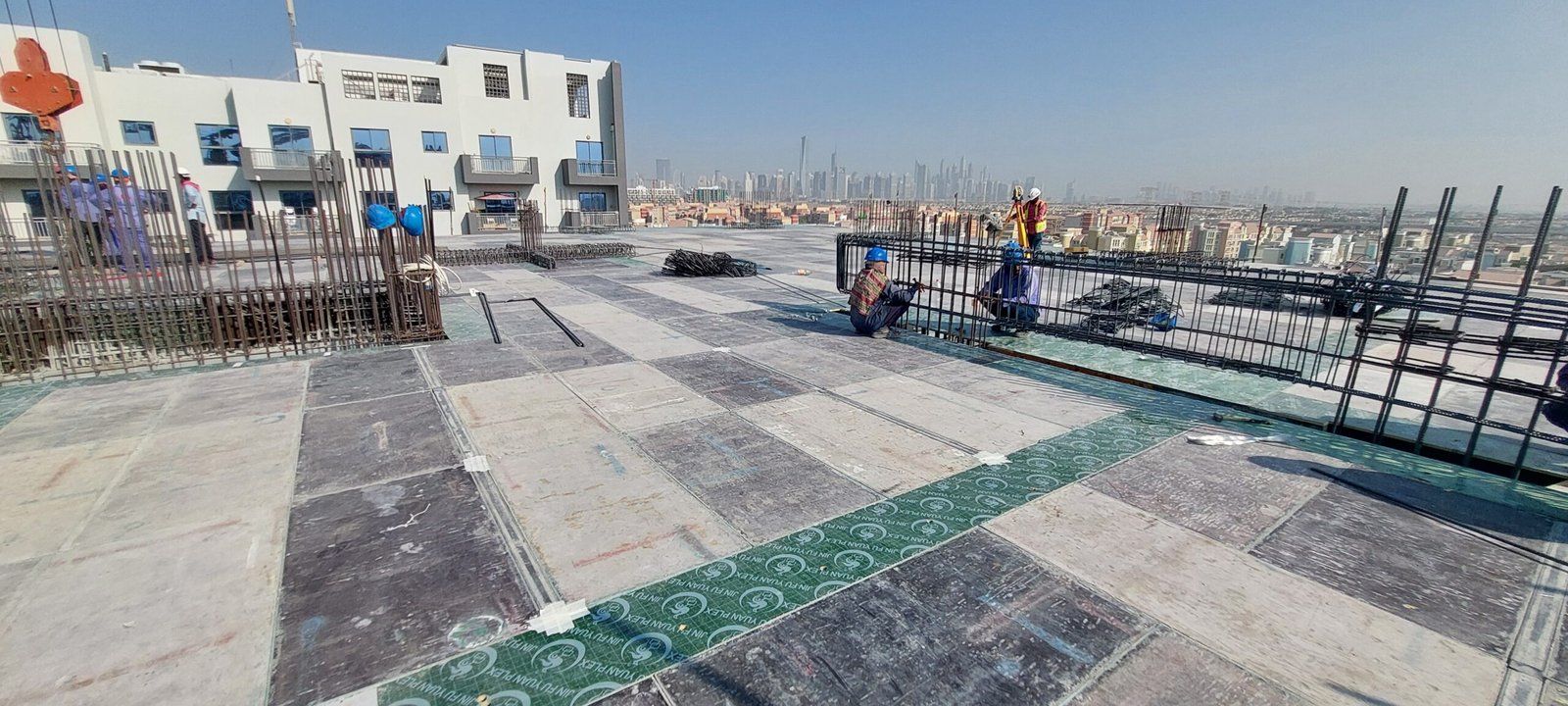

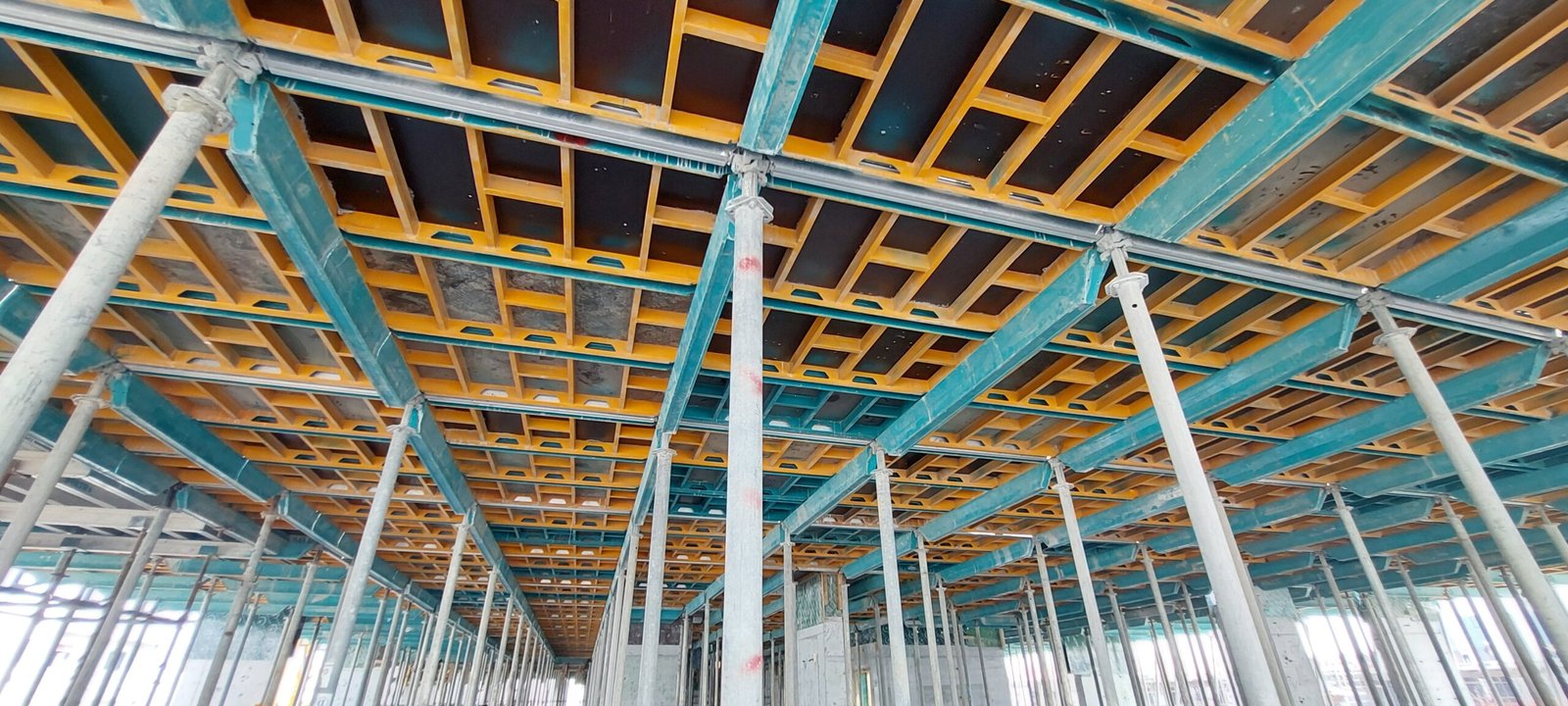

  • Shuttering work for podium slab – 85% completed
  • Reinforcement work for podium slab – 28% completed

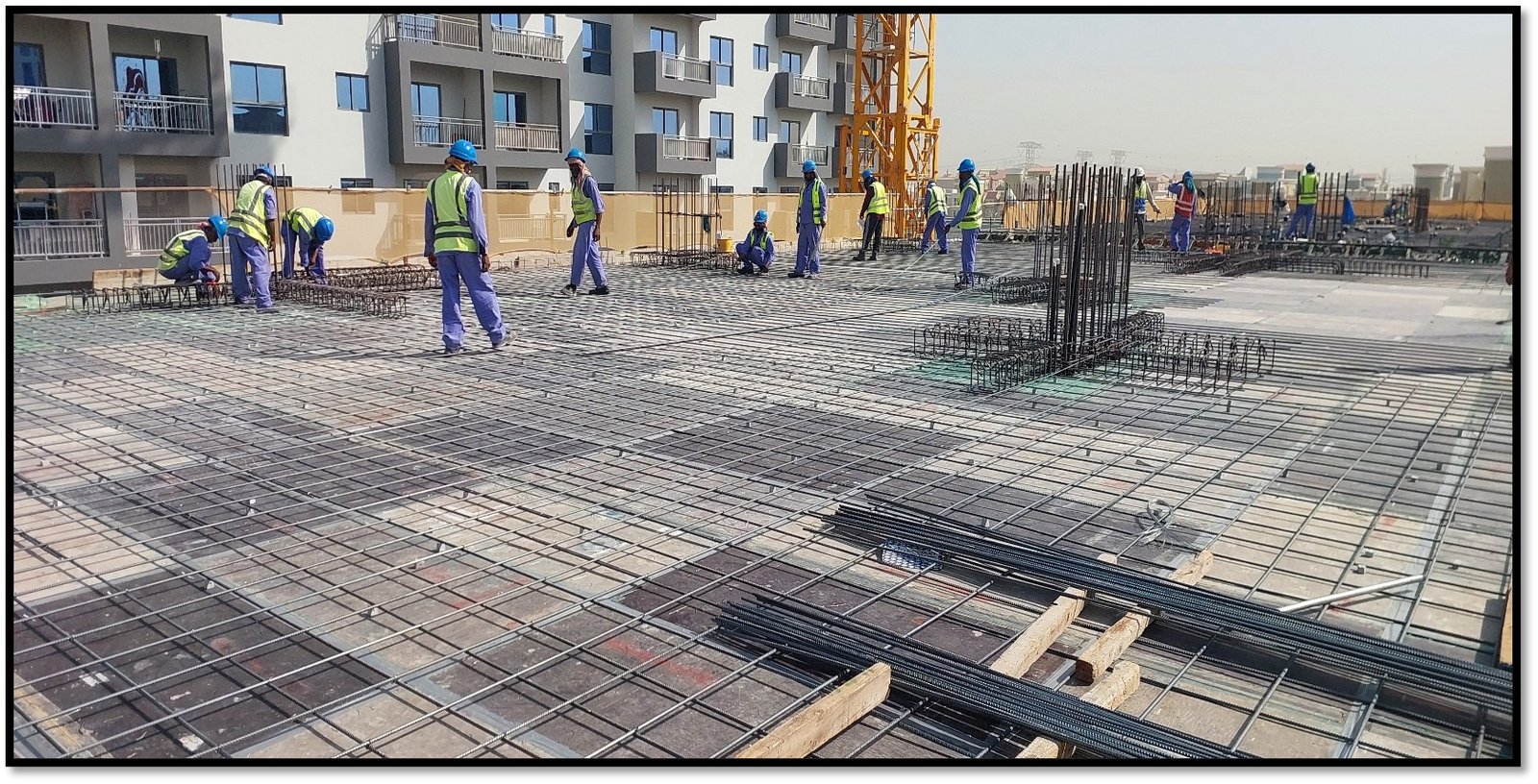

  • PT slab work for podium slab – 20% completed

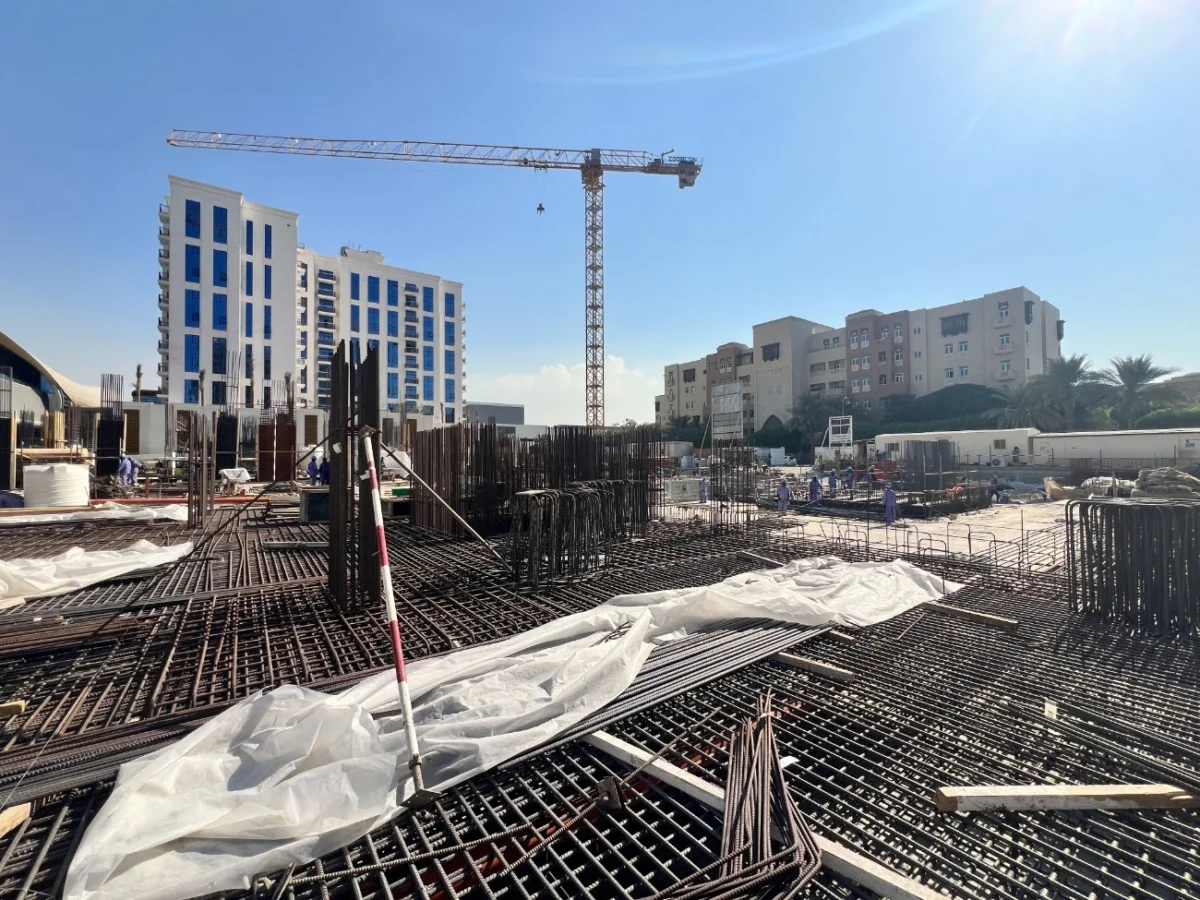

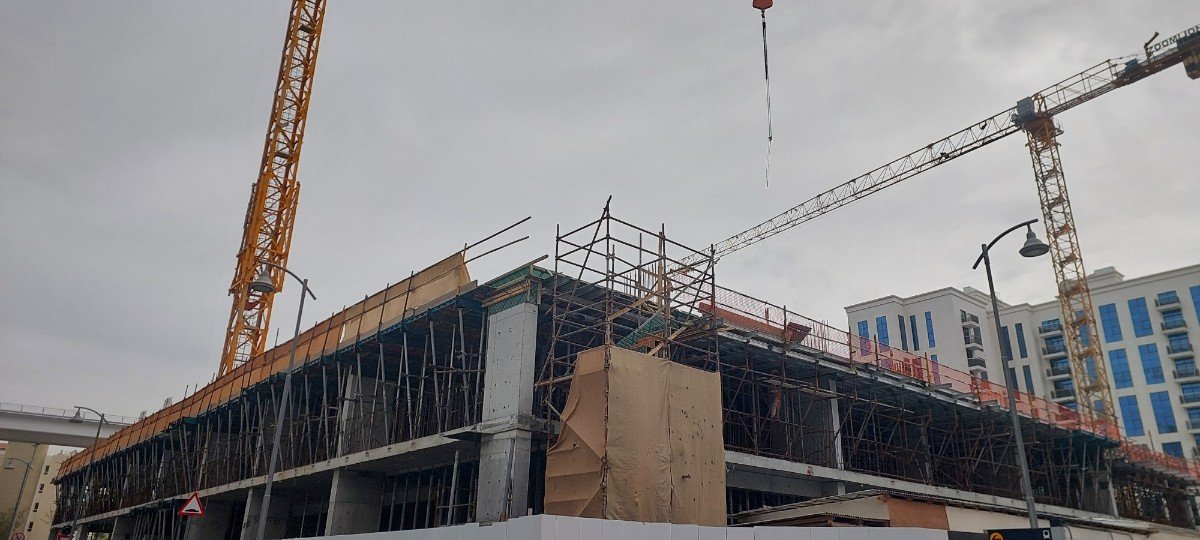

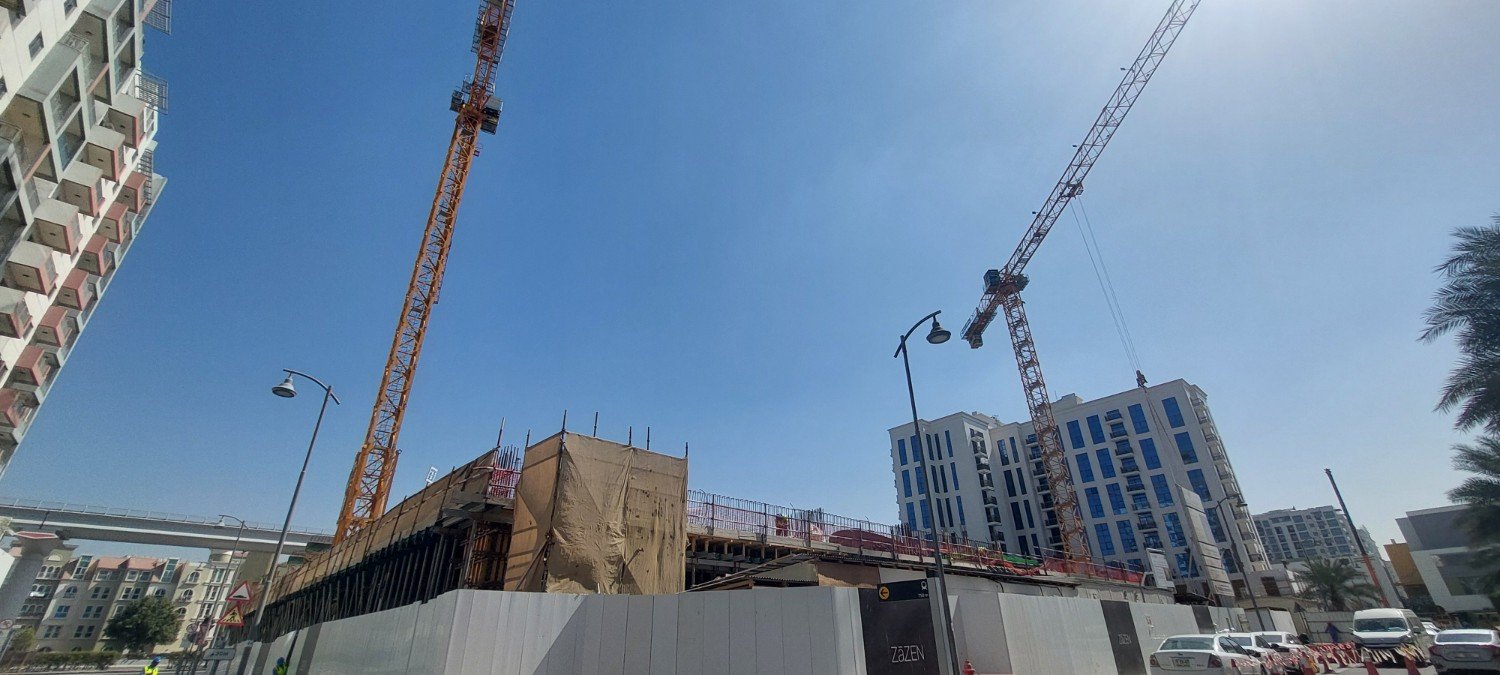

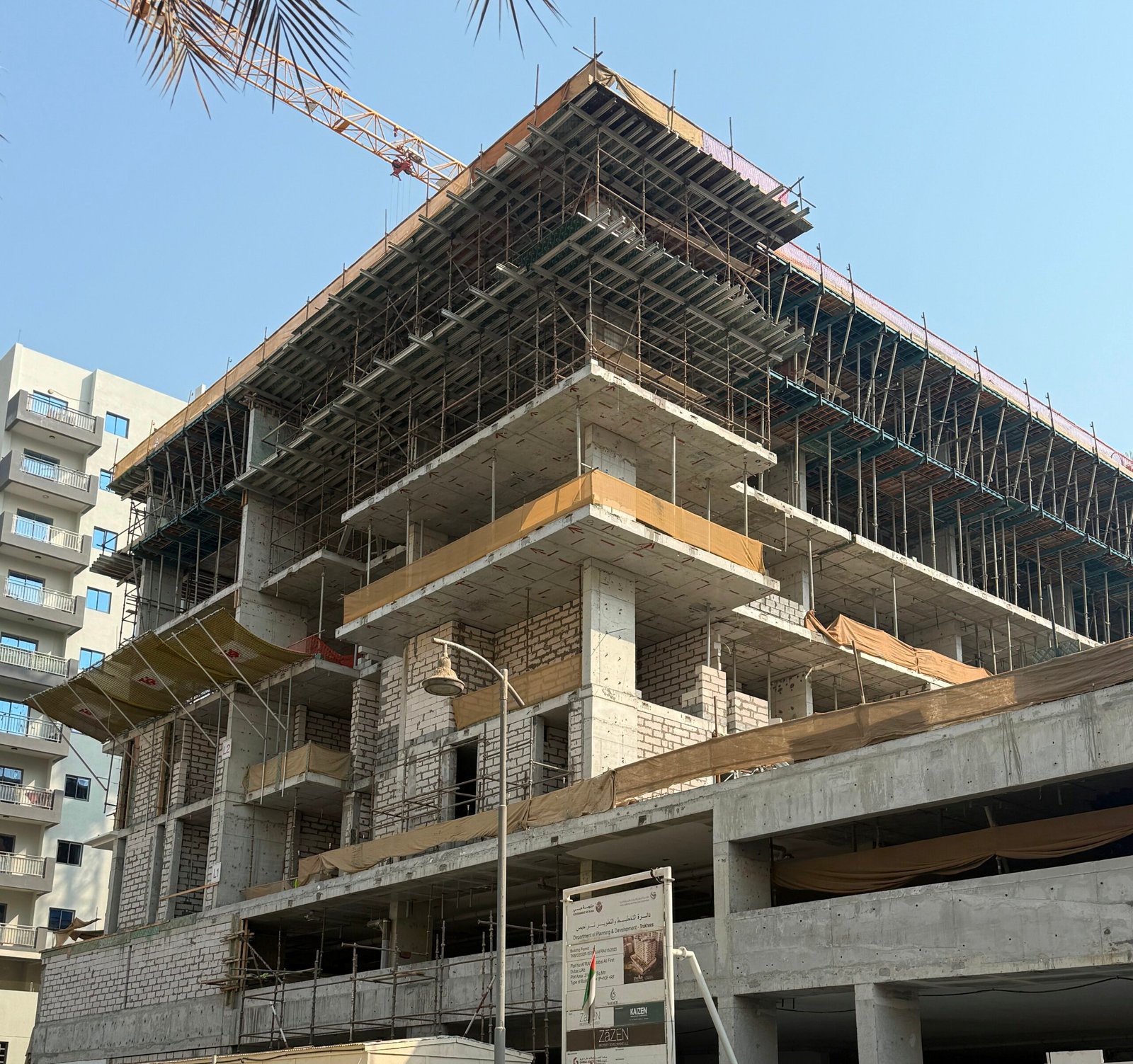

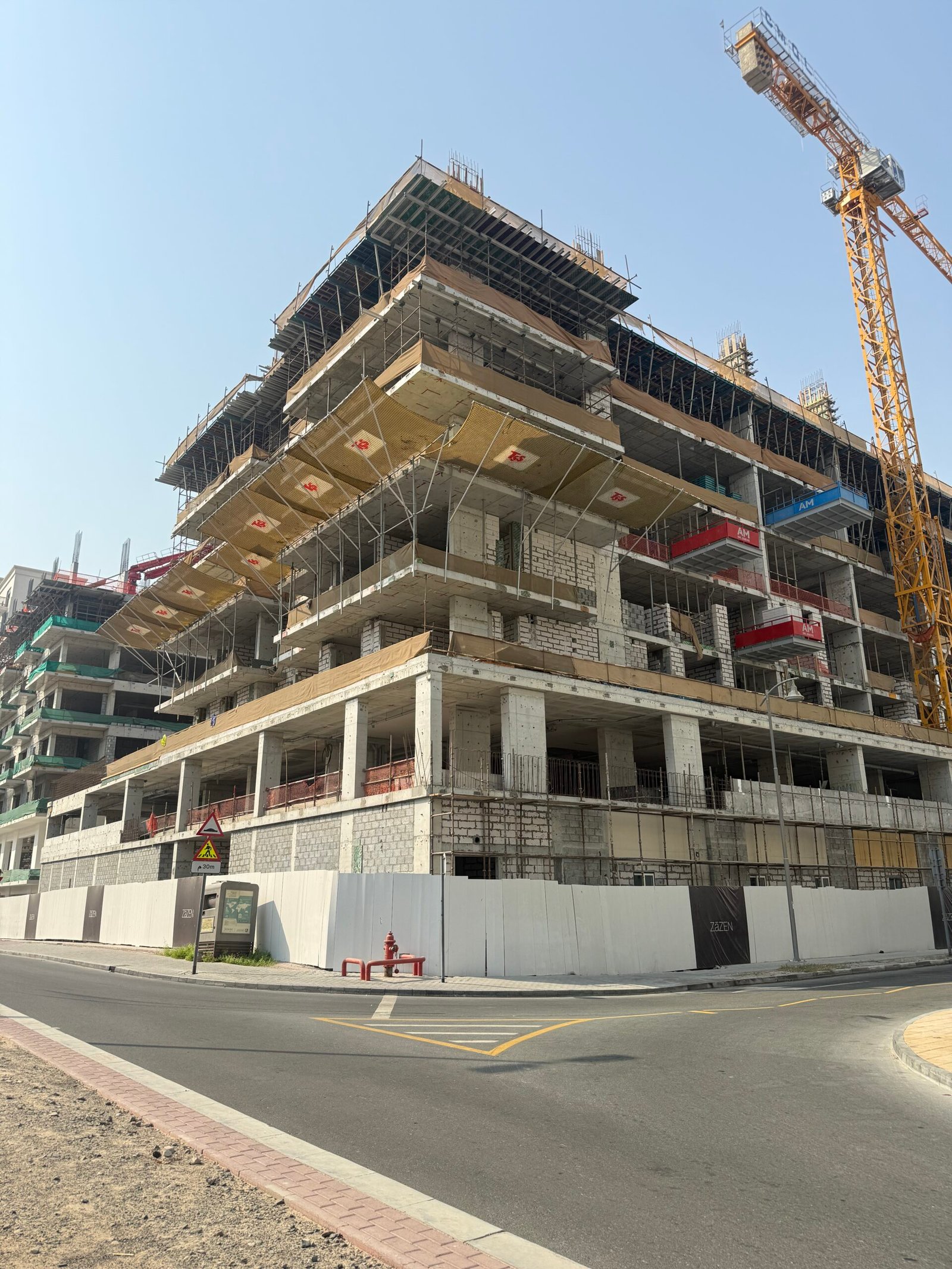

Tower Crane

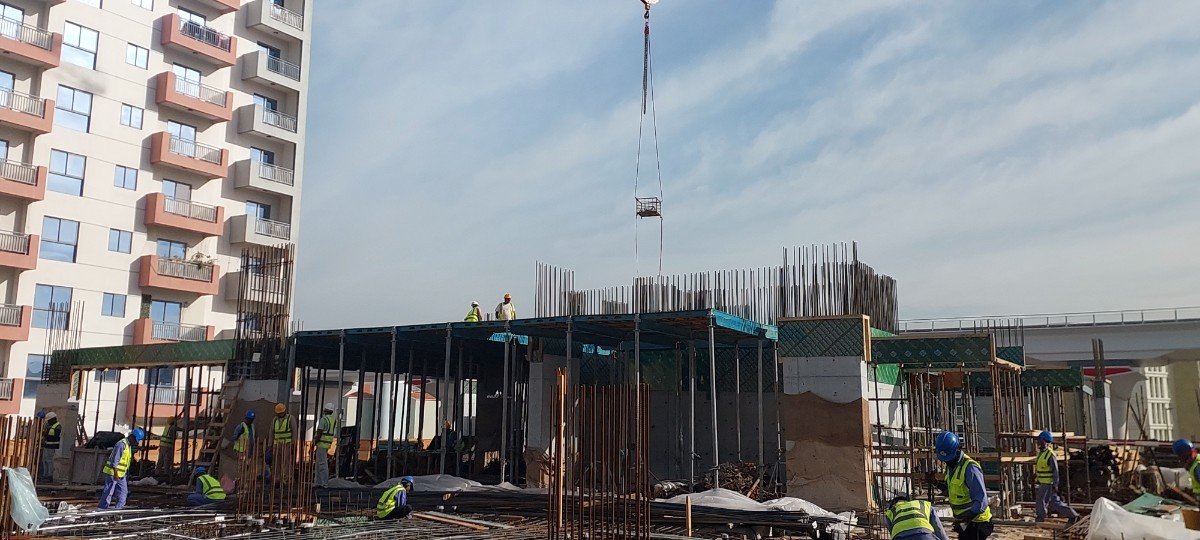

  • Installation of tower crane – 100% completed

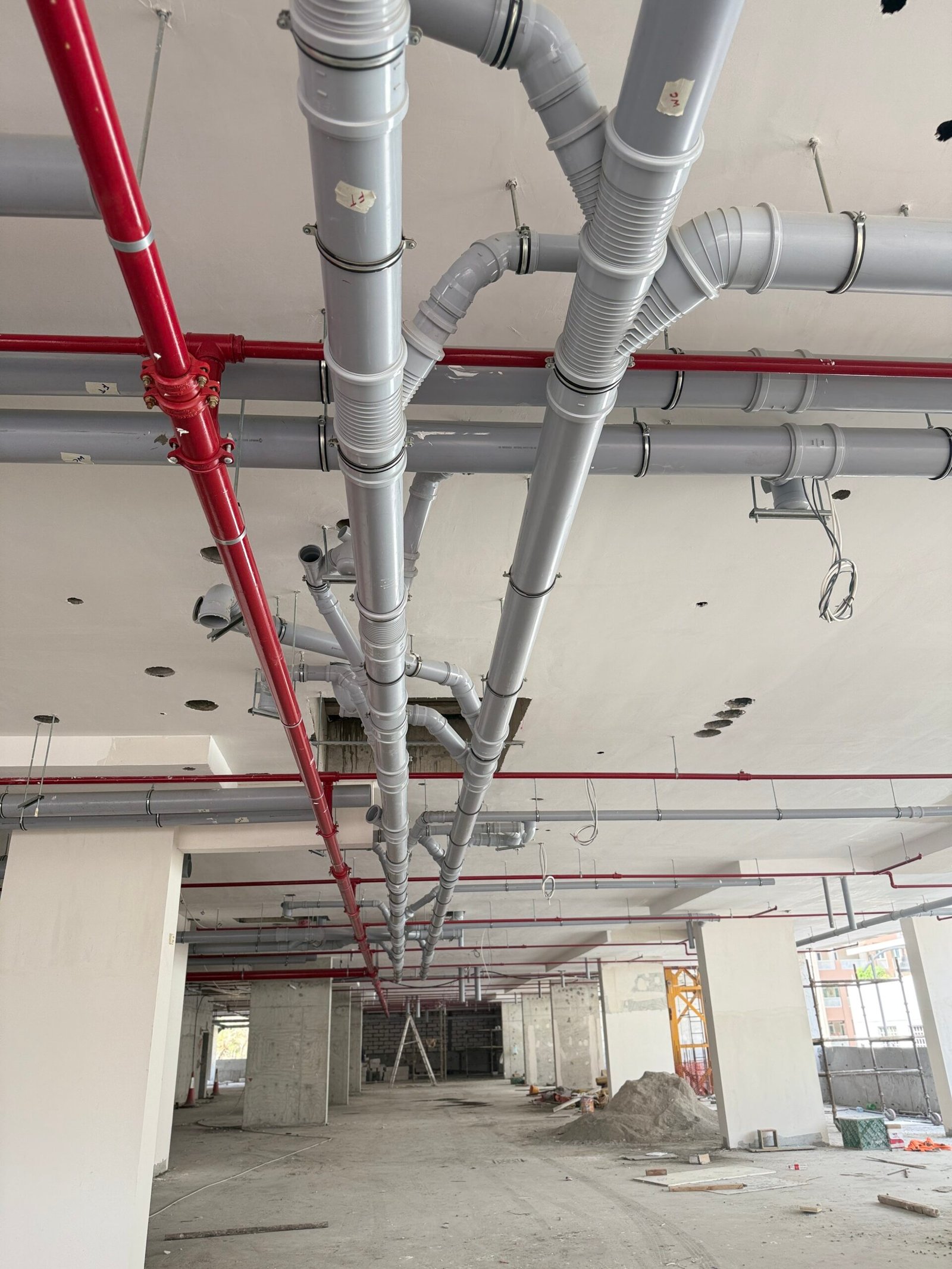

  • Electrical works, testing & commissioning, anti-collision system & zoning – 50% completed

Launched

July 2025

Planned Handover

March 2027

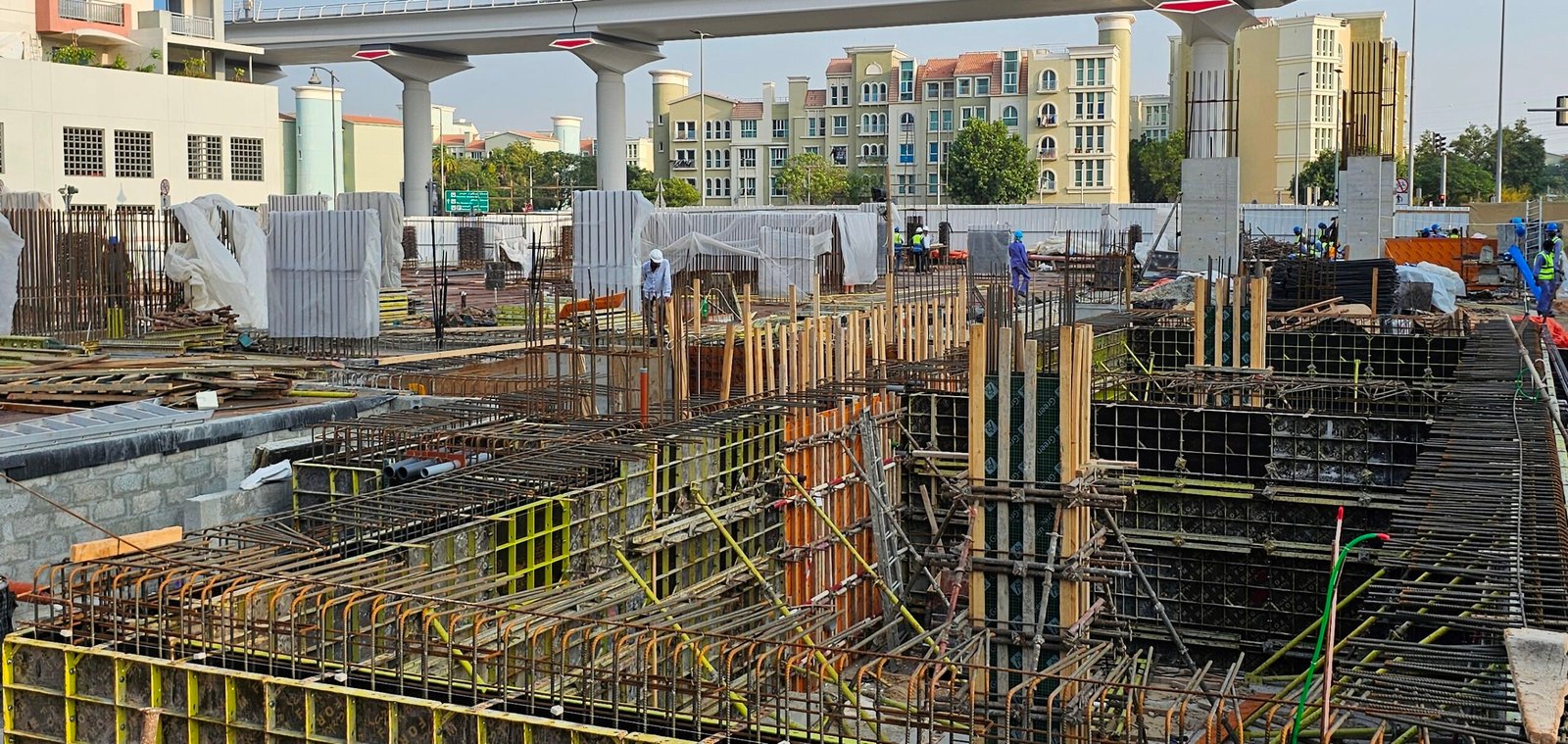

Progress

12.50%

Stage

Dewatering Works
  • Dewatering – Under progress
Roadbase & Compaction Works
  • Isolated footing – 90% completed
PCC Works
  • PCC below isolated footing – 90% completed
Waterproofing Works

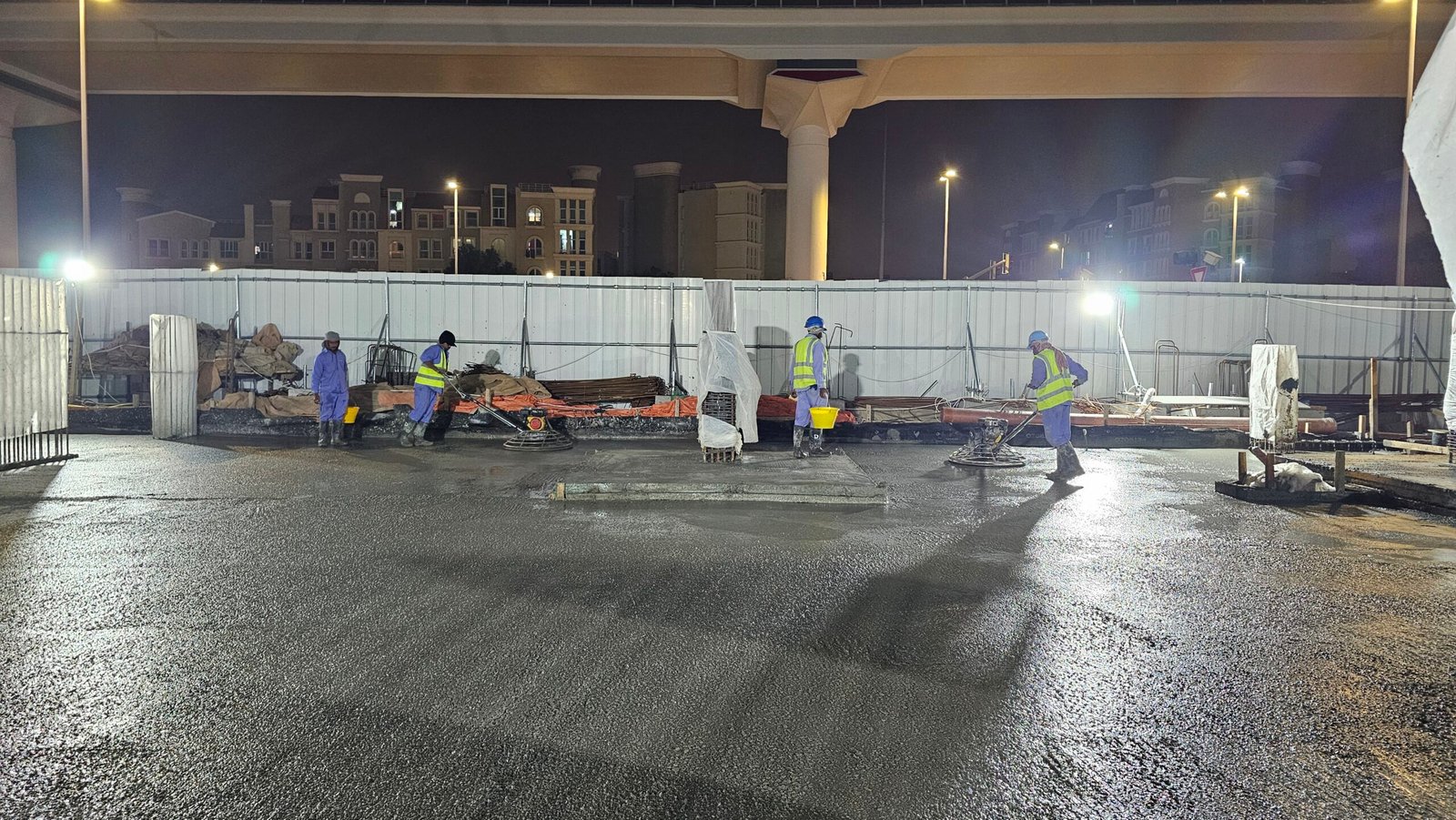

  • Waterproofing membrane below main raft foundation – 100% completed
  • Waterproofing for isolated footing – 75% completed

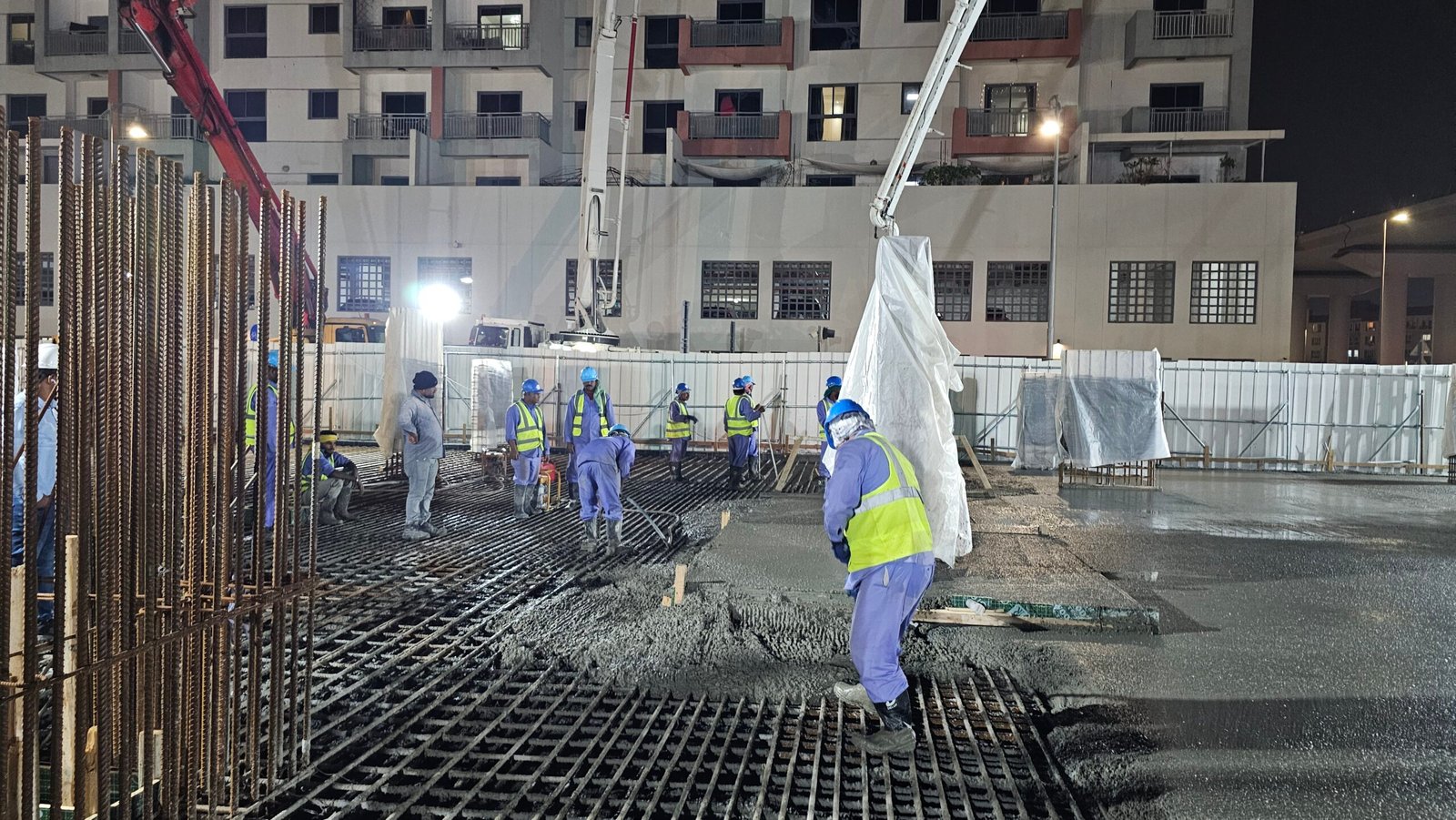

Reinforcement & Concrete Works
  • Main raft & underground raft concrete casting – 100% completed
  • Steel reinforcement work for isolated footing – 85% completed
  • Isolated footing concrete casting – 85% completed
  • Steel reinforcement work for neck column at isolated footing – 80% completed
  • Neck column concrete casting at isolated footing – 80% completed
Underground Water Tank & Pump Room
  • Reinforcement work for wall – 100% completed
  • Shuttering work for wall – 90% completed
  • Concrete casting for wall – 0% completed
Ground Floor

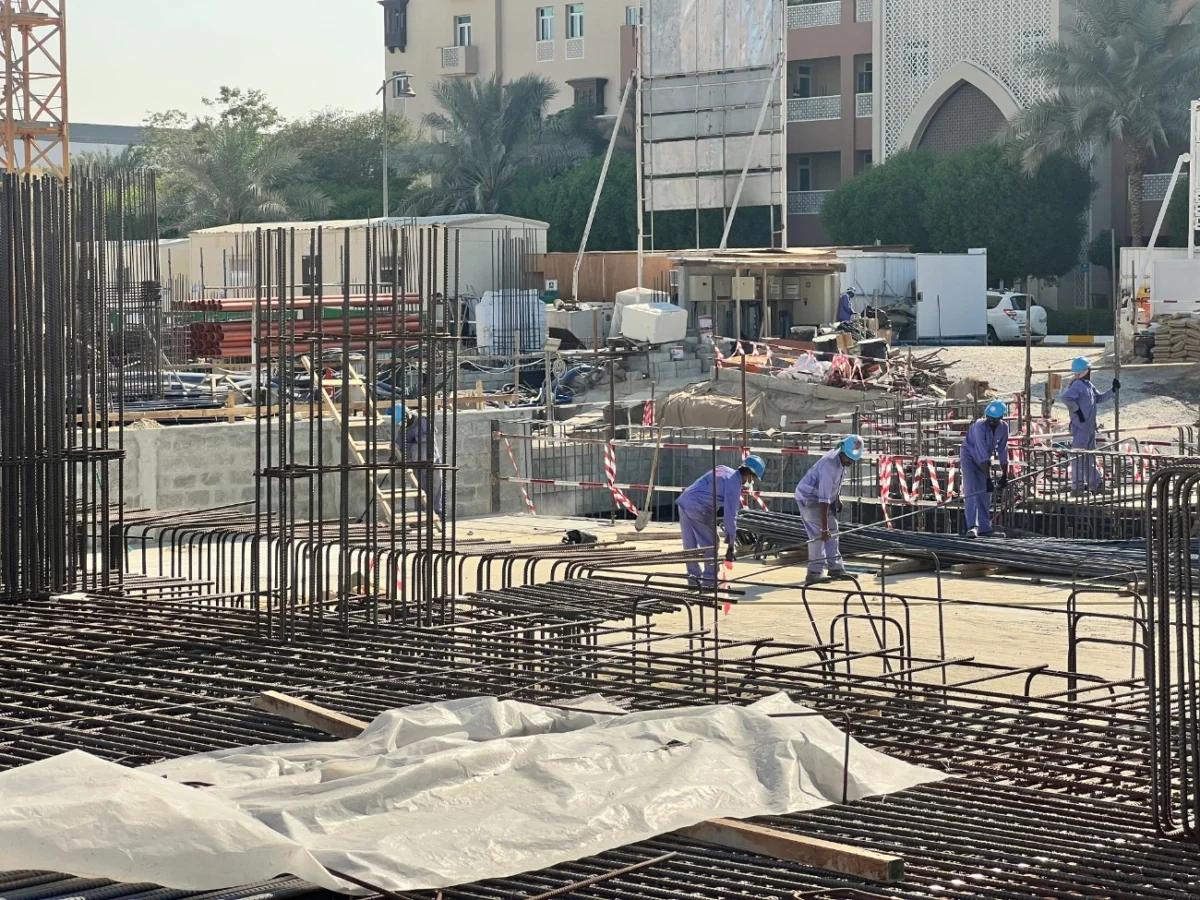

  • Reinforcement work for ground floor columns – 20% completed

Construction start

July 2025

Planned completion

March 2027

Progress

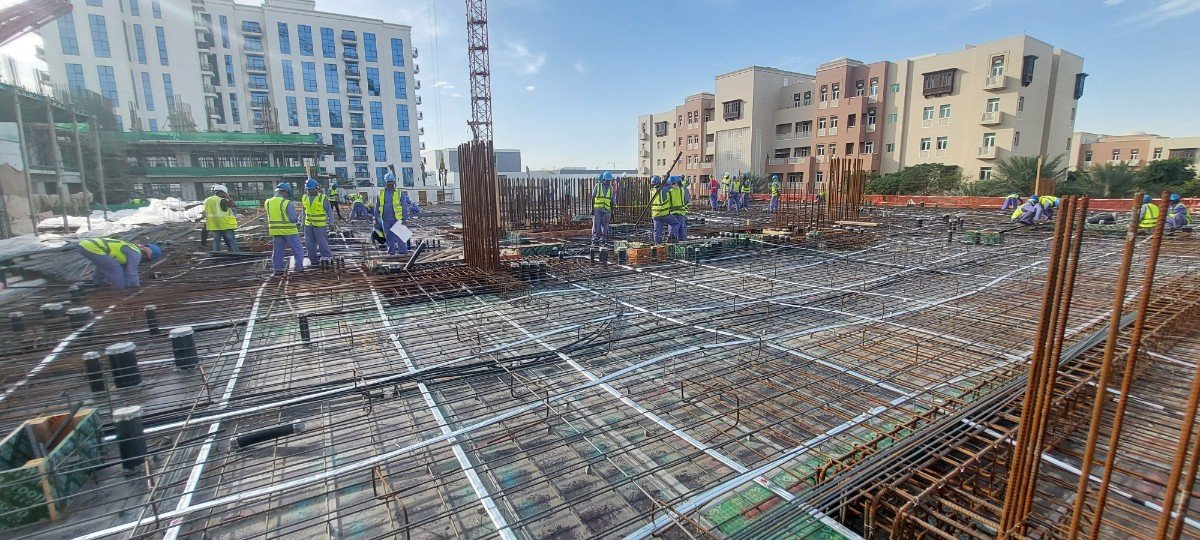

9.50%

Stage

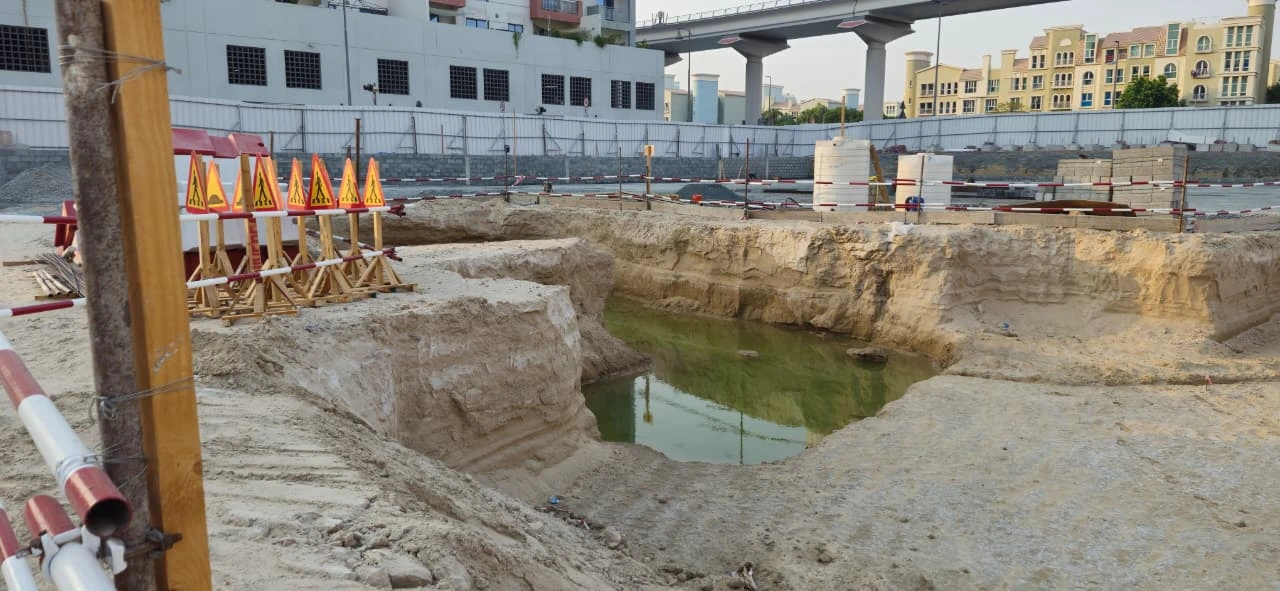

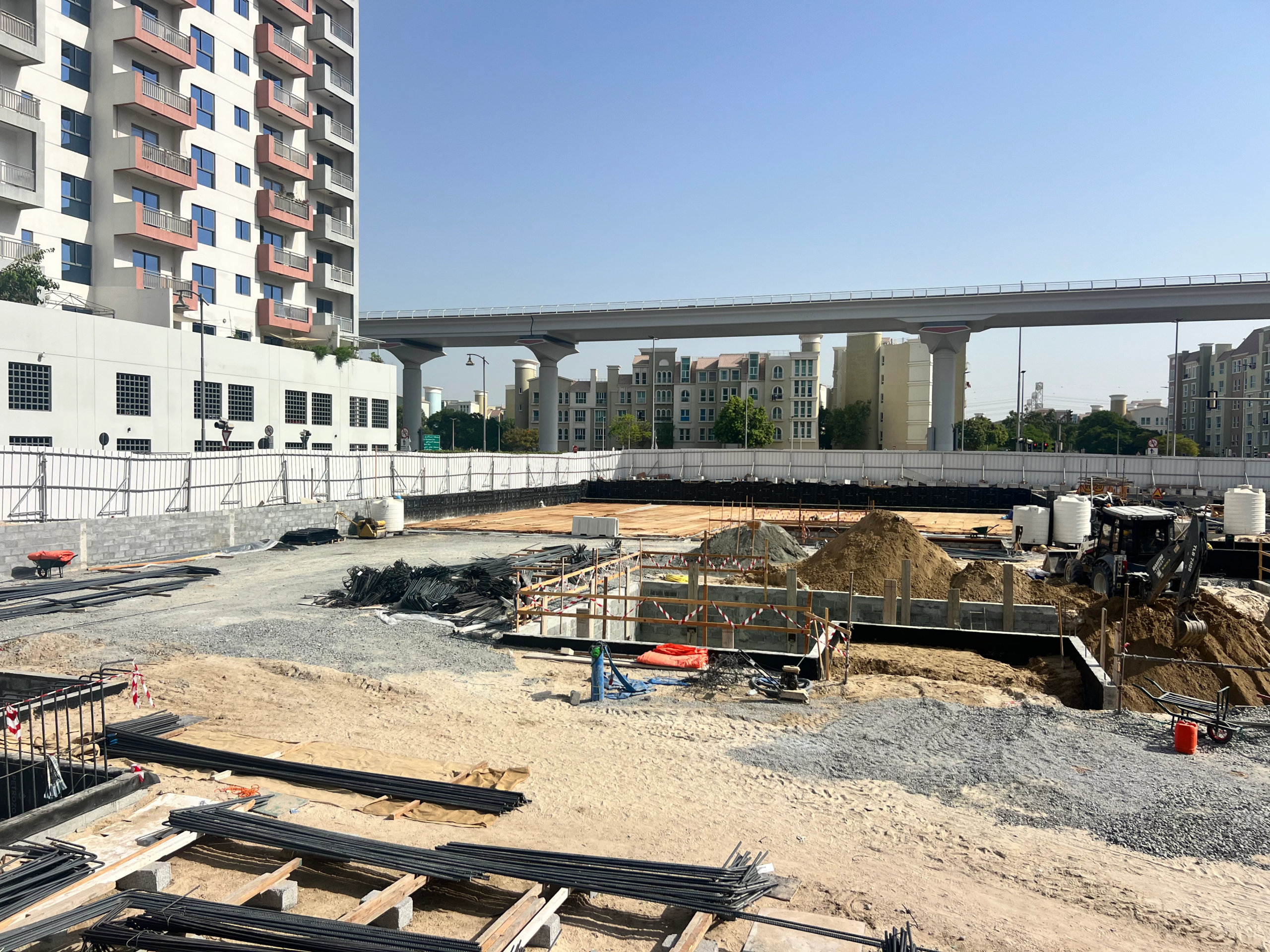

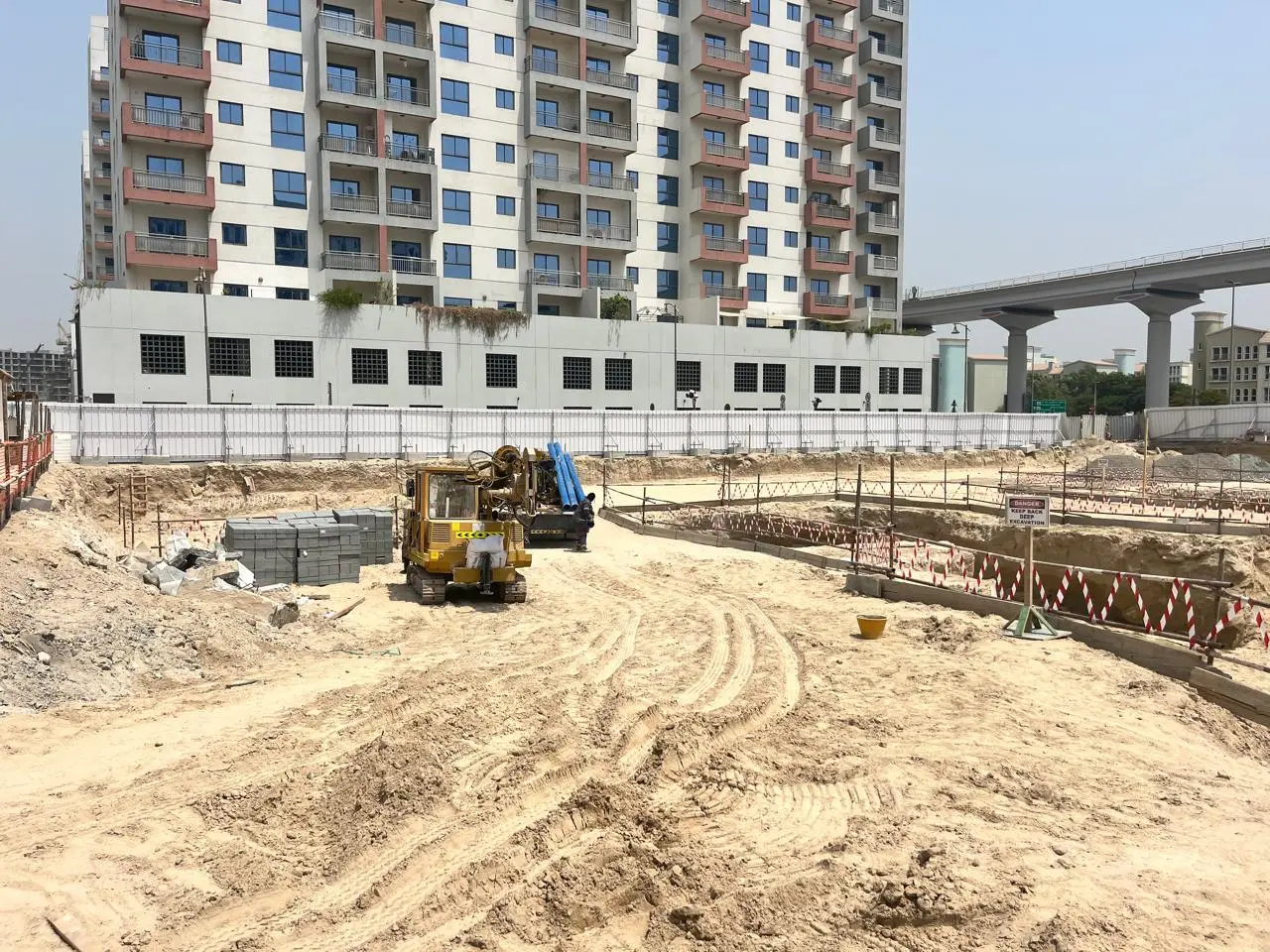

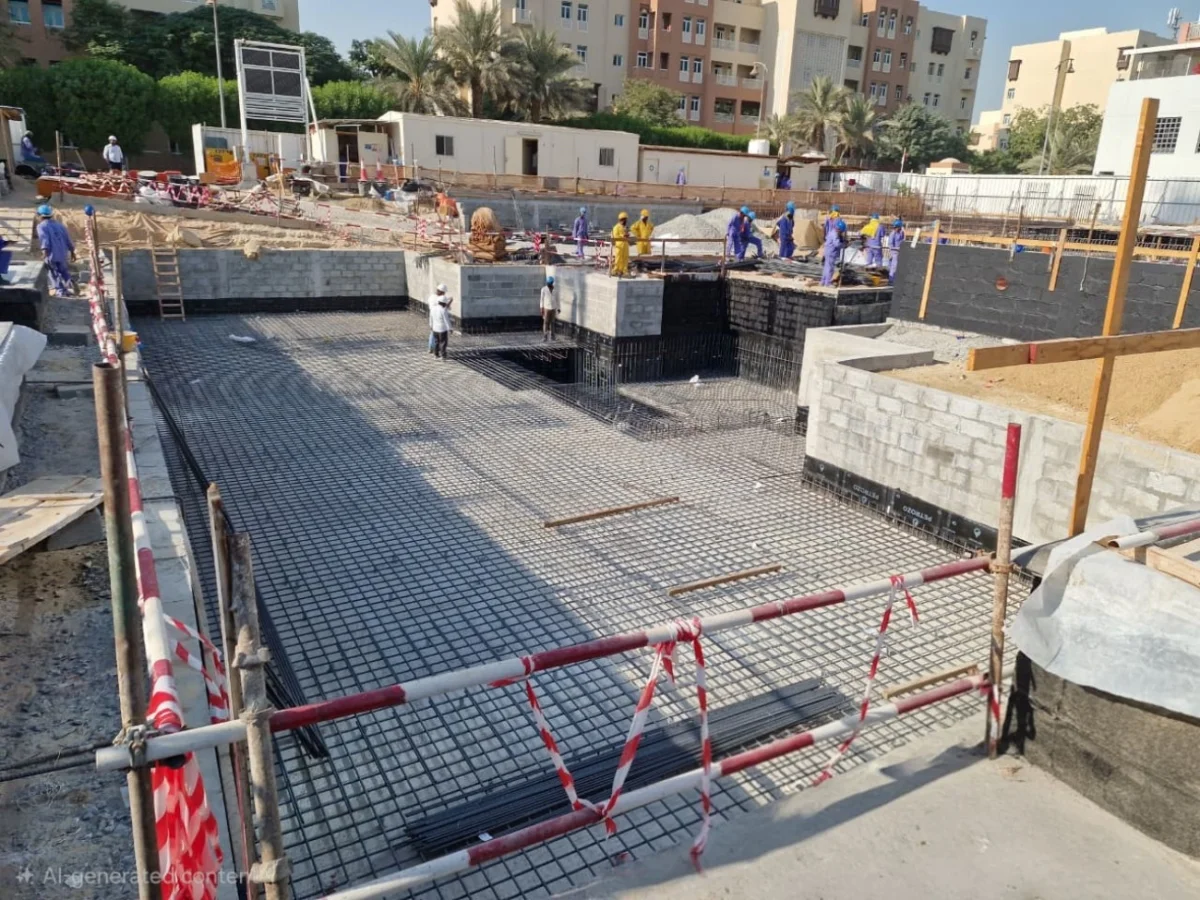

Excavation works:
  • Main raft area – 100% completed
  • Staircase & UG water tank – 100% completed
  • UG pump room & sump pit – 100% completed
Dewatering works:
Dewatering – under progress.
Road base & compaction works:
  • Main raft foundation area – 80% completed
  • Isolated footing – 90% completed
  • UG water tank & pump room – 90% completed

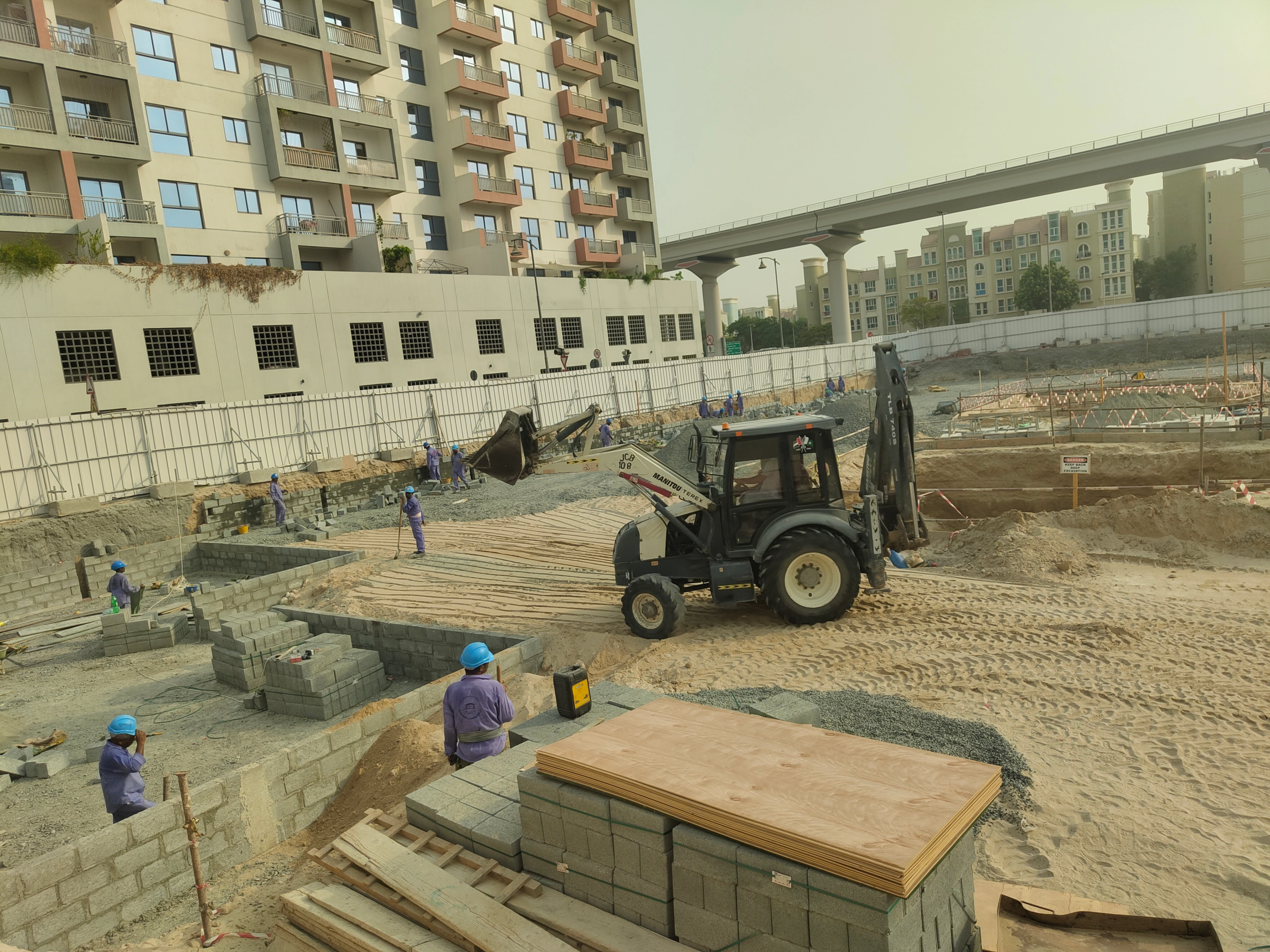

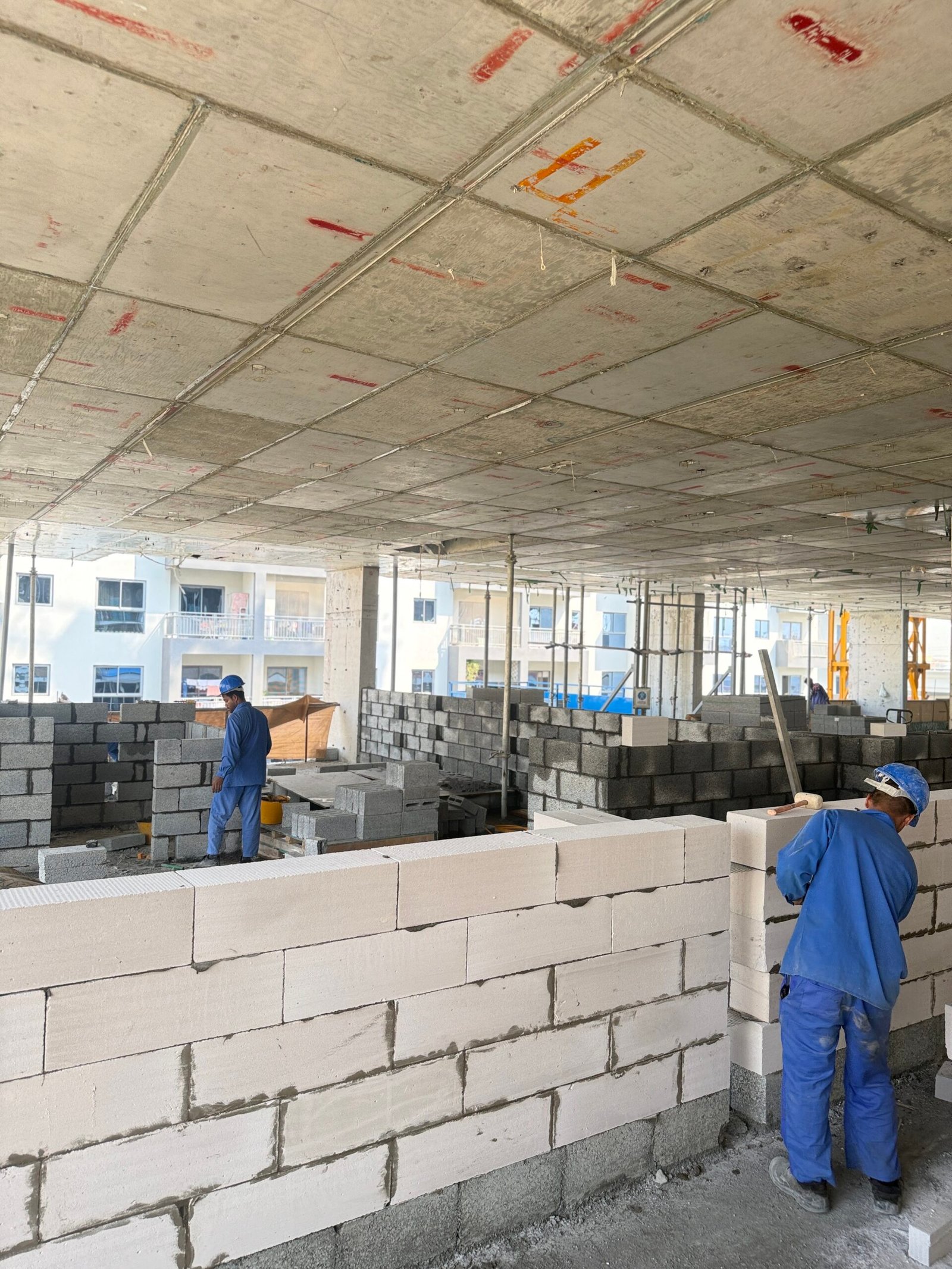

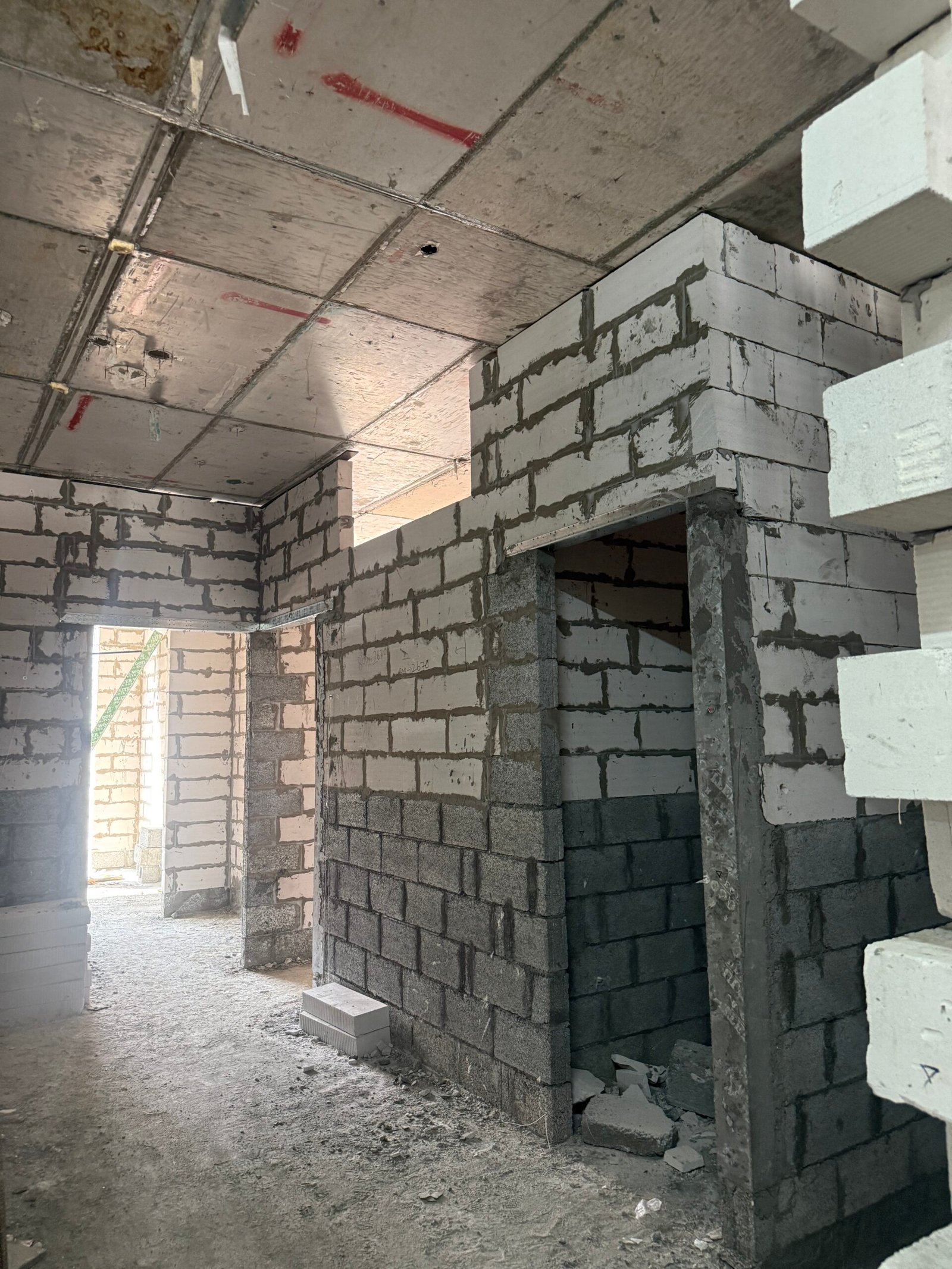

Solid block works:

Solid block works for main raft area – 100% completed

  • PCC works:
  • PCC below raft foundation – 85% completed
  • PCC below isolated footing – 85% completed
Waterproofing & reinforcement works:

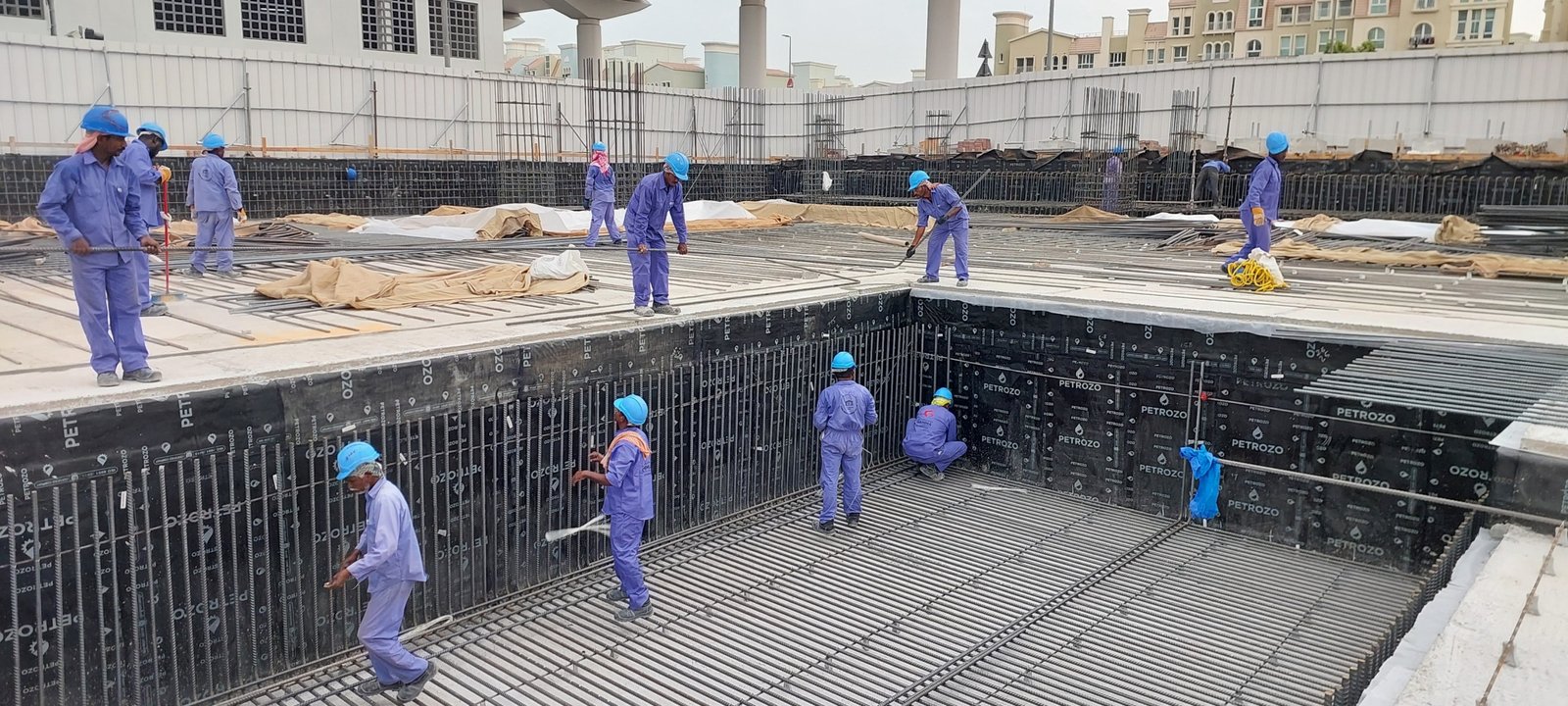

  • Waterproofing membrane below main raft foundation – 70% completed
  • Waterproofing membrane for isolated footing – 75% completed

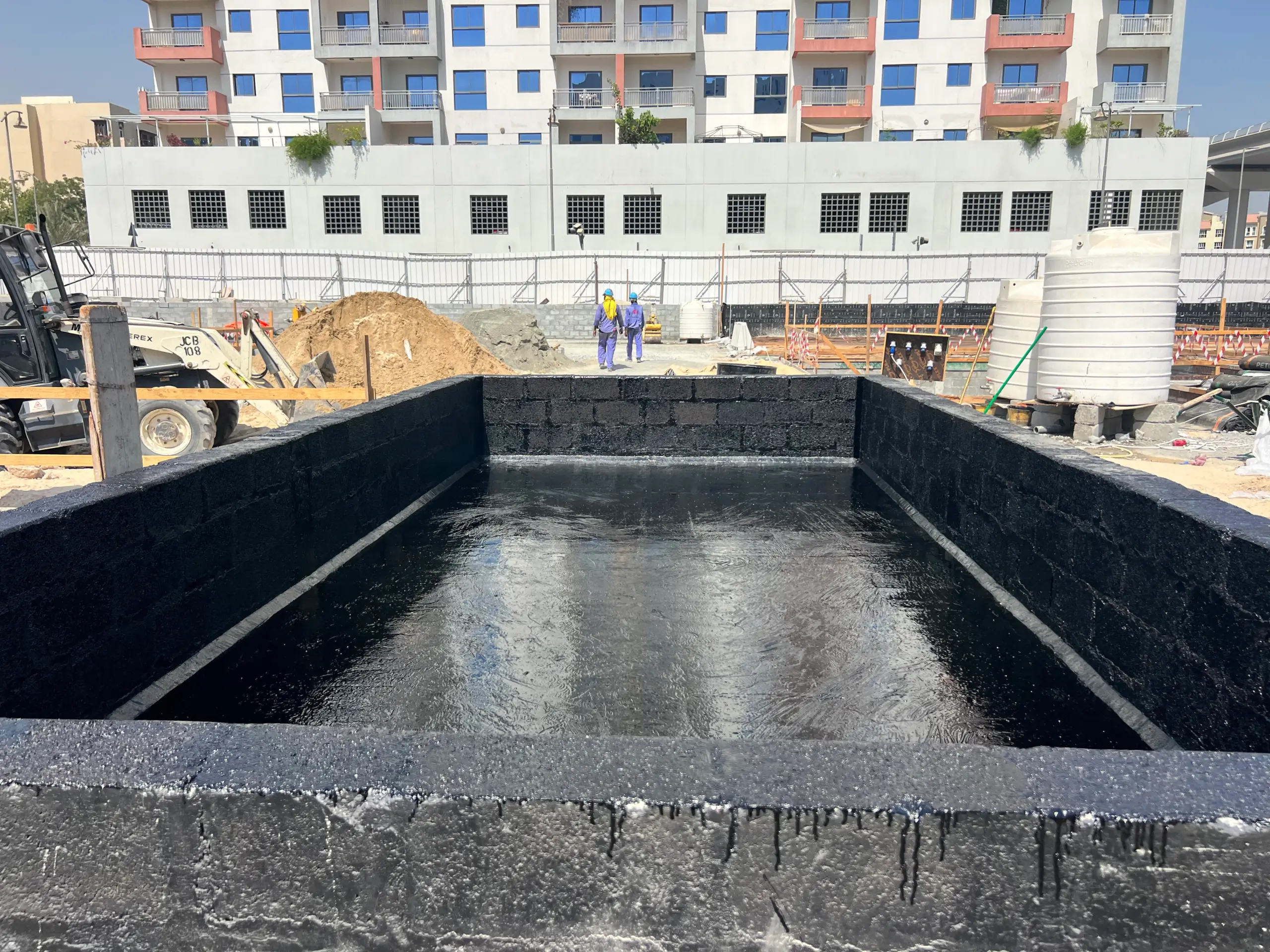

  • Waterproofing membrane for UG tank & pump room – 100% completed
Reinforcement & concrete works:
  • Steel reinforcement work for the isolated footing & substation – 75% completed
  • Steel reinforcement work for raft – 65% completed
  • Steel reinforcement work for neck column at isolated footing – 80% completed
  • Isolated footing concrete casting – 75% completed
  • Neck column concrete casting at isolated footing – 80% completed

Construction start

July 2025

Planned completion

March 2027

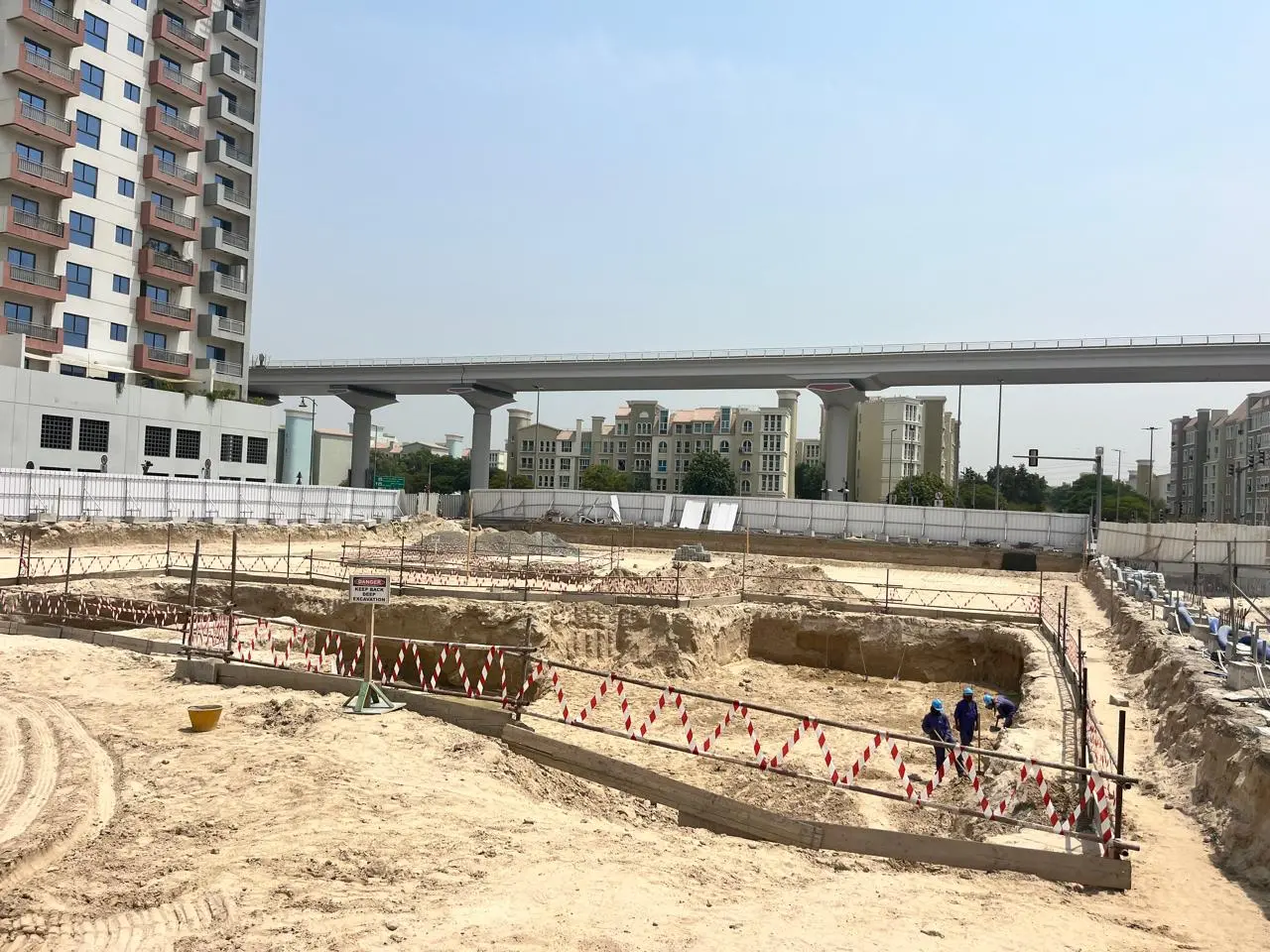

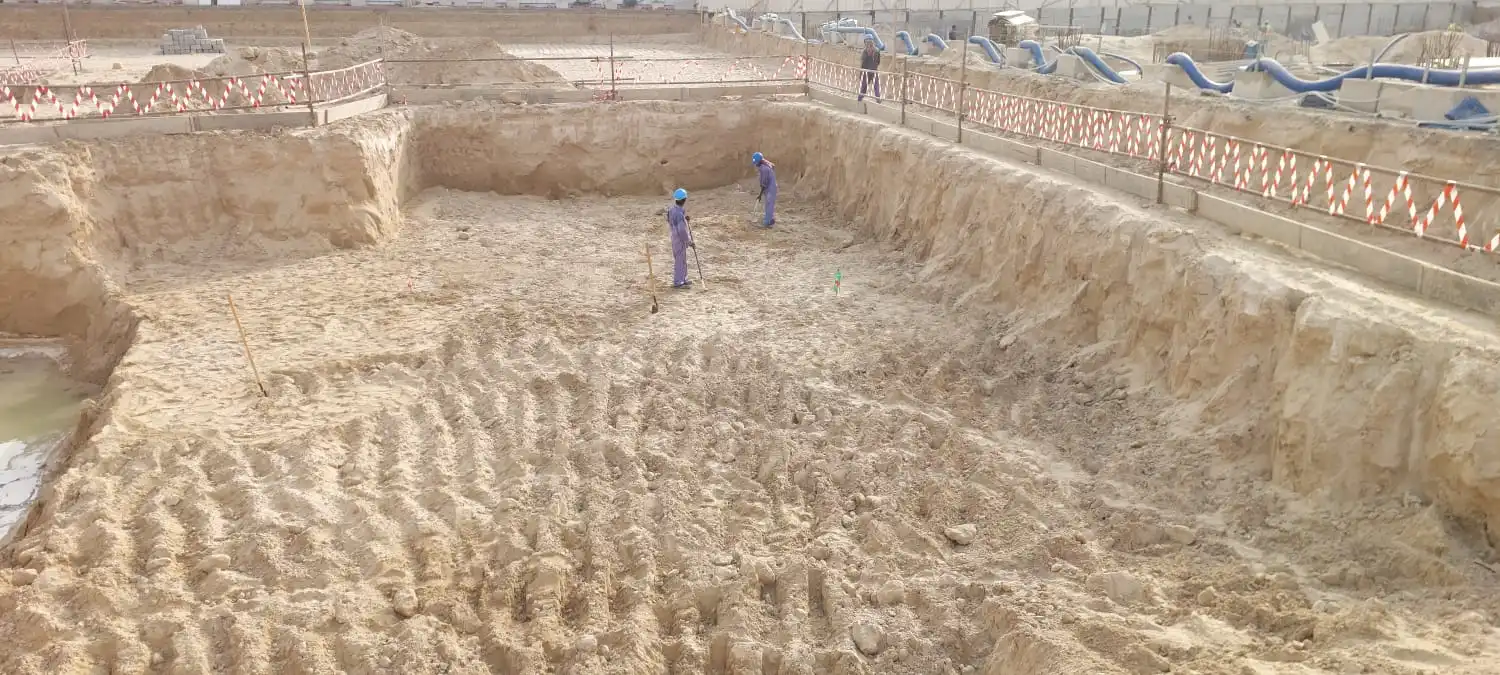

Excavation works:

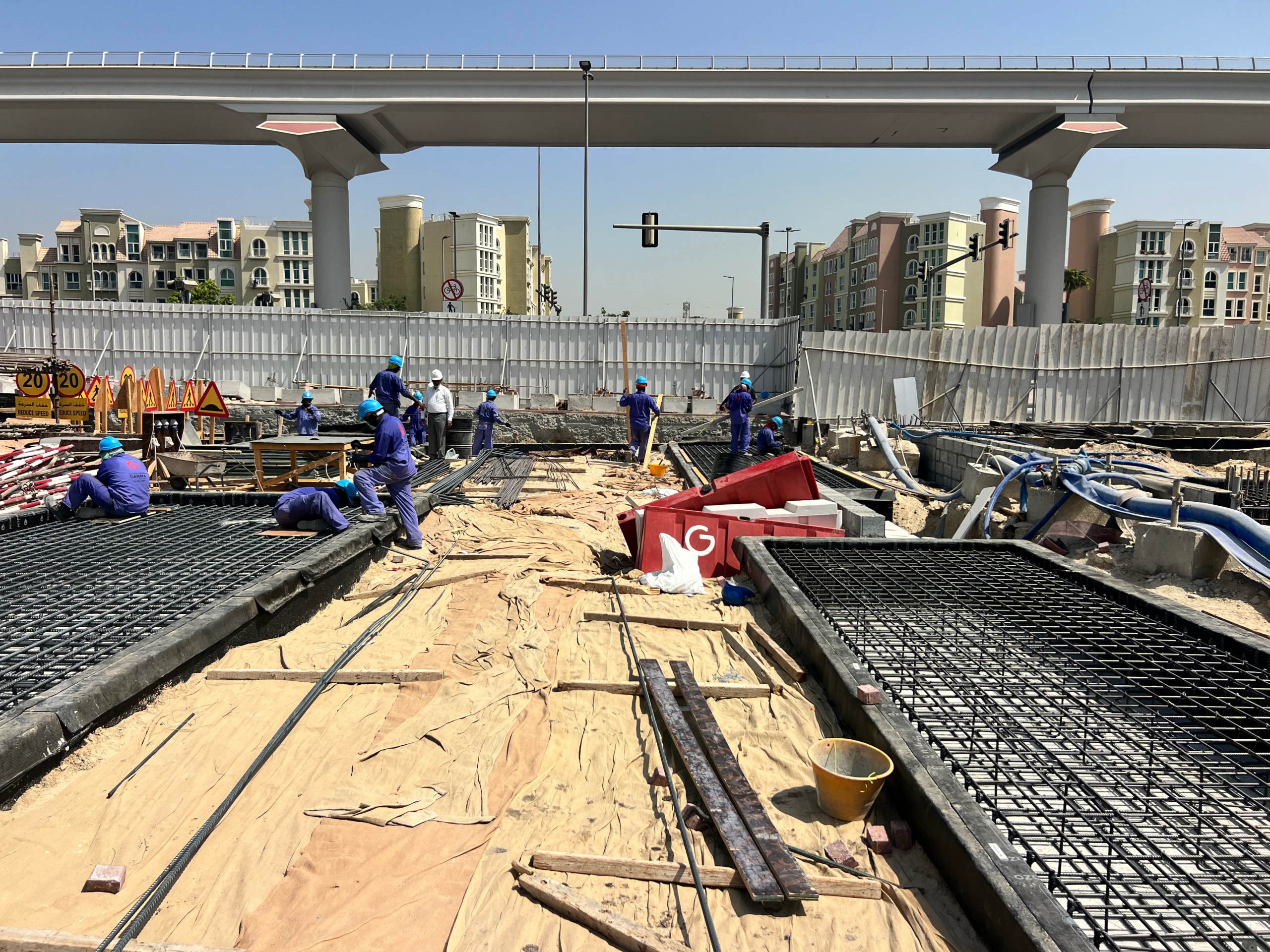

6.50%

Stage

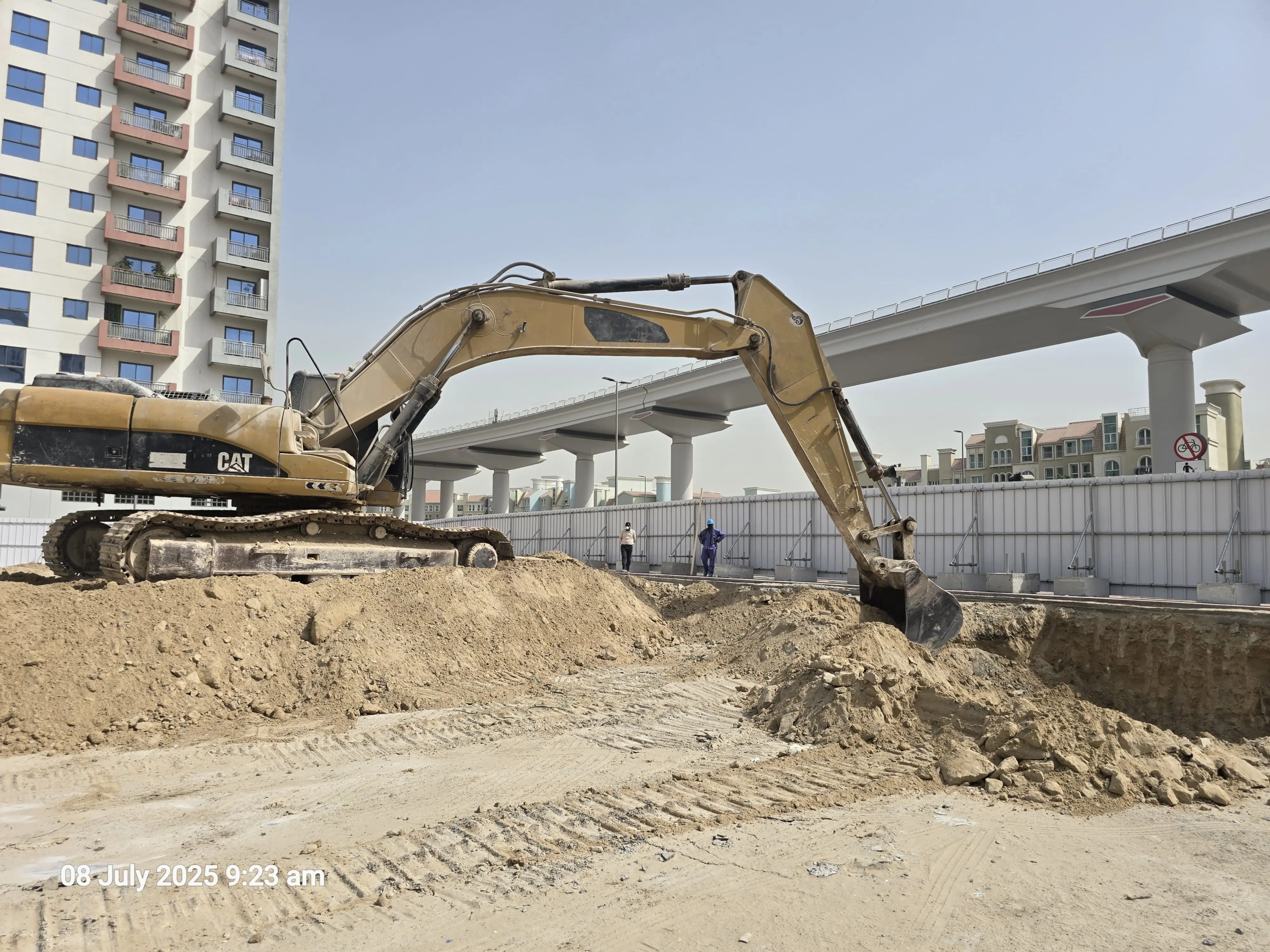

Excavation works:
Main raft area – 90% completed
UG pump room & sump pit – 90% completed
Solid block works:
Solid block works for main raft area – 75% completed

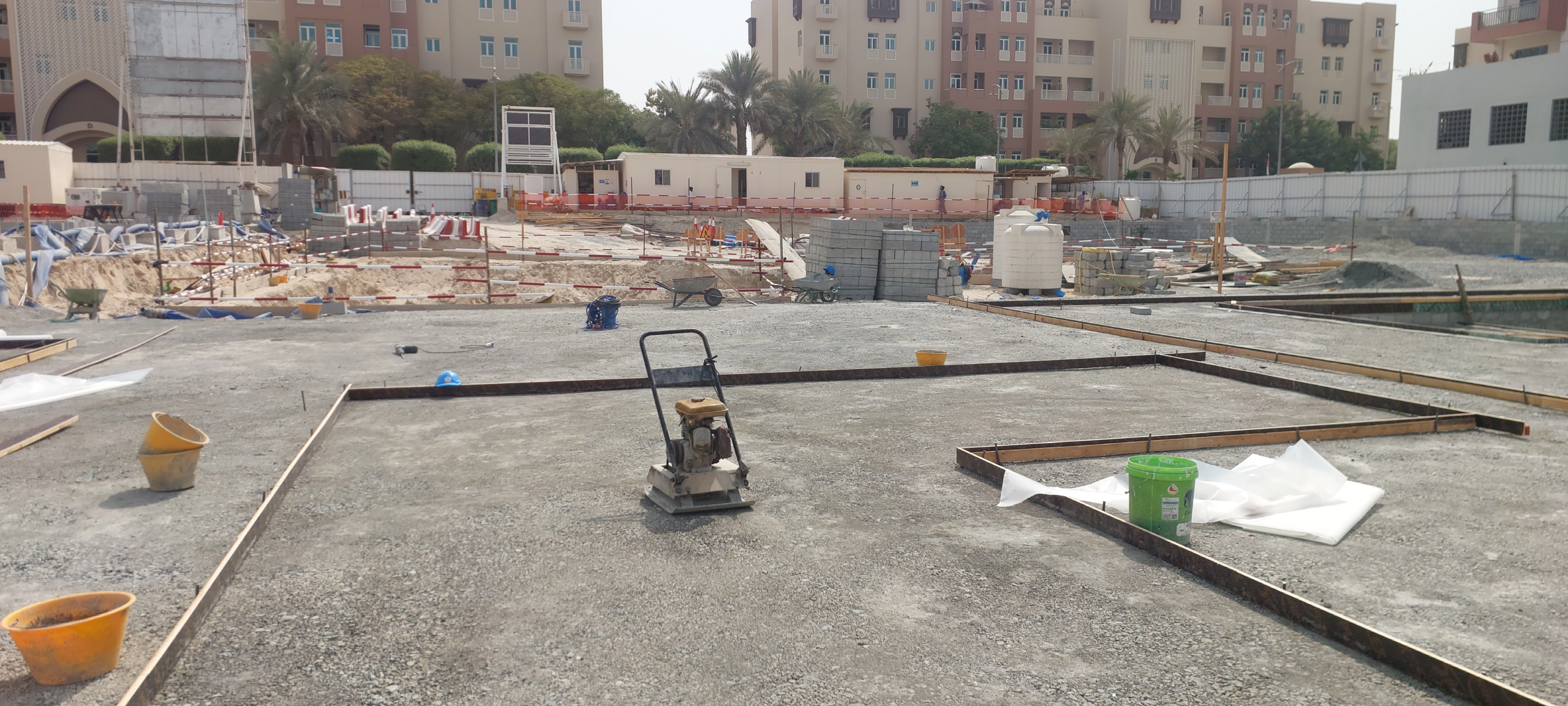

PCC works:

PCC below raft foundation – 70% completed
PCC below isolated footing – 85% completed
Waterproofing & reinforcement works:

Waterproofing membrane below main raft foundation – 55% completed
Waterproofing membrane for isolated footing – 75% completed

  • PCC works:
  • PCC below raft foundation – 85% completed
  • PCC below isolated footing – 85% completed
Reinforcement & concrete works:
  • Steel reinforcement work for the isolated footing & substation – 75% completed
  • Steel reinforcement work for raft – 30% completed
  • Steel reinforcement work for neck column at isolated footing – 80% completed
  • Isolated footing concrete casting – 75% completed
  • Neck column concrete casting at isolated footing – 80% completed

Construction start

July 2025

Planned completion

March 2027

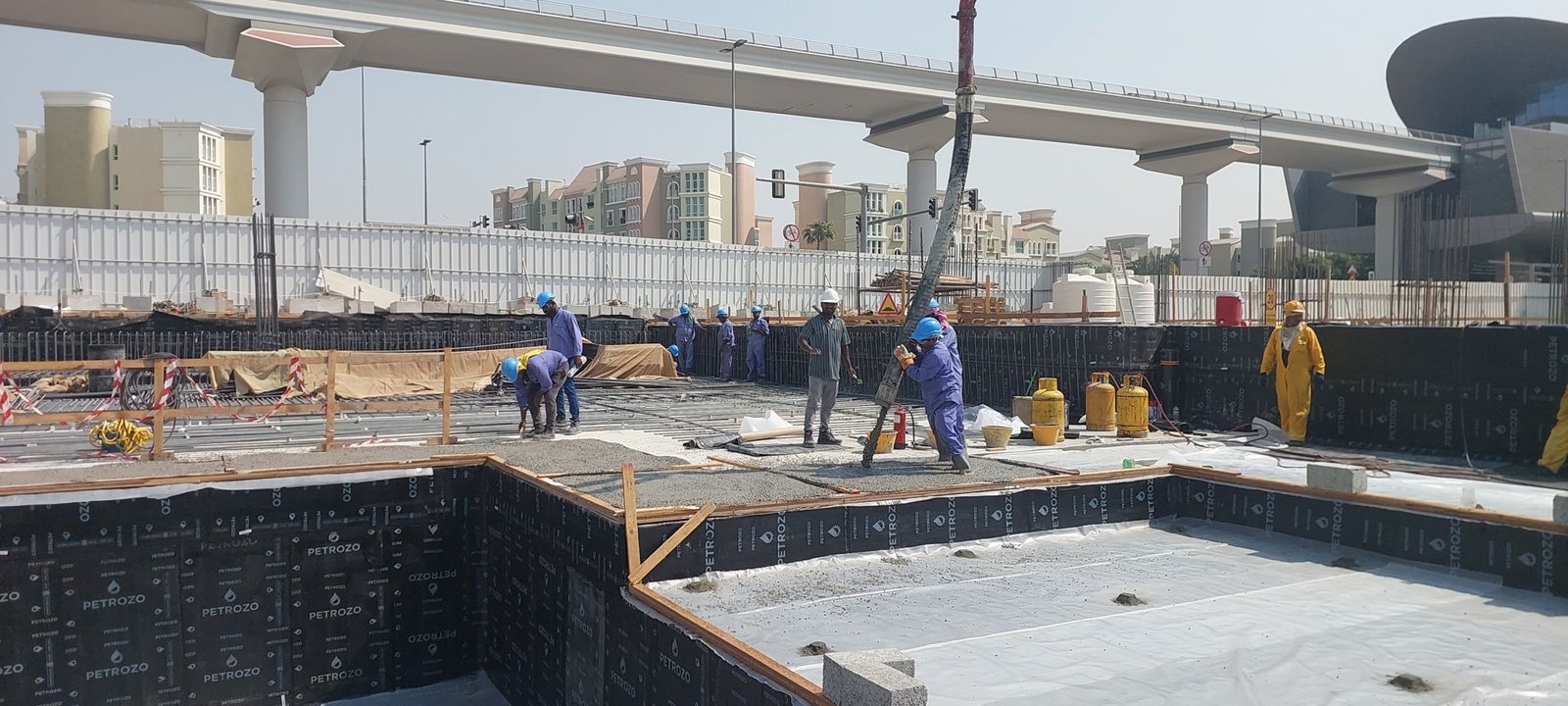

Progress

5.15%

Progress

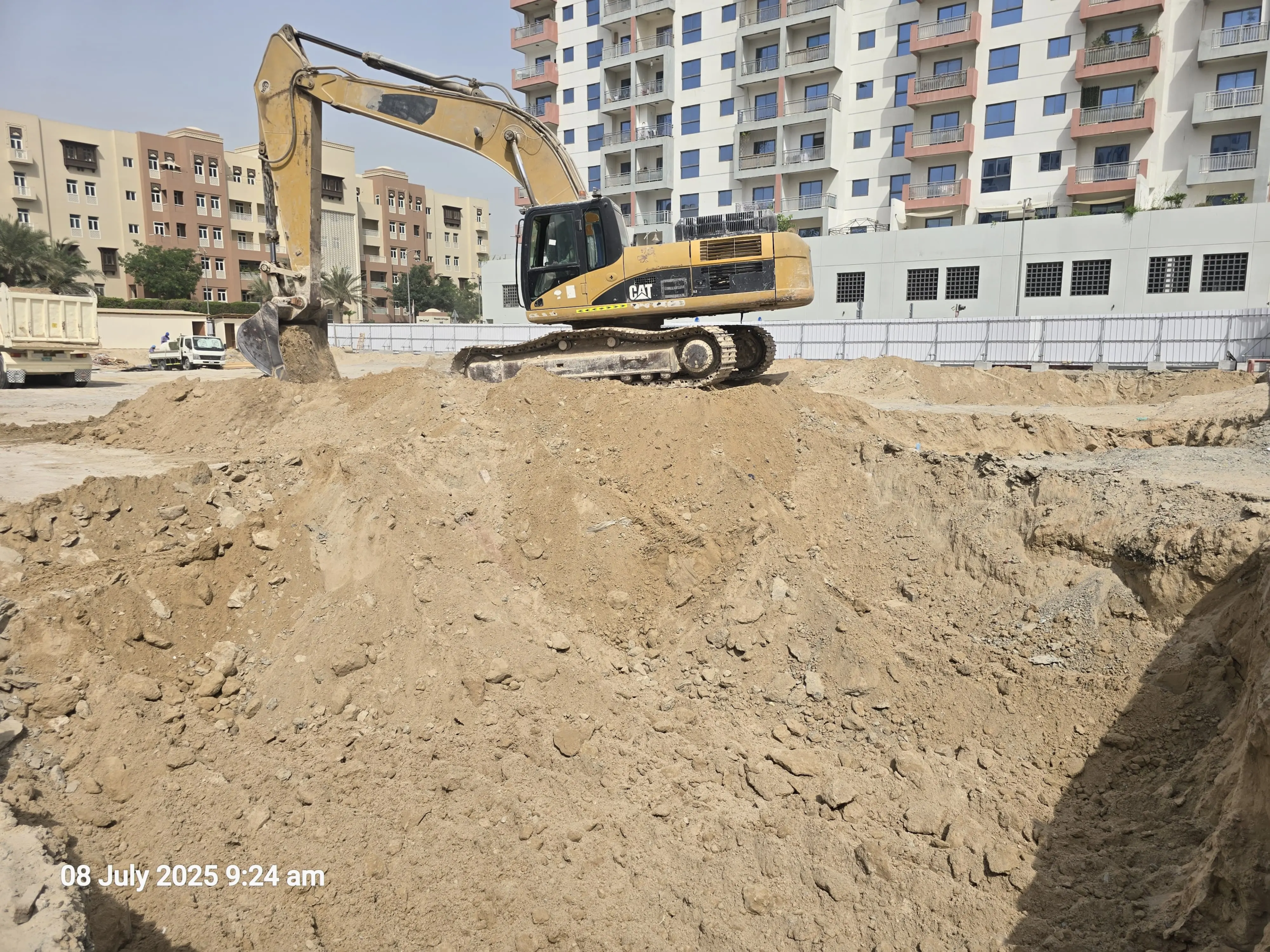

Excavation works:
  • Main raft area – 85% completed
  • Staircase & UG water tank – 100% completed.
  • UG pump room & sump pit – 80% completed.
Dewatering works:
Dewatering – under progress.
Road base & compaction works:
  • Main raft foundation area – 80% completed
  • Isolated footing – 85% completed
  • UG staircase – 100% completed.
  • UG water tank & pump room – 80% completed
Solid block works:

Solid block works for main raft area – 75% completed

  • PCC works:
  • PCC below raft foundation – 75% completed
  • PCC below isolated footing – 85% completed
Waterproofing & reinforcement works:
  • Waterproofing membrane below main raft foundation – 50% completed
  • Waterproofing membrane for isolated footing – 75% completed
  • Steel reinforcement work for the isolated footing & substation – 50% completed.

Construction start

July 2025

Planned completion

March 2027

Progress

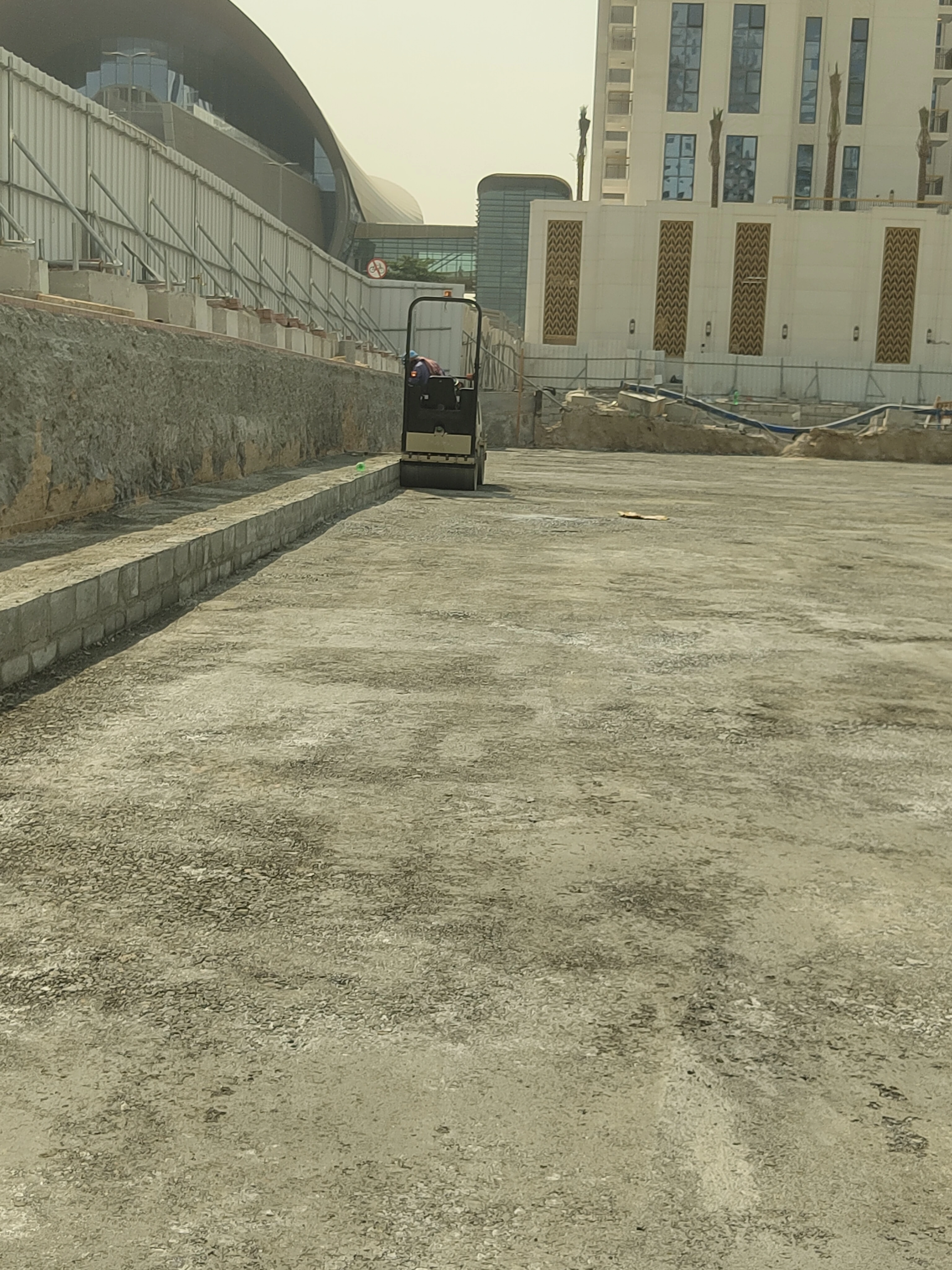

2.86%

Stage

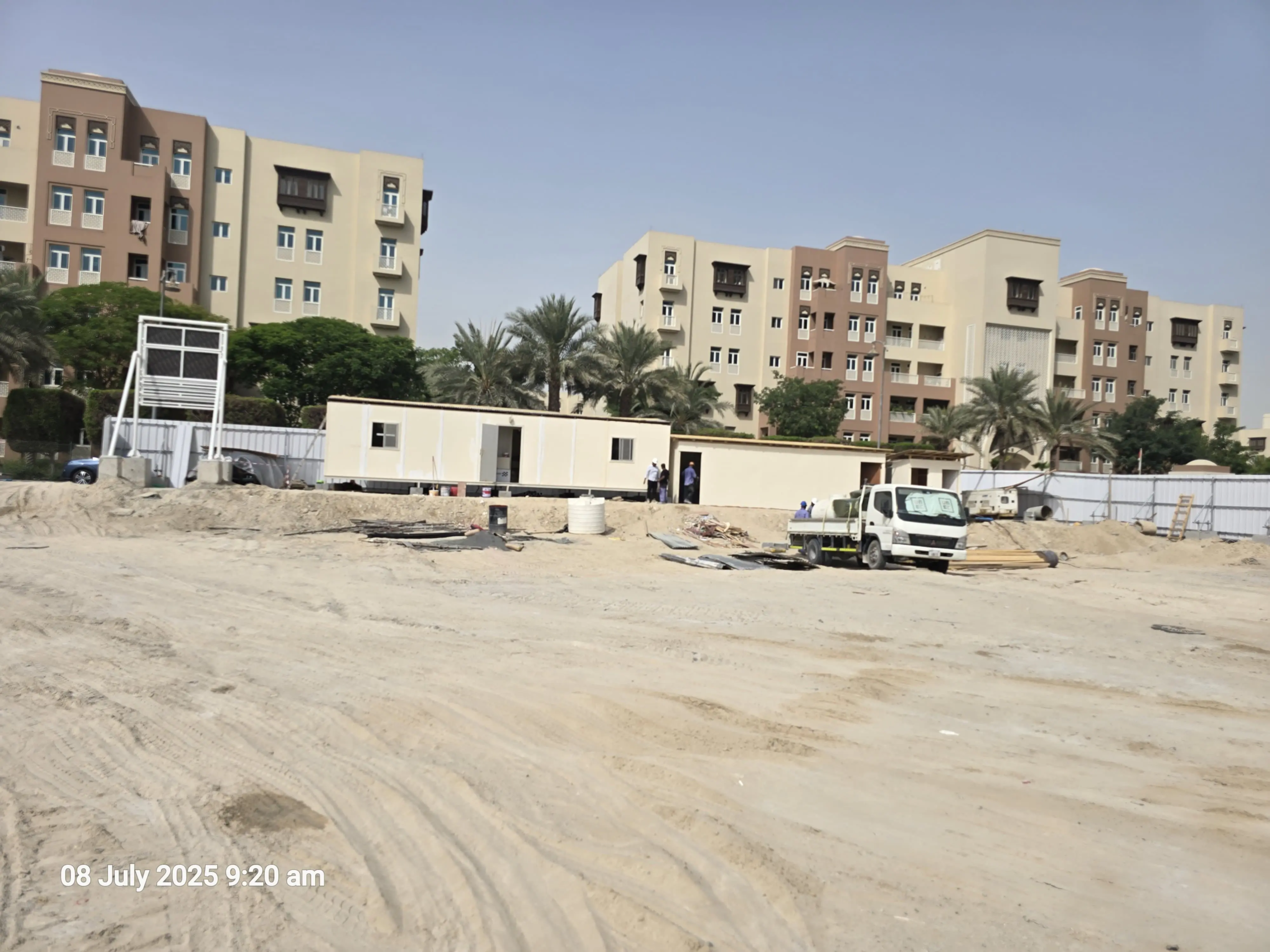

Mobilization works
  • Site office, 100% completed.
Excavation works:
  • Excavation for lift pit, 100% completed.
  • Excavation for water tank & pump room, 50% completed.
  • Compaction of main excavation area, 50% completed.
Dewatering works:
  • Mobilization for dewatering works, 100% completed.
  • Dewatering, under progress.
Roadbase works
  • Compaction, leveling and laying of roadbase, 50% completed.
Solid block works

Substation and lift area, 50% completed.

  • PCC works:
  • PCC work below the raft foundation, 50% completed.

Construction start

July 2025

Planned completion

March 2027

Progress

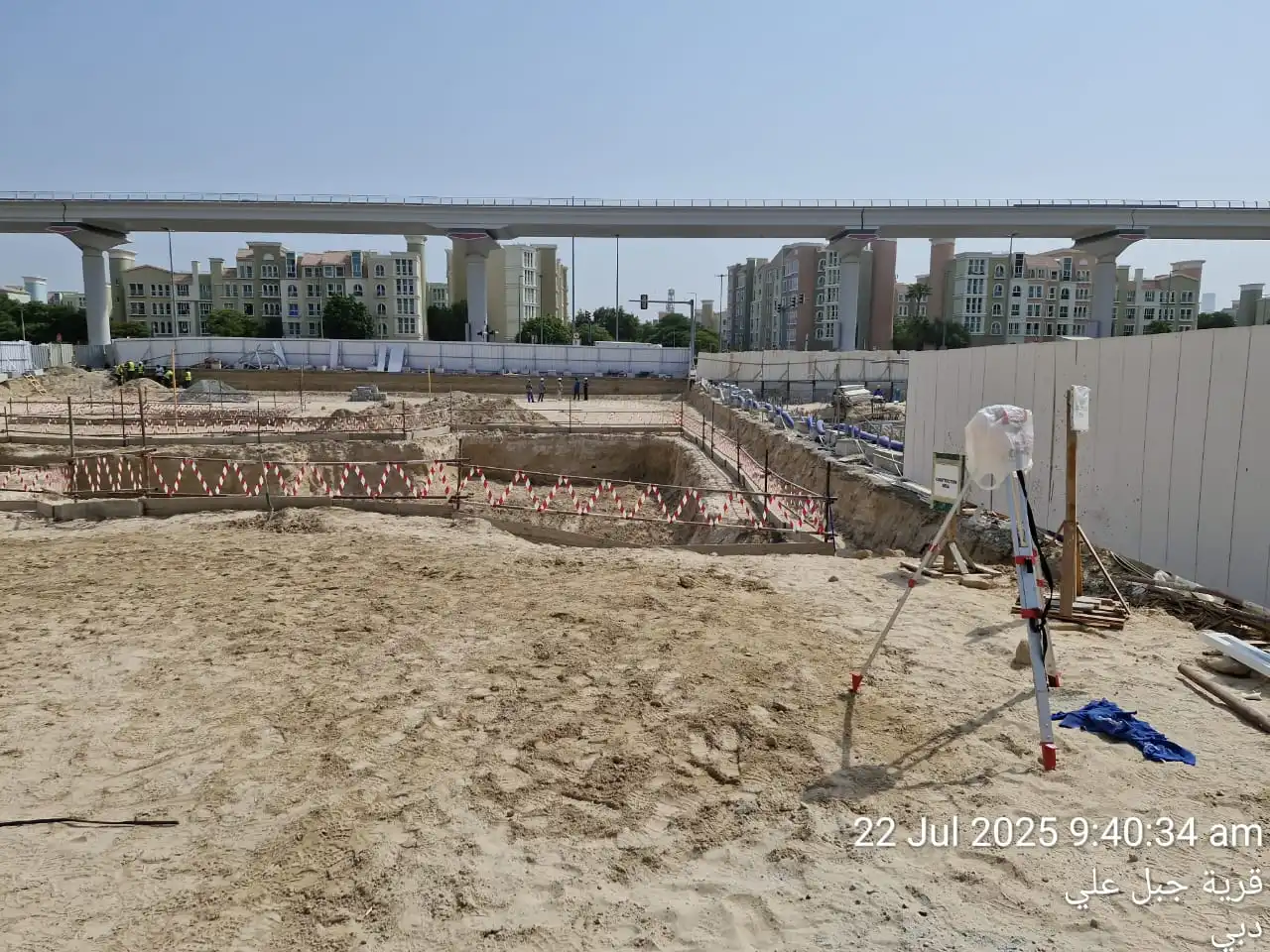

1.00%

Stage

Mobilization works
  • Site office, 75% completed.
  • Sign board erection, 100% completed.
  • Store & labor rest room, 100% completed.
Excavation works:

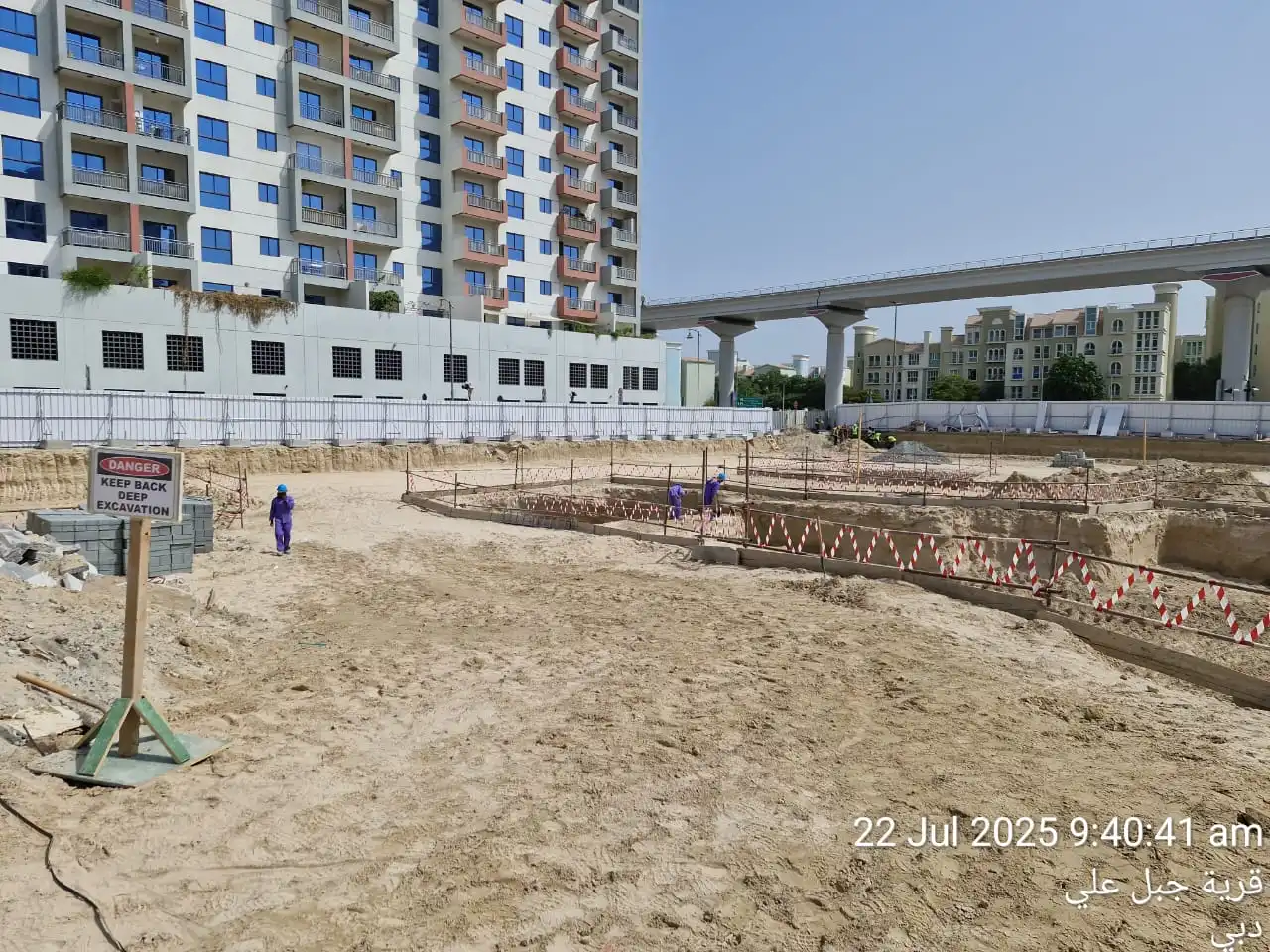

  • Excavation for main area, 100% completed.
  • Excavation for water tank & pump room, 50% completed.
Dewatering works:
  • Mobilization for de-watering works, 50% completed.

Construction start

July 2025

Planned completion

March 2027
