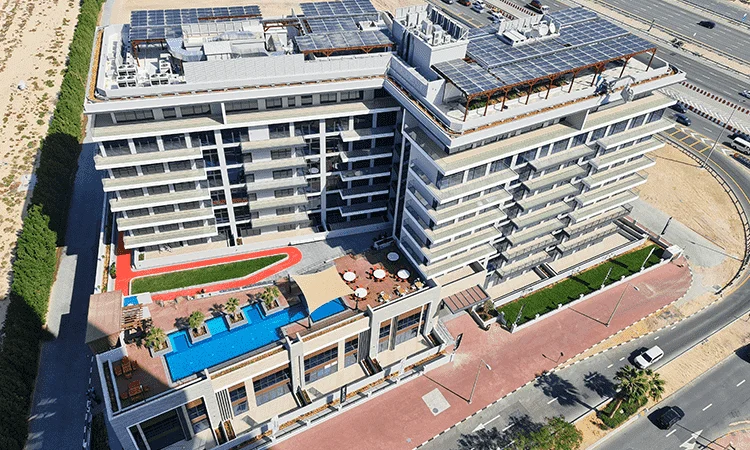

Zazen One Construction Updates
100%
Complete
ZāZEN One
CONSTRUCTION UPDATES
Start Date
Jan 2020
Completion DateJan 2022
This project was delivered on time and handed over on January 31st 2022.
TIMELINE
ZāZEN ONE – CONSTRUCTION UPDATE







Progress
100%
Stage
Authority Inspection & Approvals:
- Final demarcation certificate obtained from Nakheel
- Final demarcation certificate obtained from Trakhees
- DCD certificate obtained
- SIRA certificate obtained
- DCD inspection for LPG approved on 11th January 2022
- Dubai Land Department Building Completion Certificate received on 25th January 2022
Utilities & Services:
- DEWA power connection obtained
- DEWA meters approved and received for all units on 20th January 2022
- DEWA approval for solar panels and activation of meter completed
- DU inspection approved on 22nd January 2022
Approvals & Documentation:
- Final approved drawings from Trakhees received
- Nakheel stamped drawings received on 3rd January 2022
- Trakhees Completion Certificate received on 8th January 2022
- Nakheel Completion Certificate issued
Project Completion & Handover:
- Building handover and snagging in process as of 26th January 2022
Launched
15th January 2020
Planned Handover
January 2022
Progress
100%
Stage
Authority Inspection & Approvals:
- Final demarcation certificate obtained from Nakheel
- Final demarcation certificate obtained from Trakhees
- DCD certificate obtained
- SIRA certificate obtained
- DCD inspection for LPG approved on 11th January 2022
- Dubai Land Department Building Completion Certificate received on 25th January 2022
Utilities & Services:
- DEWA power connection obtained
- DEWA approval for Solar panels and activation of meter completed
- DEWA meters approved and received for all units on 20th January 2022
- DU inspection approved on 22nd January 2022
Documentation & Completion:
- Final approved drawings from Trakhees received
- Nakheel stamped drawings received on 3rd January 2022
- Trakhees Completion Certificate received on 8th January 2022
- Nakheel Completion Certificate issued
- Building handover and snagging in process as of 26th January 2022
Launched
15th January 2020
Planned Handover
January 2022
Progress
92.80%
Stage
Construction & Finishing Works:
- False ceiling work for the Ground Floor main entrance lobby completed
- 100% of MEP 3rd fix work from Ground to 7th Floor and Roof completed
- Facade work – 100% of aluminum & glazing work completed
- Facade work – 95% painting work completed
- 100% of lift work completed
- 100% of boundary wall work completed
- Front interlock & curb stone work at ground and podium floor completed
- Installation of way finding signage completed
- Swimming pool work completed
- Jogging track work completed
- Soil filling and irrigation work under progress
Authority Inspection & Approvals:
- Nakheel and Trakhees demarcation certificate obtained
- DEWA Water 1st inspection completed and comments incorporated
- DEWA Power obtained
- DU communication 1st inspection approved
- 1st Dubai Civil Defense inspection completed and comments incorporated
- Solar Panel installation complete and 1st inspection approved
- 75% of lift installation and testing work completed
Launched
15th January 2020
Planned Handover
January 2022
Progress
87.00%
Stage
Interior & Finishing Works:
- MEP 2nd Fix work completed
- Wardrobe work from Ground to 5th Floor completed
- Kitchen cabinet work from Ground Floor to 7th Floor completed
- Timber door work from Ground to 7th Floor and Roof completed
- Vanity work from Ground to 7th Floor completed
- False ceiling work from Ground to 7th Floor and Roof completed
- Staircase handrail work at Ground and Podium Floor completed
- Balcony handrail from Podium to 7th Floor and Roof completed
Facade & External Works:
- Facade work – 100% of external plastering work completed
- Facade work – 90% of aluminium & glazing work completed
- Facade work – 100% of stone cladding work completed
- 75% of lift installation and testing work completed
Launched
15th January 2020
Planned Handover
January 2022
Progress
81.09%
Stage
Interior Works:
- Wet area wall tile work and waterproofing from Ground to 7th Floor completed
- Wet area floor tiling from Ground to 7th Floor completed
- Dry tiling from Ground to 7th Floor completed
- 1st coat painting work from Ground to 7th Floor completed
- Wardrobe installation from Ground to 5th Floor completed
- Kitchen cabinet installation from Ground to 5th Floor completed
- Timber door installation from Ground to 5th Floor completed
- Vanity counter installation from Ground to 2nd Floor completed
- MEP 1st and 2nd Fix work from Ground to Roof level completed
- False ceiling work from Ground to 4th Floor completed
- Balcony handrail installation from Podium to 3rd Floor completed
Facade & External Works:
- 90% of external plastering work completed
- 85% of aluminium & glazing work completed
- 80% of stone cladding work completed
- 55% of lift installation completed
- 55% of boundary wall completed
Launched
15th January 2020
Planned Handover
January 2022
Progress
76.7%
Stage
Interior & Finishing Works:
- Plaster work for all floors completed
- Wet area wall tile work from 1st to 6th floor completed
- 80% of wet area wall tile at 7th floor completed
- Wet area waterproofing from 1st to 7th floor completed
- Wet area floor tiling from Ground to 7th floor completed
- 95% of dry tiling from Ground to 4th floor completed
- 90% of dry tiling on 5th & 6th floor completed
- Painting work from Ground to 7th floor under progress
- 100% of wardrobe fixing on Ground & Podium floor completed
- 90% of kitchen cabinet work on Ground & Podium floor completed
- 100% of doors work on Ground & Podium floor completed
- 100% of vanity work on Ground & Podium floor completed
- MEP first fix work from 1st to 7th floor and Roof completed
Facade & External Works:
- Façade work – external plastering under progress
- Façade work – aluminum & glazing under progress
- Façade work – stone cladding under progress
- Façade work – painting under progress
- 100% of garbage chute work completed
- Lift work under progress
- Window cleaning system work under progress
Launched
15th January 2020
Planned Handover
January 2022
Progress
66%
Stage
Interior Works:
- Plaster work at 5th & 6th Floor completed
- Wet area wall tile work from 1st to 6th Floor completed
- Wet area floor tiling from Ground Floor to 3rd Floor completed
- Dry tiling from Ground Floor to 4th Floor completed
- Painting work from Ground Floor to 7th Floor under progress
- 100% of wardrobe work at the Ground and Podium Floor completed
- 100% of doors work at the Ground and Podium Floor completed
- 100% of vanity work at the Ground and Podium Floor completed
- MEP 1st Fix work from 1st to 7th Floor and Roof completed
- False ceiling work from the Ground to 3rd Floor under progress
Facade & External Works:
- Façade work – external plastering work under progress
- Façade work – aluminum & glazing work under progress
Launched
15th January 2020
Planned Handover
January 2022
Progress
51%
Stage
Structural & Interior Works:
- Casting of parapet wall completed
- Block work at Seventh and Roof floor completed
- Plaster work from Podium to 4th floor completed
- Wet area waterproofing from 1st to 3rd floor completed
- Wet area floor and wall tiling from Ground floor to 3rd floor under progress
- MEP 1st Fix works from 1st to 3rd floor completed
Facade Works:
- Facade external plastering works under progress
Launched
15th January 2020
Planned Handover
January 2022
Progress
45%
Stage
Structural Works:
- Roof Floor and Top of Roof Slab casting completed
- Parapet wall work under progress
- Block work on Second, Third and Fourth Floor completed
- Block work from Fifth to Seventh Floor under progress
Interior & MEP Works:
- Plaster work at Podium, First and Second Floor completed
- Wet area waterproofing from Ground to Second Floor under progress
- Wet area wall and floor tiling from Ground to Third Floor under progress
- Dry tiling from Ground to Second Floor under progress
- MEP 1st fix works at First Floor and Second Floor completed
- MEP 2nd fix works from Ground to Fourth Floor under progress
Launched
15th January 2020
Planned Handover
January 2022
Progress
42%
Stage
Structural Works:
- Sixth Floor to Roof all the vertical elements completed
- Seventh Floor slab casting completed
- Block work at Ground Floor, Podium Floor and First Floor completed
- Block work at Second Floor, Third Floor and Fourth Floor under progress
MEP Works:
- MEP 1st fix work at Ground and Podium Floor completed
- MEP 1st fix work at First and Second Floor under progress
- MEP 2nd fix work at Ground Floor, Podium Floor and First Floor under progress
Launched
15th January 2020
Planned Handover
January 2022
Progress
33.78%
Stage
Structural Works:
- Fifth Floor slab casting completed
- Third to Sixth Floor all the vertical elements completed
- Block work at Ground Floor completed
- Block work at Podium Floor and First Floor under progress
MEP Works:
- MEP works under progress at Ground Floor and Podium Floor
Launched
15th January 2020
Planned Handover
January 2022
Progress
28.49%
Stage
Structural Works:
- 2nd and 3rd floor slabs concreted
- 1st floor to 4th floor – all vertical elements concreted
Interior & Block Works:
- Block work in progress at Ground & Podium Floor
- Plastering work in progress at Ground Floor
Launched
15th January 2020
Planned Handover
January 2022
Progress
24.19%
Stage
Structural Works:
- 1st floor slab completed
- 1st floor to 2nd floor Column / Walls – 50% completed
Launched
15th January 2020
Planned Handover
January 2022
Progress
22.04%
Stage
Structural Works:
- Casting of Podium floor completed
- 50% Casting of 1st floor completed
- Duplex Area – Cover slab concreted
Launched
15th January 2020
Planned Handover
January 2022
Progress
14.05%
Stage
Structural Works:
- Casting of Grade slab completed
- Casting of Ramp to Podium floor completed
- Ground Floor – Column / Walls concreting completed
Launched
15th January 2020
Planned Handover
January 2022
Progress
12.71%
Stage
Underground & Foundation Works:
- Underground services for Drainage completed
- Back Filling below the Grade slab completed
- Grade slab in progress
Launched
15th January 2020
Planned Handover
January 2022
Progress
9.82%
Stage
Foundation & Substructure Works:
- All the Foundations concreted
- Neck Column & Tie beam works completed
- Substructure waterproofing completed
- Backfilling up to Tie beam level completed
Launched
15th January 2020
Planned Handover
January 2022
Progress
2.25%
Stage
Excavation & Foundation Works:
- Excavation completed
- Casting of major areas – Raft & Foundations completed
Launched
15th January 2020
Planned Handover
January 2022
Progress
0.08%
Stage
Initial Works:
- Mobilization completed
- Excavation in progress
Launched
15th January 2020
Planned Handover
January 2022
