مستجدات الإنشاء – ذا هاب ريزيدن

CONSTRUCTION UPDATES

9.50%

THE HUB RESIDENCES BY ZāZEN

Al Furjan

It is currently under construction and is planned for completion in January 2027 . This project is registered under RERA project number 3419.

VIEW PROJECT
DELIVERED

TIMELINE

The Hub Residences JOURNEY

Progress

9.50%

Stage

Excavation Works:
  • Main raft area – 100% completed
  • Staircase & UG water tank – 100% completed
  • UG pump room & sump pit – 100% completed
Dewatering Works:
Dewatering – Under progress.
Road base & Compaction Works:
  • Main raft foundation area – 80% completed
  • Isolated footing – 90% completed
  • UG Water tank & Pump room – 90% completed
Solid Block Works:
Solid Block works for main raft area – 100% completed
  • PCC Works:
  • PCC below Raft foundation – 85% completed
  • PCC Below Isolated footing – 85% completed
Waterproofing & Reinforcement Works:
  • Waterproofing membrane below Main Raft foundation – 70% completed
  • Waterproofing membrane for Isolated footing – 75% completed
  • Waterproofing membrane for UG tank & pump room – 100% completed

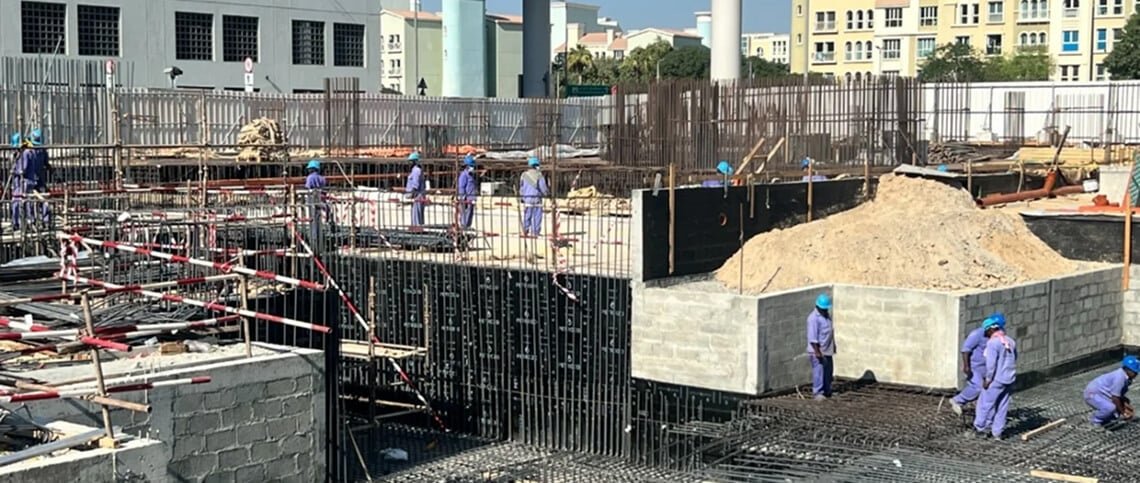

Reinforcement & Concrete Works:
  • Steel reinforcement work for the Isolated footing & substation – 75% completed
  • Steel reinforcement work for raft – 65% completed
  • Steel reinforcement work for Neck column at Isolated footing – 80% completed
  • Isolated footing concrete casting – 75% completed
  • Neck column concrete casting at Isolated footing – 80% completed

Construction Start

July 2025

Planned Completion

January 2027

Excavation Works:

6.50%

Stage

Excavation Works:
Main raft area – 90% completed
UG pump room & sump pit – 90% completed
Solid Block Works:
Solid Block works for main raft area – 75% completed
PCC Works:
PCC below Raft foundation – 70% completed
PCC Below Isolated footing – 85% completed
Waterproofing & Reinforcement Works:
Waterproofing membrane below Main Raft foundation – 55% completed
Waterproofing membrane for Isolated footing – 75% completed
  • PCC Works:
  • PCC below Raft foundation – 85% completed
  • PCC Below Isolated footing – 85% completed
Reinforcement & Concrete Works:
  • Steel reinforcement work for the Isolated footing & substation – 75% completed
  • Steel reinforcement work for raft – 30% completed
  • Steel reinforcement work for Neck column at Isolated footing – 80% completed
  • Isolated footing concrete casting – 75% completed
  • Neck column concrete casting at Isolated footing – 80% completed

Construction Start

July 2025

Planned Completion

January 2027

Progress

5.15%

Progress

Excavation Works:
  • Main raft area – 85% completed
  • Staircase & UG water tank – 100% completed.
  • UG pump room & sump pit – 80% completed.
Dewatering Works:
Dewatering – Under progress.
Road base & Compaction Works:
  • Main raft foundation area – 80% completed
  • Isolated footing – 85% completed
  • UG staircase – 100% completed.
  • UG Water tank & Pump room – 80% completed
Solid Block Works:
Solid Block works for main raft area – 75% completed
  • PCC Works:
  • PCC below Raft foundation – 75% completed
  • PCC Below Isolated footing – 85% completed
Waterproofing & Reinforcement Works:
  • Waterproofing membrane below Main Raft foundation – 50% completed
  • Waterproofing membrane for Isolated footing – 75% completed
  • Steel reinforcement work for the Isolated footing & substation – 50% completed.

Construction Start

July 2025

Planned Completion

January 2027

Progress

 2.86%

Stage

Mobilization Works
  • Site Office, 100% completed.
Excavation Works:
  • Excavation for Lift pit, 100% completed.
  • Excavation for Water tank & pump room, 50% completed.
  • Compaction of Main Excavation Area, 50% completed.
Dewatering Works:
  • Mobilization for Dewatering works, 100% completed.
  • Dewatering, under progress.
Roadbase Works
  • Compaction, Leveling and Laying of roadbase, 50% completed.
Solid Block Works
Substation and lift area, 50% completed.
  • PCC Works:
  • PCC work below the Raft foundation, 50% completed.

Construction Start

 July 2025

Planned Completion

January 2027

Progress

1.00%

Stage

Mobilization Works
  • Site Office, 75% completed.
  • Sign Board Erection, 100% completed.
  • Store & Labor rest room, 100% completed.
Excavation Works:
  • Excavation for main area, 100% completed.
  • Excavation for water tank & pump room, 50% completed.
Dewatering Works:
  • Mobilization for De-watering works, 50% completed.

Construction Start

 July 2025

Planned Completion

January 2027
